Project Graphics
Animations and renderings have been created to highlight various project components. Please have a look!
Initial Contract – Construction Progress Photos – Season 1

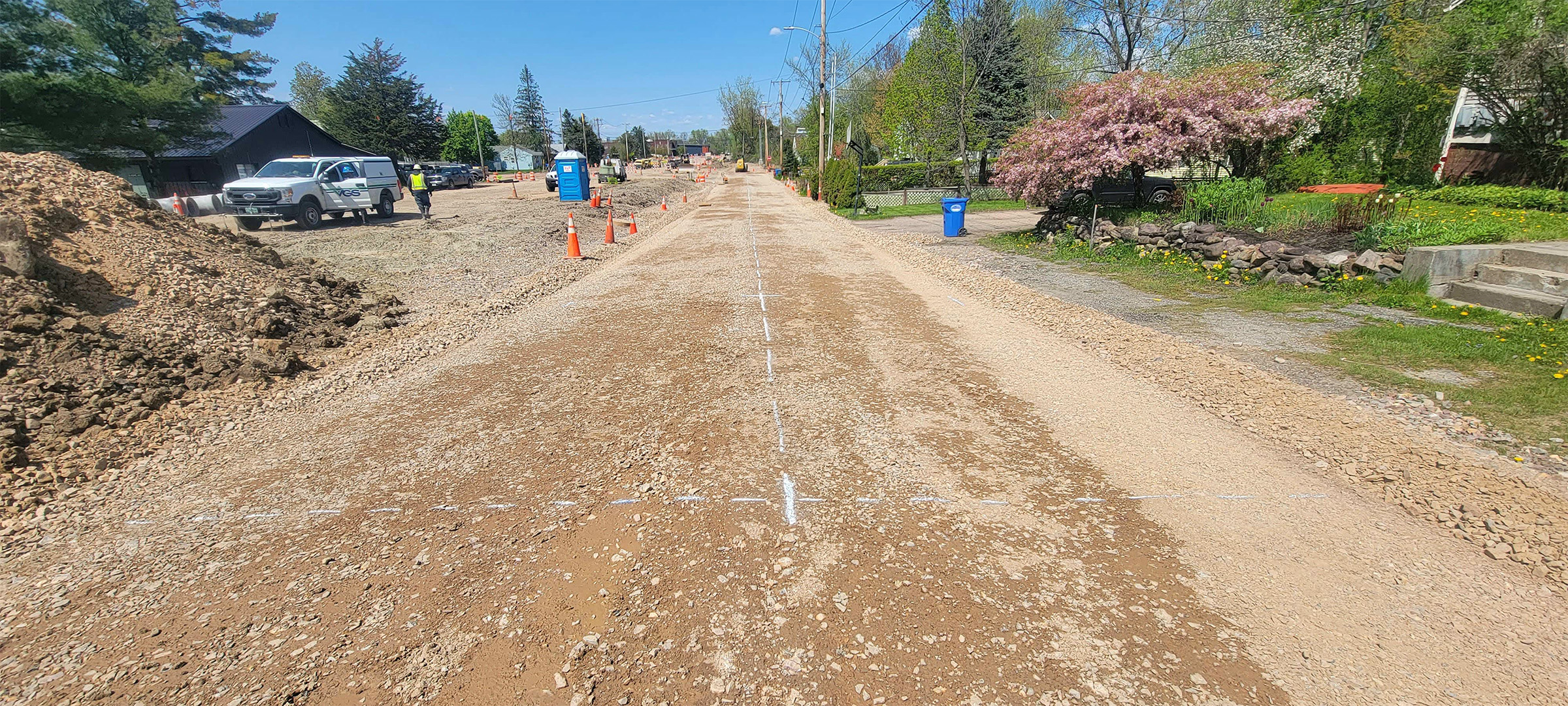

Construction of the initial contract began in June of 2022 and continued over the course of three construction seasons through the Fall of 2024. In order to avoid additional traffic delays during the construction of the Shelburne Street Roundabout, the first construction season focused on the area between Home Avenue and Sears Lane with some off-road work along Lakeside Avenue. The work focused on the installation of underground utilities and stormwater infrastructure, including the sand filter near Lakeside Avenue, the culvert at Englesby Brook, and the stormwater detention pond between Sears Lane and Flynn Avenue.
Initial Contract – Construction Progress Photos – Season 2
The second construction season focused on the completion of underground utilities and stormwater infrastructure, reconstruction of roadways, installation of shared-use paths and sidewalks, improvements of the railroad crossing, installation of traffic signals, and the construction of the Champlain Parkway starting between Home Avenue and Sears Lane, followed by Sears Lane to Lakeside Avenue. In addition, crews began the reconstruction of Lakeside Avenue between the railroad tracks and Pine Street and the rehabilitation of Pine Street between Lakeside Avenue and Kilburn Street, including the reconstruction or rehabilitation of the roadways, the installation of a shared-use path and sidewalks, improvements to the existing roadway geometries and layout, and traffic signal installation.
Animations
Interstate 189 Interchange to Home Avenue Northbound
Home Avenue to Lakeside Avenue Northbound
Lakeside Avenue at Pine Street to Main Street Northbound
Champlain Parkway at Home Avenue looking North
Champlain Parkway at Flynn Avenue looking Southwest
Champlain Parkway at Lakeside Avenue looking North
Champlain Parkway at Sears Avenue looking North
Pine Street at King Street looking North
Pine Street at Locust Street Looking North
Pine Street at Lakeside Avenue looking North
Pine Street at Howard Street looking North
Pine Street at Kilburn Street looking South
Pine Street at Maple Street looking South
Pine Street at Marble Avenue looking North
Renderings
- Shared Use Path Near Ferguson Avenue Cul-De-Sac Looking North
- View from Bicycle on Champlain Parkway South of Flynn Avenue Looking North
- Southwest Corner of Flynn Avenue and Champlain Parkway Looking Northeast
- Champlain Parkway Between Flynn Avenue and Sears Lane Looking North
- Pine Street & Howard Street Looking North
- Shared Use Path Between Howard Street and Marble Street Looking North
- Pine Street & Kilburn Street Looking North
- View from Bicycle Near Pine Street and Maple Street Looking North
- Champlain Parkway Alignment (10MB PDF)
- Champlain Parkway Rendering of View Looking South at King Street (4MB PDF)
- Champlain Parkway Rendering of View Looking North from Home Avenue (5MB PDF)
Initial Contract - Construction Season 1 (114)

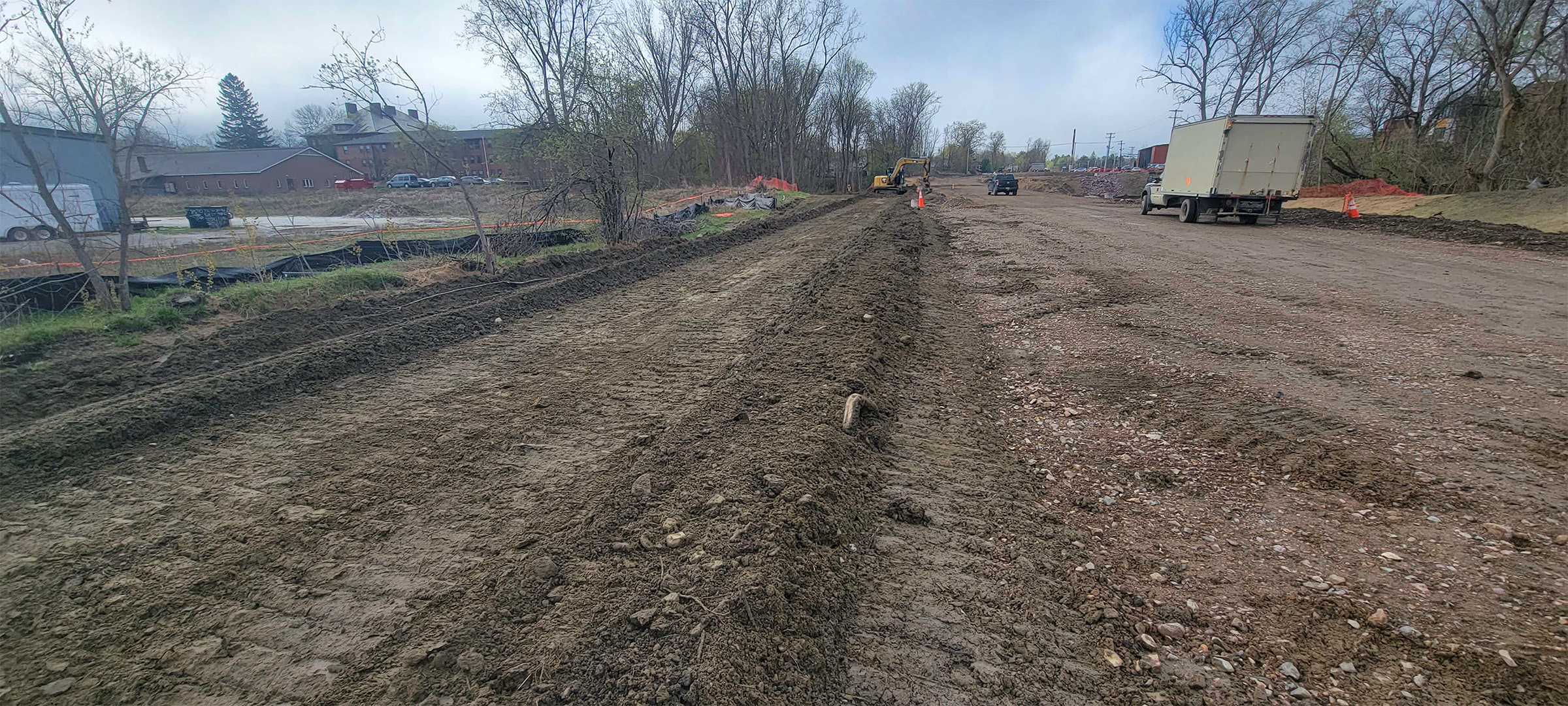

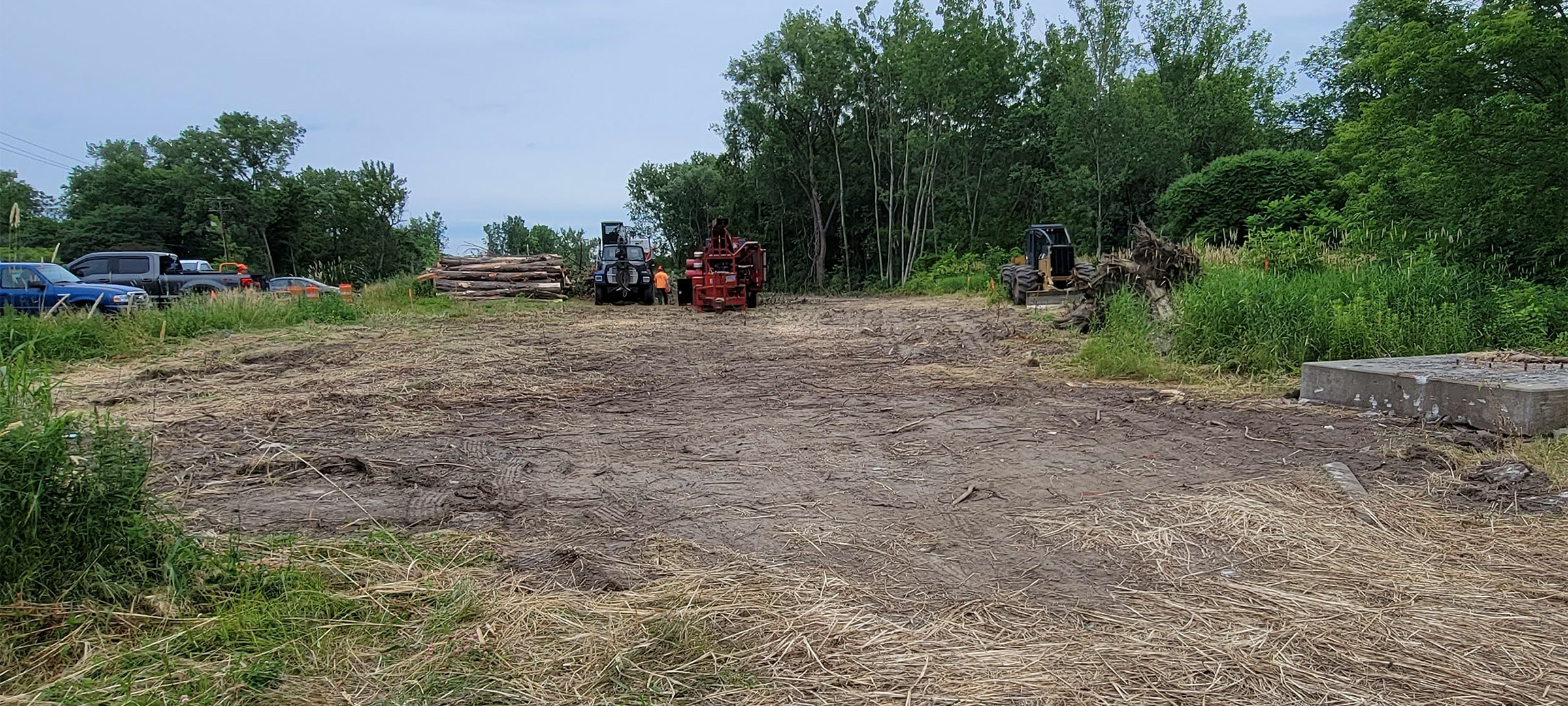

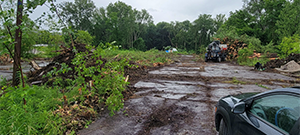

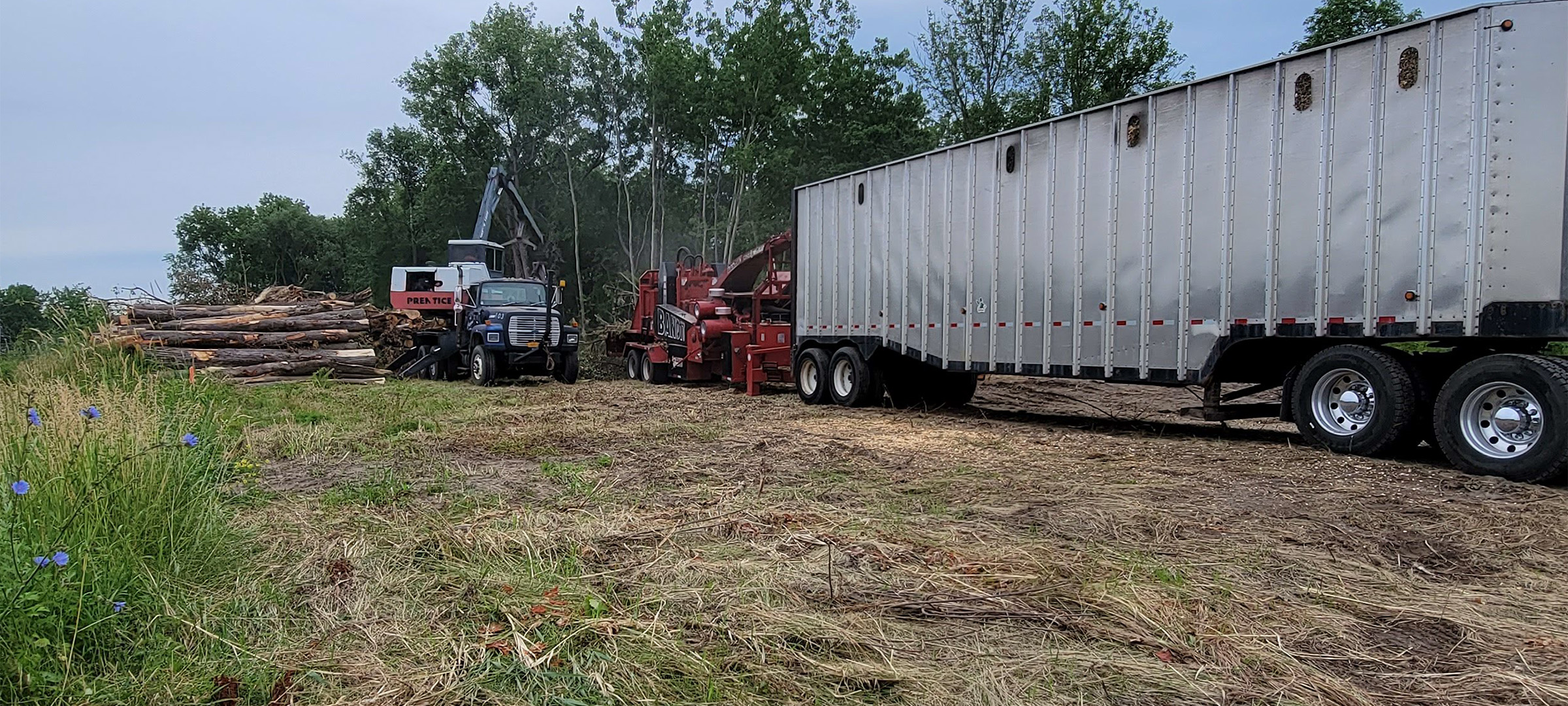

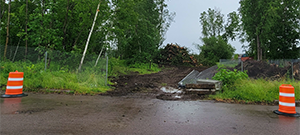

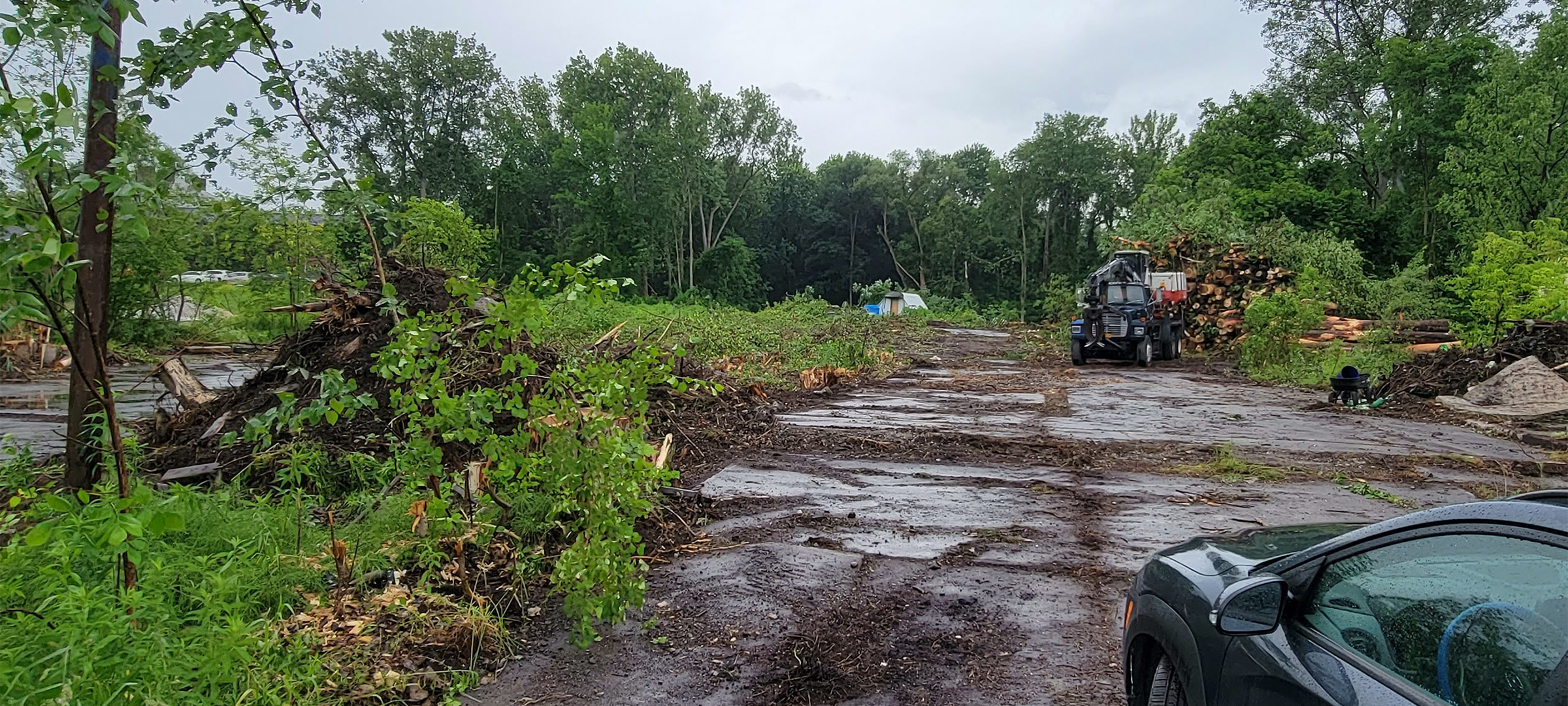

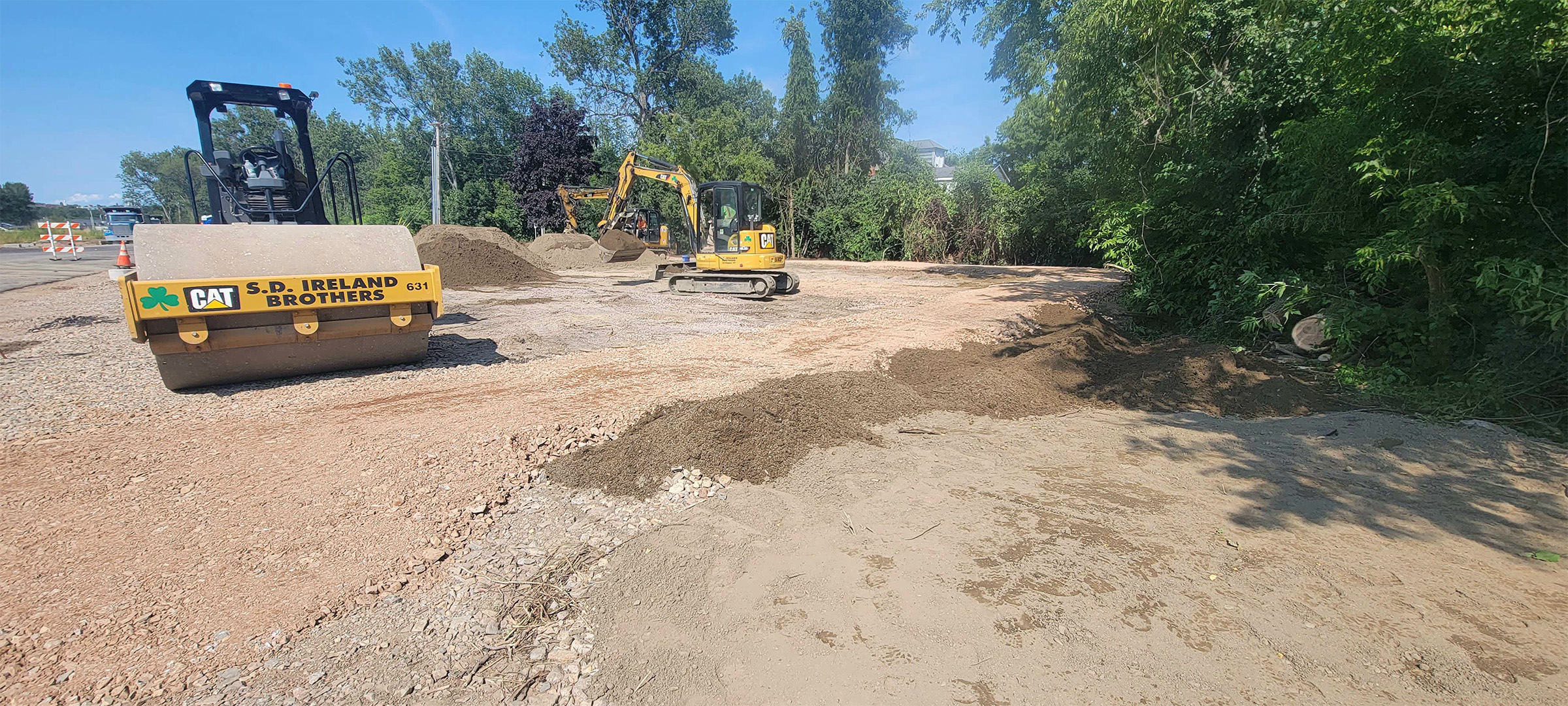

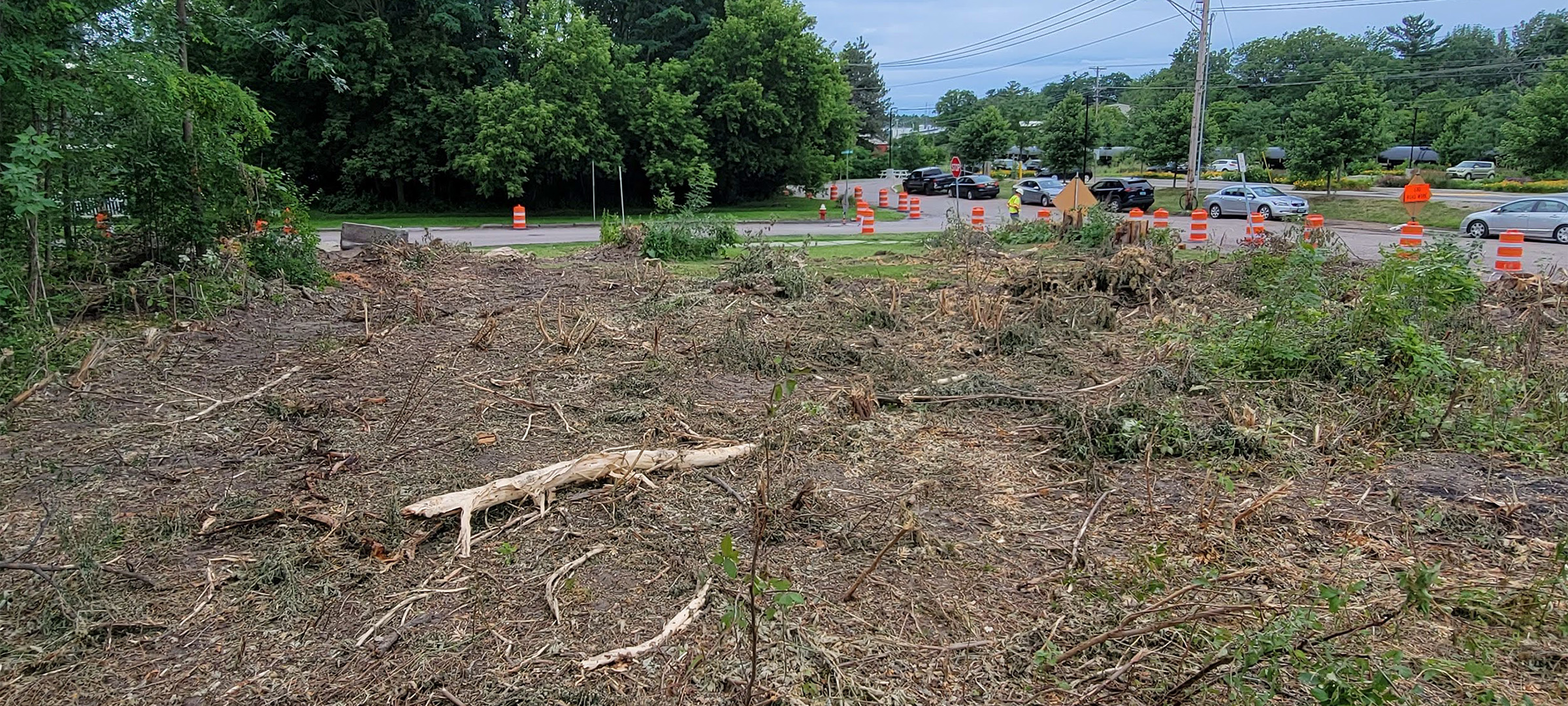

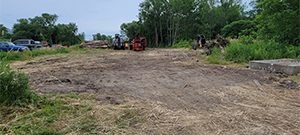

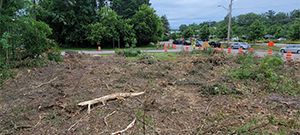

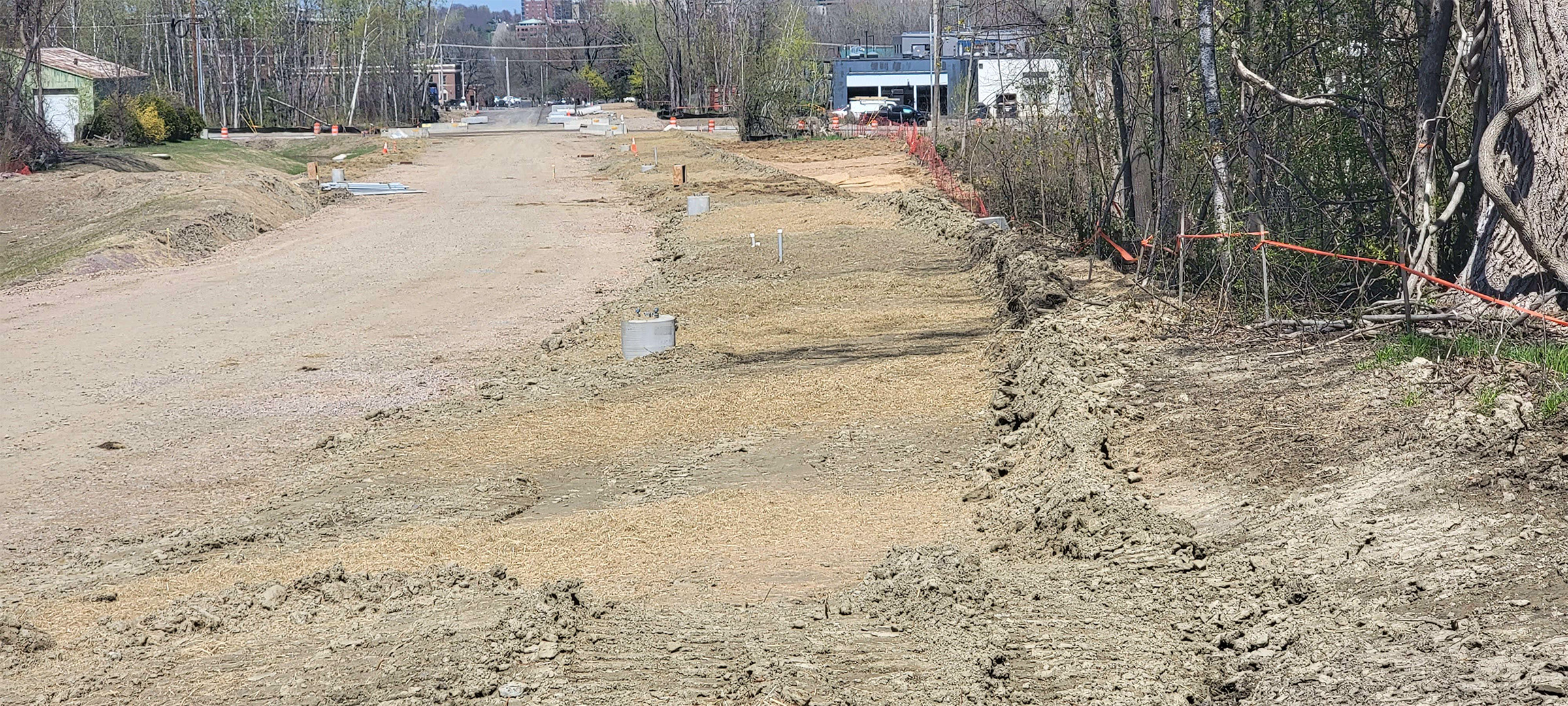

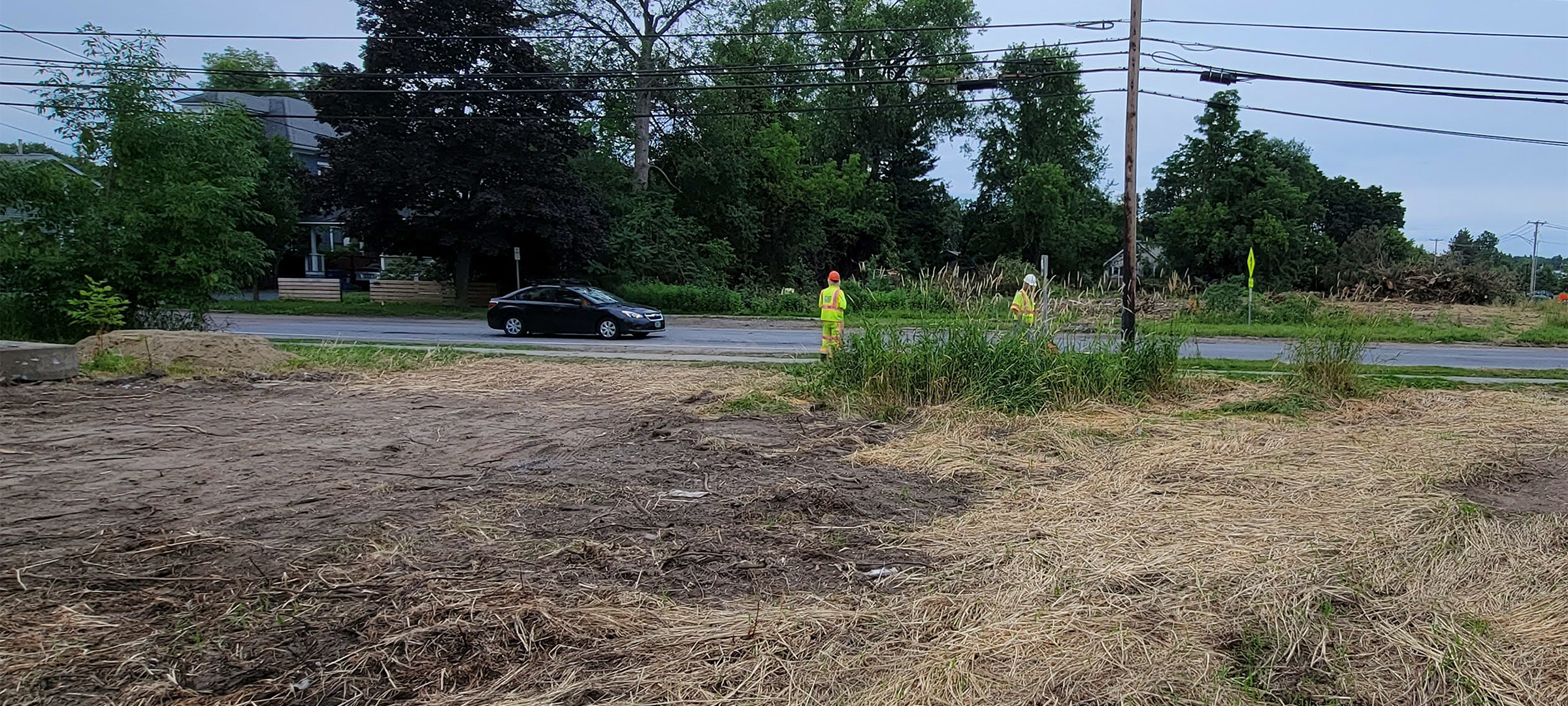

Crews performed clearing and grubbing work along the future Champlain Parkway alignment in preparation for construction. Clearing is the removal of vegetation above the ground such as trees and bushes and grubbing is the removal of subsurface vegetation such as stumps. Pictured near Sears Lane.
Crews performed clearing and grubbing work along the future Champlain Parkway alignment in preparation for construction. Clearing is the removal of vegetation above the ground such as trees and bushes and grubbing is the removal of subsurface vegetation such as stumps.
Crews performed clearing and grubbing work along the future Champlain Parkway alignment in preparation for construction. Clearing is the removal of vegetation above the ground such as trees and bushes and grubbing is the removal of subsurface vegetation such as stumps. Pictured near Briggs Street and Ferguson Avenue.
Crews performed clearing and grubbing work along the future Champlain Parkway alignment in preparation for construction. Clearing is the removal of vegetation above the ground such as trees and bushes and grubbing is the removal of subsurface vegetation such as stumps.
Crews performed clearing and grubbing work along the future Champlain Parkway alignment in preparation for construction. Clearing is the removal of vegetation above the ground such as trees and bushes and grubbing is the removal of subsurface vegetation such as stumps. Pictured near Flynn Avenue.
Crews performed clearing and grubbing work along the future Champlain Parkway alignment in preparation for construction. Clearing is the removal of vegetation above the ground such as trees and bushes and grubbing is the removal of subsurface vegetation such as stumps.

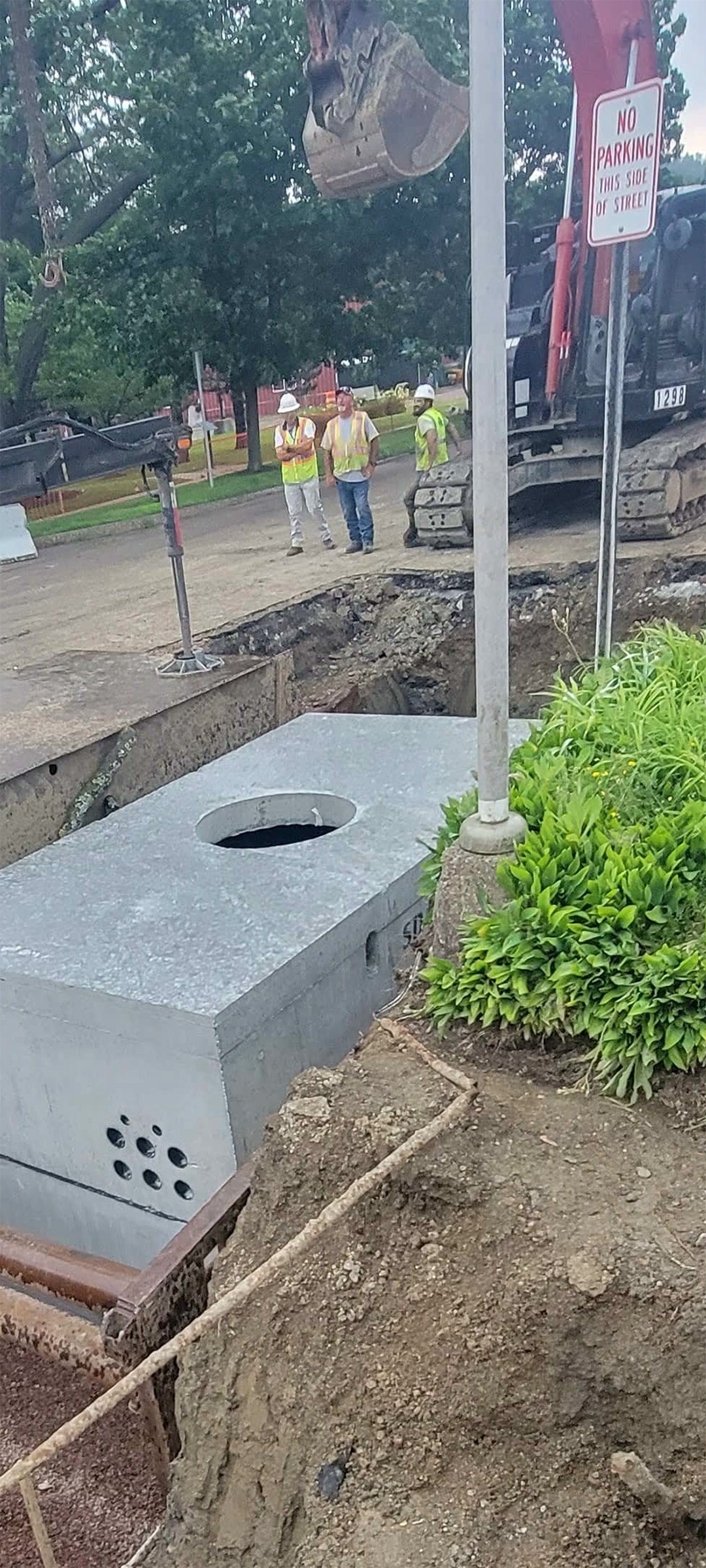

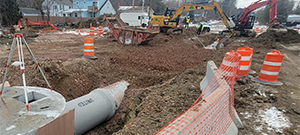

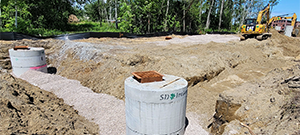

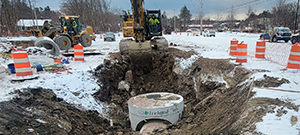

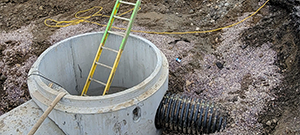

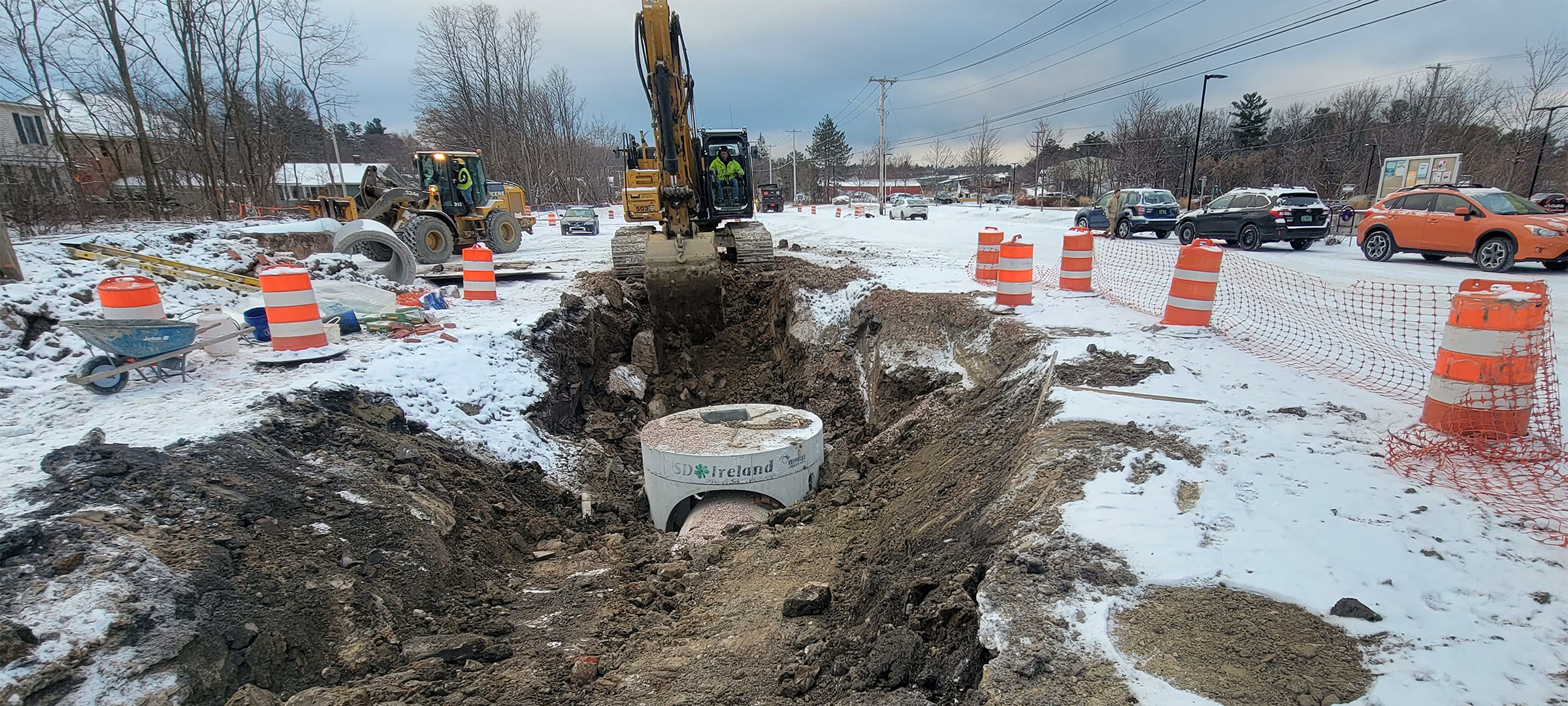

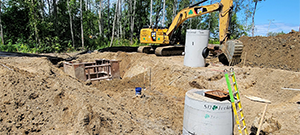

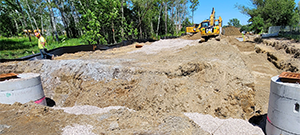

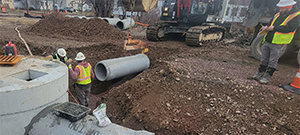

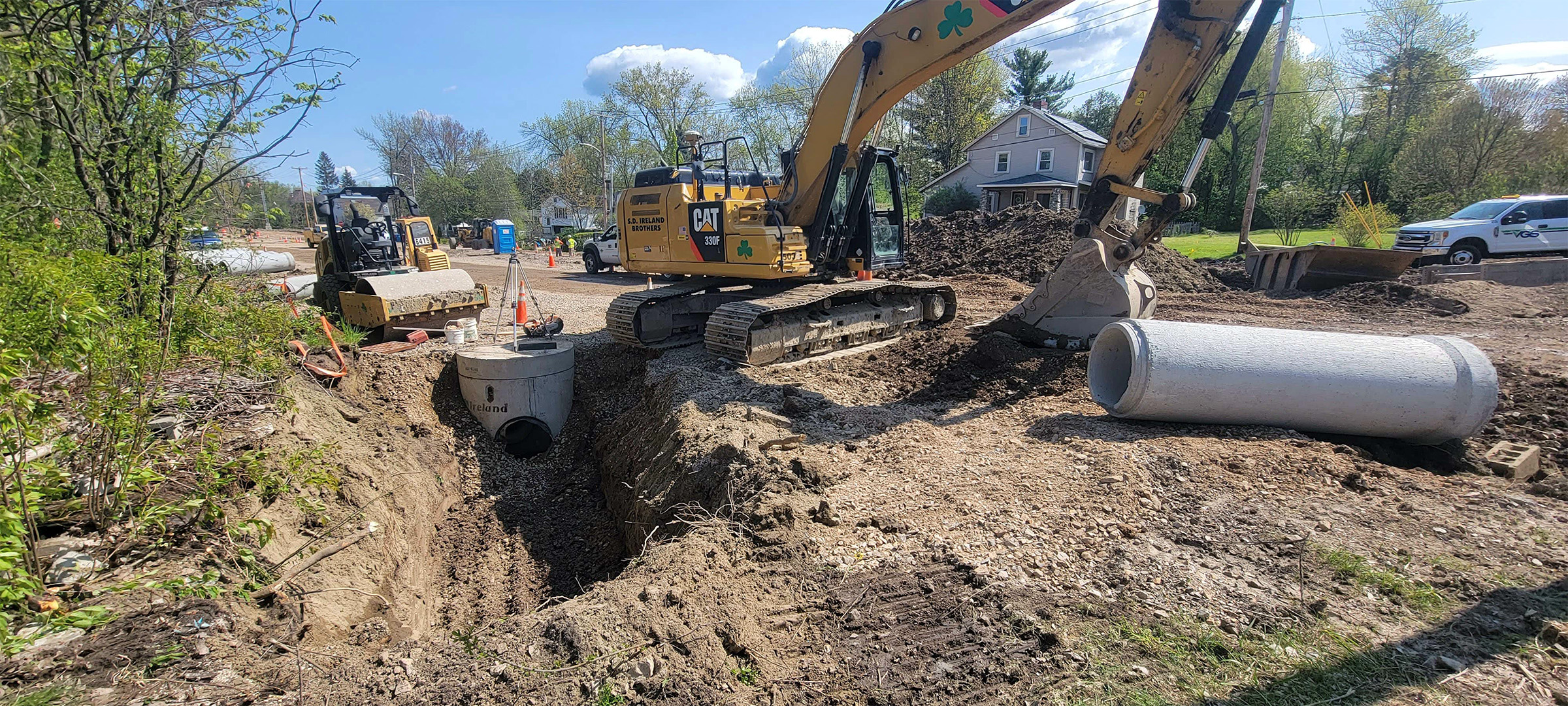

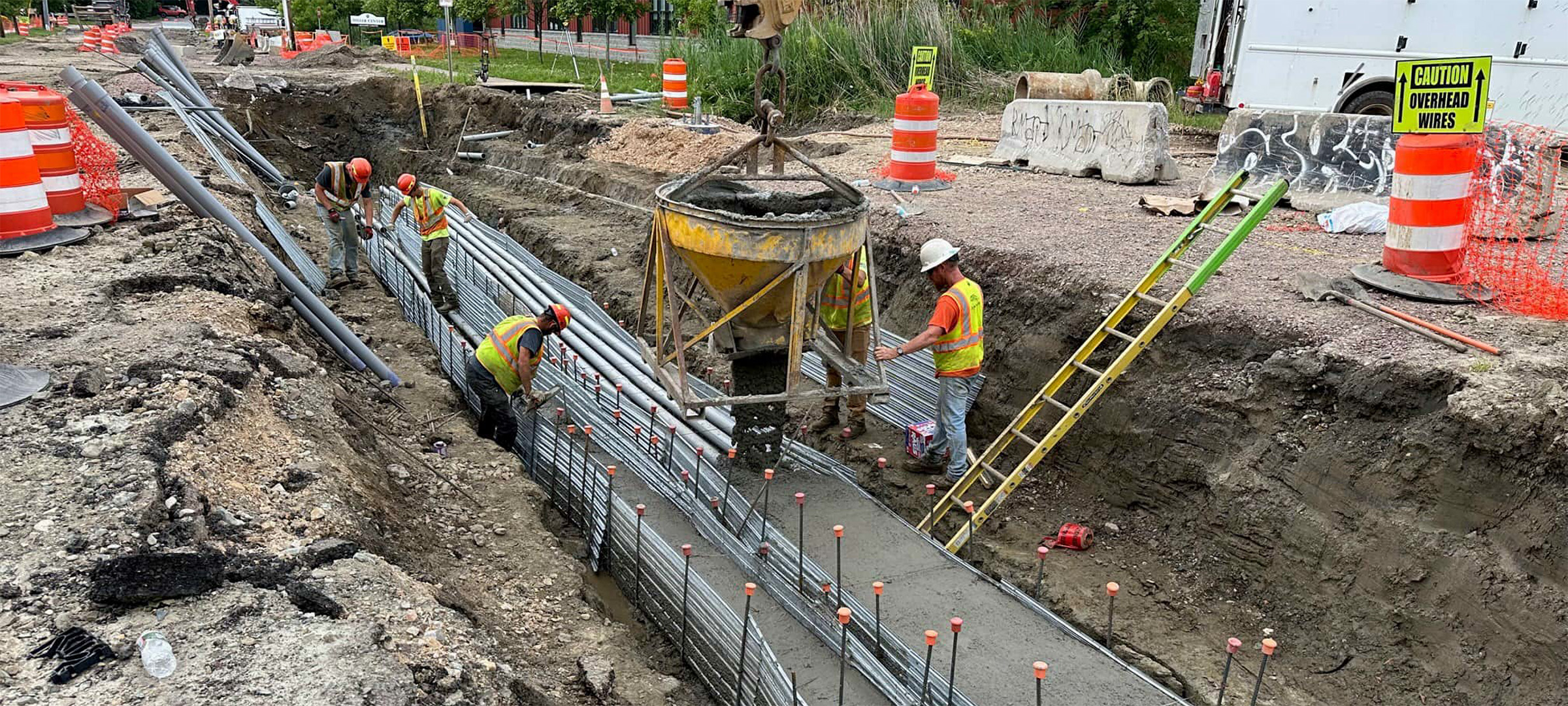

New stormwater infrastructure installed along the Champlain Parkway.
New stormwater infrastructure installed along the Champlain Parkway.
New stormwater infrastructure installed along the Champlain Parkway.
New stormwater infrastructure installed along the Champlain Parkway.
New stormwater infrastructure installed along the Champlain Parkway.

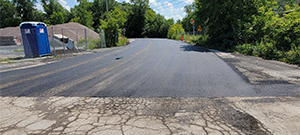

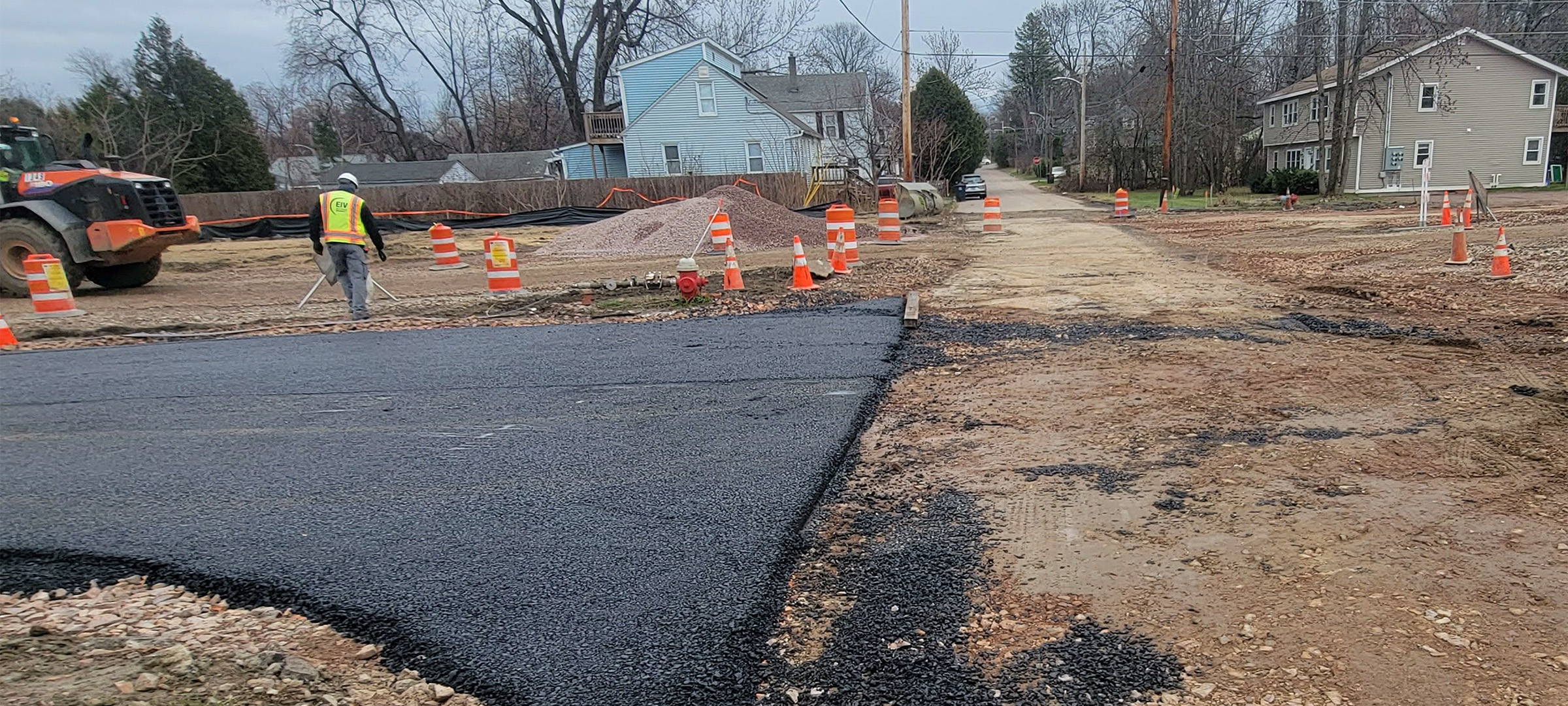

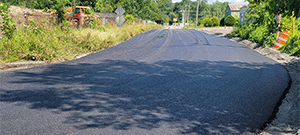

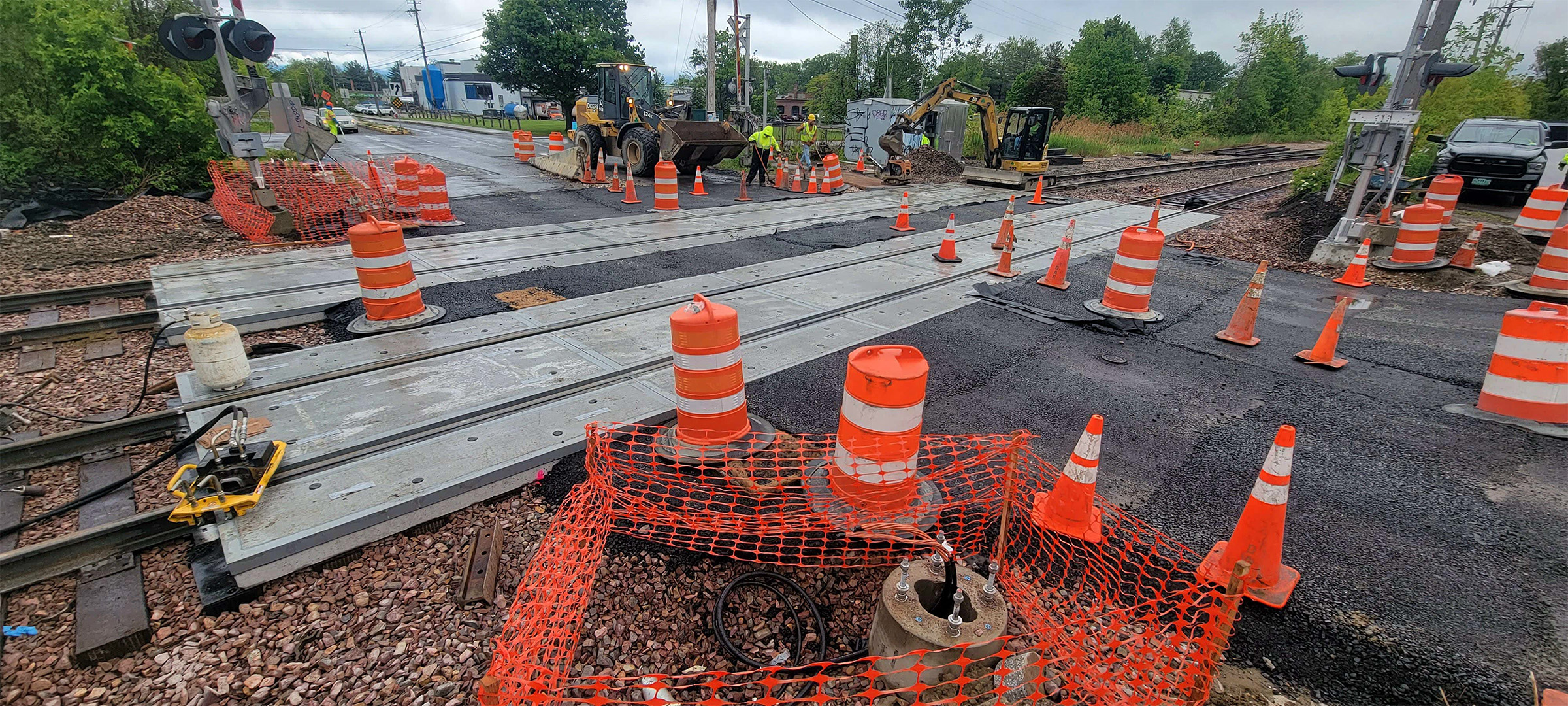

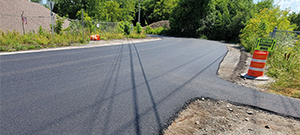

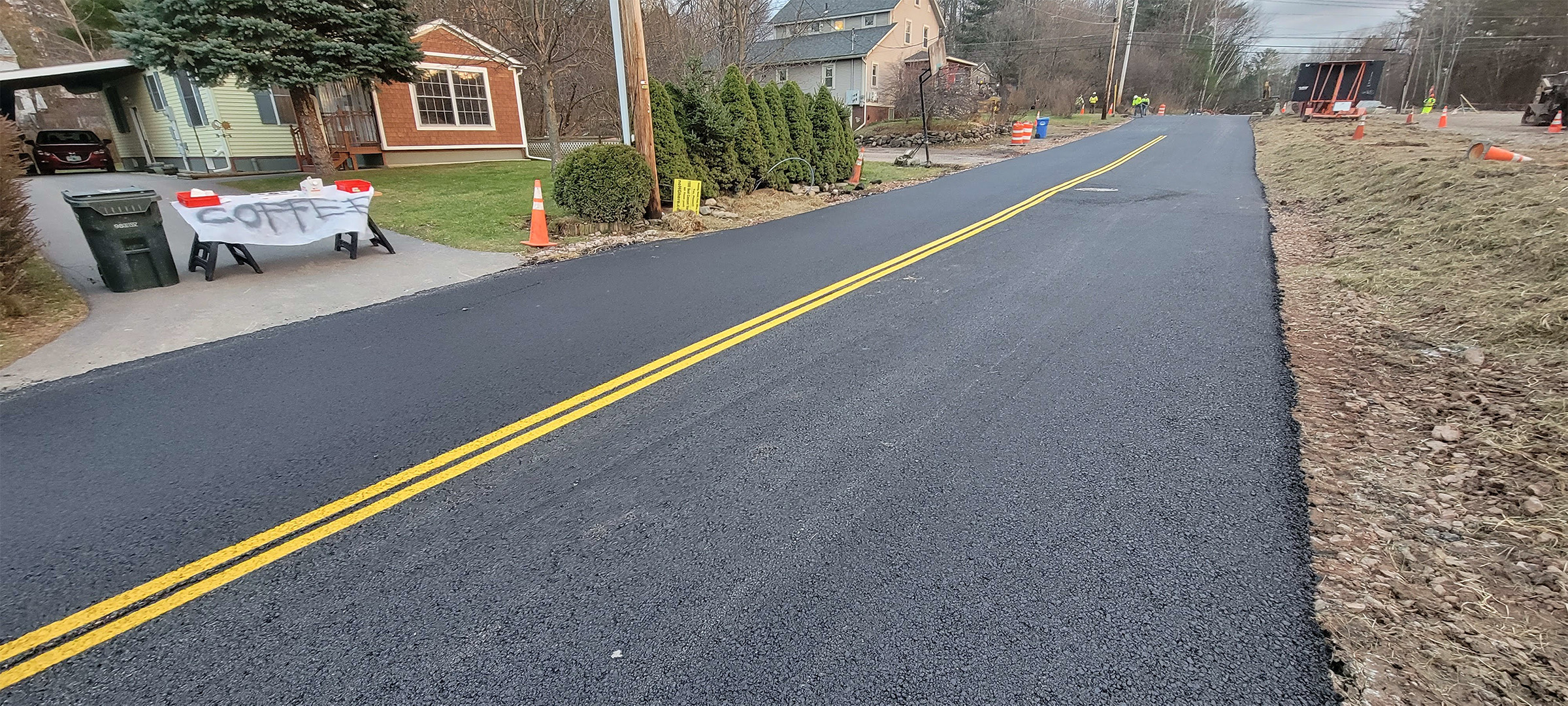

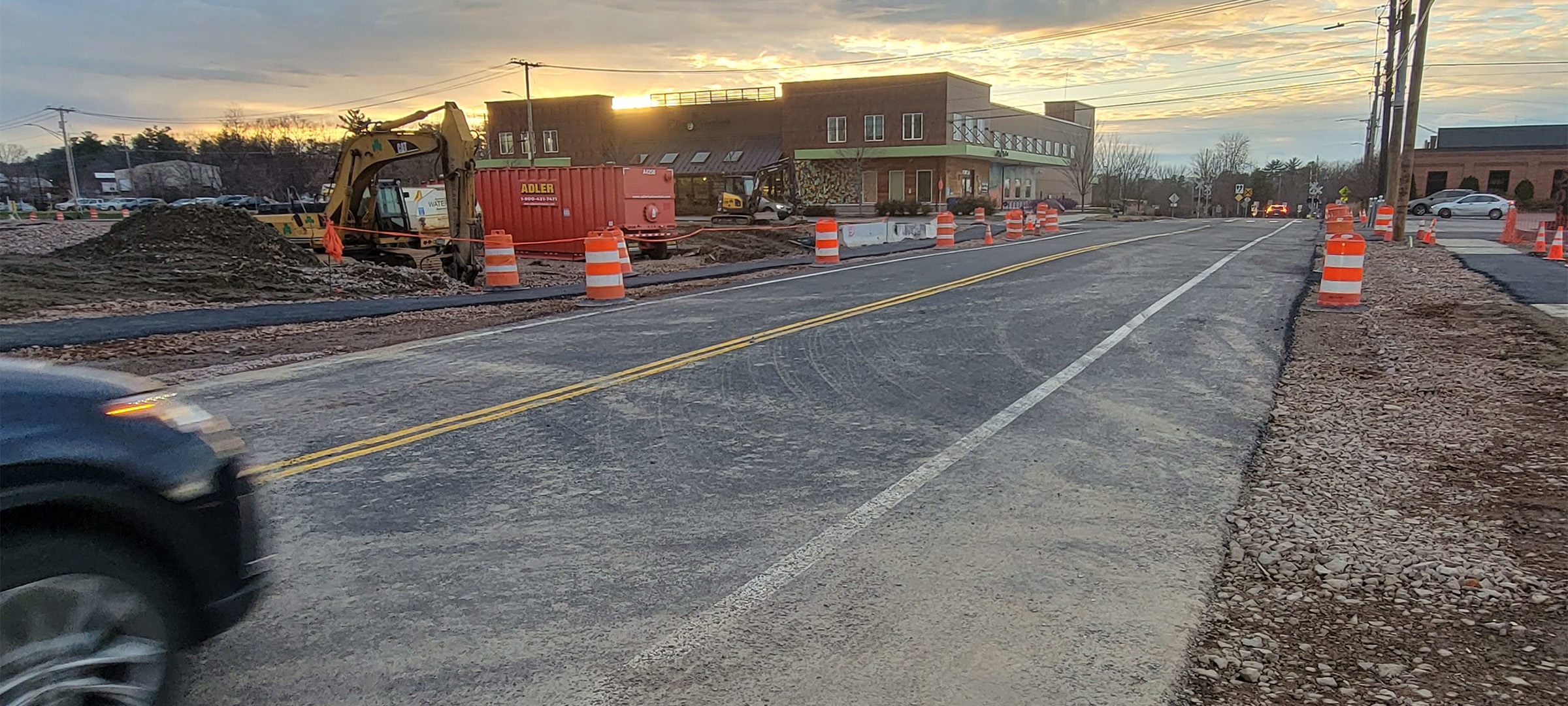

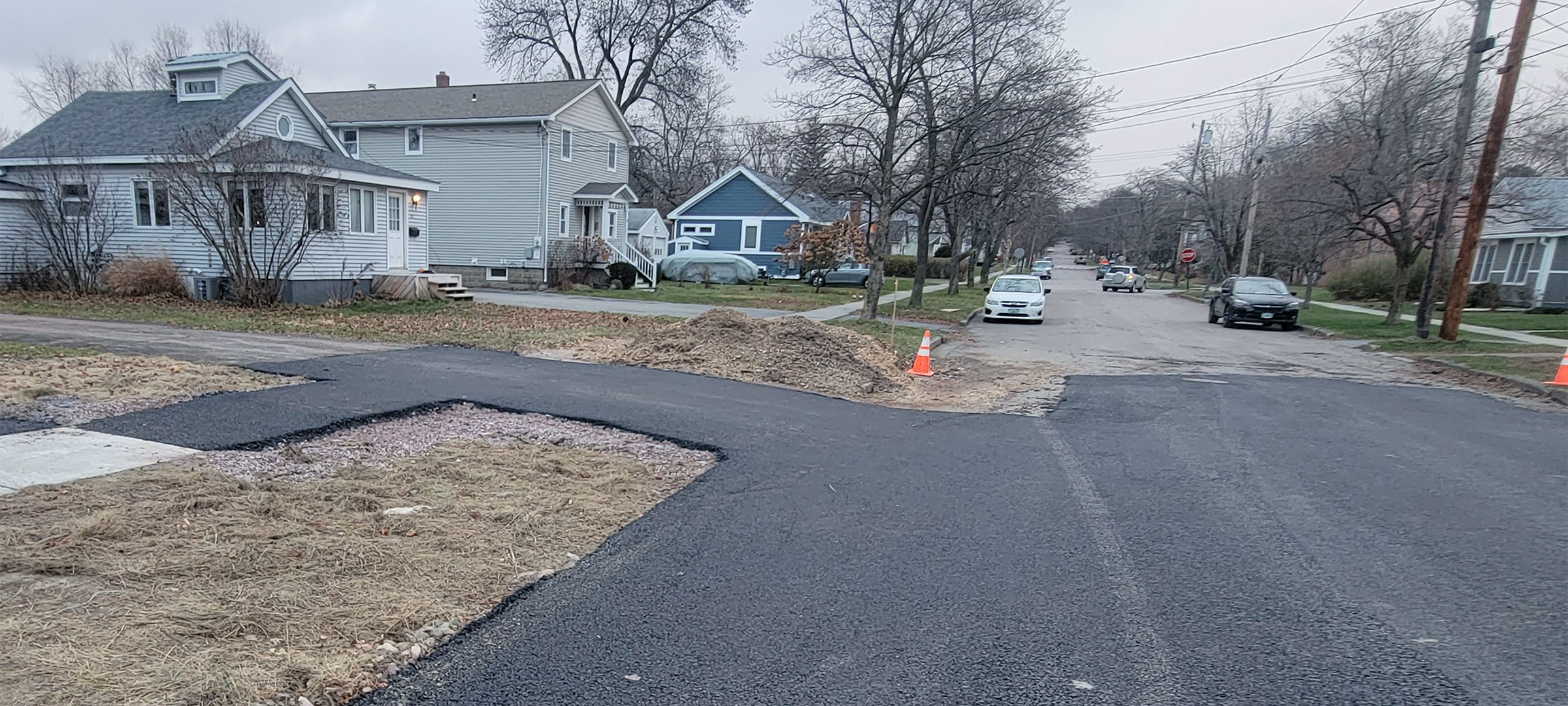

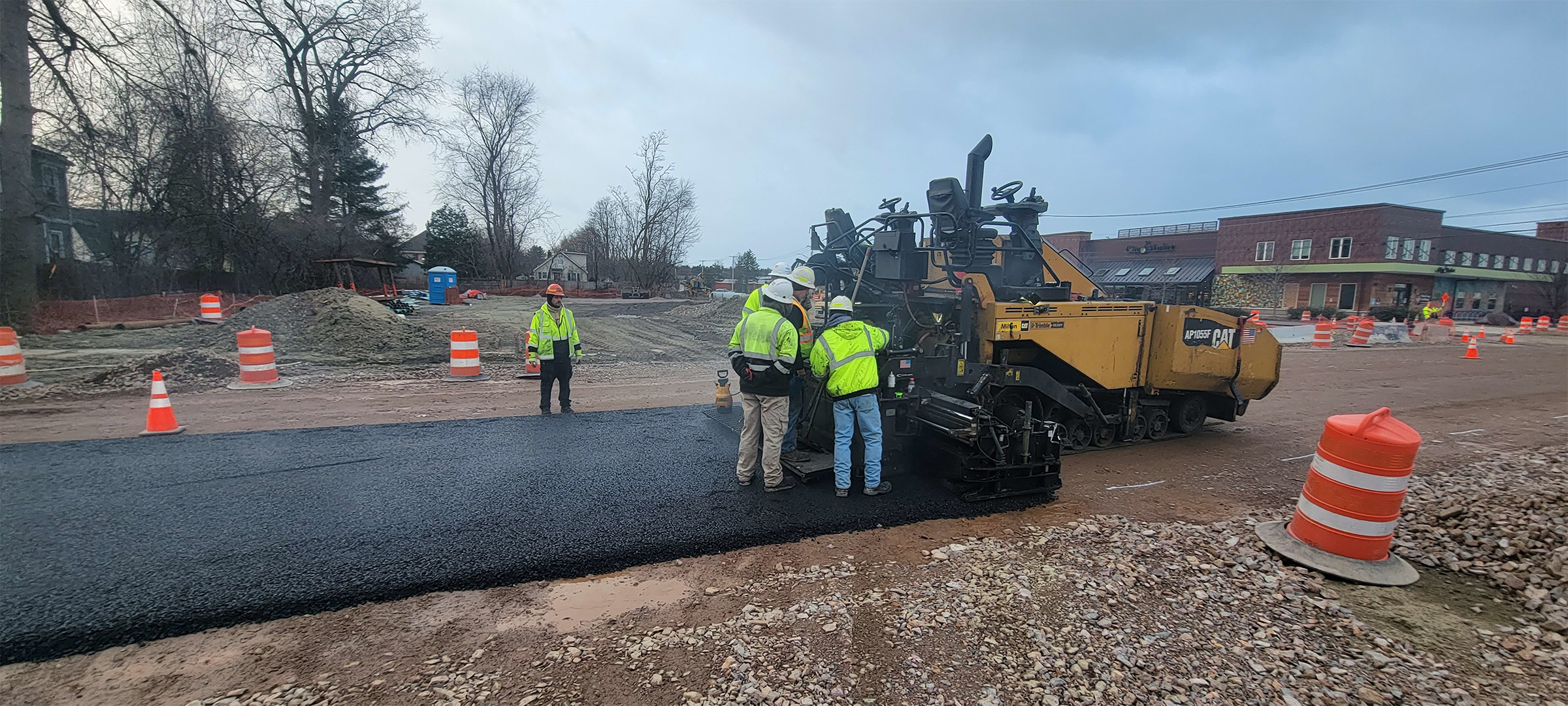

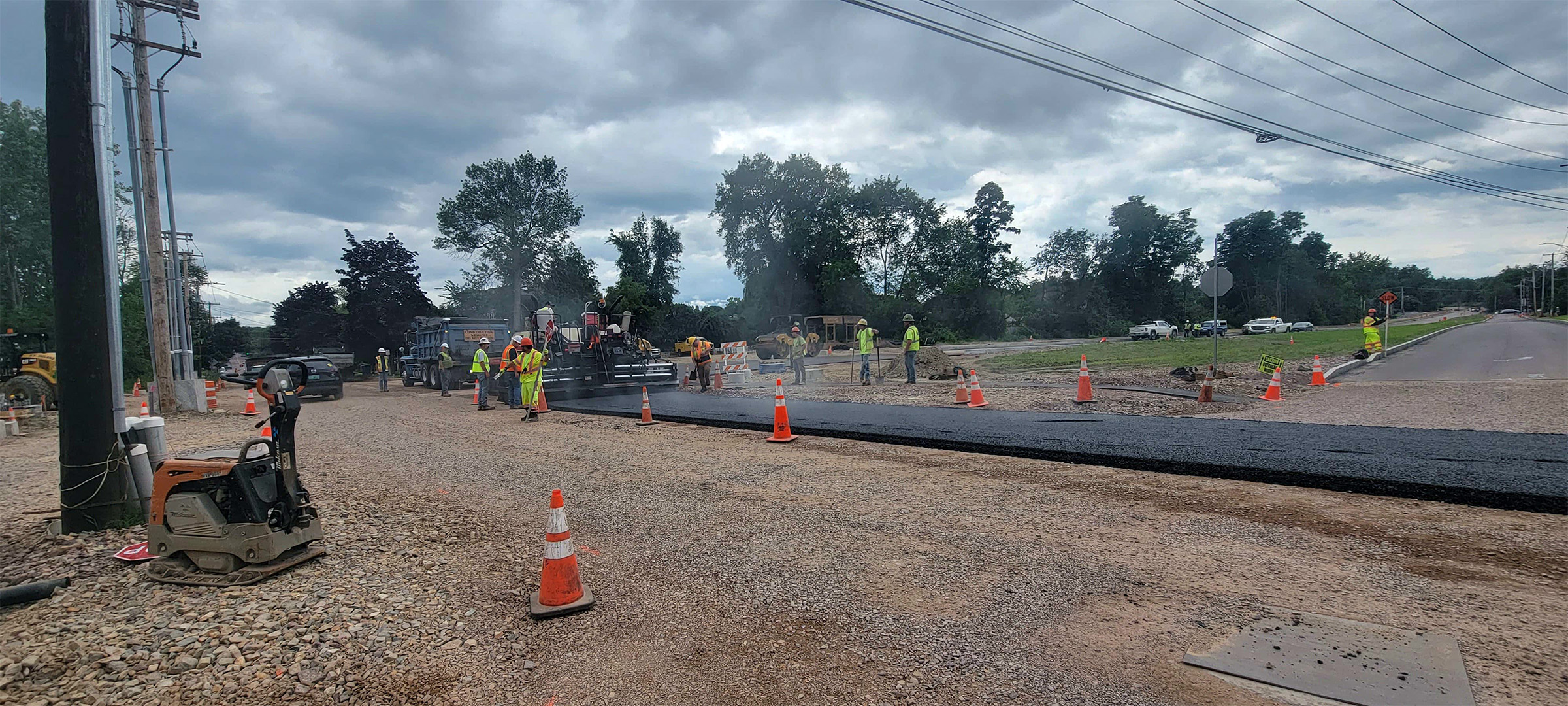

Temporary paving of Sears Lane.
Temporary paving of Sears Lane.
Temporary paving of Sears Lane.

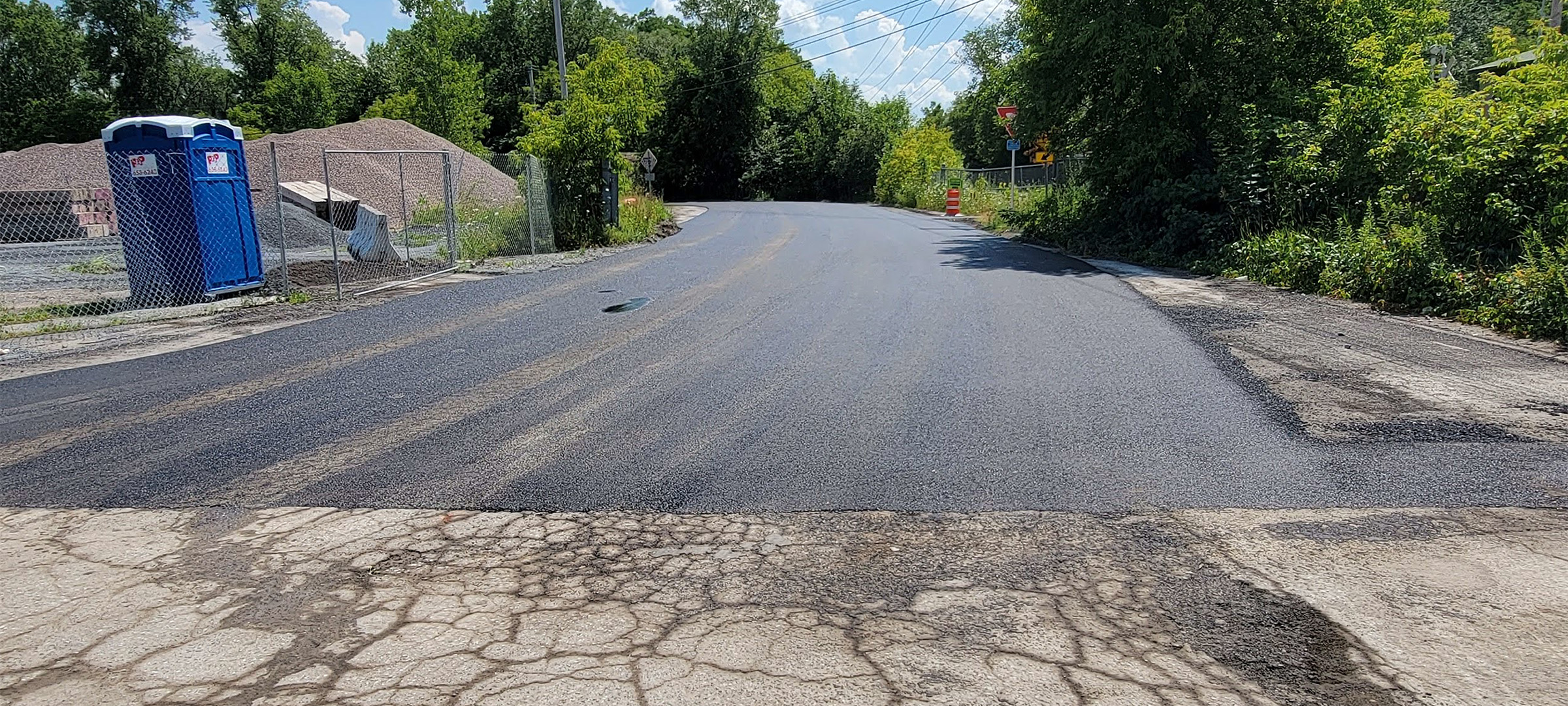

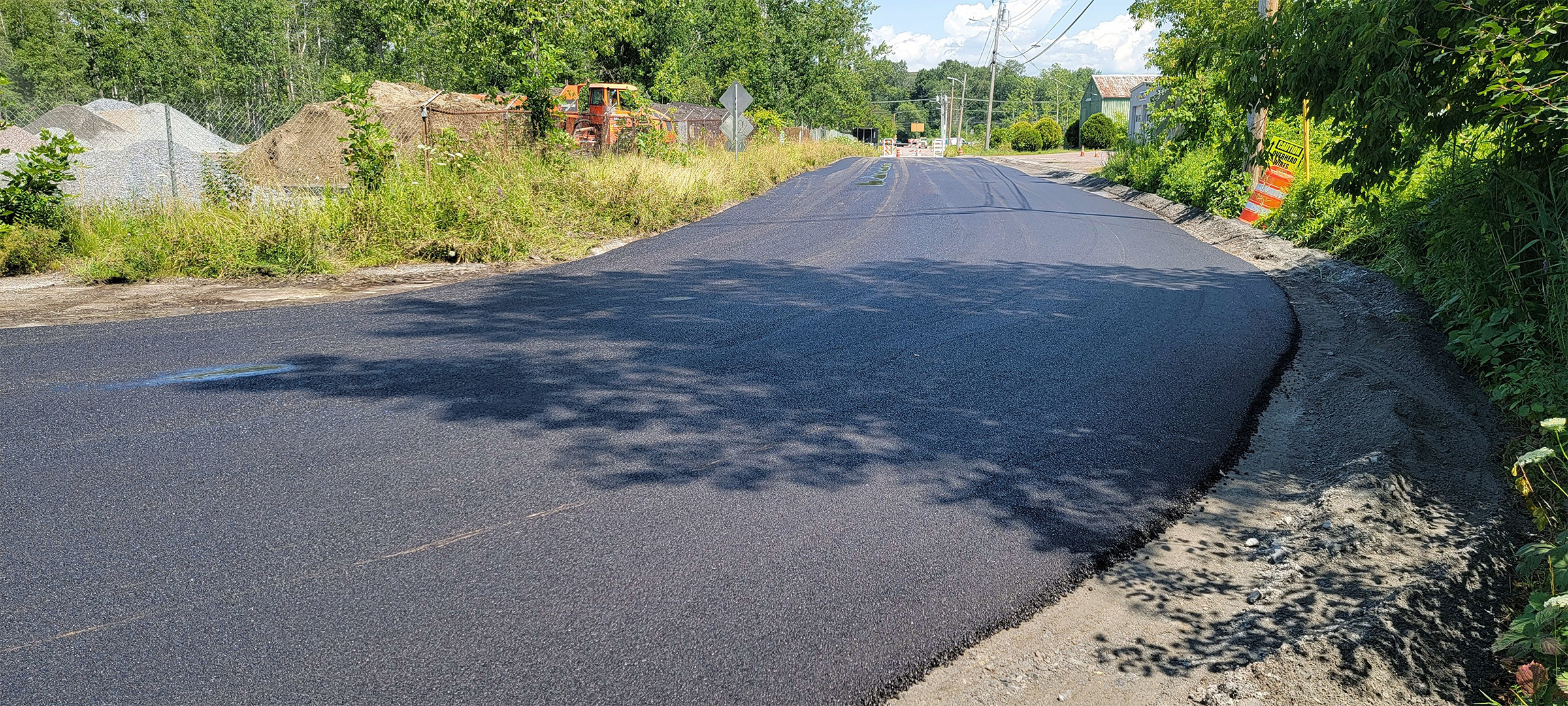

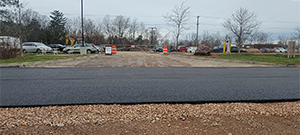

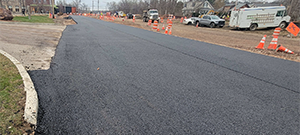

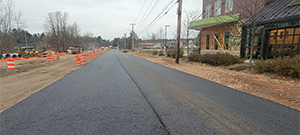

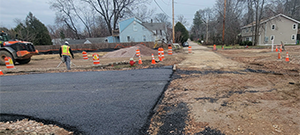

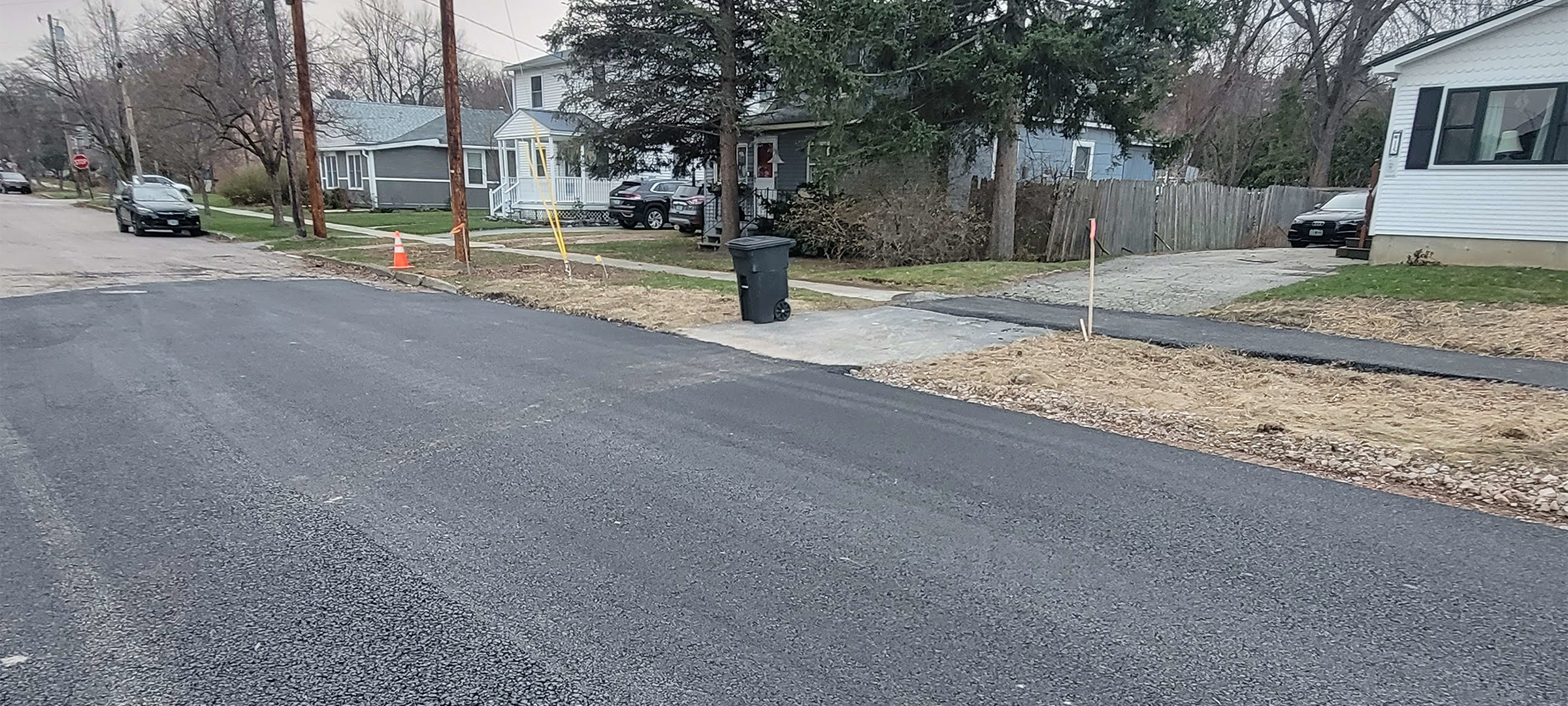

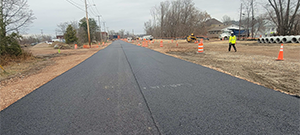

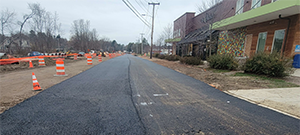

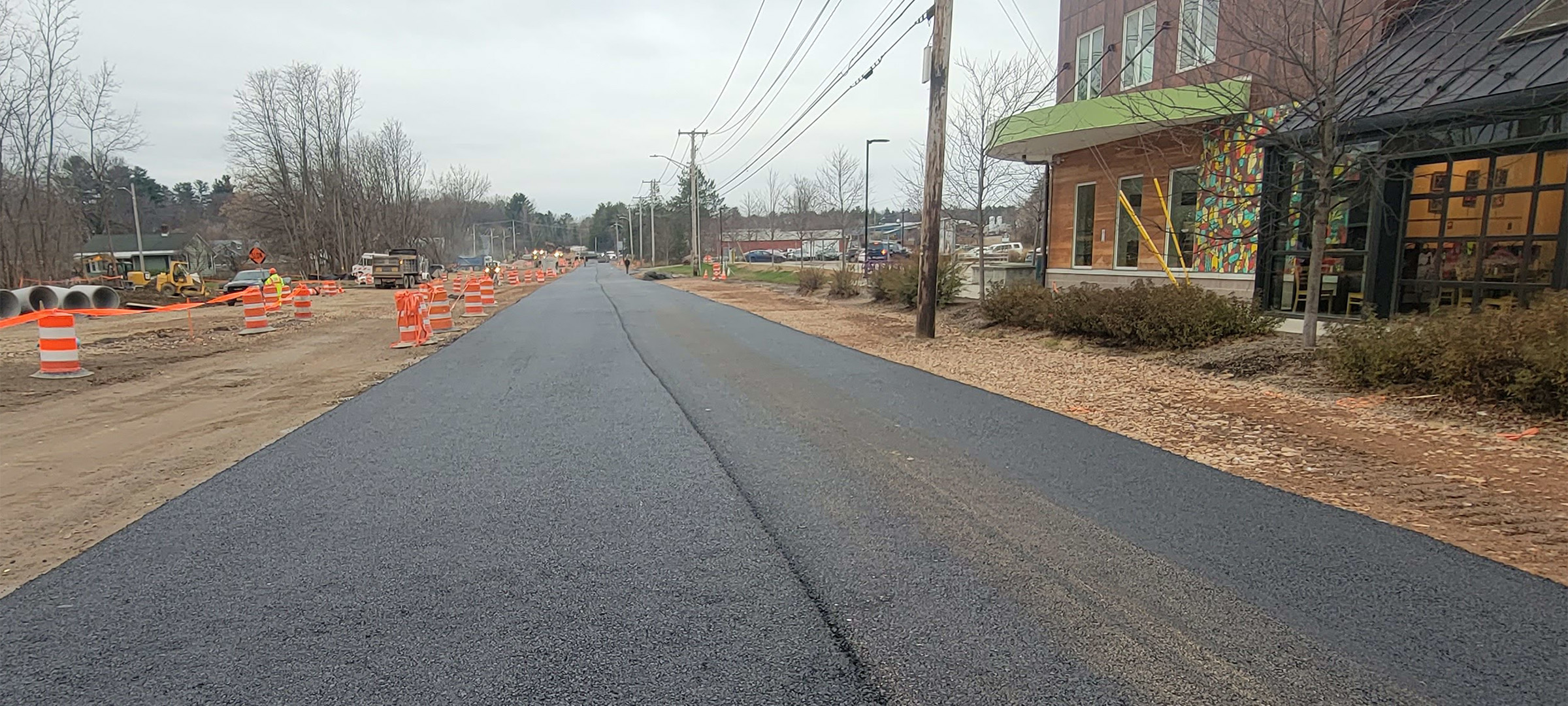

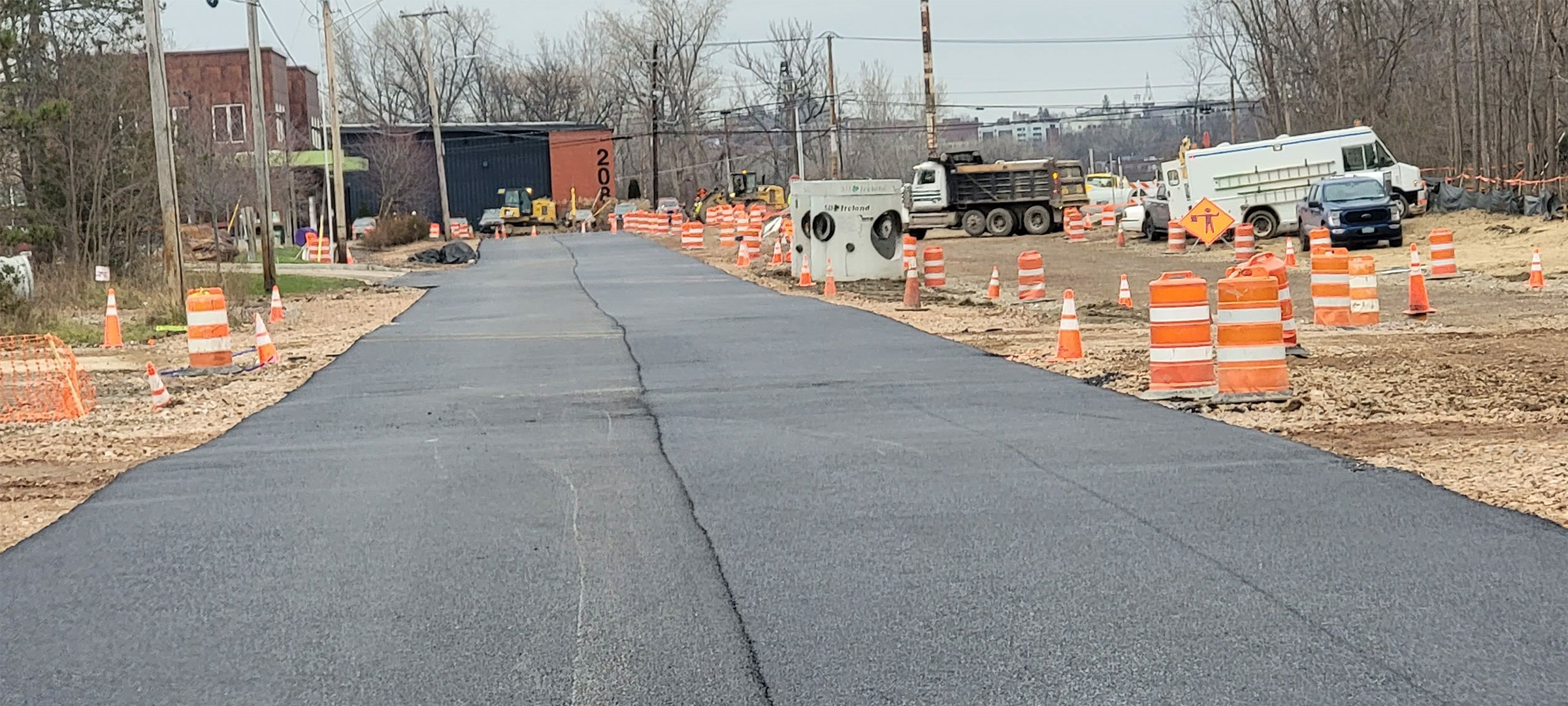

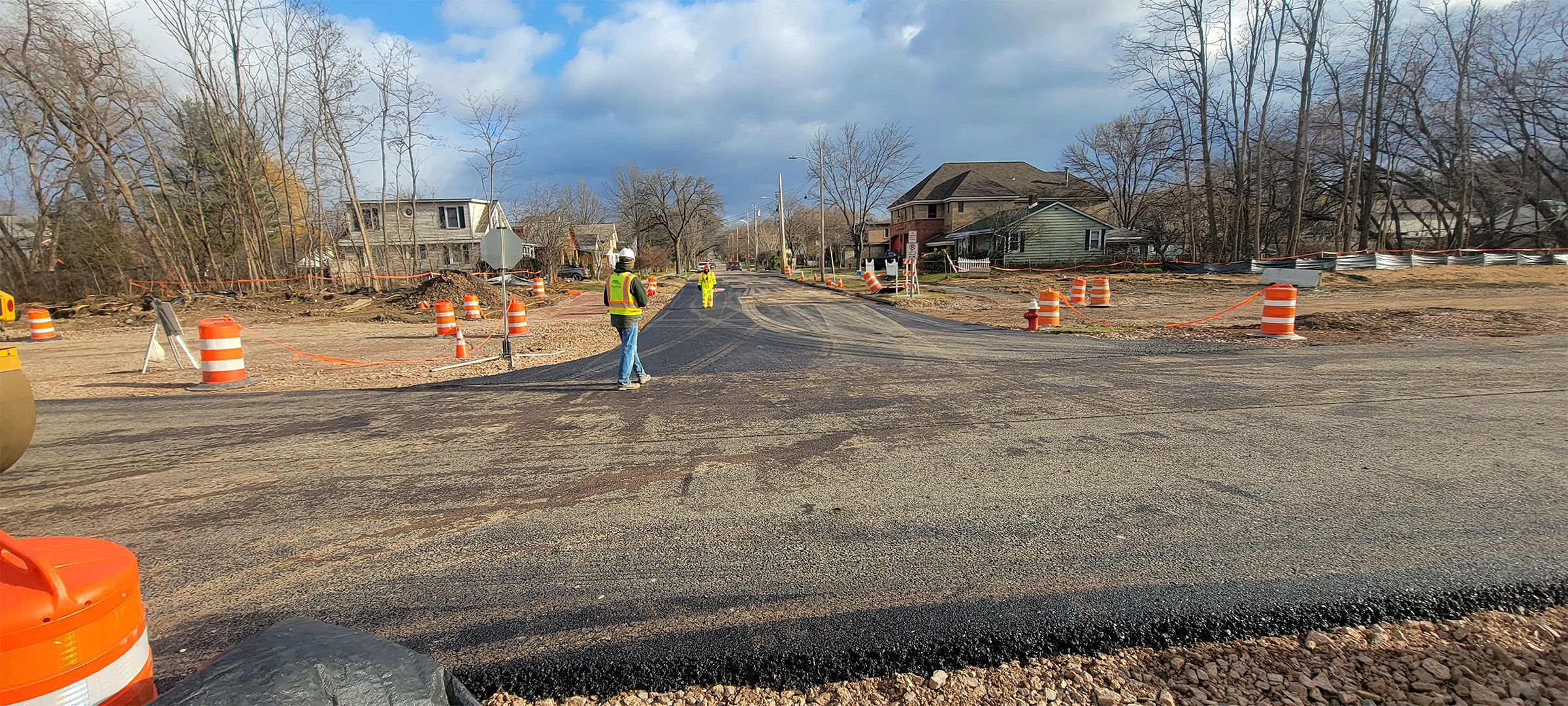

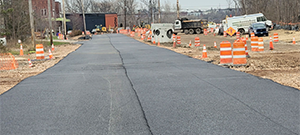

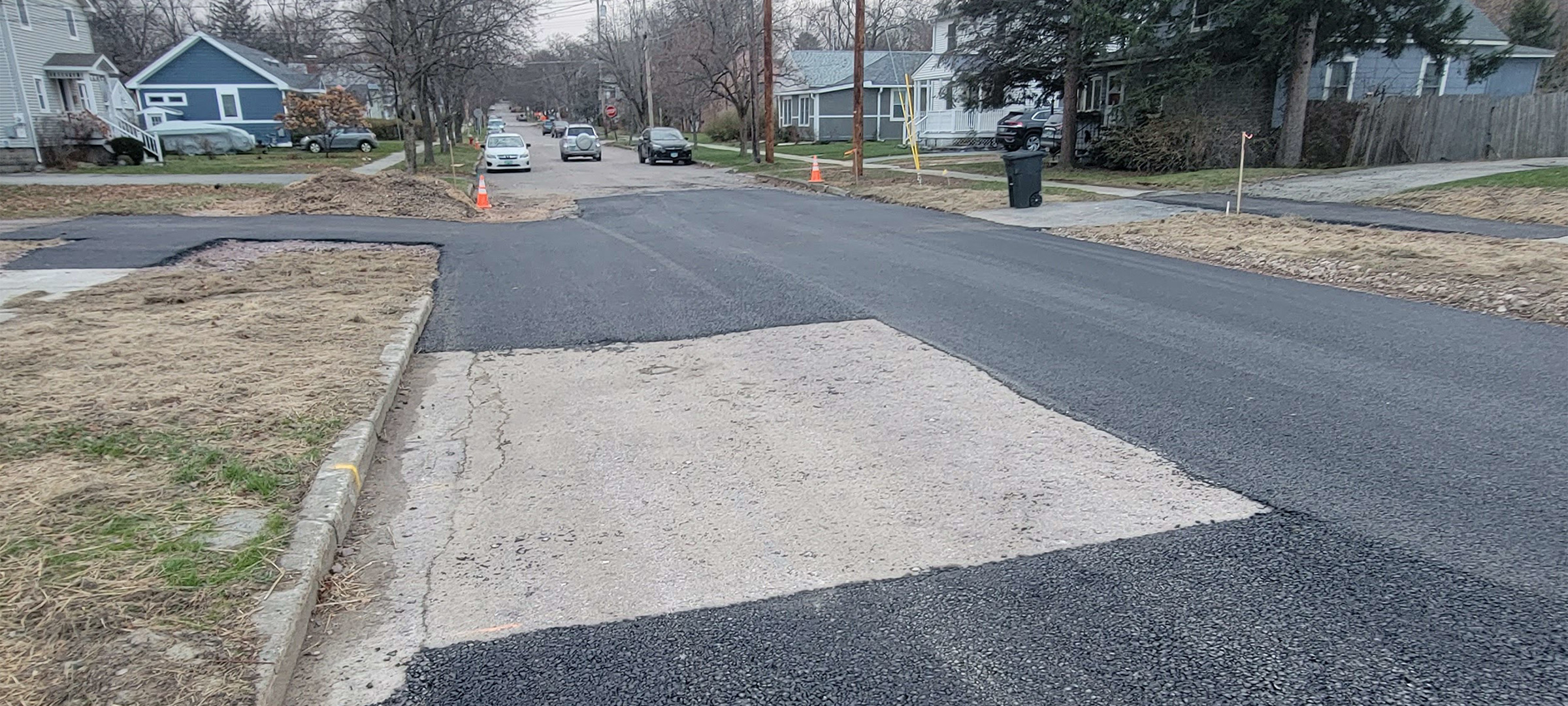

Temporary paving of Briggs Street prior to the winter shutdown after construction season 1.
Temporary paving of Briggs Street prior to the winter shutdown after construction season 1.
Temporary paving of Briggs Street prior to the winter shutdown after construction season 1.
Temporary paving of Briggs Street prior to the winter shutdown after construction season 1.
Temporary paving of Briggs Street prior to the winter shutdown after construction season 1.
Temporary paving of Briggs Street prior to the winter shutdown after construction season 1.
Temporary paving of Briggs Street prior to the winter shutdown after construction season 1.
Temporary paving of Briggs Street prior to the winter shutdown after construction season 1.

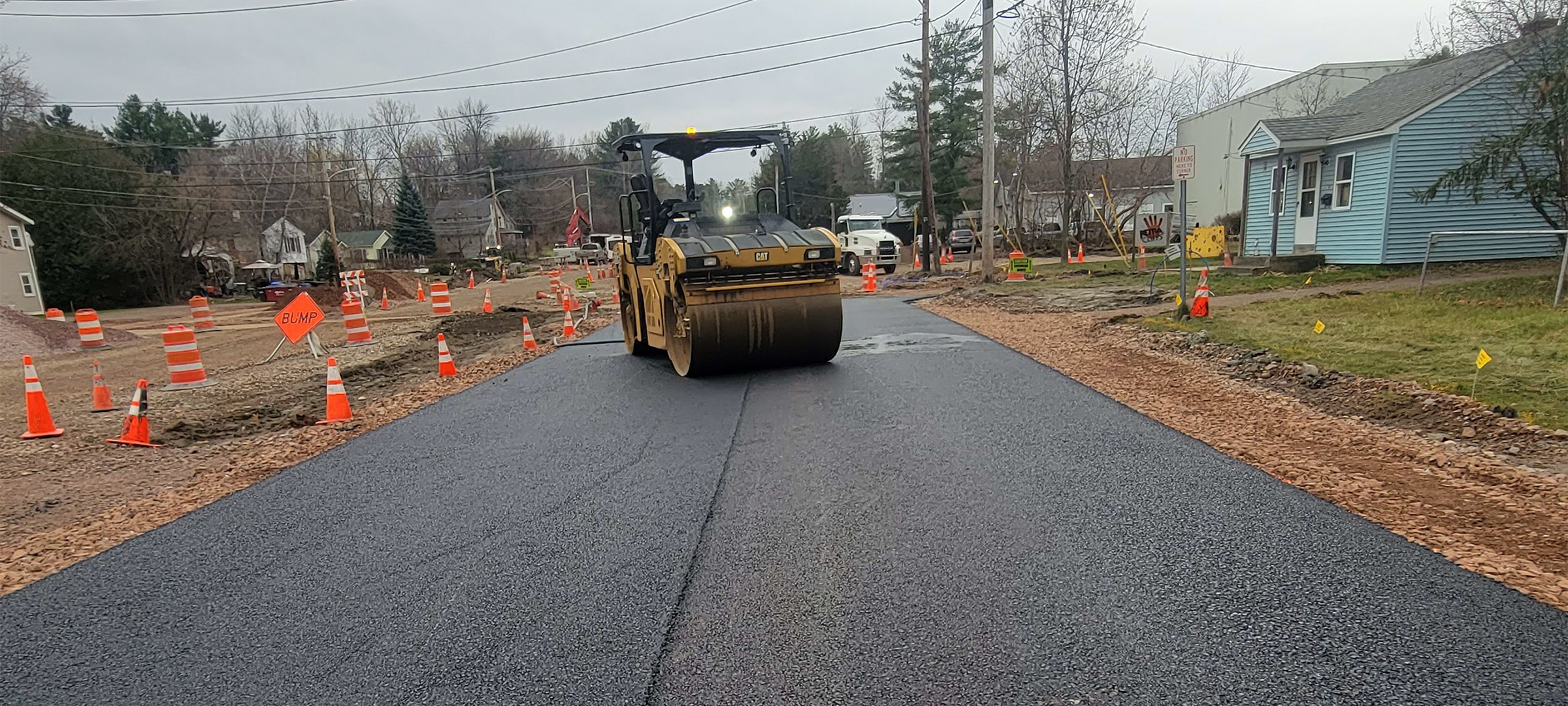

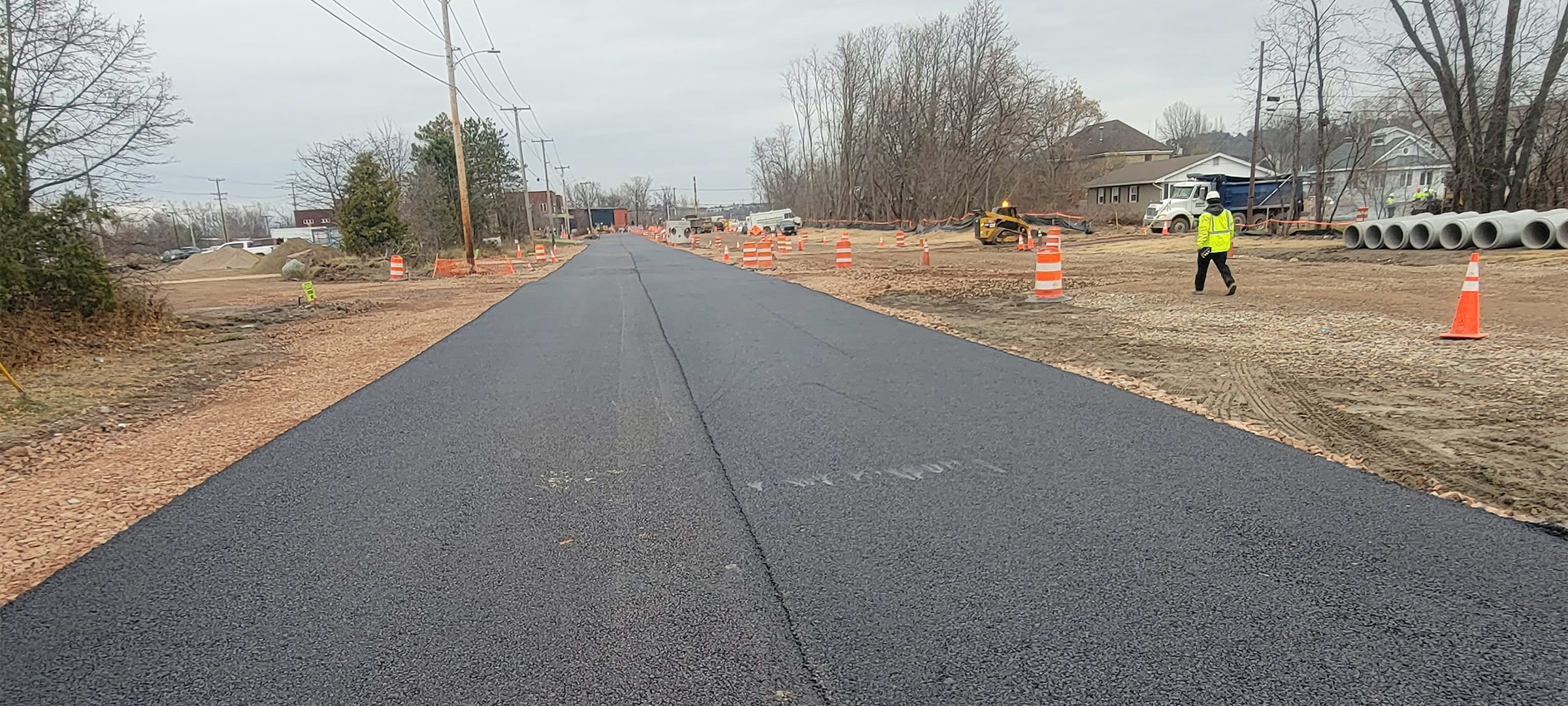

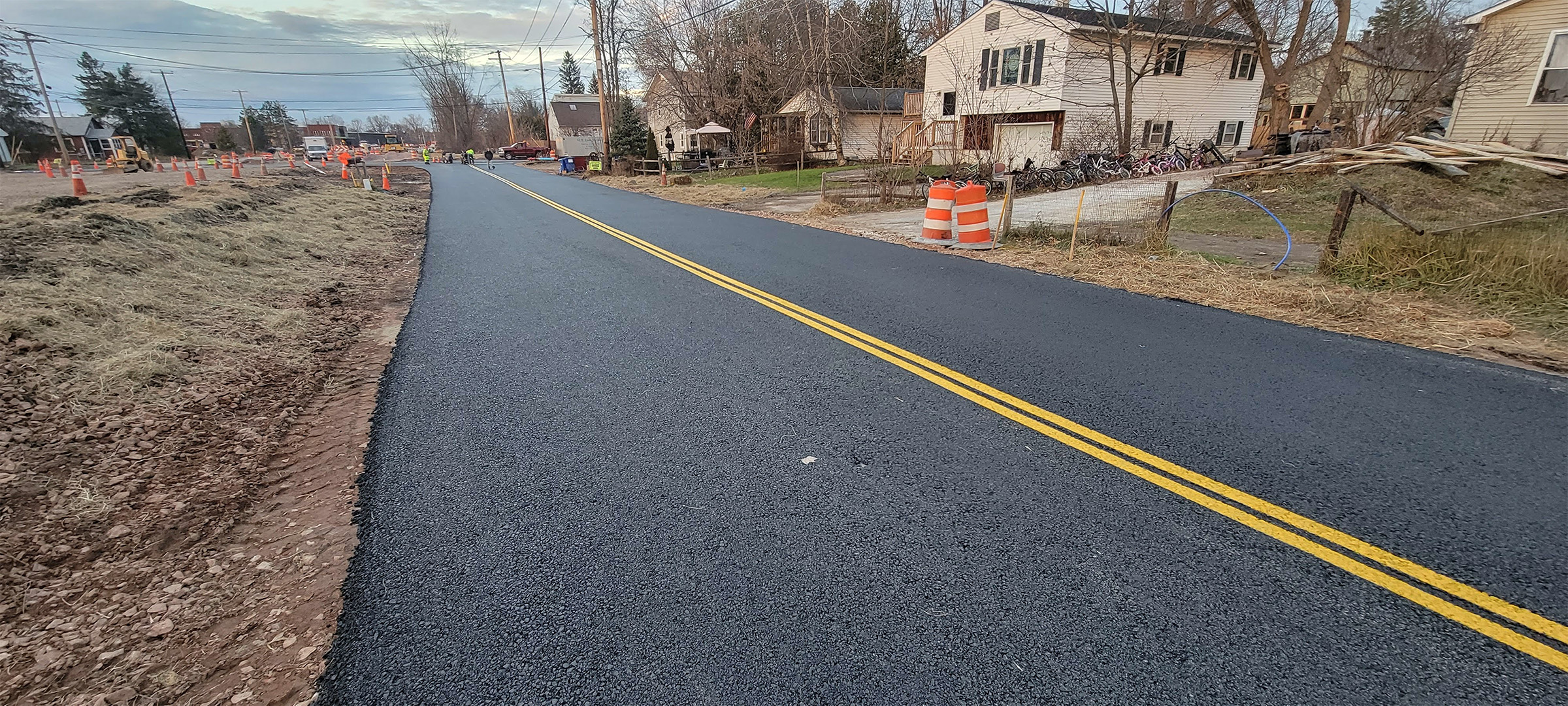

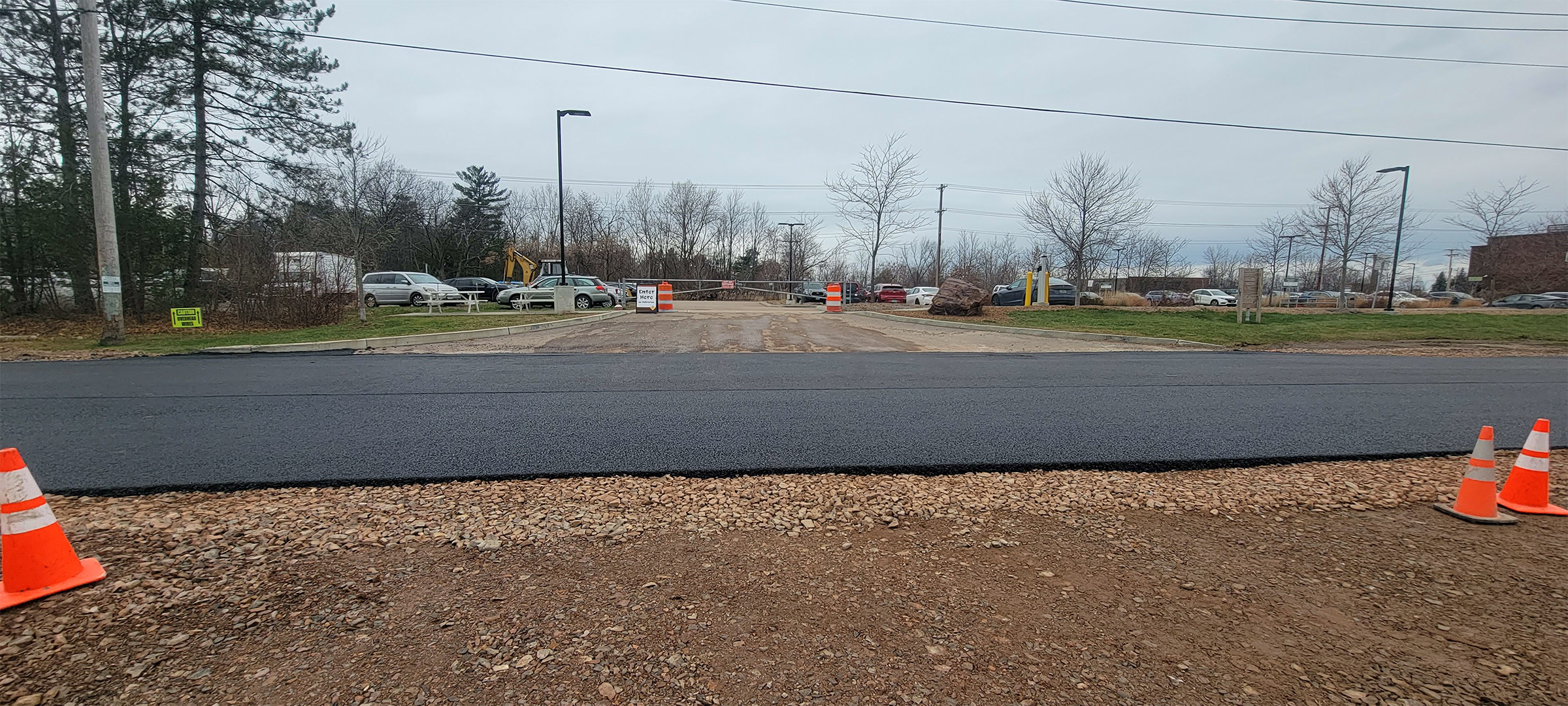

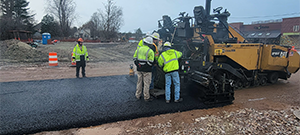

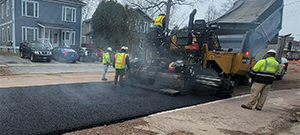

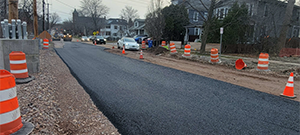

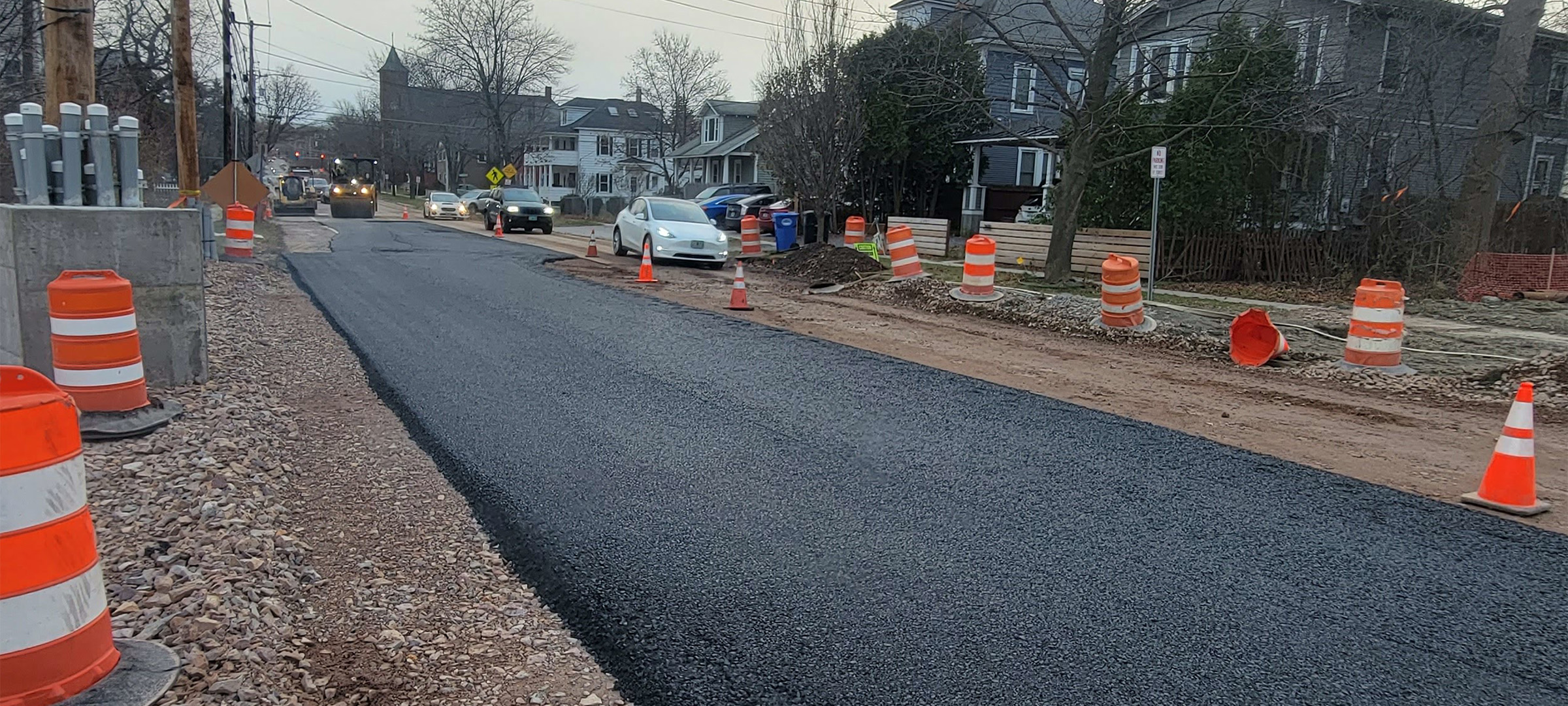

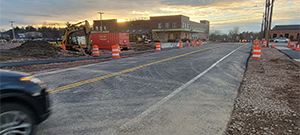

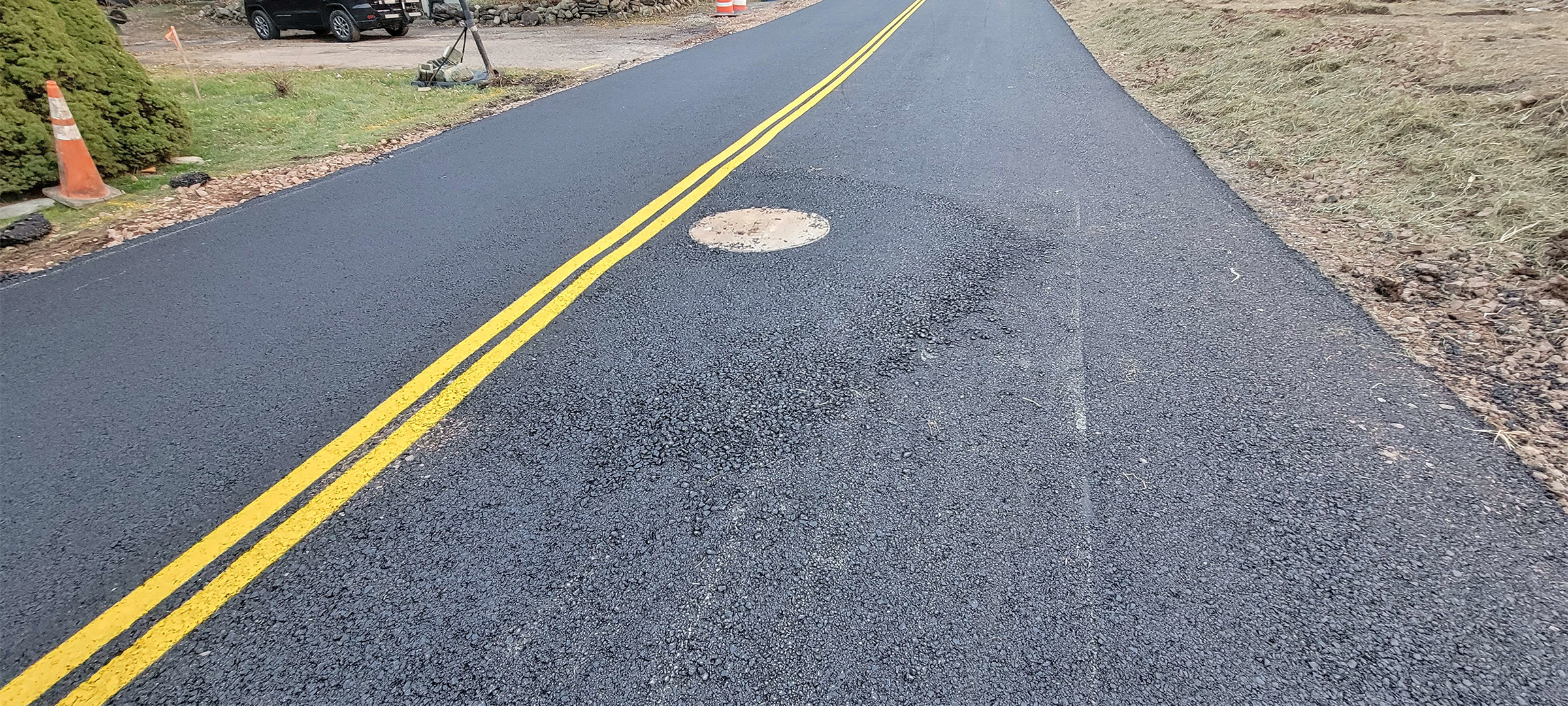

Temporary paving of Flynn Avenue prior to the winter shutdown after construction season 1.
Temporary paving of Flynn Avenue prior to the winter shutdown after construction season 1.
Temporary paving of Flynn Avenue prior to the winter shutdown after construction season 1.
Temporary paving of Flynn Avenue prior to the winter shutdown after construction season 1.
Temporary paving of Flynn Avenue prior to the winter shutdown after construction season 1.

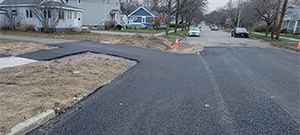

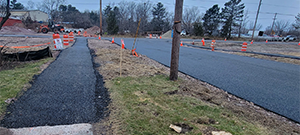

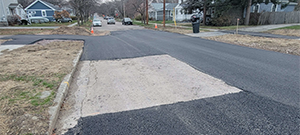

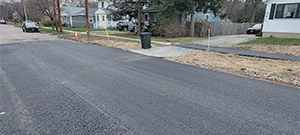

Temporary paving of Lyman Avenue prior to the winter shutdown after construction season 1.
Temporary paving of Lyman Avenue prior to the winter shutdown after construction season 1.
Temporary paving of Lyman Avenue prior to the winter shutdown after construction season 1.
Temporary paving of Lyman Avenue prior to the winter shutdown after construction season 1.

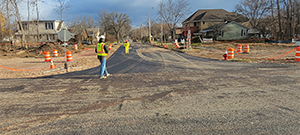

Temporary paving of Ferguson Avenue prior to the winter shutdown after construction season 1.

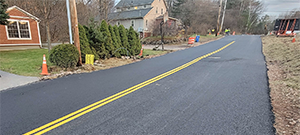

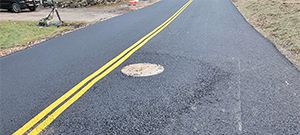

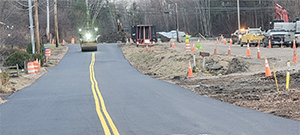

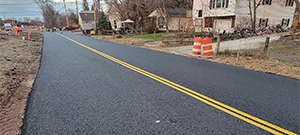

Temporary paving of Batchelder Street prior to the winter shutdown after construction season 1.
Temporary paving of Batchelder Street prior to the winter shutdown after construction season 1.
Temporary paving of Batchelder Street prior to the winter shutdown after construction season 1.
Temporary paving of Batchelder Street prior to the winter shutdown after construction season 1.

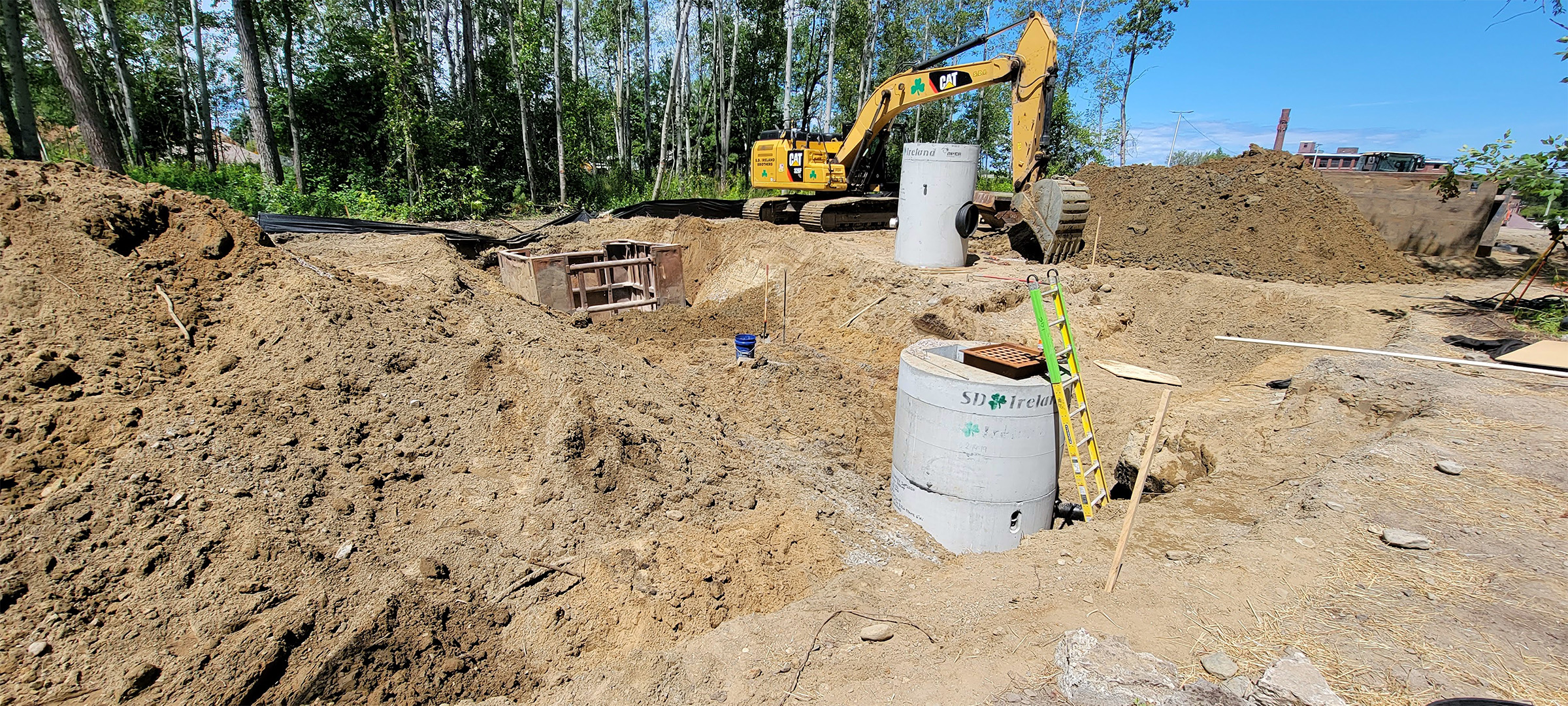

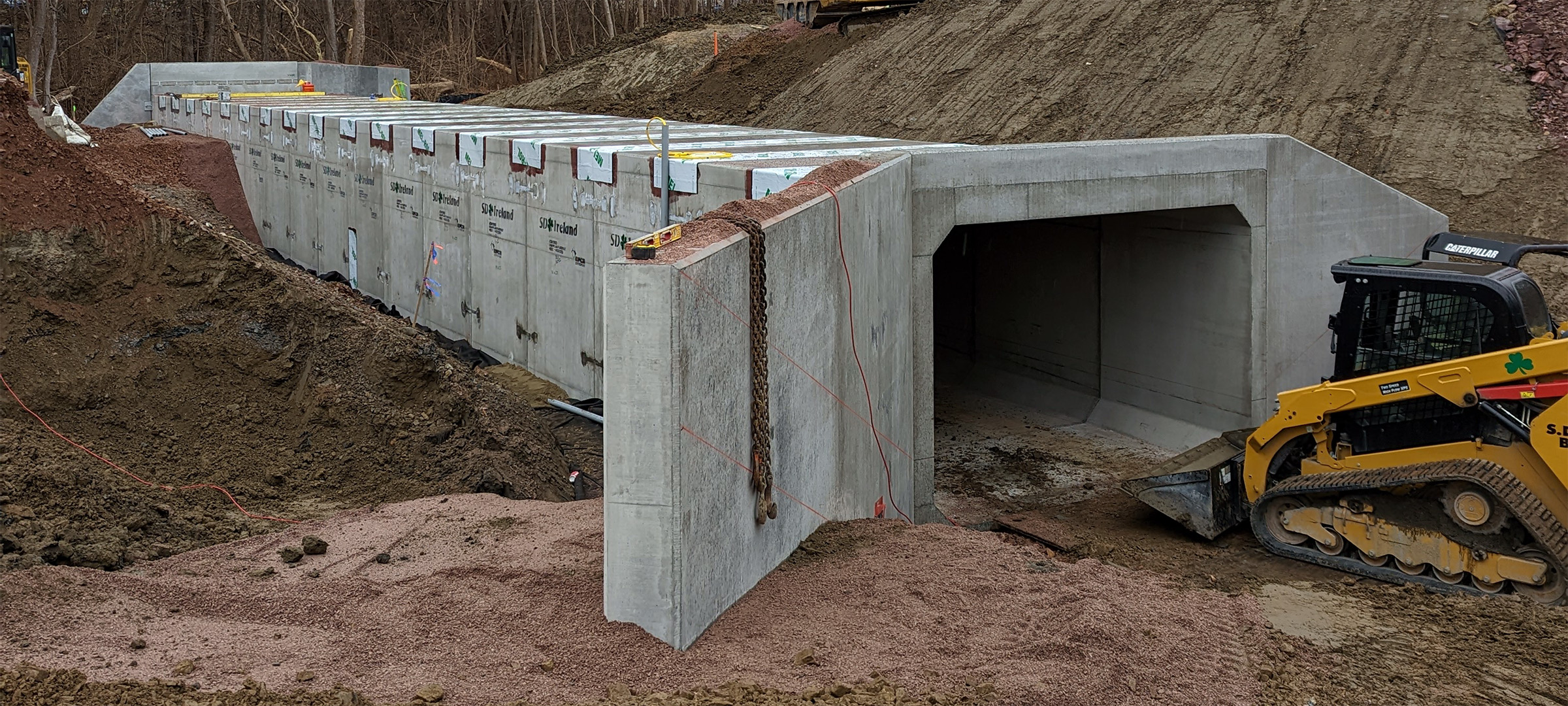

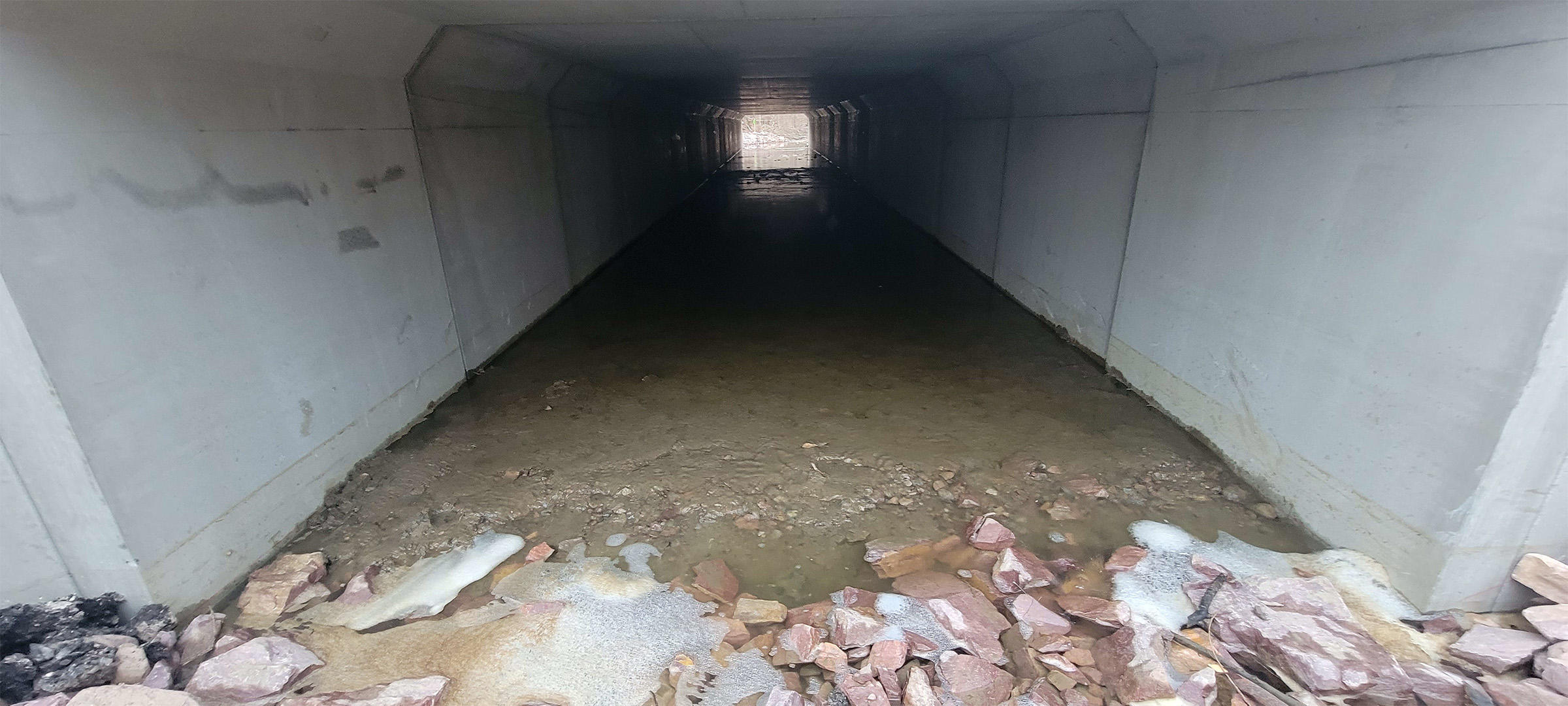

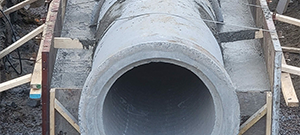

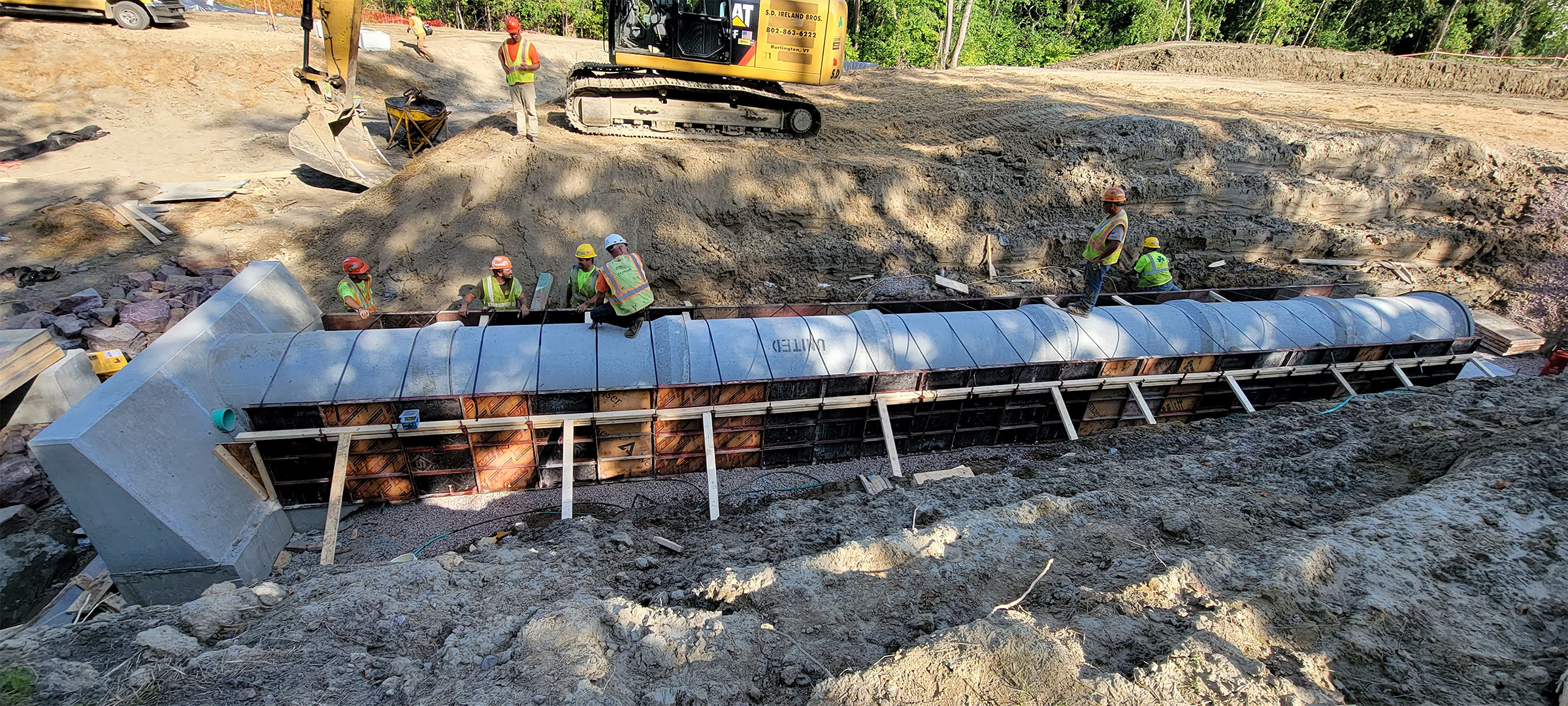

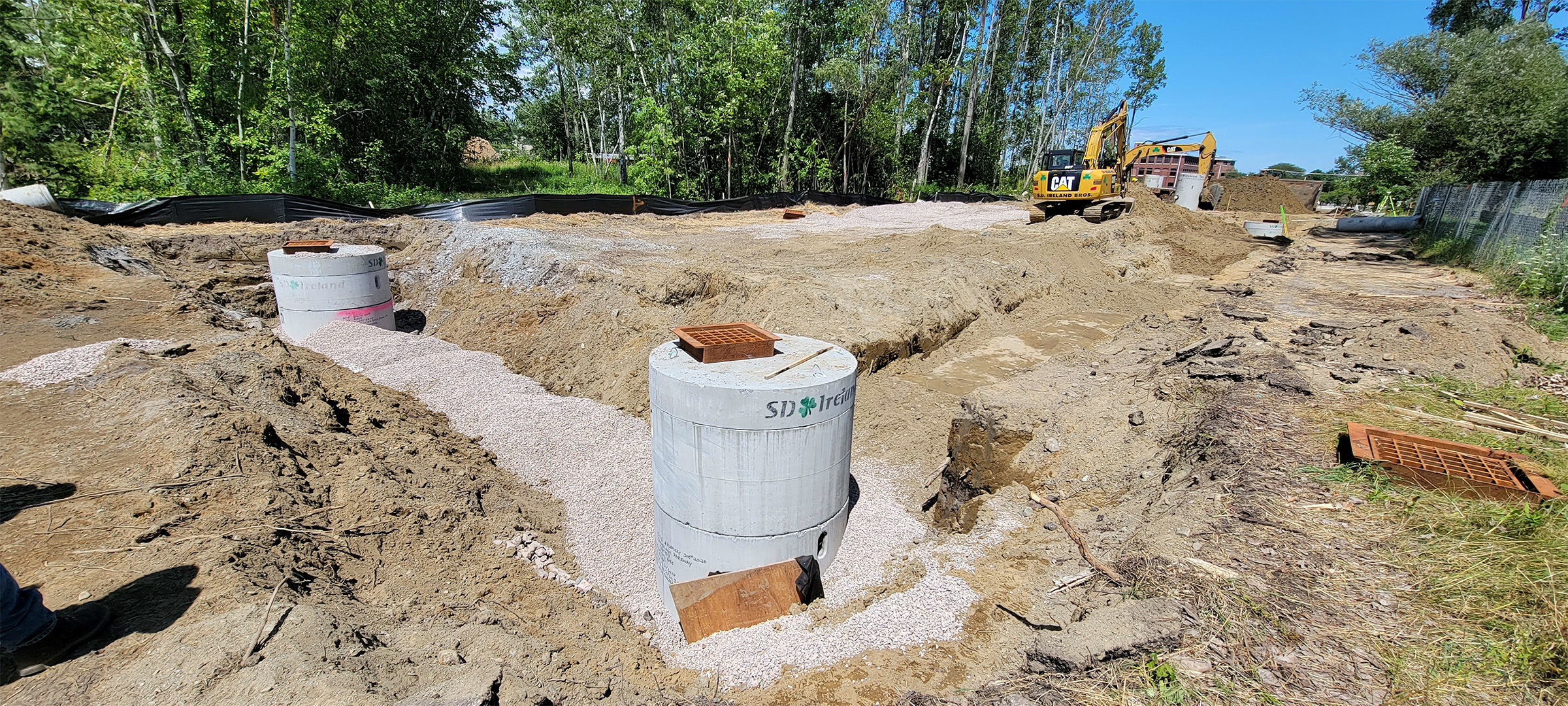

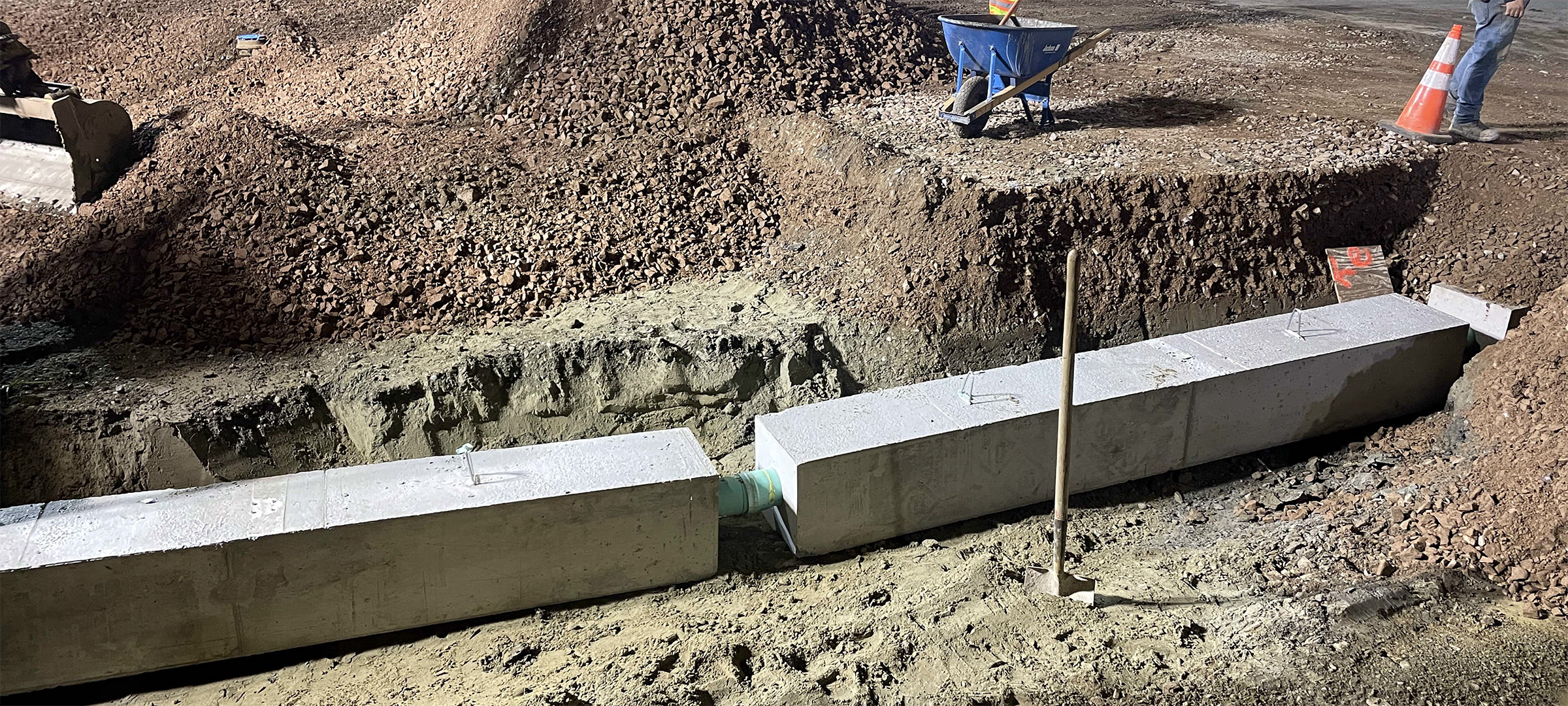

The Champlain Parkway included several stormwater features including the construction of a stormwater detention pond near Englesby Brook.
The Champlain Parkway included several stormwater features including the construction of a stormwater detention pond near Englesby Brook. Pictured pipe footing.
The Champlain Parkway included several stormwater features including the construction of a stormwater detention pond near Englesby Brook. Pictured outlet pipe on footing and headwall form.
The Champlain Parkway included several stormwater features including the construction of a stormwater detention pond near Englesby Brook. Pictured outlet pipe on footing and headwall form.
The Champlain Parkway included several stormwater features including the construction of a stormwater detention pond near Englesby Brook. Pictured concrete forms.
The Champlain Parkway included several stormwater features including the construction of a stormwater detention pond near Englesby Brook. Pictured outpipe, headwall, and concrete pours.
The Champlain Parkway included several stormwater features including the construction of a stormwater detention pond near Englesby Brook. Pictured completed outlet pipe.
The Champlain Parkway included several stormwater features including the construction of a stormwater detention pond near Englesby Brook. Pictured primary outlet structure.
The Champlain Parkway included several stormwater features including the construction of a stormwater detention pond near Englesby Brook. Pictured primary outlet structure.
The Champlain Parkway included several stormwater features including the construction of a stormwater detention pond near Englesby Brook. Pictured installation of drainage pipe.
The Champlain Parkway included several stormwater features including the construction of a stormwater detention pond near Englesby Brook.
The Champlain Parkway included several stormwater features including the construction of a stormwater detention pond near Englesby Brook. Pictured geomembrane liner.
The Champlain Parkway included several stormwater features including the construction of a stormwater detention pond near Englesby Brook. Pictured cable matting.

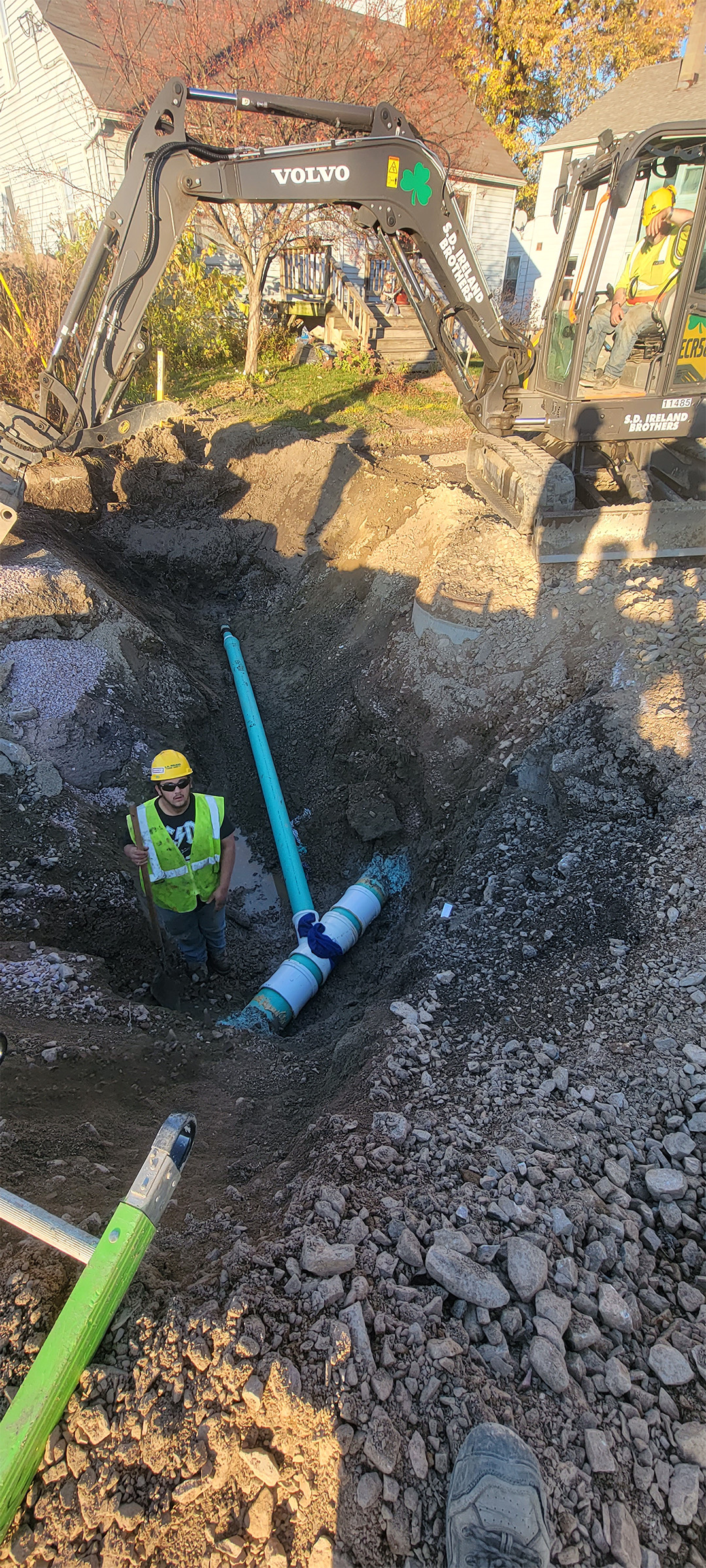

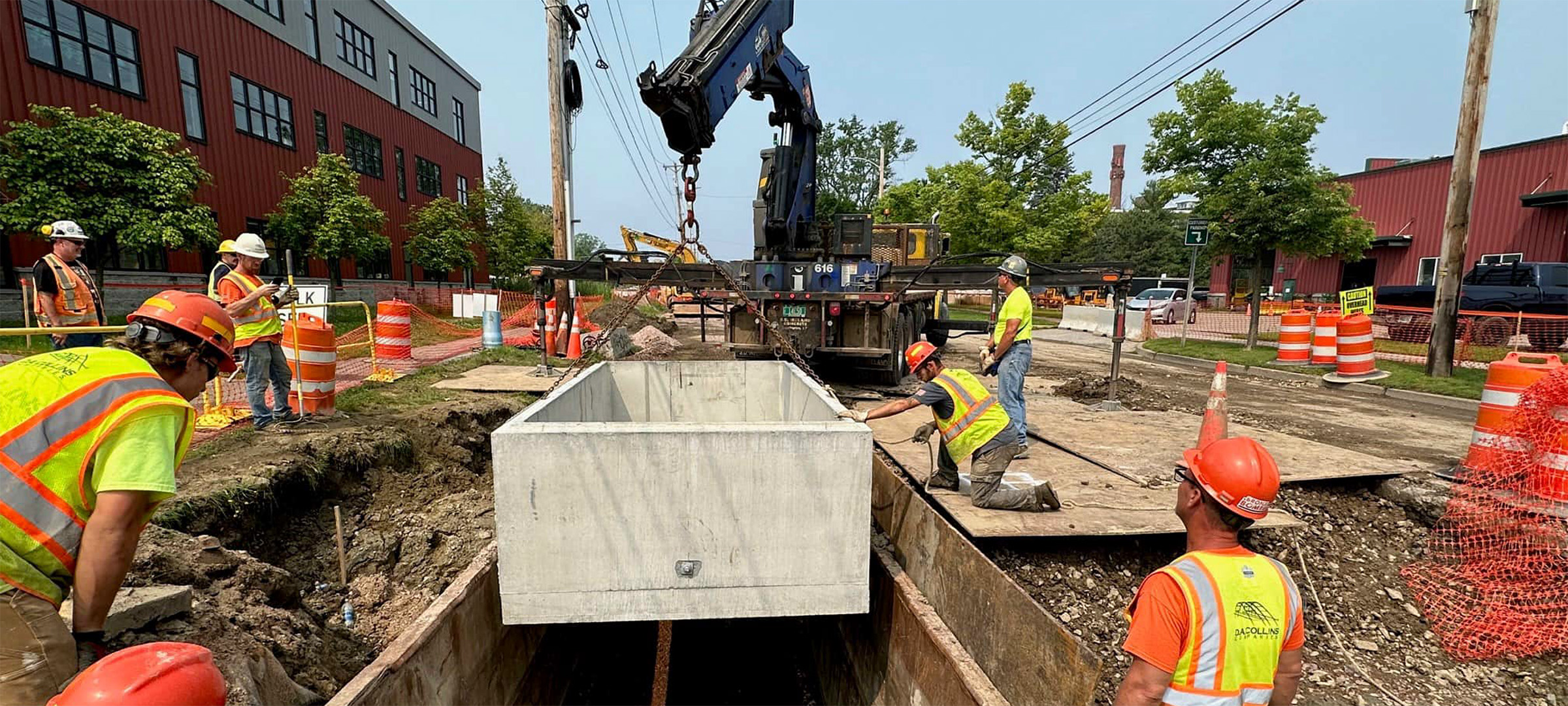

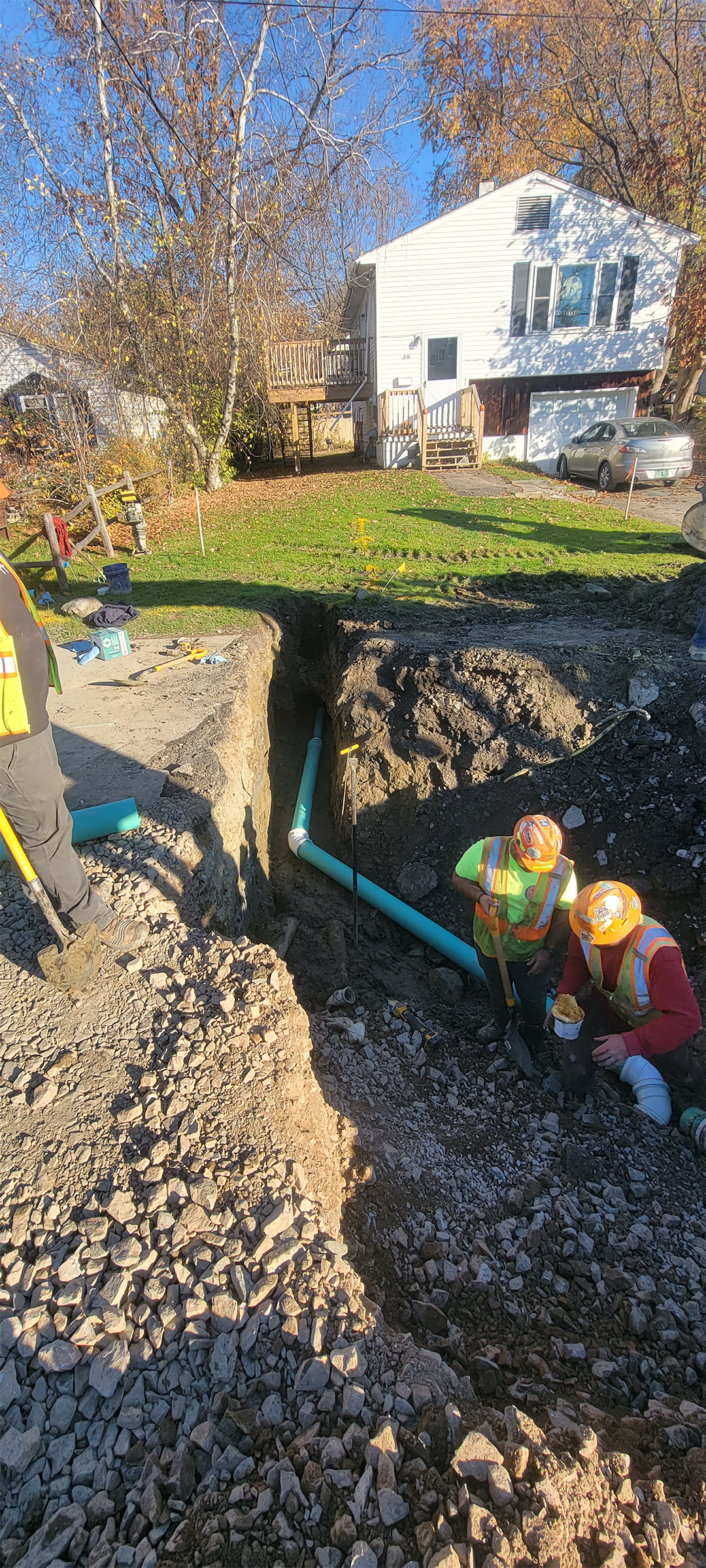

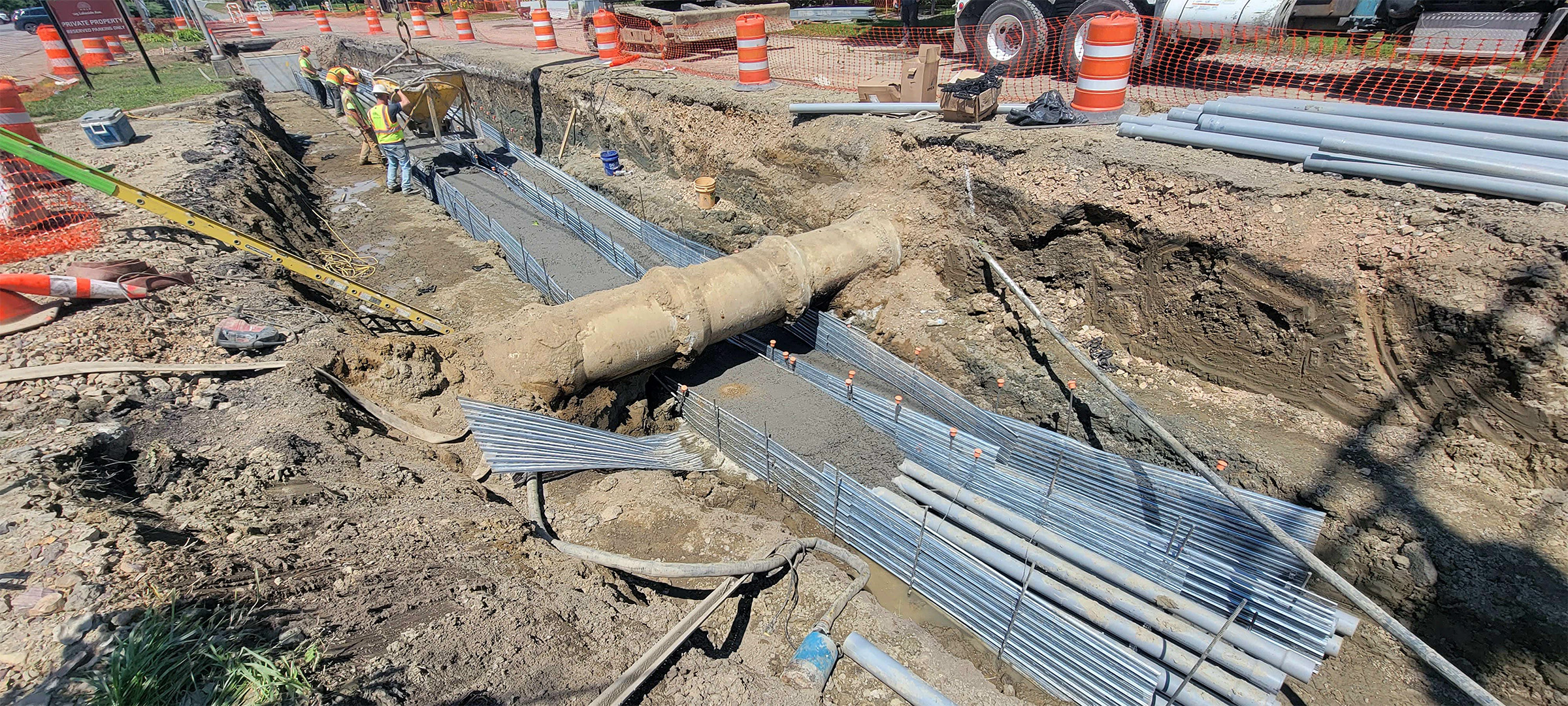

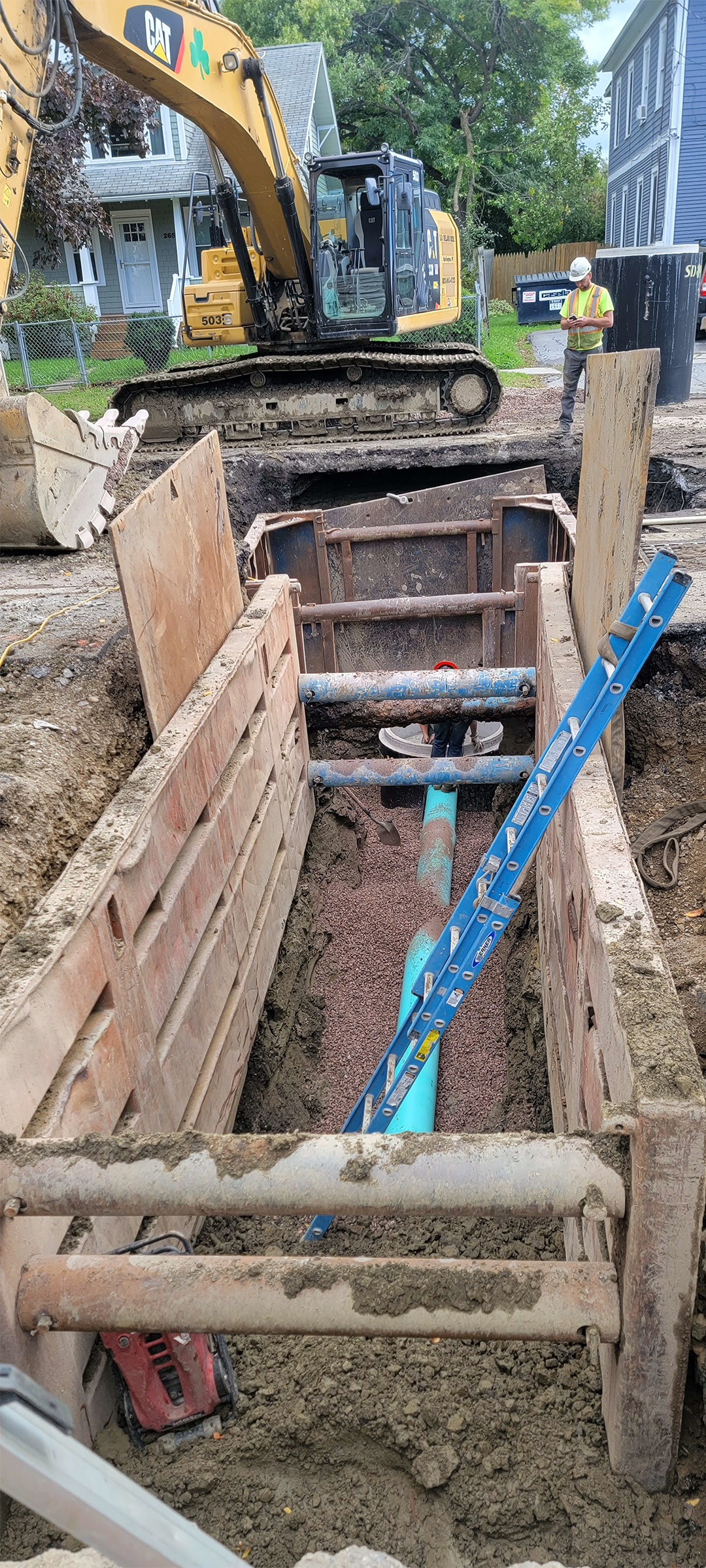

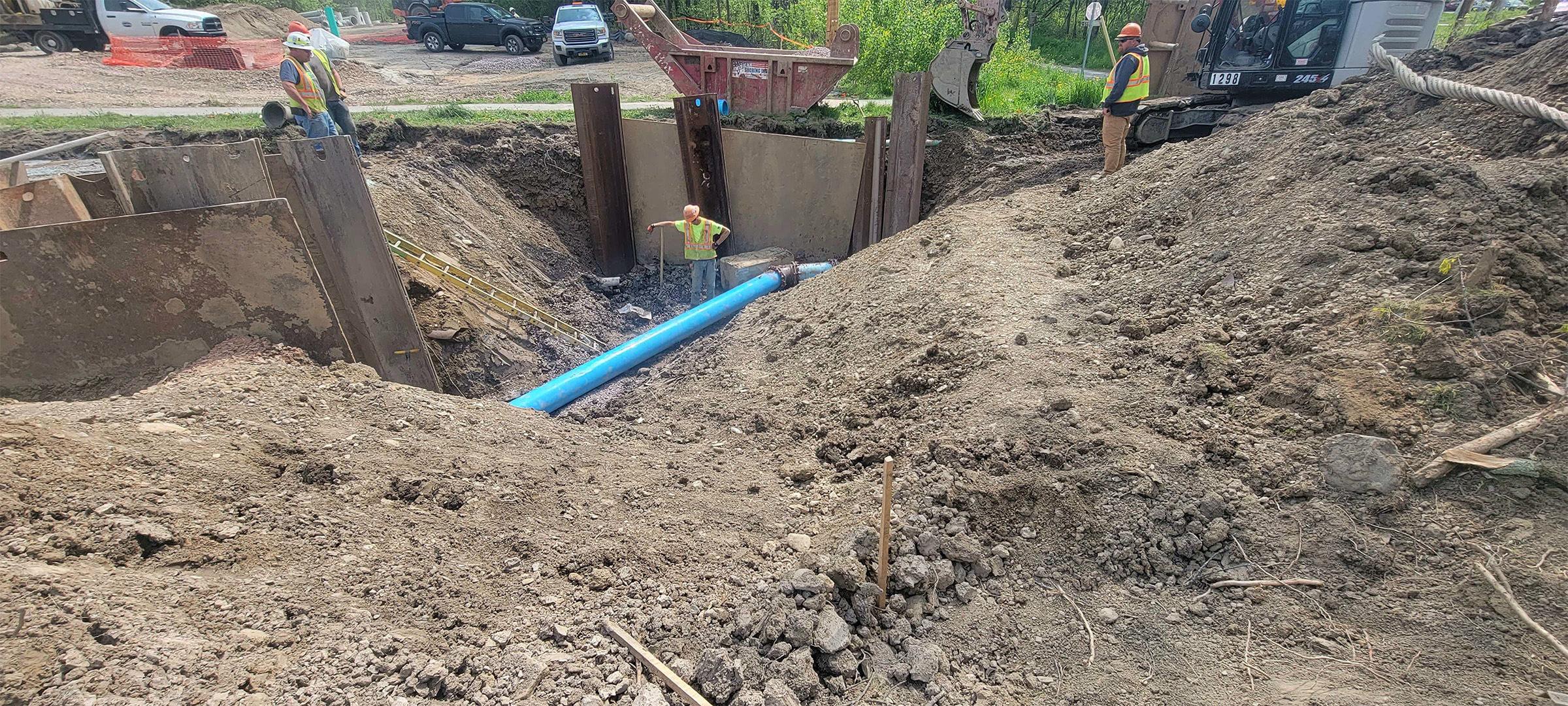

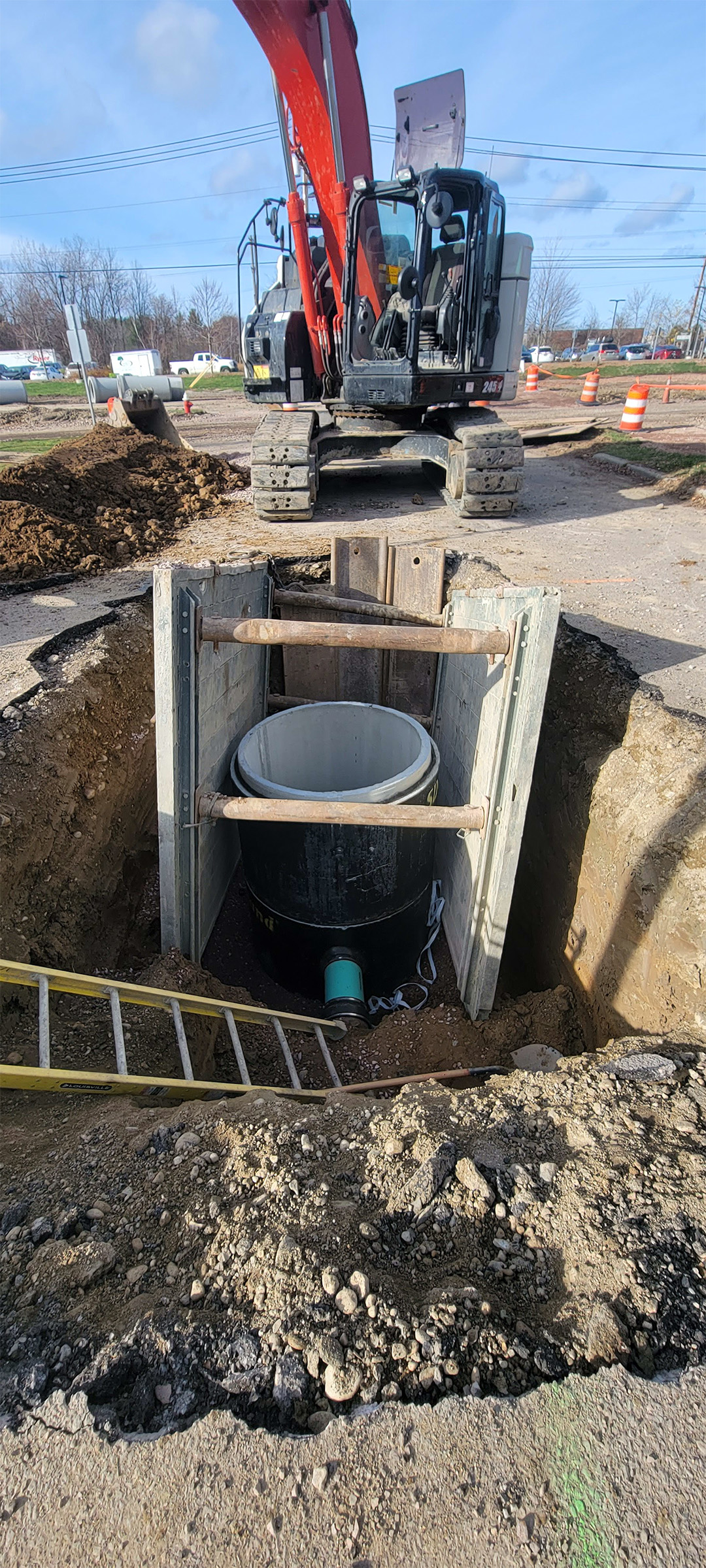

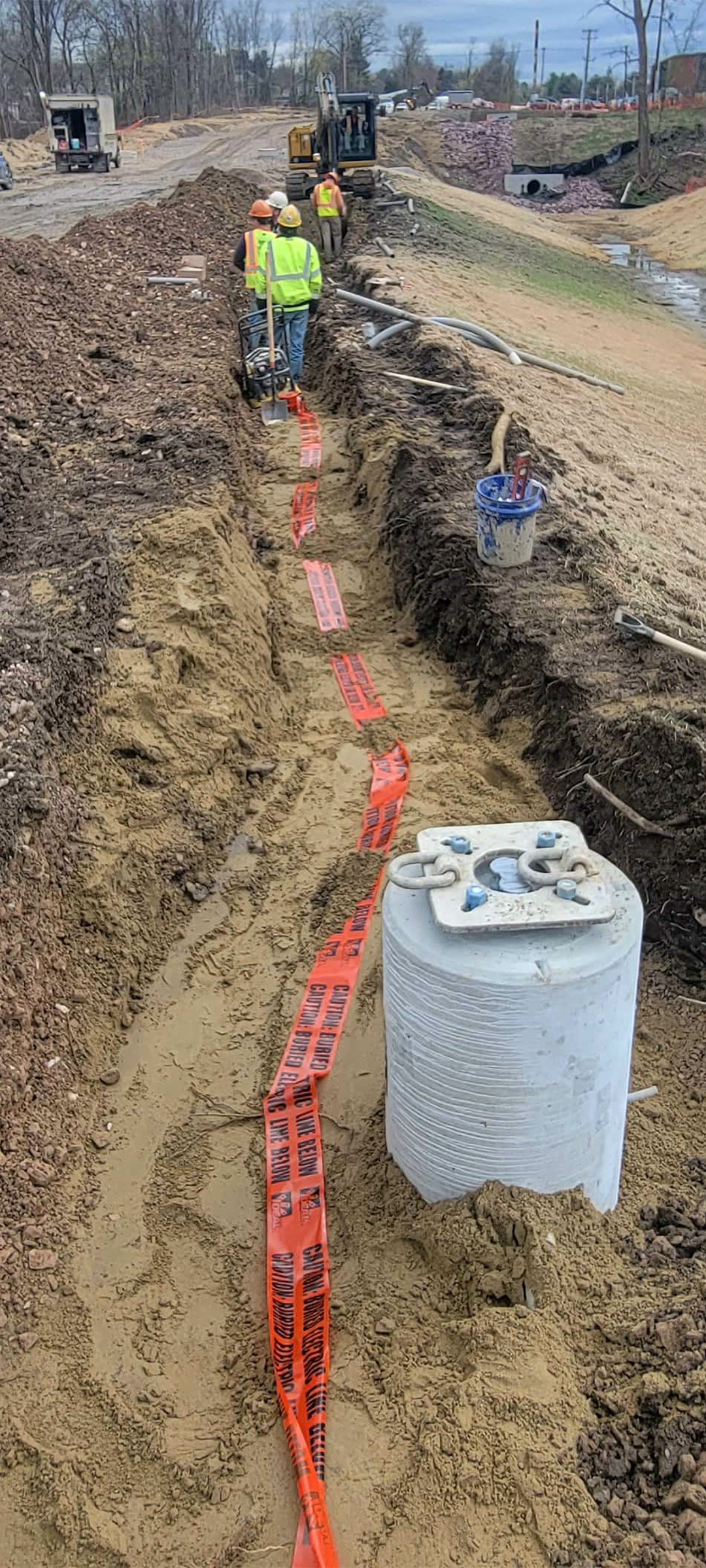

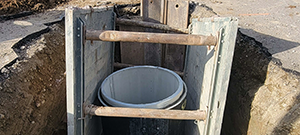

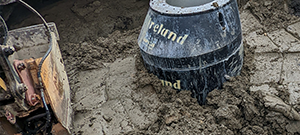

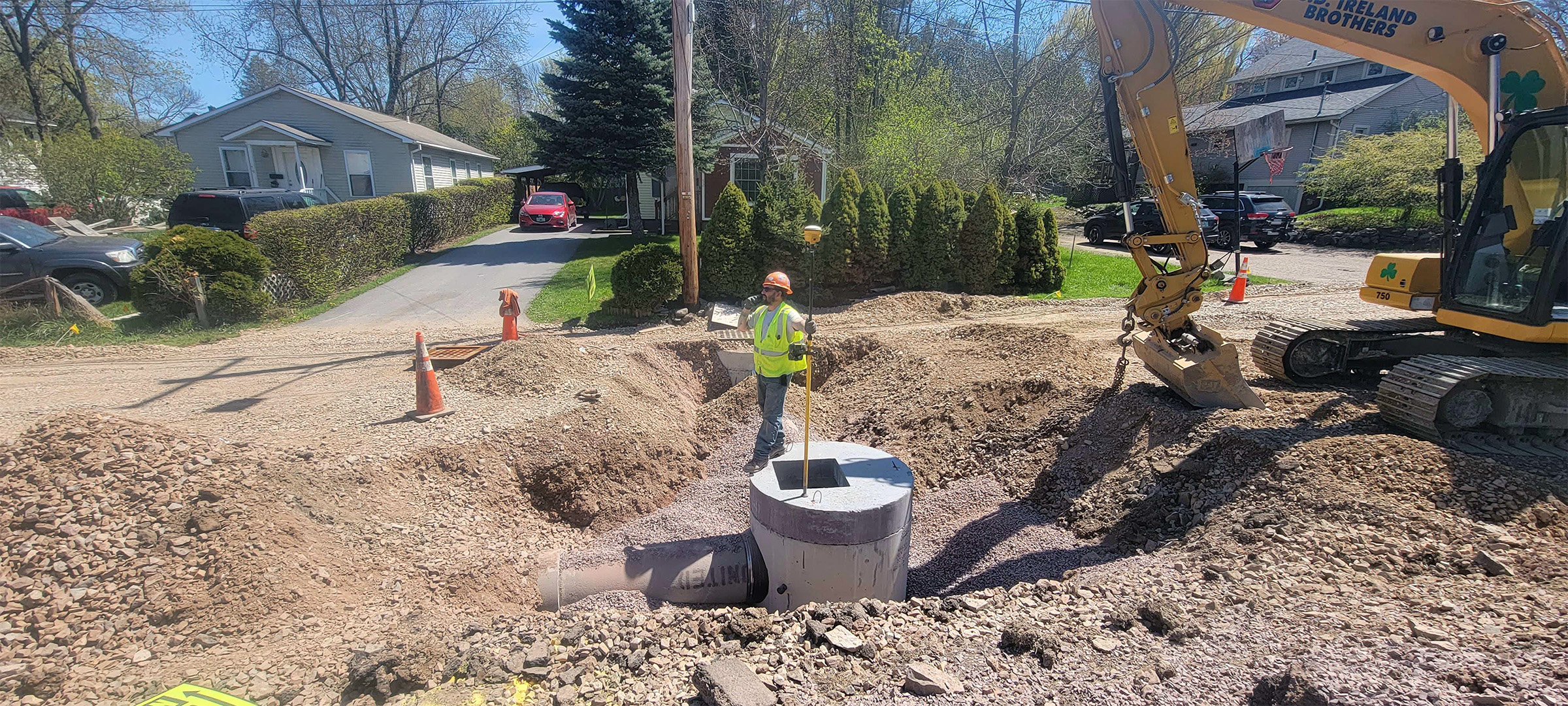

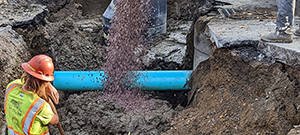

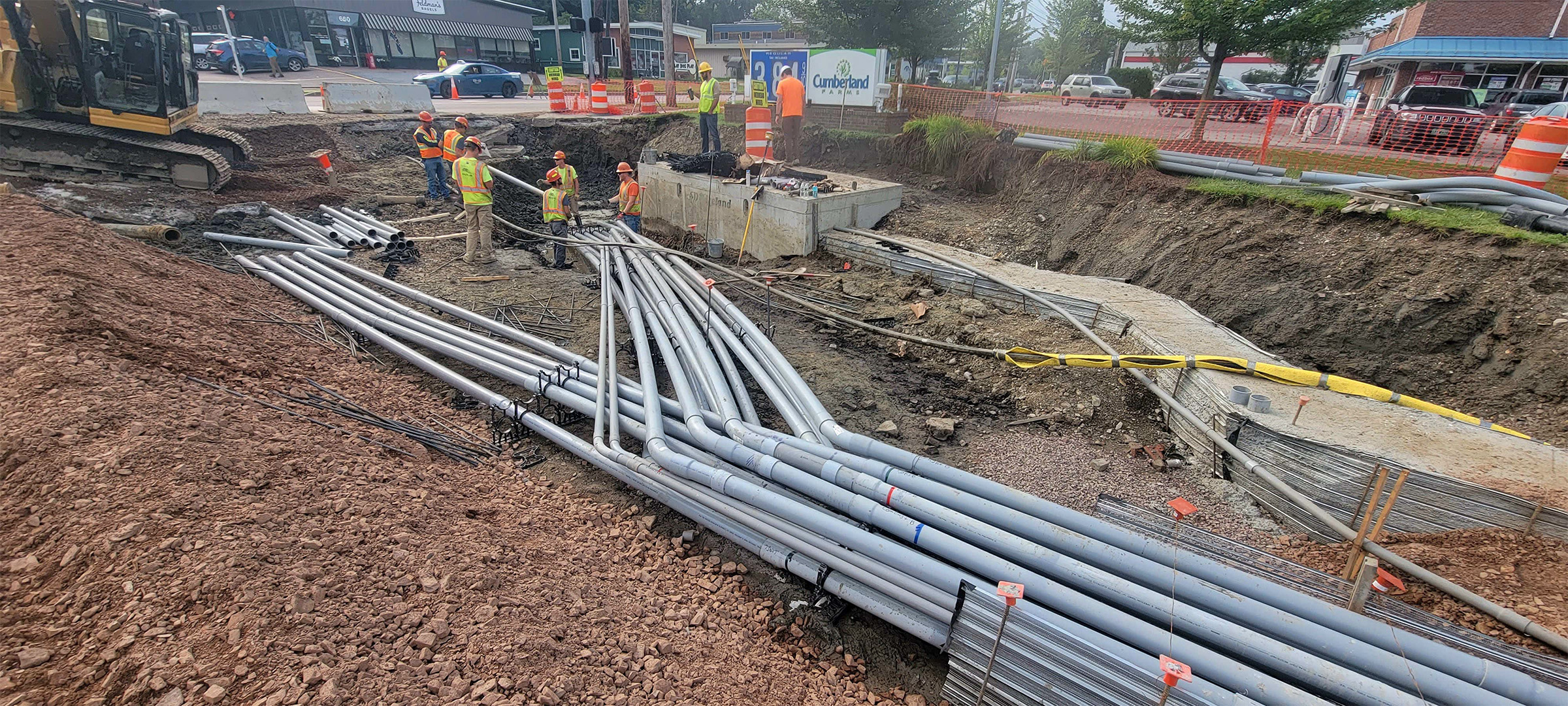

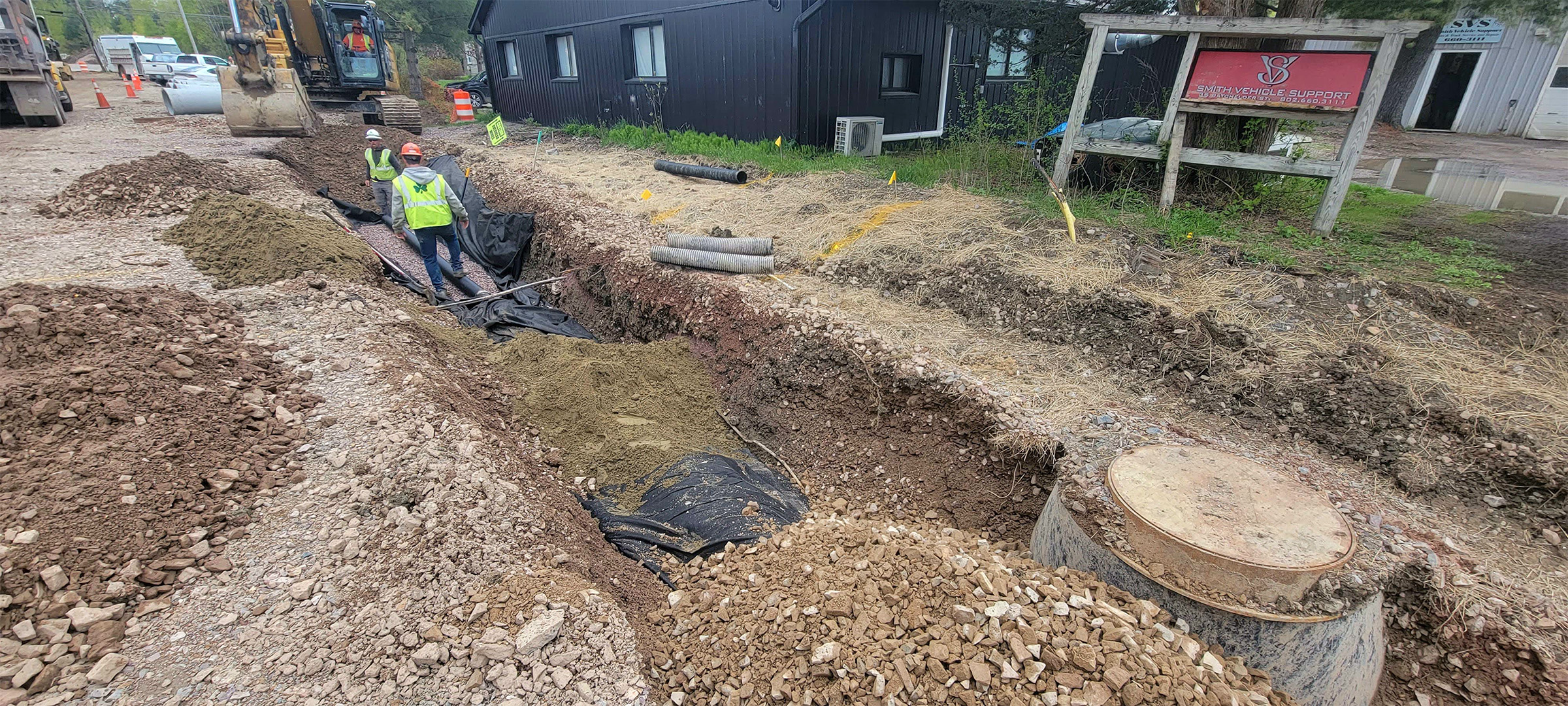

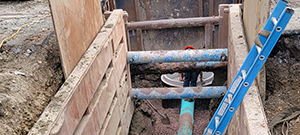

Crews install new sewer line throughout the south end to replace existing aging infrastructure. New sewer line installation on Flynn Avenue.
Crews install new sewer line throughout the south end to replace existing aging infrastructure. New sewer installation on Flynn Avenue.
Crews install new sewer line throughout the south end to replace existing aging infrastructure. New sewer installation on Flynn Avenue.
Crews install new sewer line throughout the south end to replace existing aging infrastructure. New sewer installation on Briggs Street.

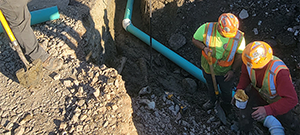

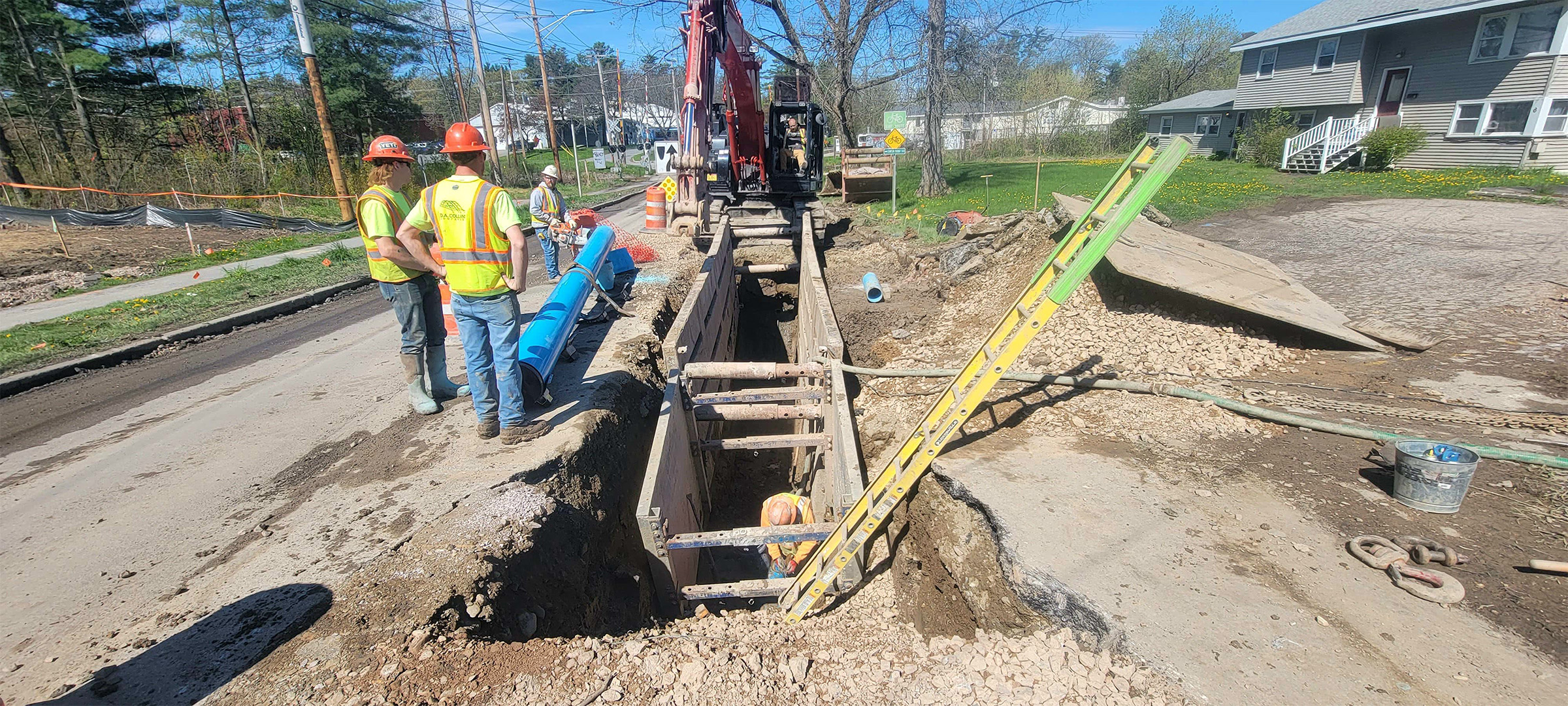

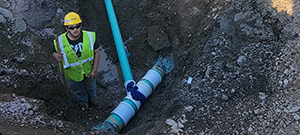

Crews install new sewer line and services throughout the south end to replace existing aging infrastructure. New sewer service installation on Morse Place.
Crews install new sewer line and services throughout the south end to replace existing aging infrastructure. New sewer service installation on Batchelder Street.
Crews install new sewer line throughout the south end to replace existing aging infrastructure. New sewer installation on Ferguson Street.

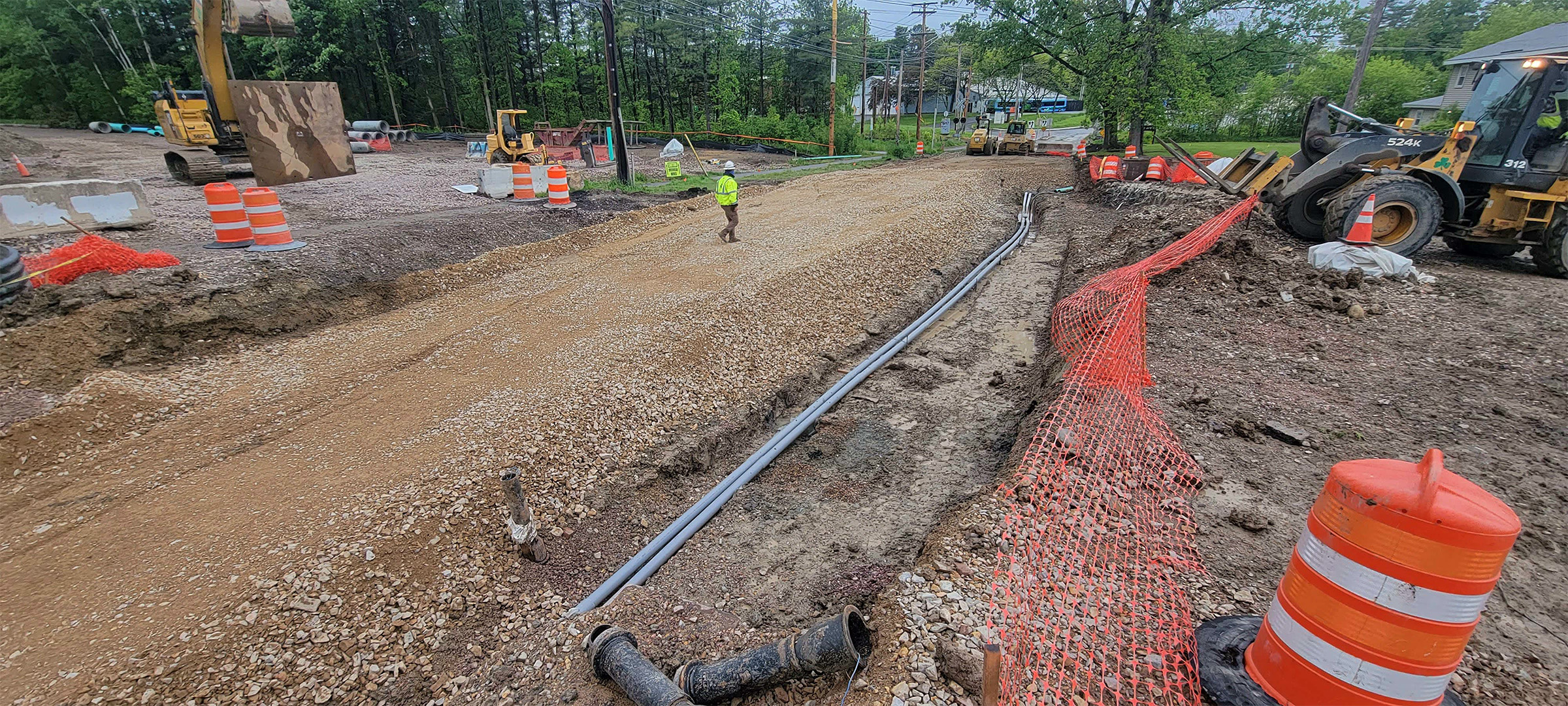

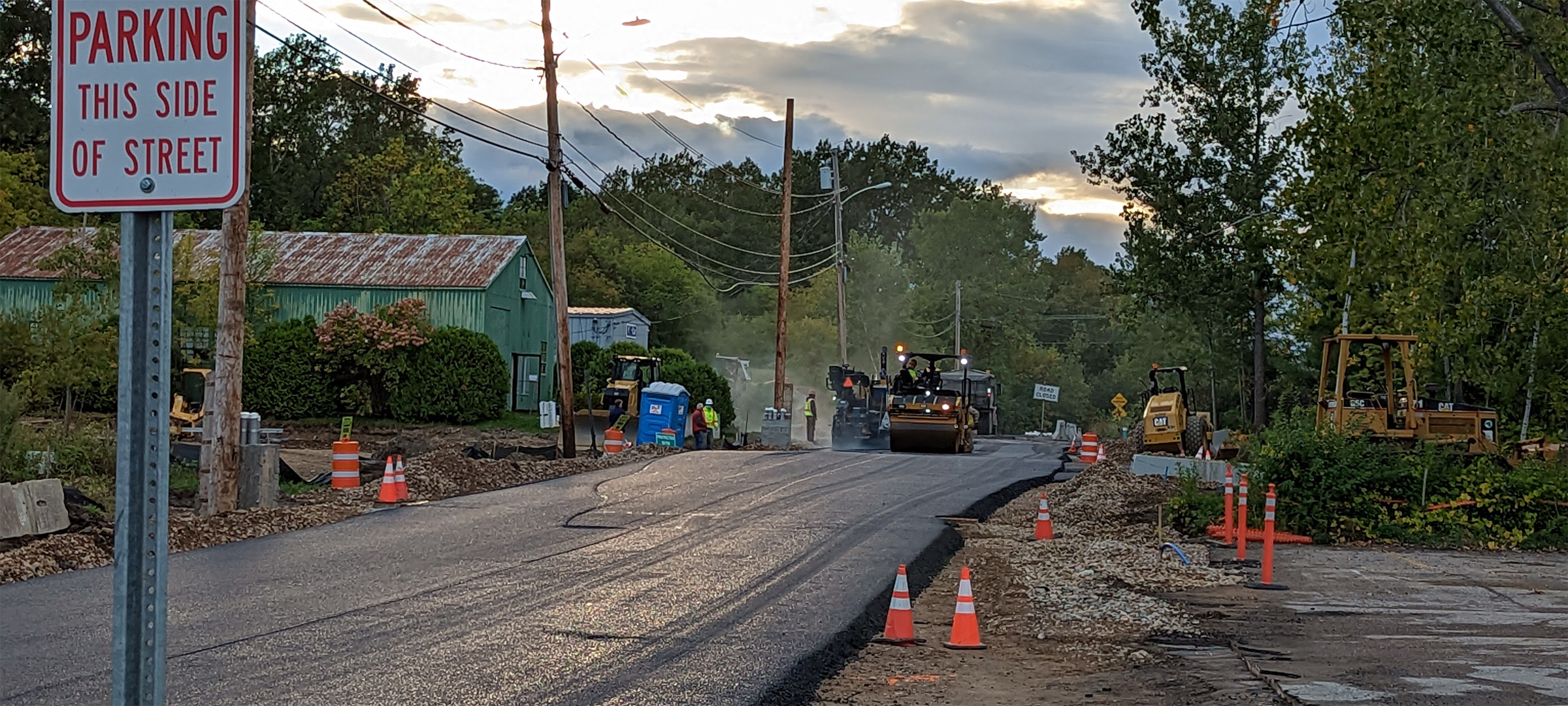

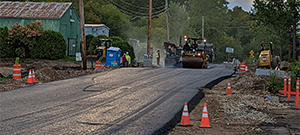

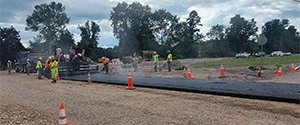

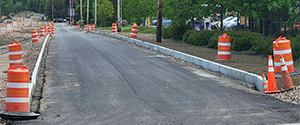

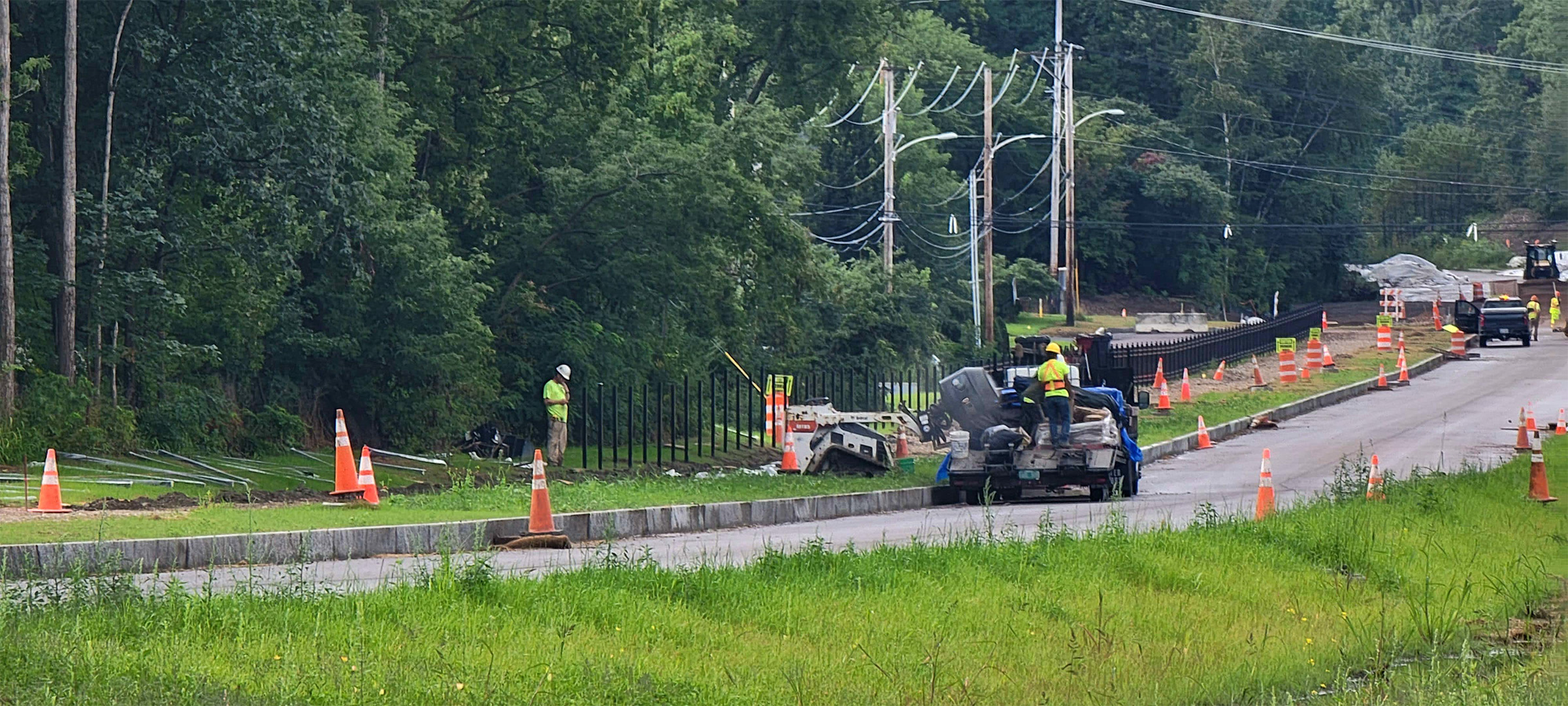

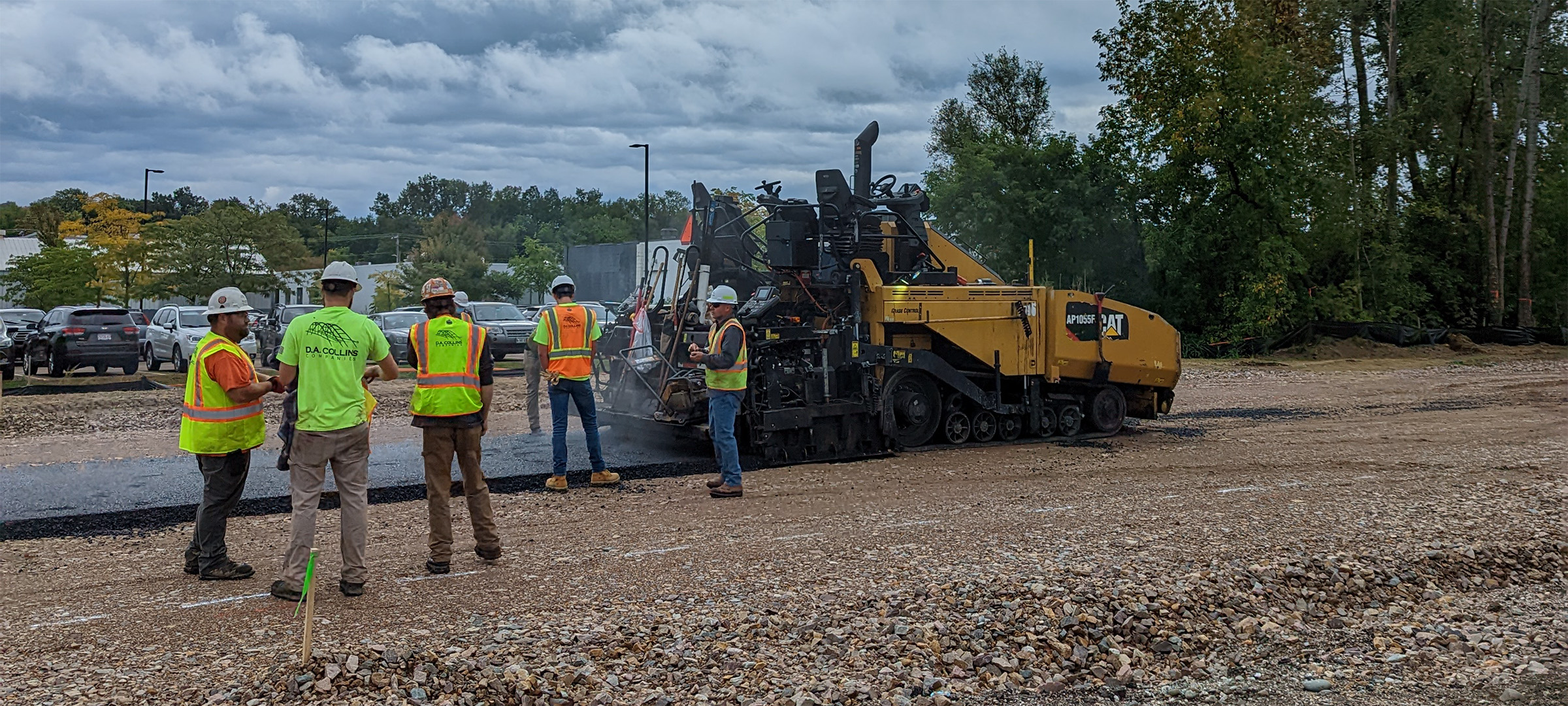

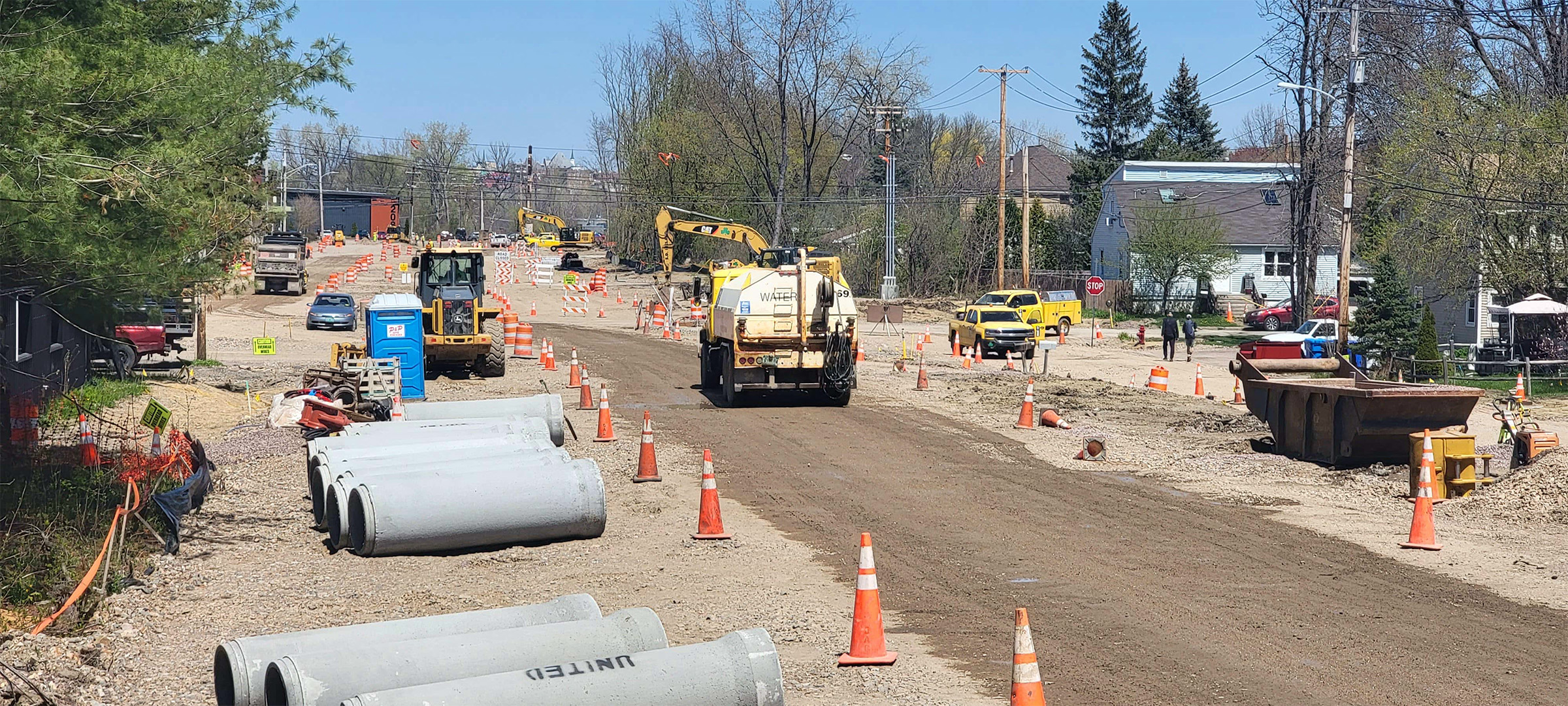

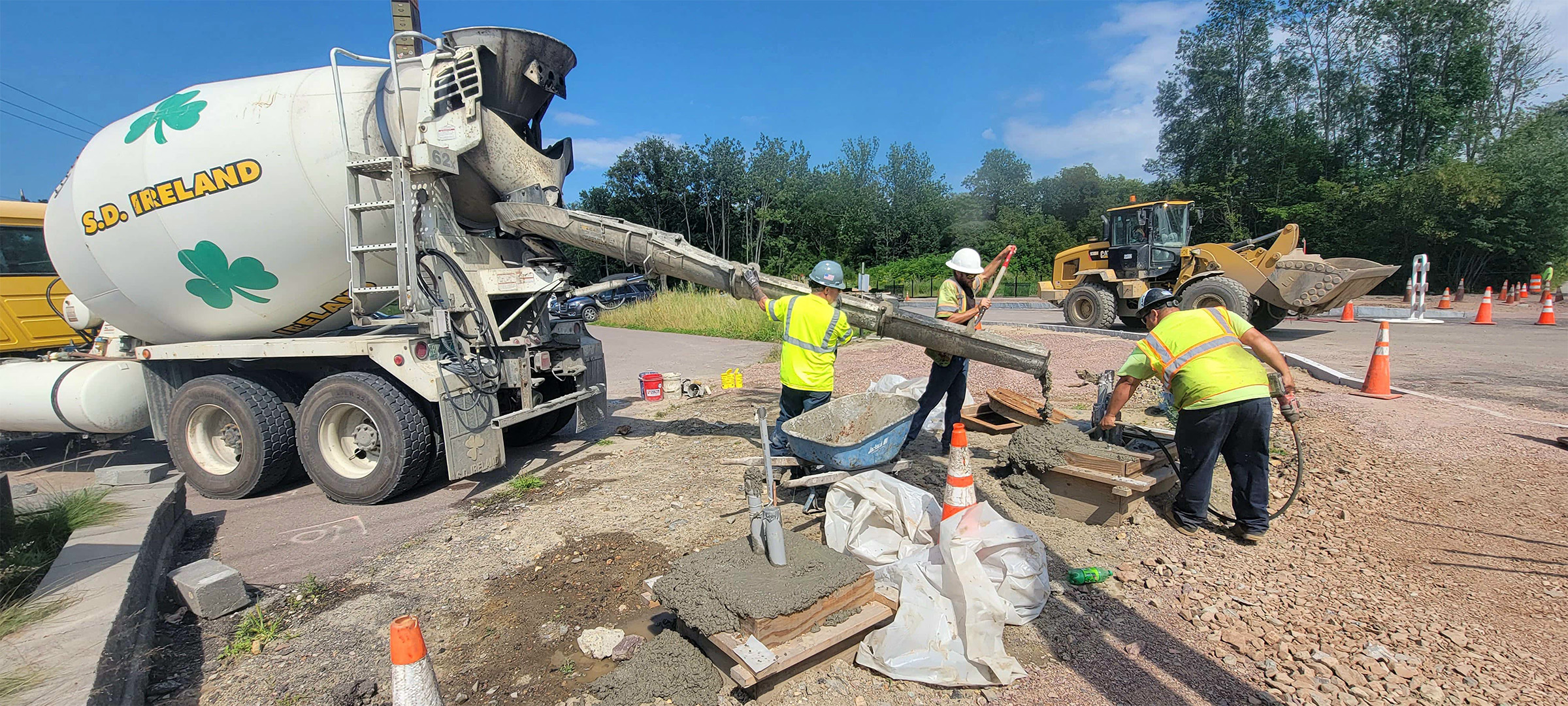

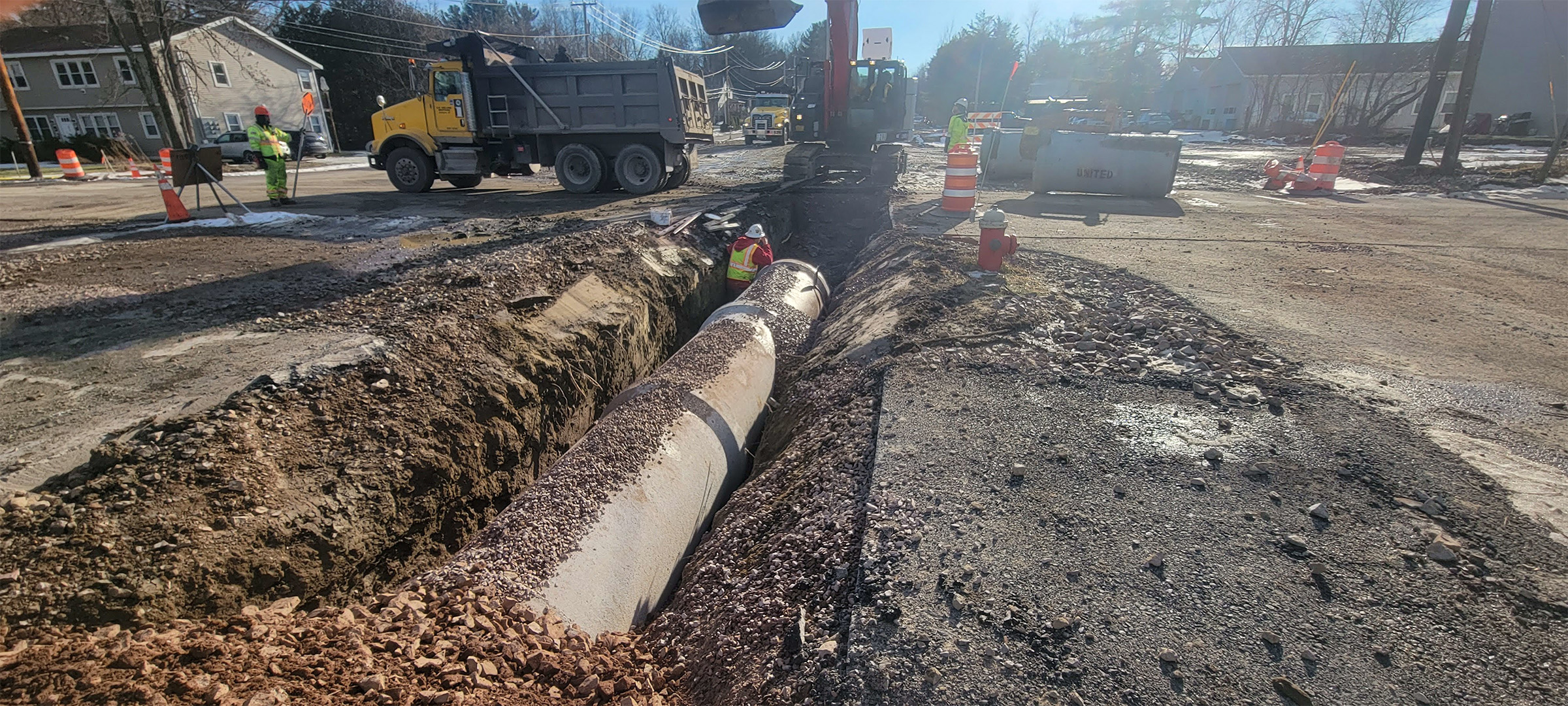

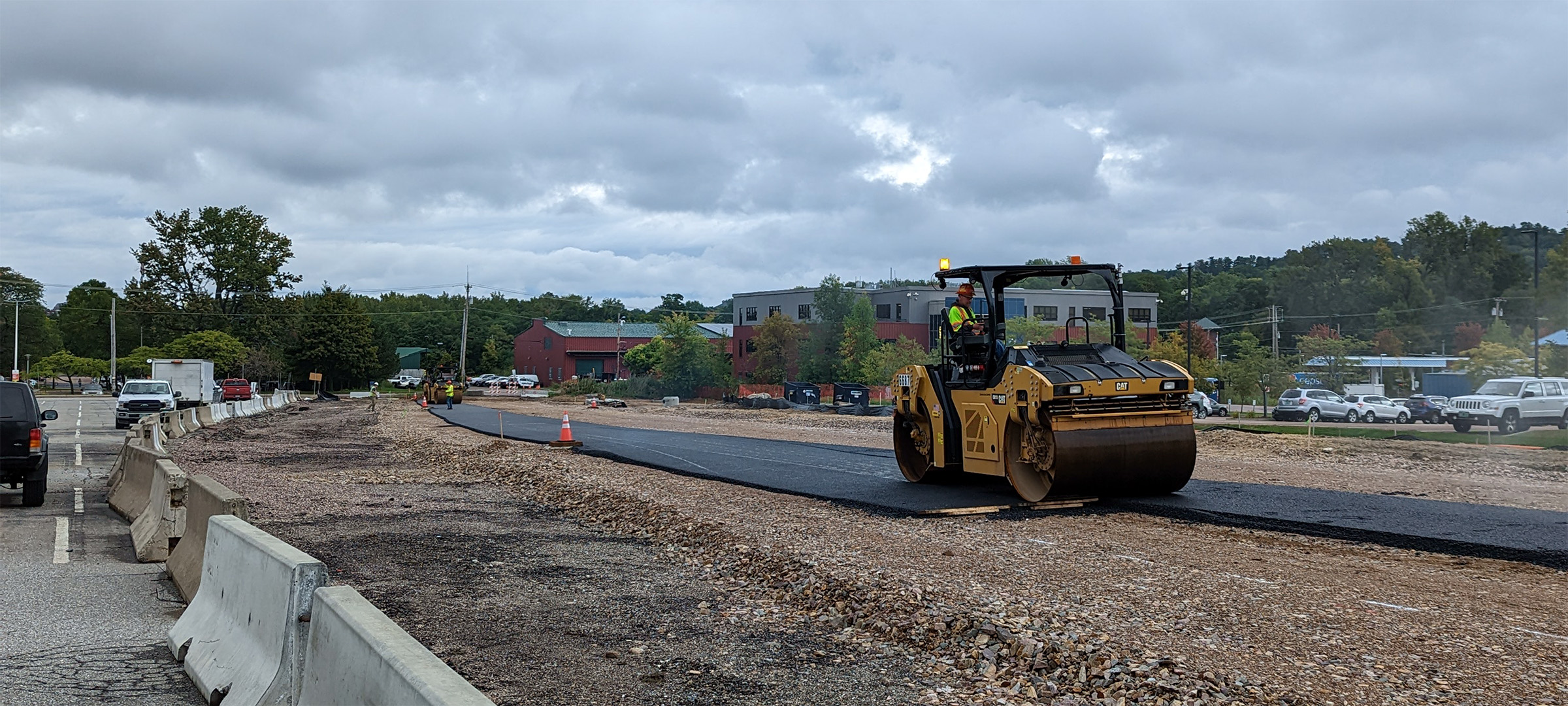

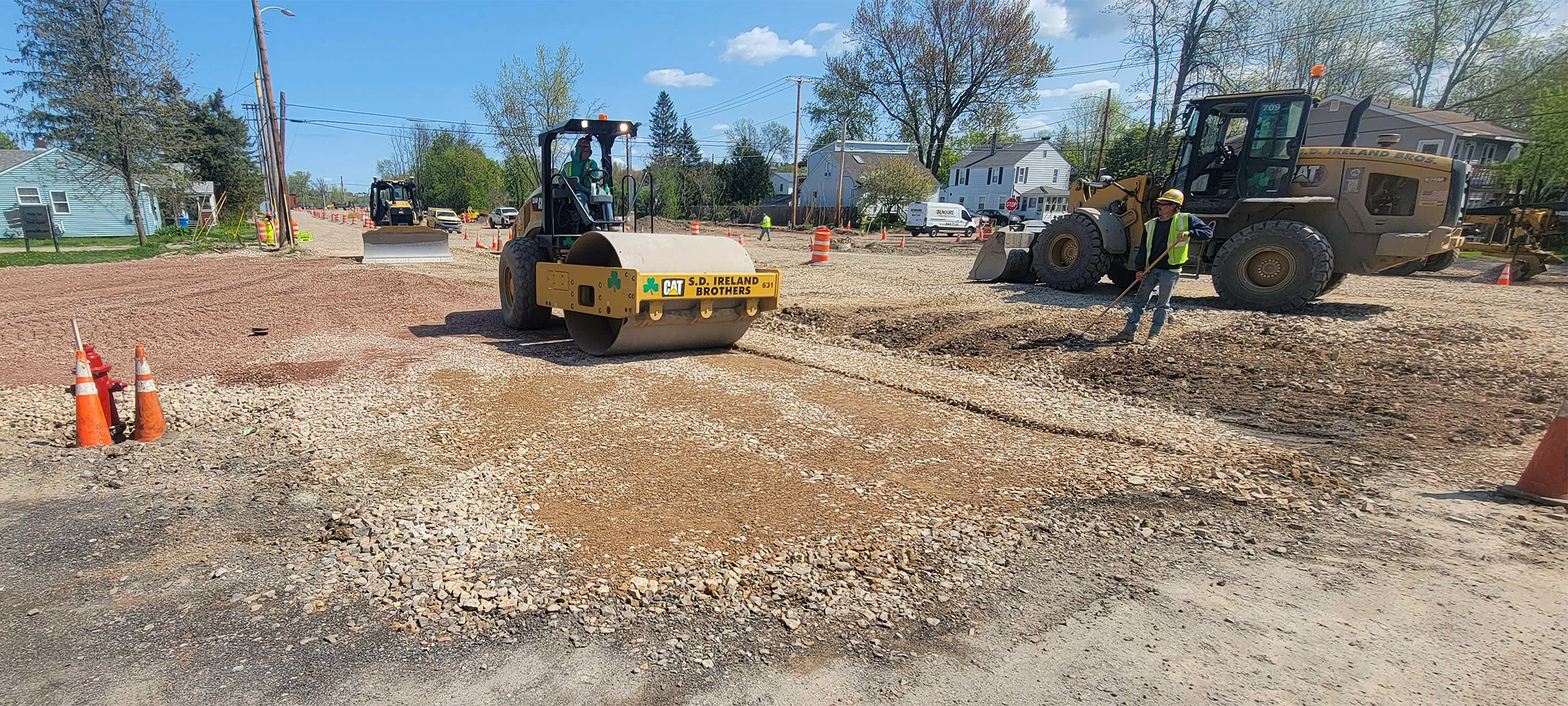

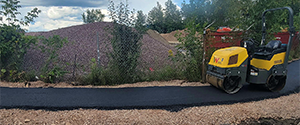

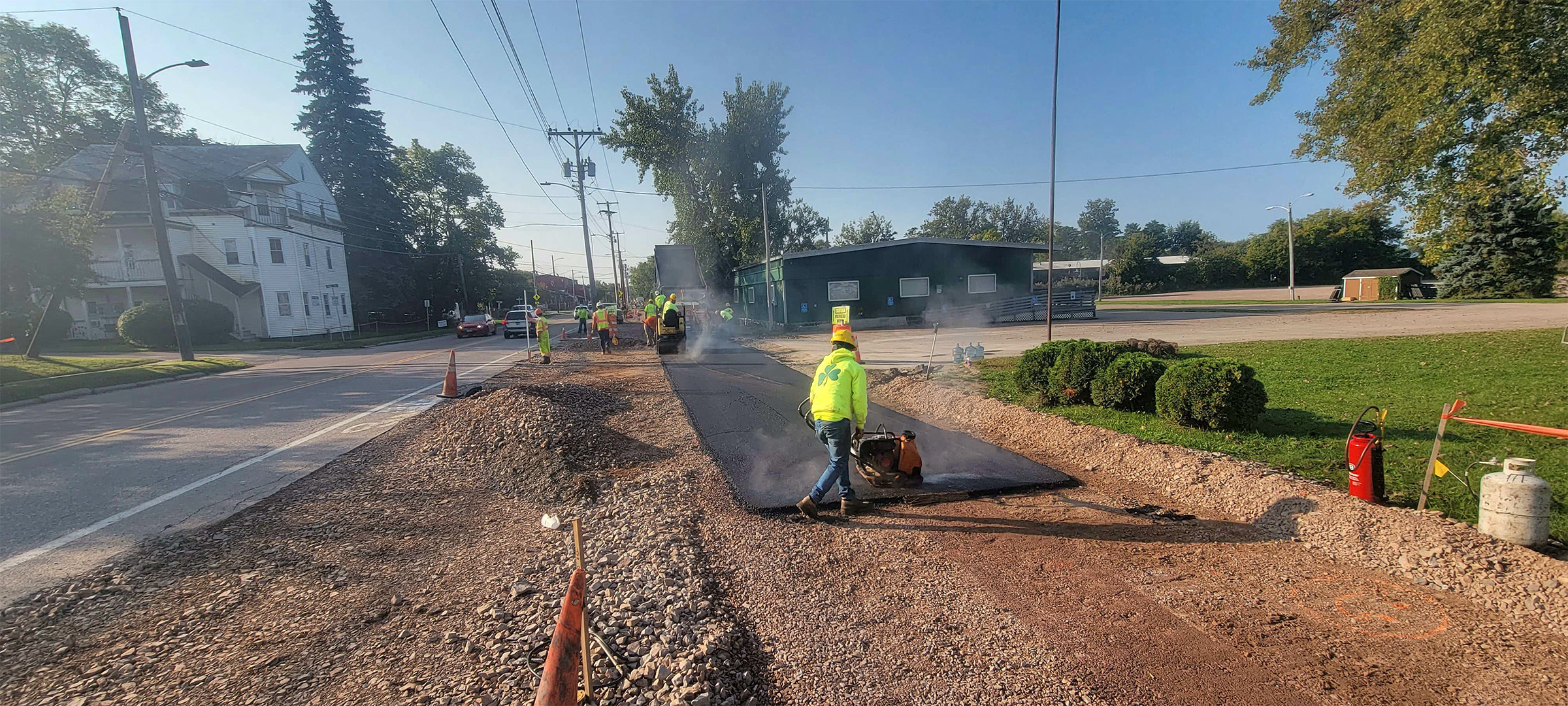

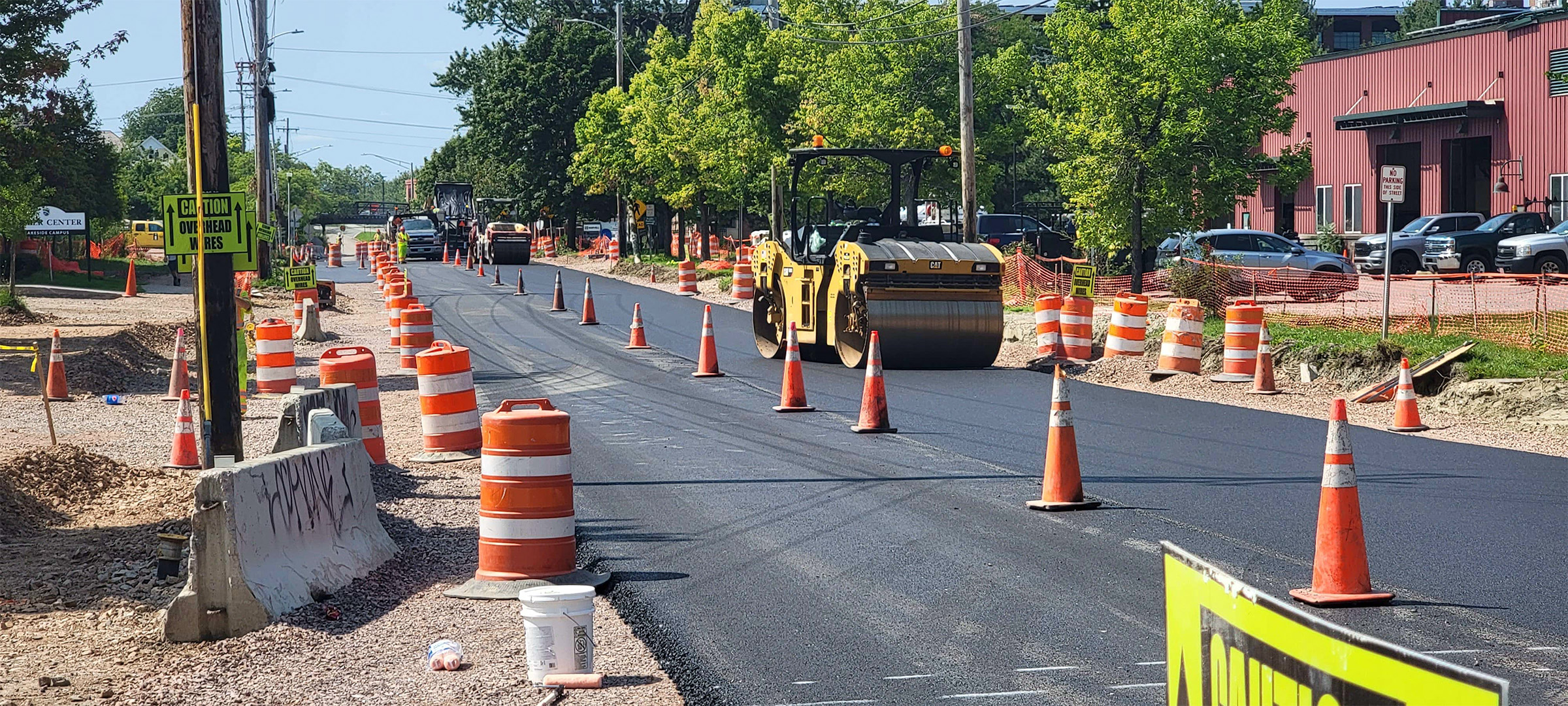

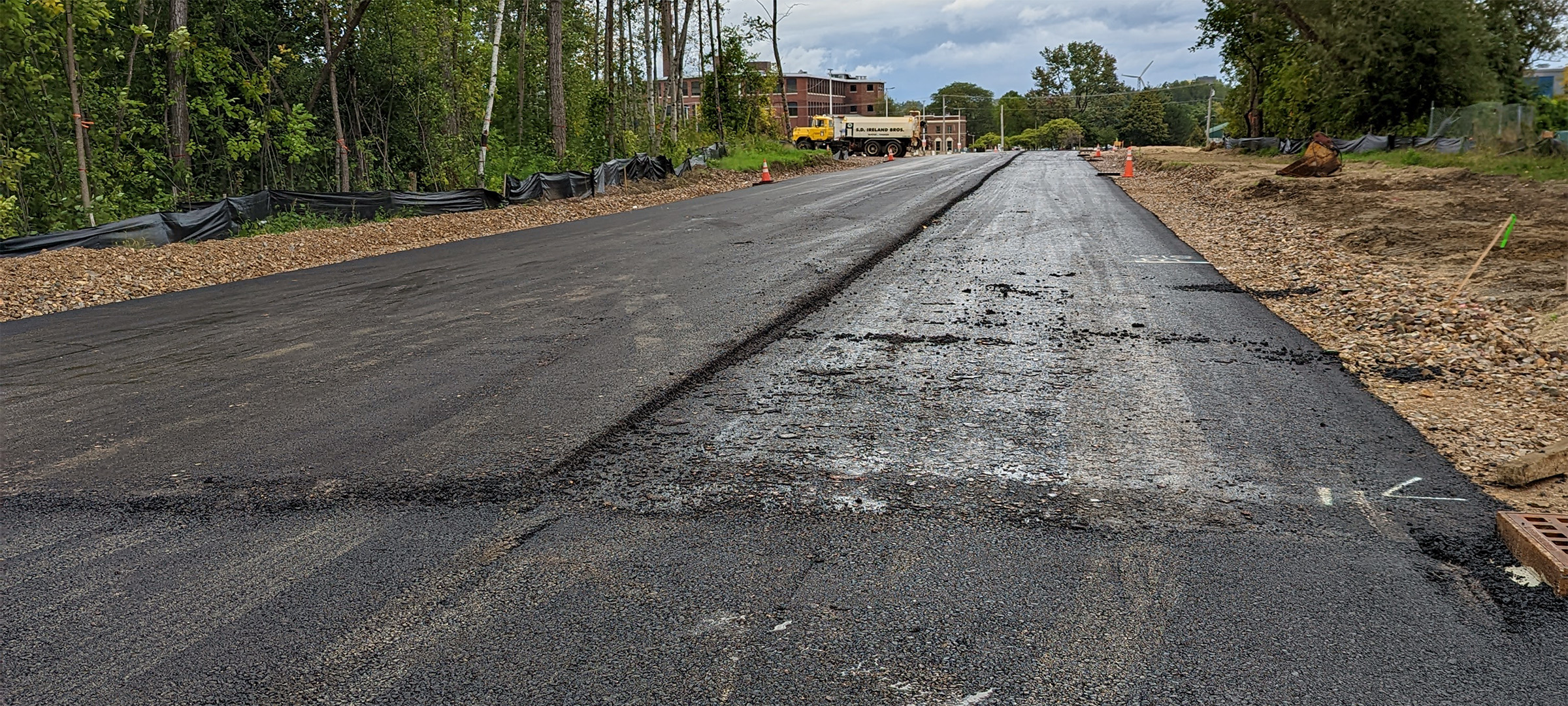

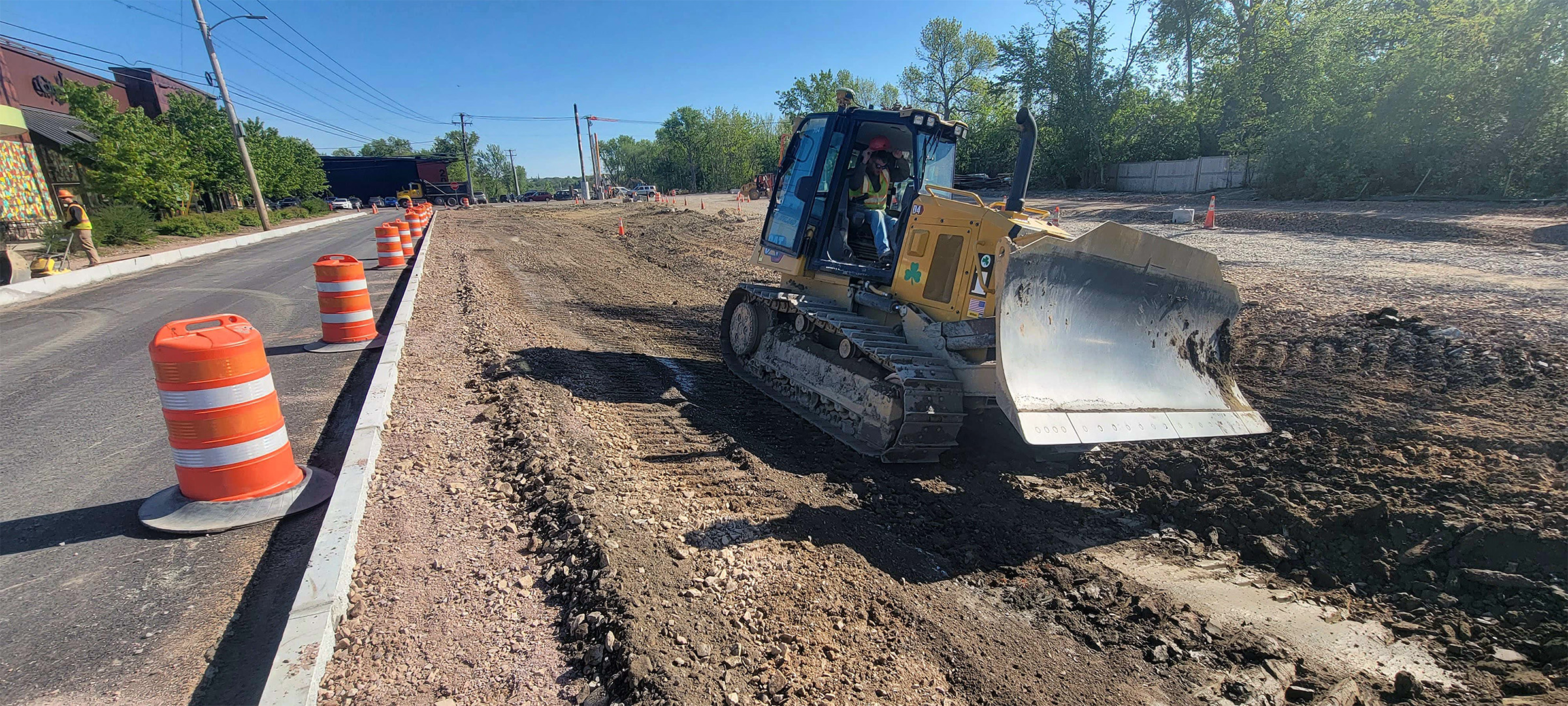

Base paving operations along Sears Lane.

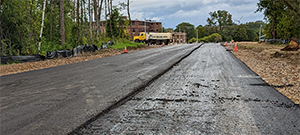

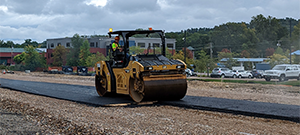

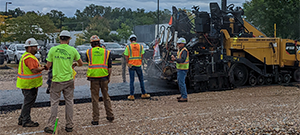

Base paving operations along the Champlain Parkway between Sears Lane and Lakeside Avenue.
Base paving operations along the Champlain Parkway between Sears Lane and Lakeside Avenue.
Base paving operations along the Champlain Parkway between Sears Lane and Lakeside Avenue.

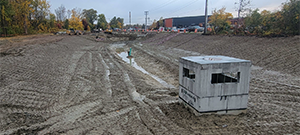

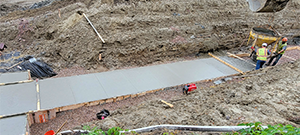

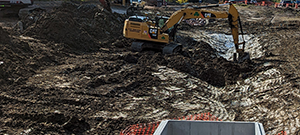

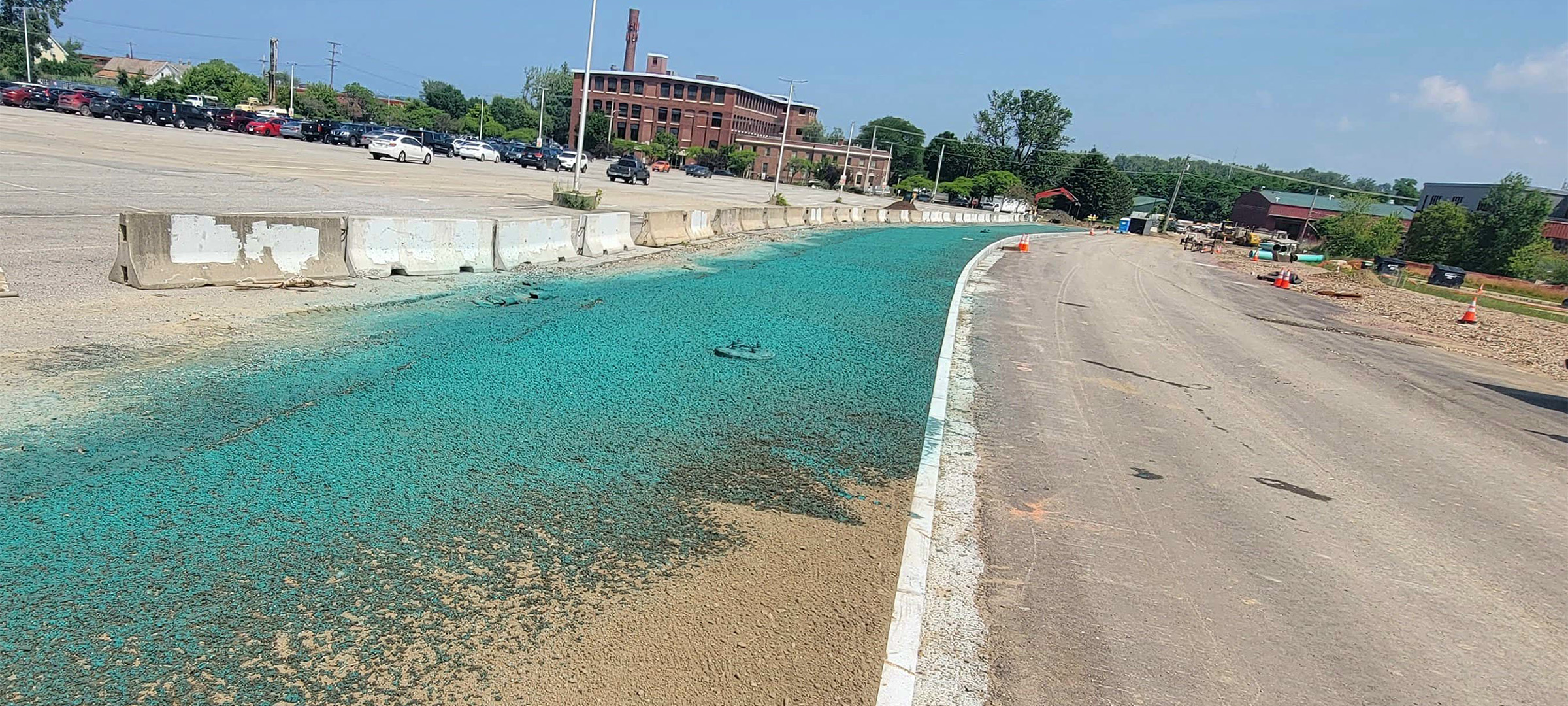

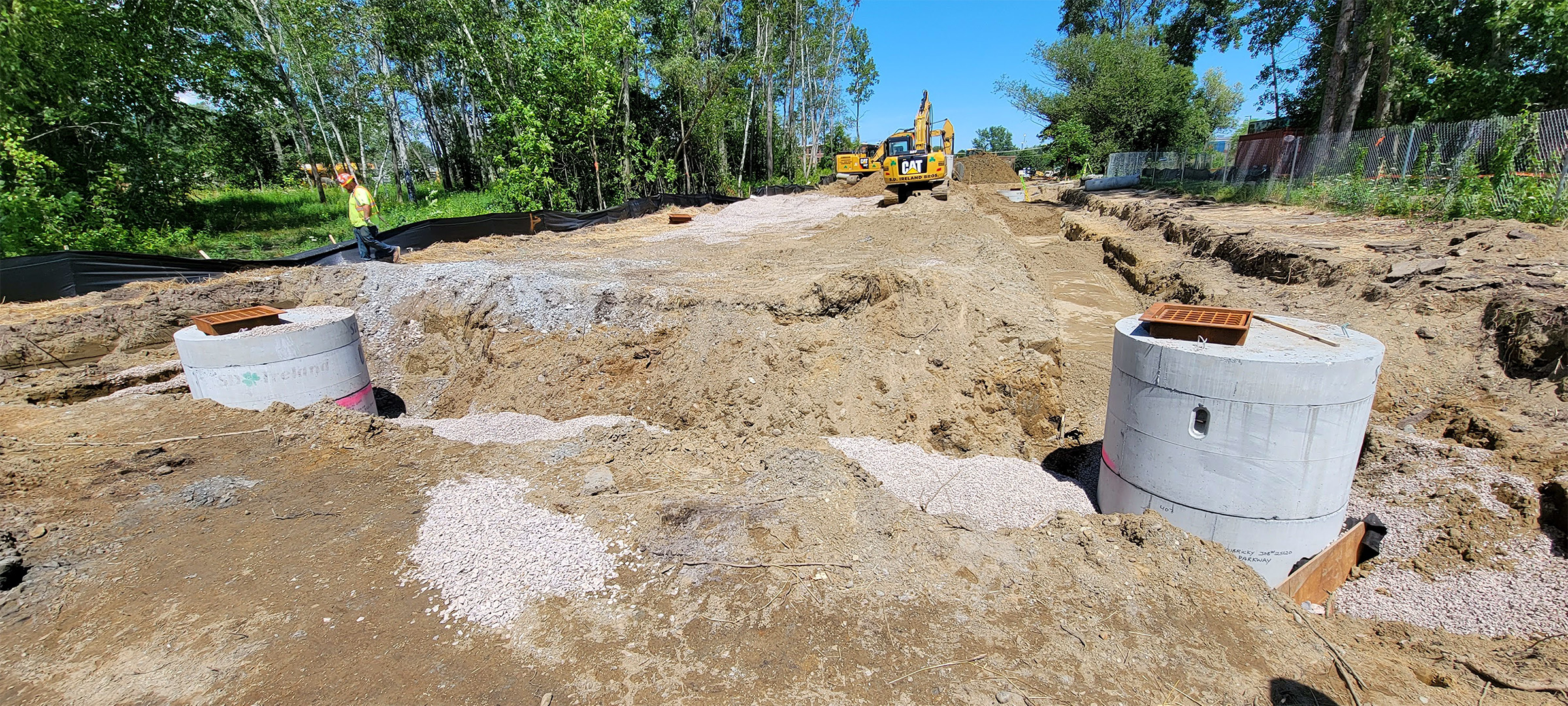

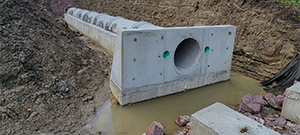

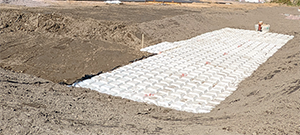

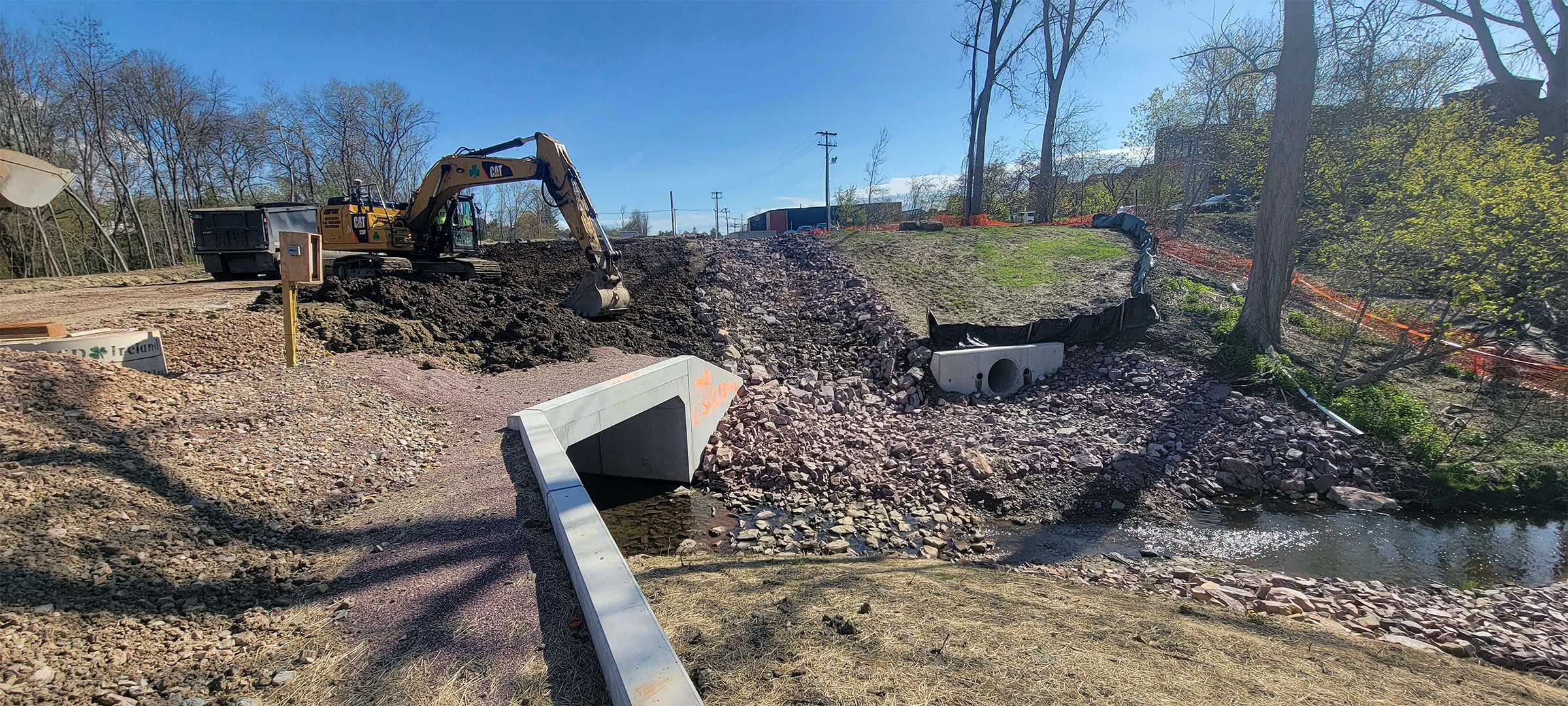

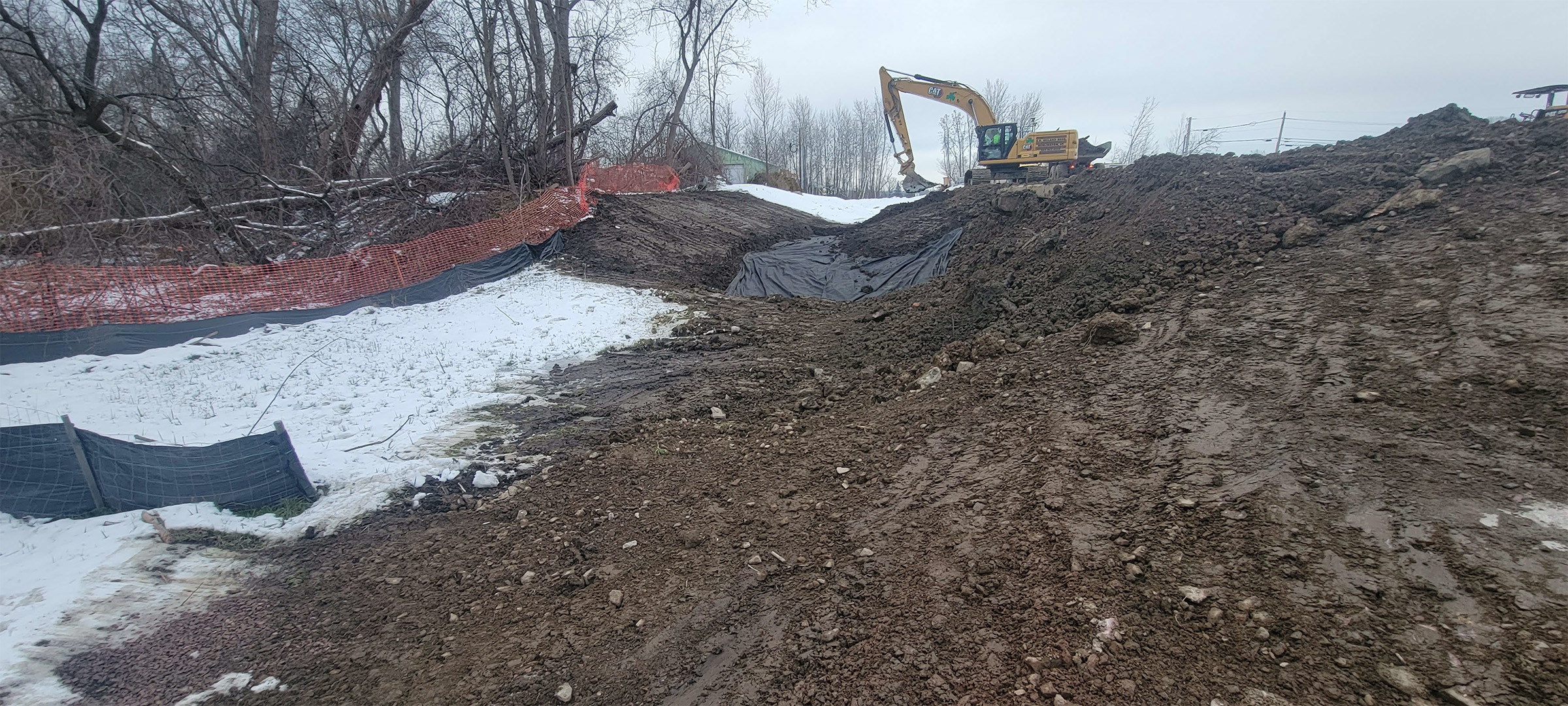

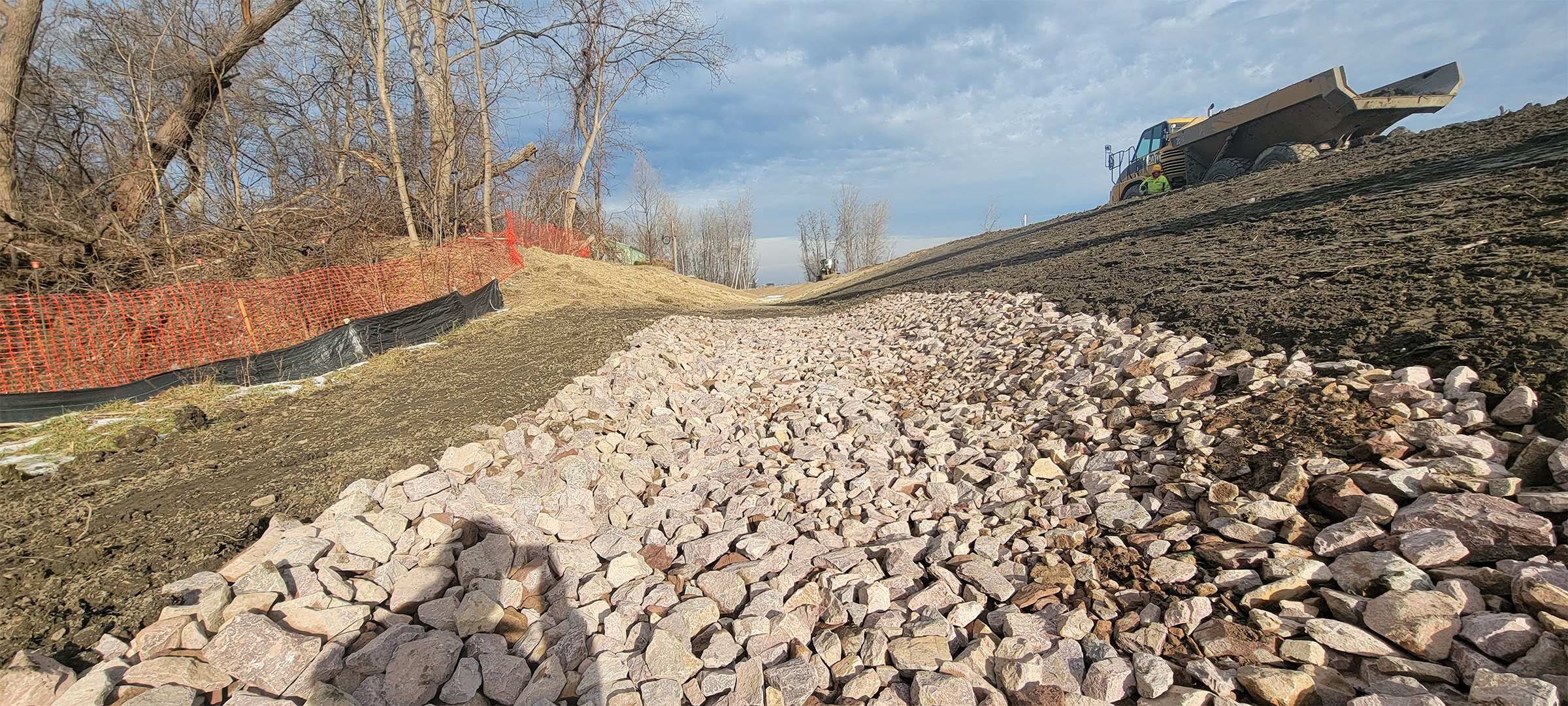

The Champlain Parkway included several stormwater features including a sand filter installed on Lakeside Avenue near the Champlain College Miller Building.
The Champlain Parkway included several stormwater features including a sand filter installed on Lakeside Avenue near the Champlain College Miller Building.

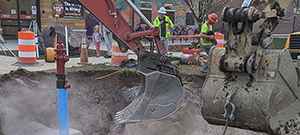

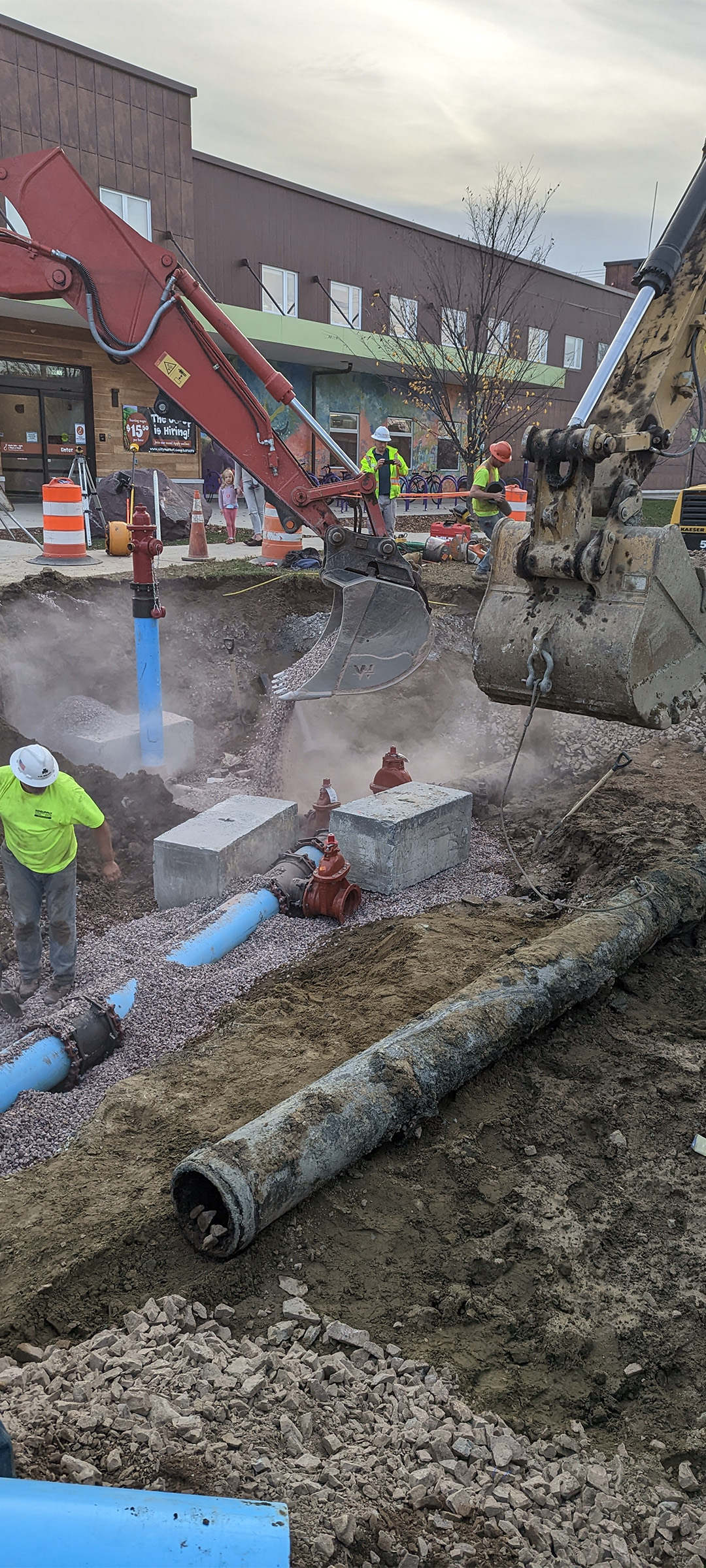

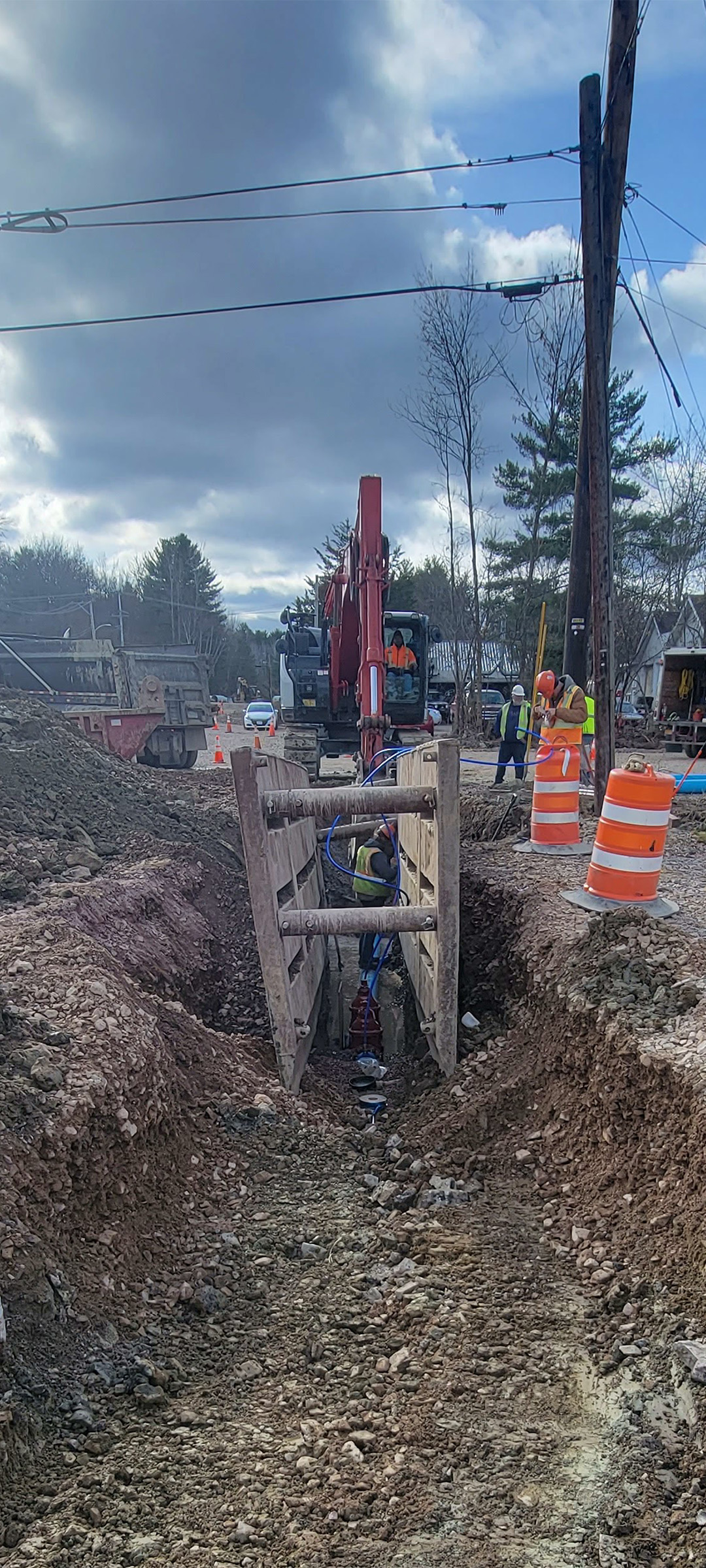

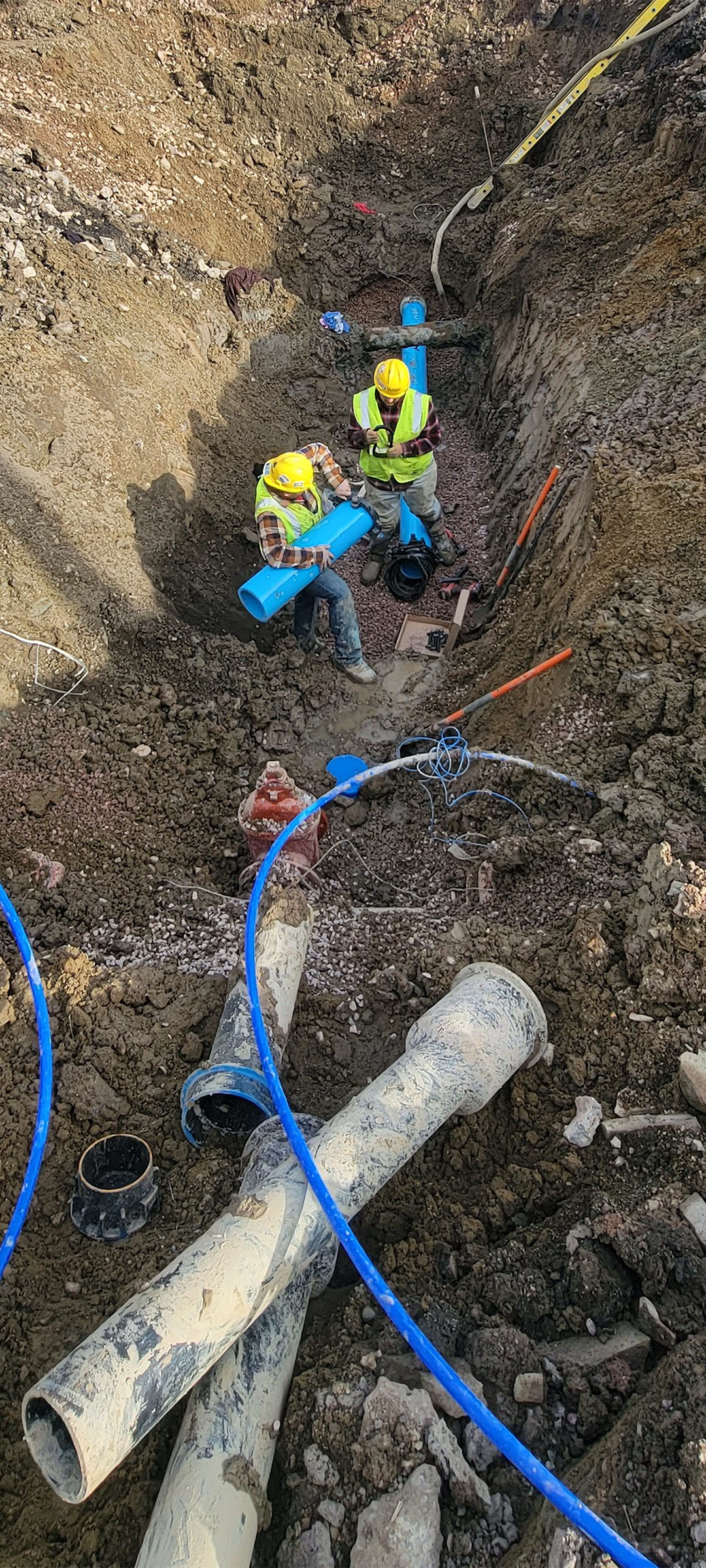

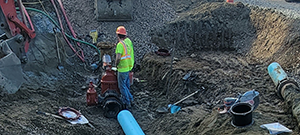

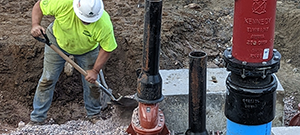

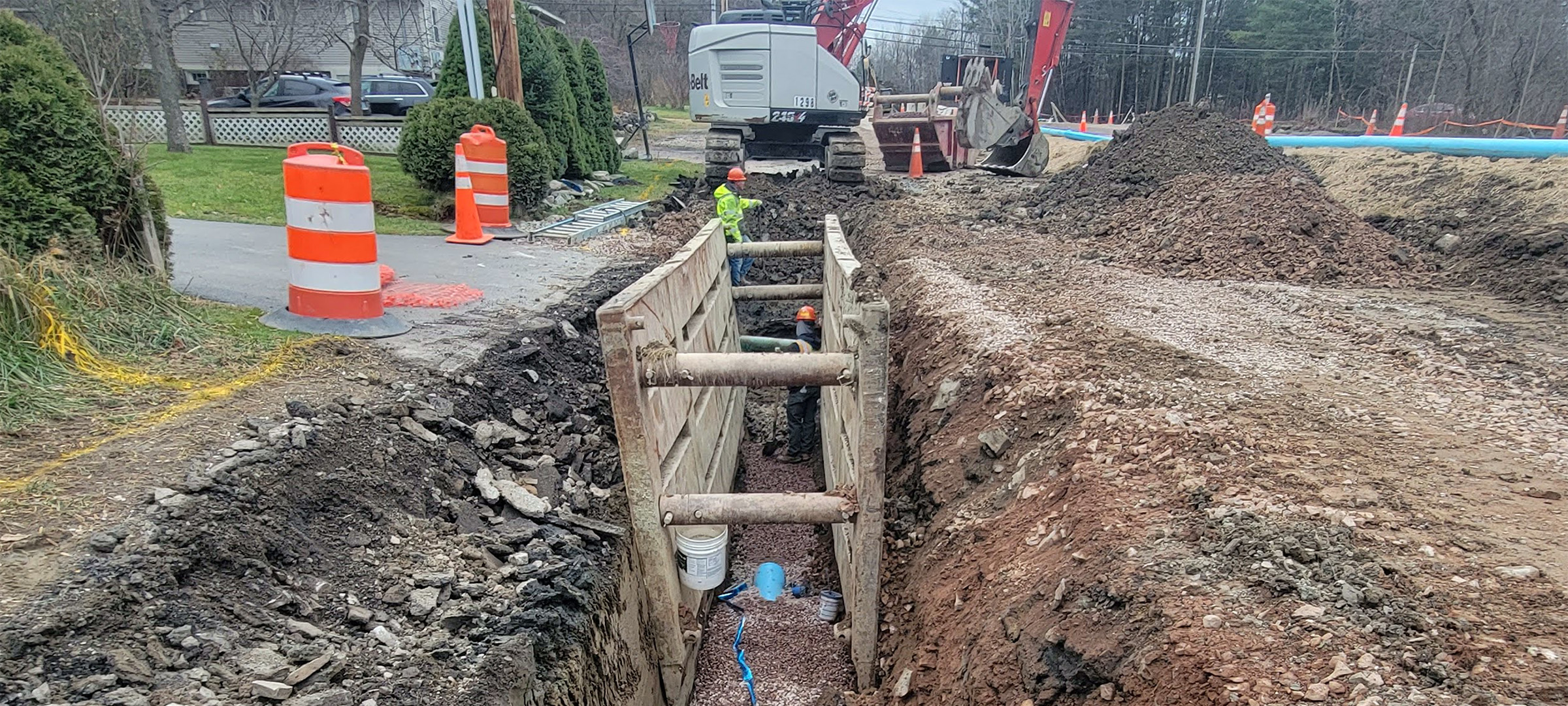

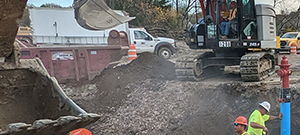

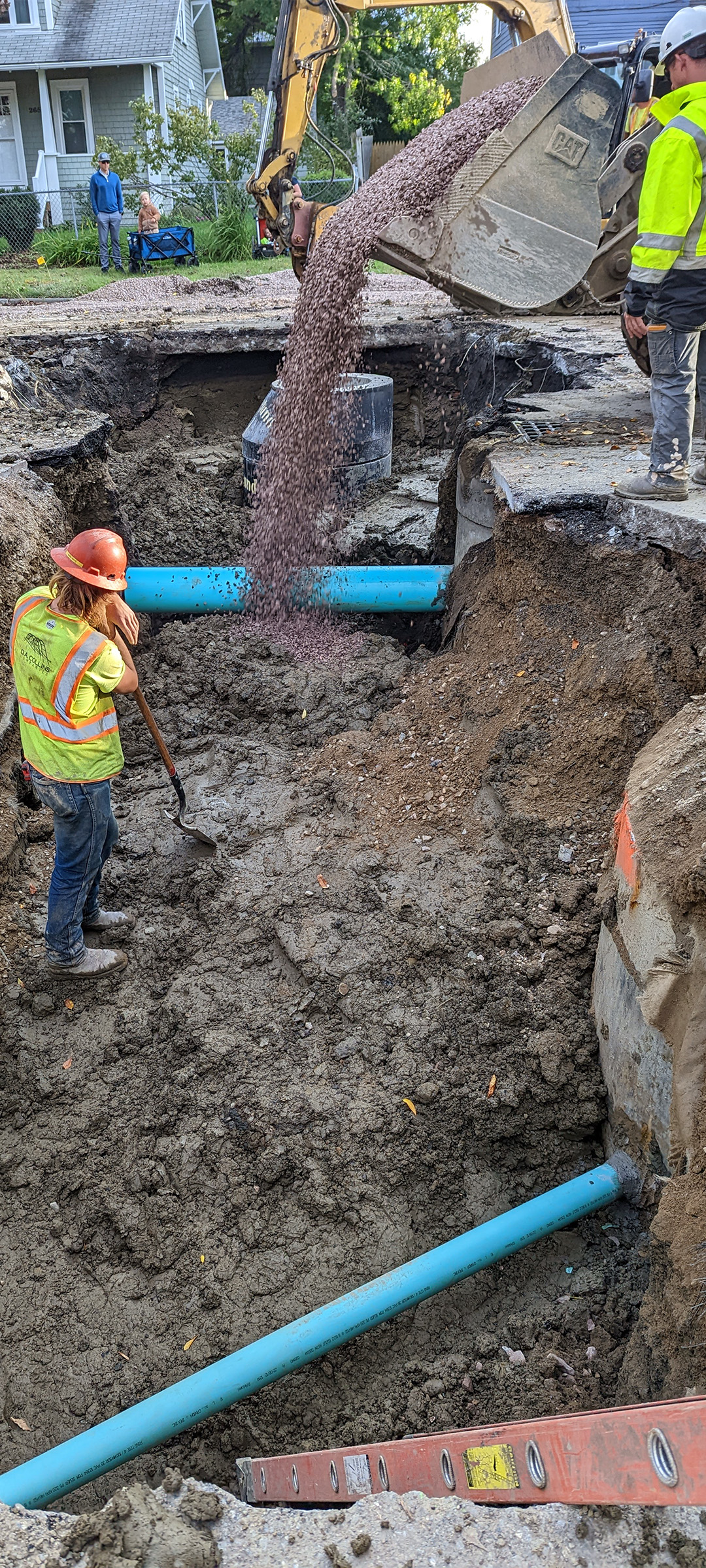

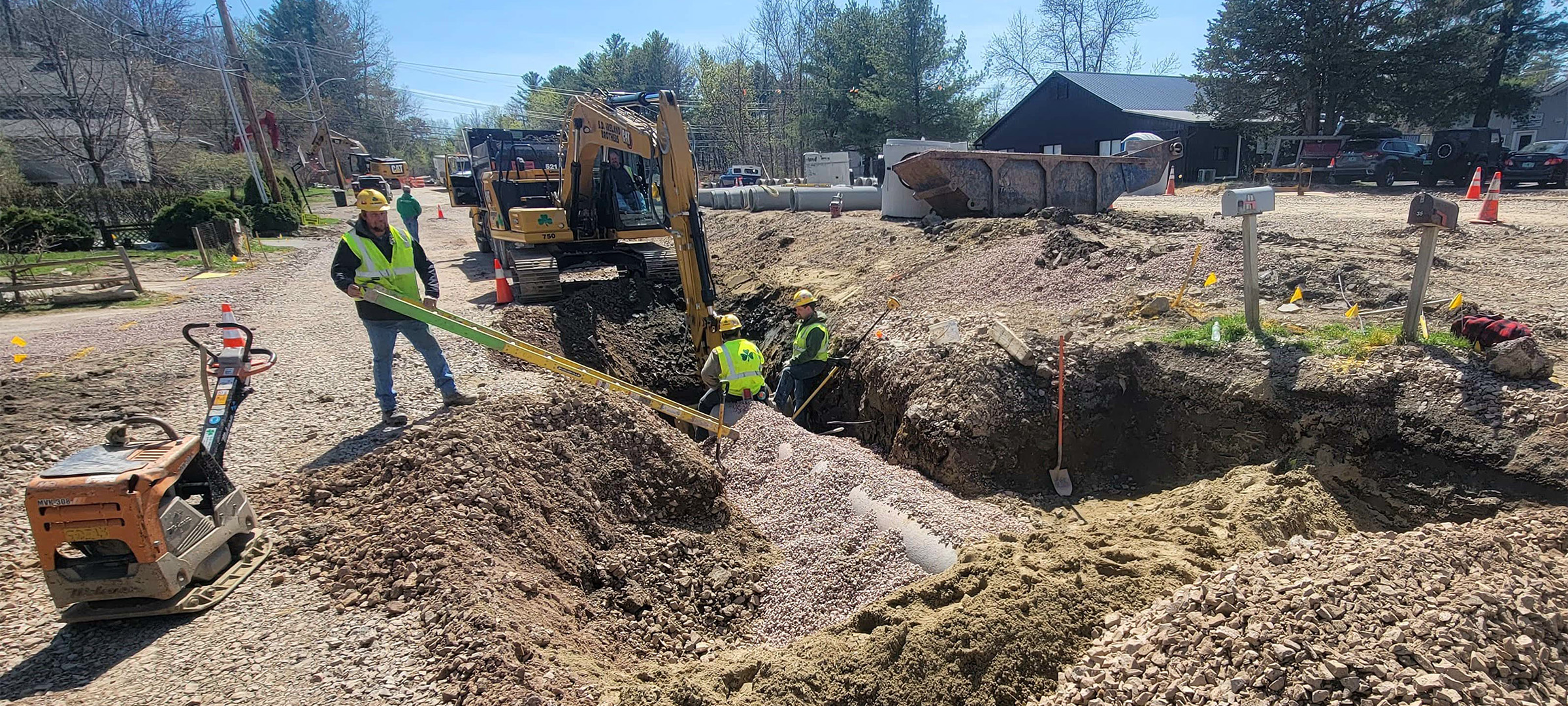

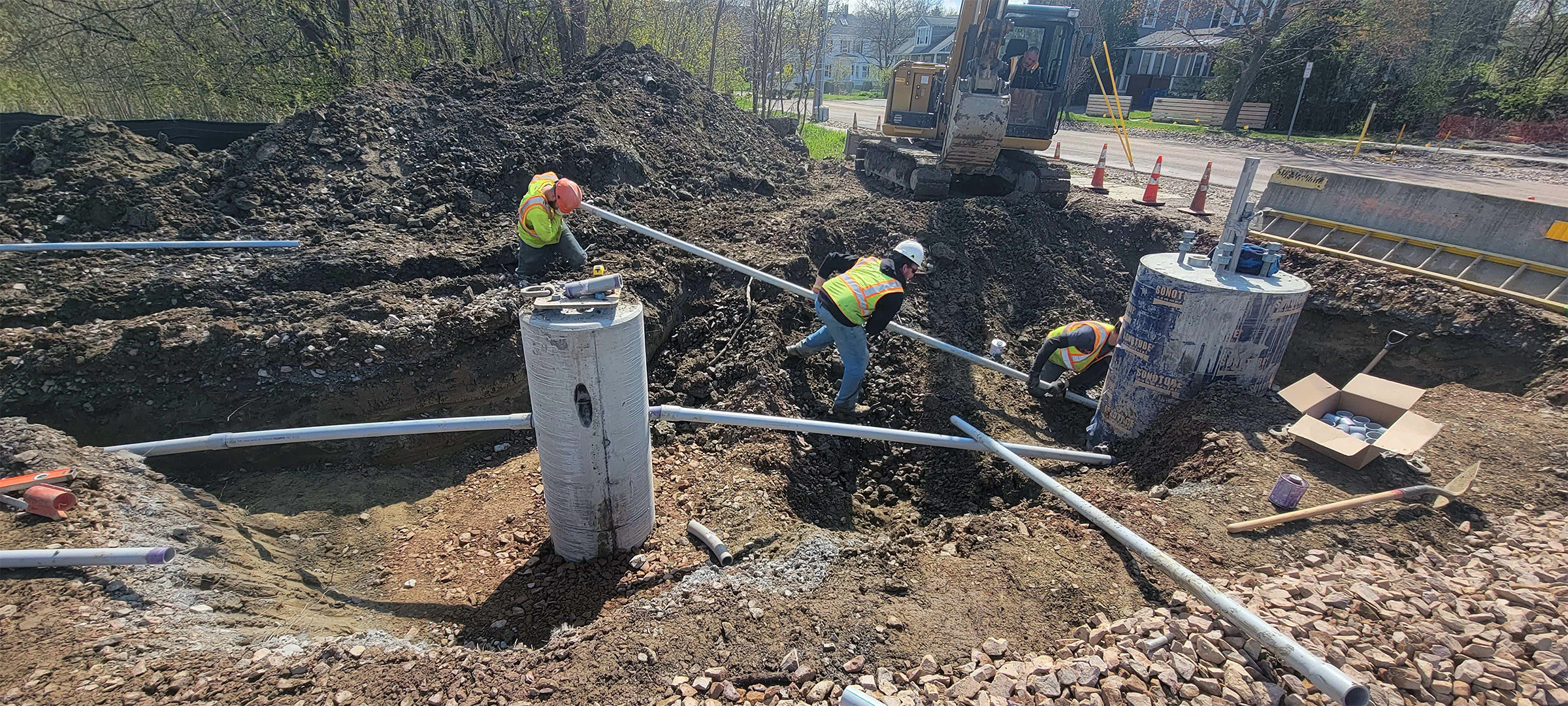

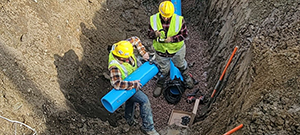

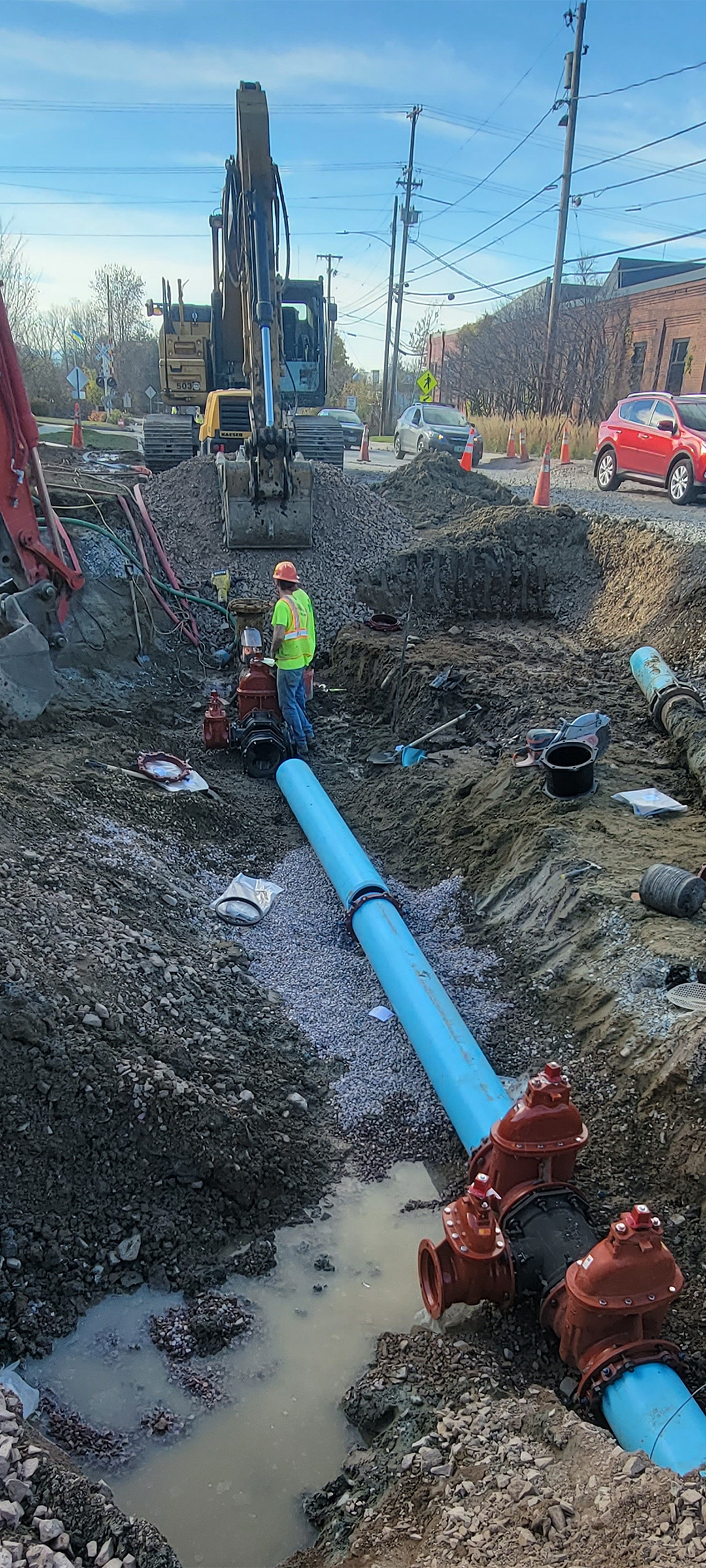

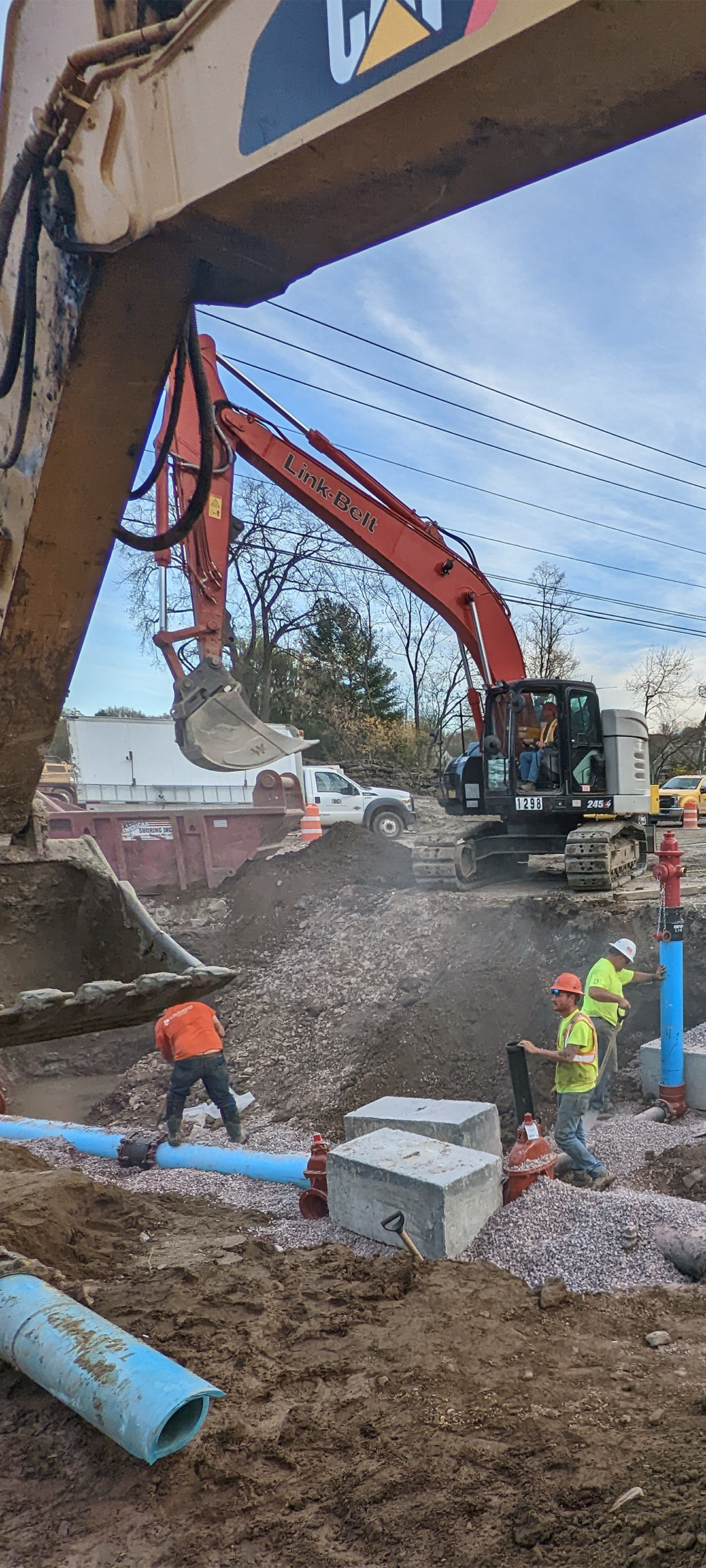

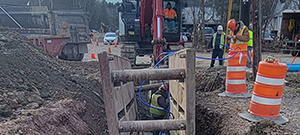

Crews install new water line throughout the south end to replace existing aging infrastructure. New water line at the corner of Briggs Street and Flynn Avenue.
Crews install new water line throughout the south end to replace existing aging infrastructure. New water line at the corner of Briggs Street and Flynn Avenue.
Crews install new water line throughout the south end to replace existing aging infrastructure. New water line at the corner of Briggs Street and Flynn Avenue.
Crews install new water line throughout the south end to replace existing aging infrastructure. New water line on Flynn Avenue.
Crews install new water line throughout the south end to replace existing aging infrastructure. New water line on Briggs Street.
Crews install new water line throughout the south end to replace existing aging infrastructure. New water line on Lyman Avenue.
Crews install new water line throughout the south end to replace existing aging infrastructure. New water line on Batchelder Street.

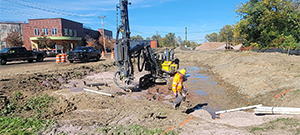

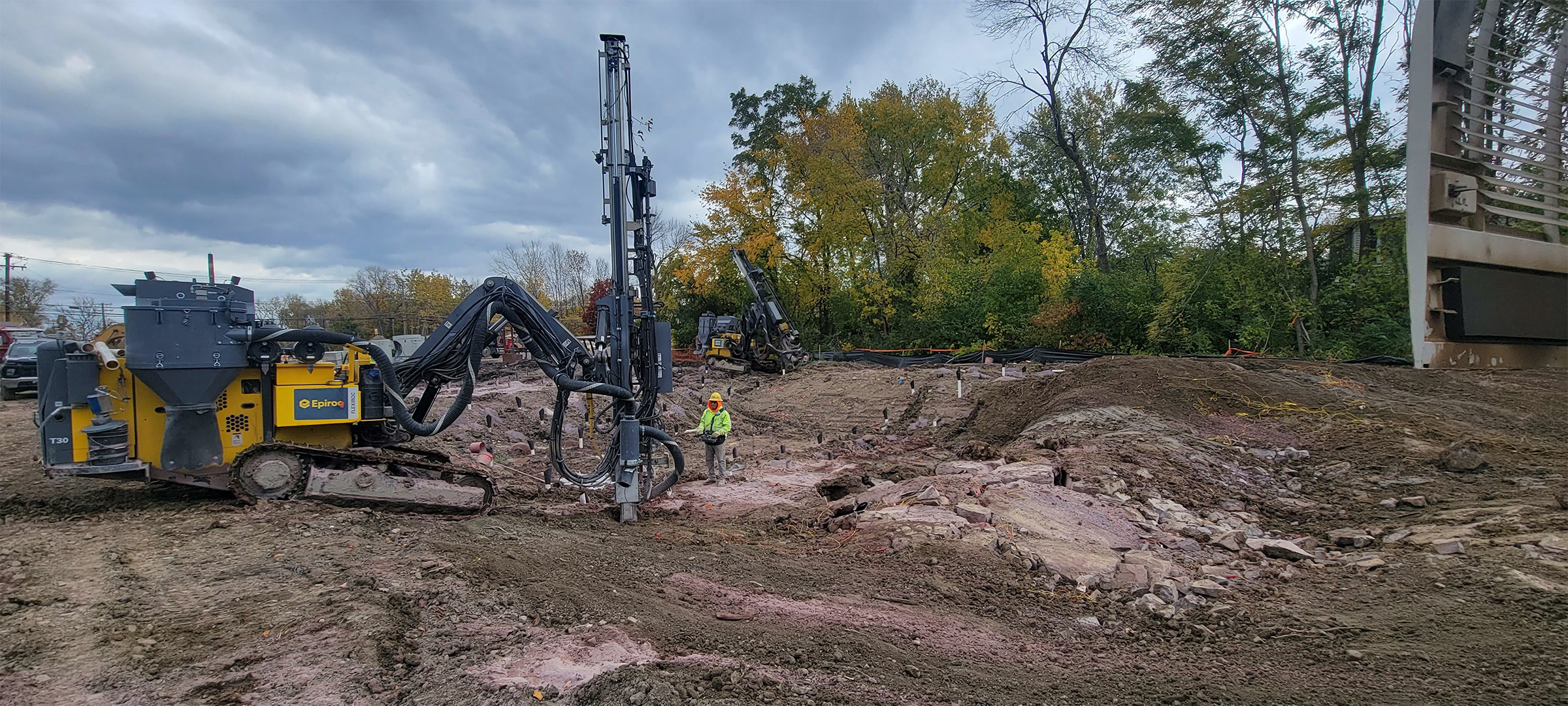

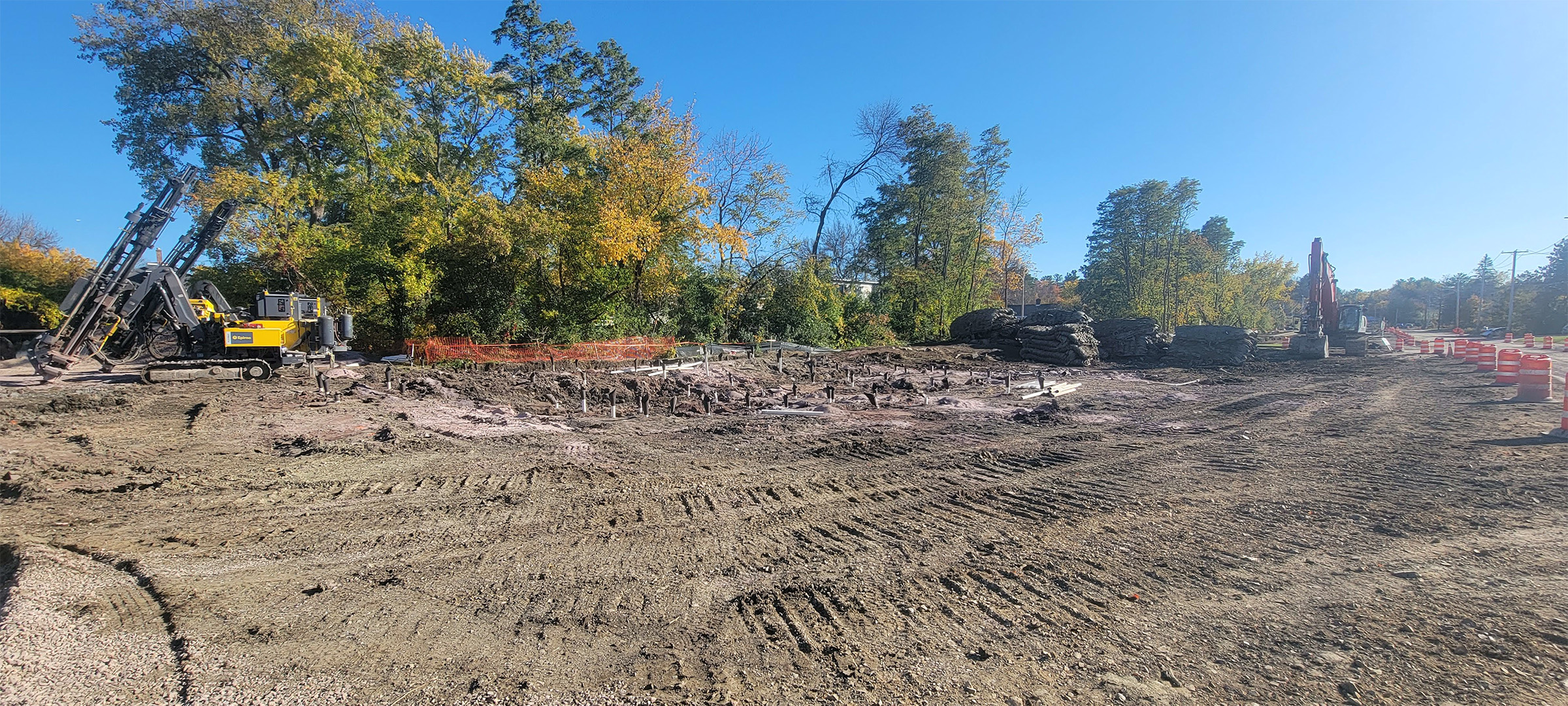

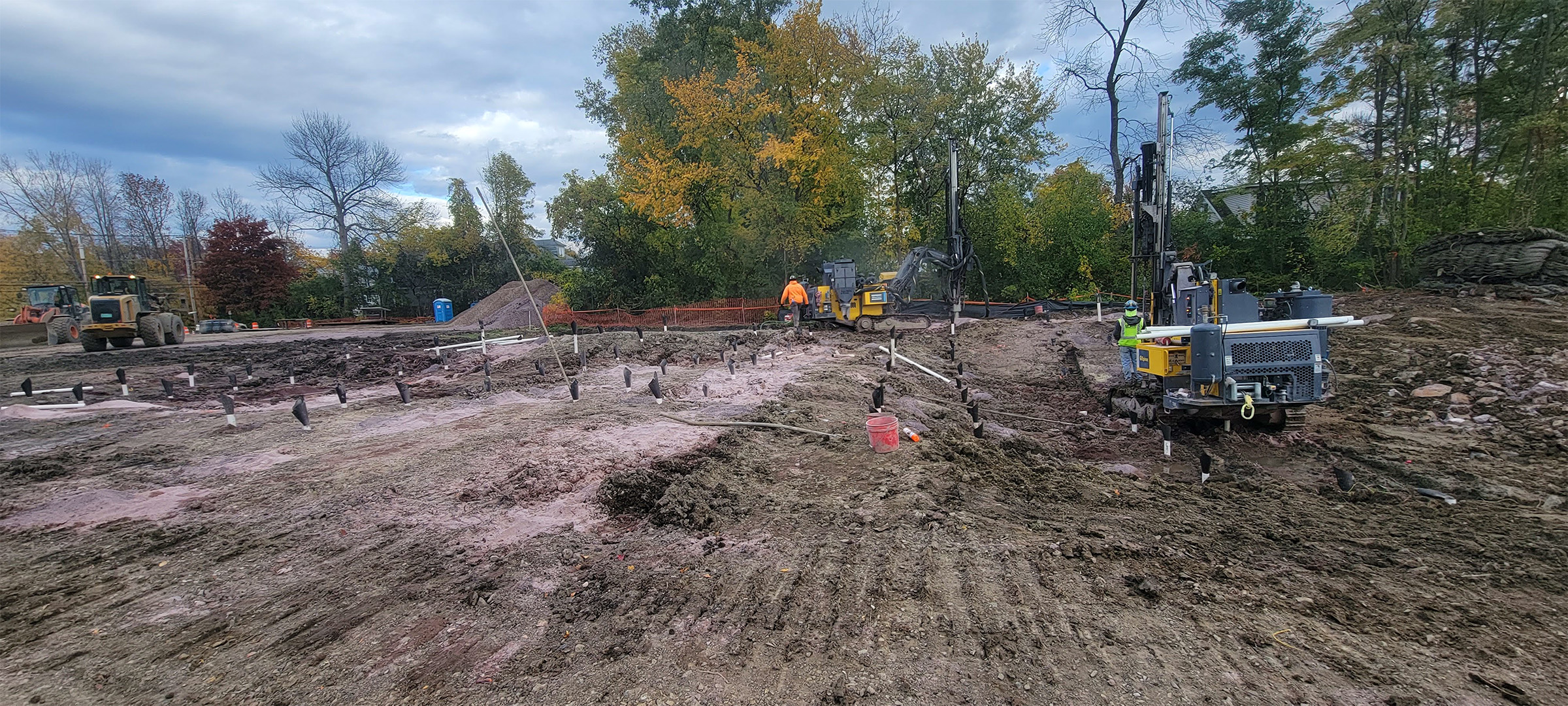

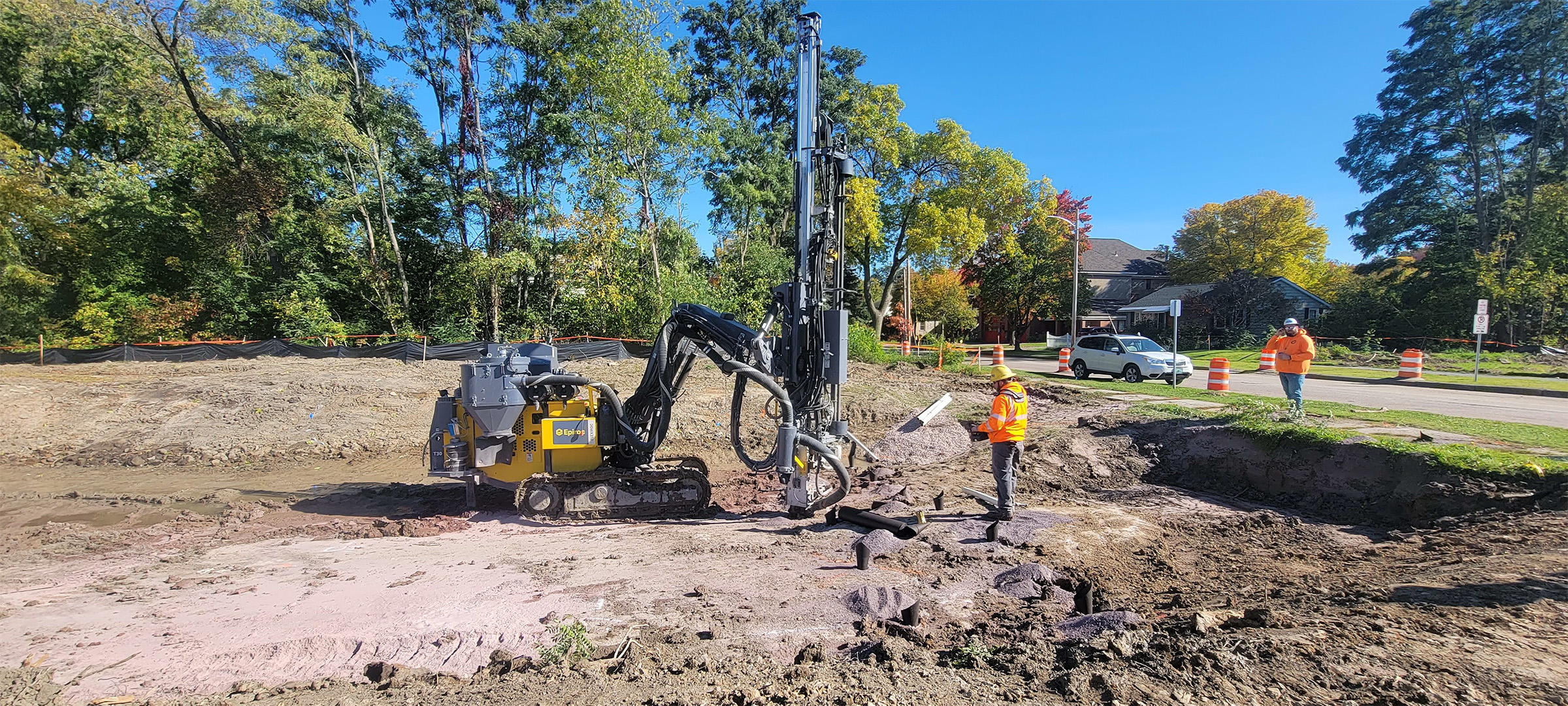

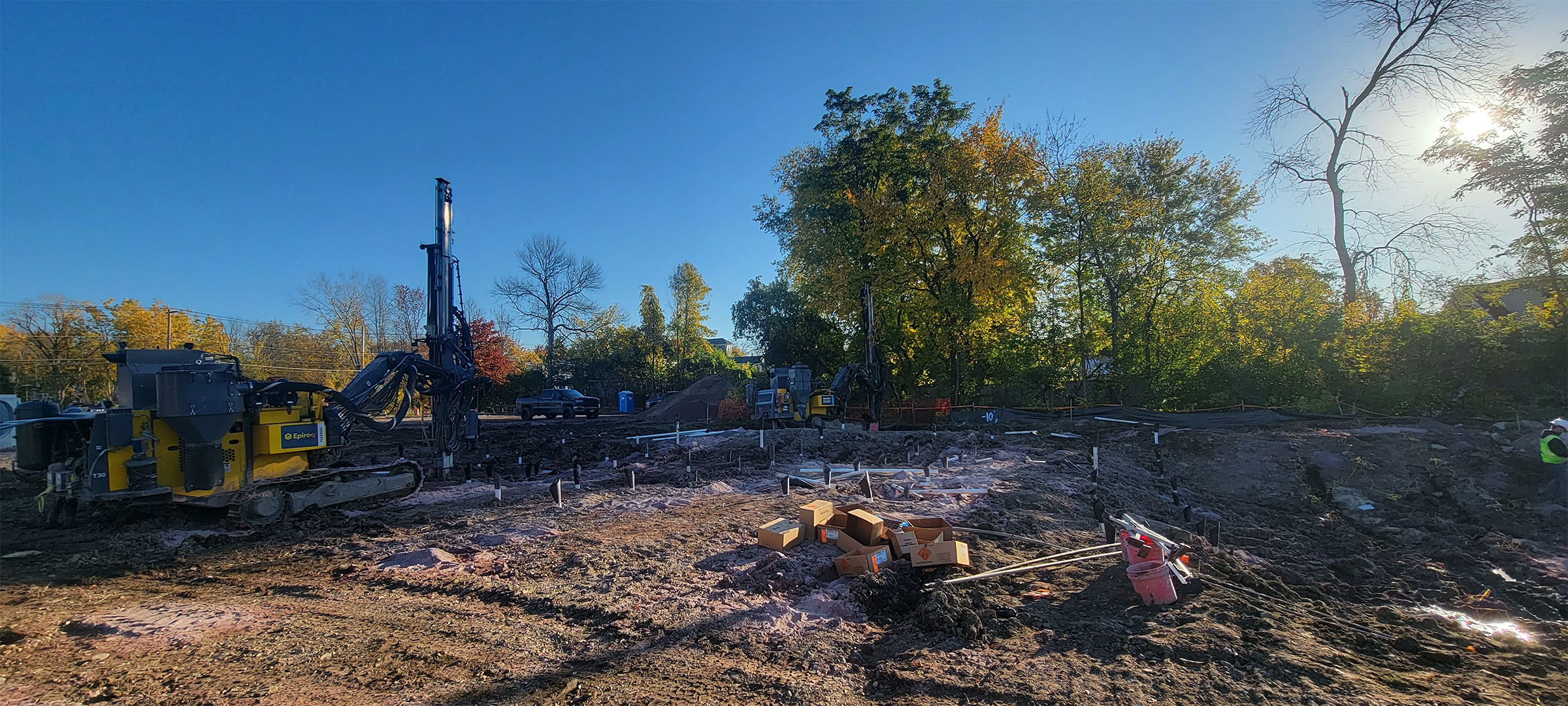

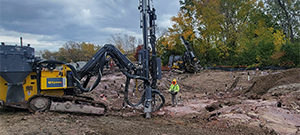

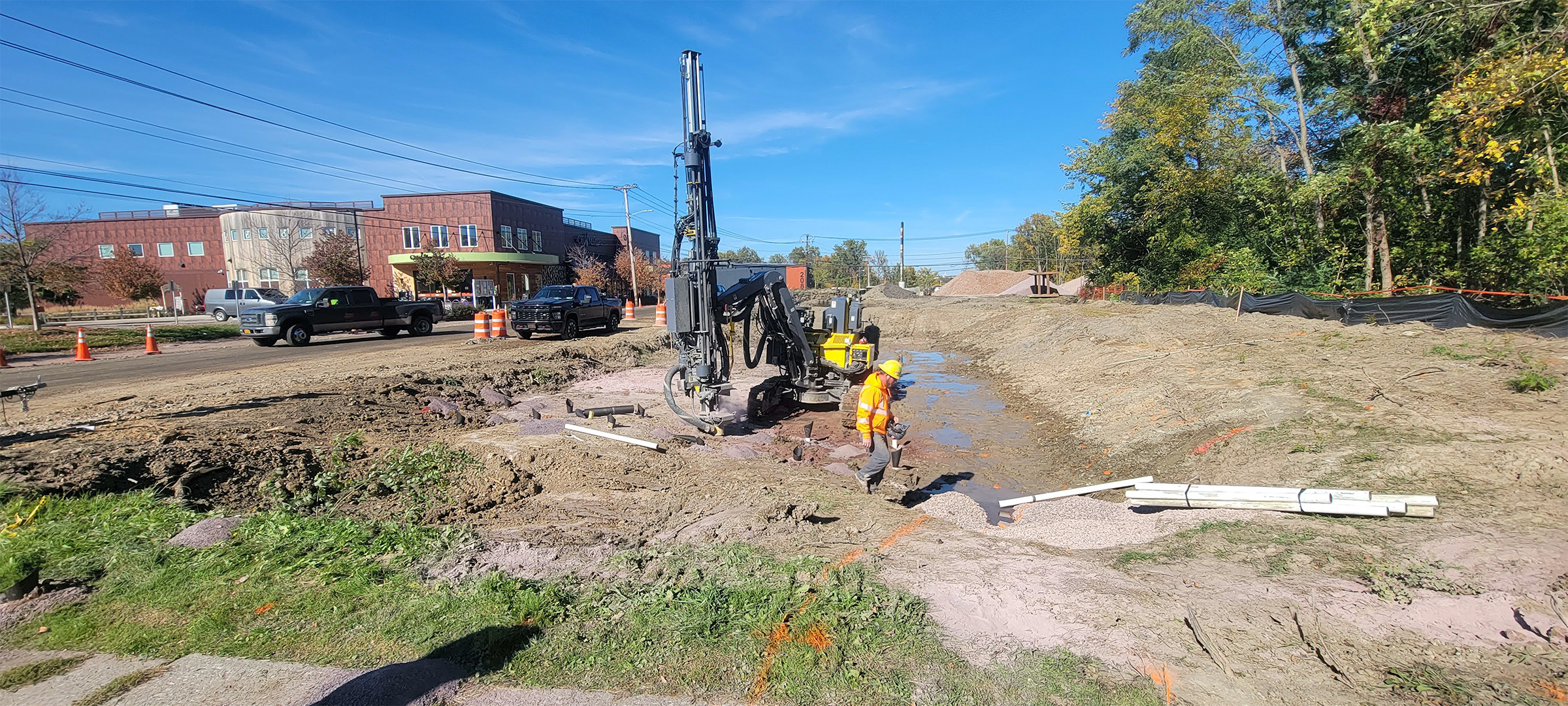

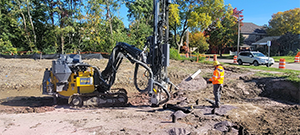

Crews drilling in preparation for blasting to remove ledge along the east side of Briggs Street just south of Flynn Avenue.
Crews drilling in preparation for blasting to remove ledge along the east side of Briggs Street just south of Flynn Avenue.
Crews drilling in preparation for blasting to remove ledge along the east side of Briggs Street just south of Flynn Avenue.

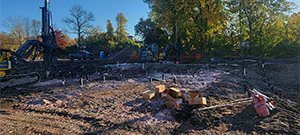

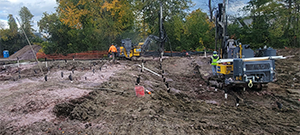

Crews prepare the site for blasting to remove ledge along the east side of Briggs Street just south of Flynn Avenue.
Crews prepare the site for blasting to remove ledge along the east side of Briggs Street just south of Flynn Avenue.

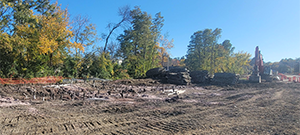

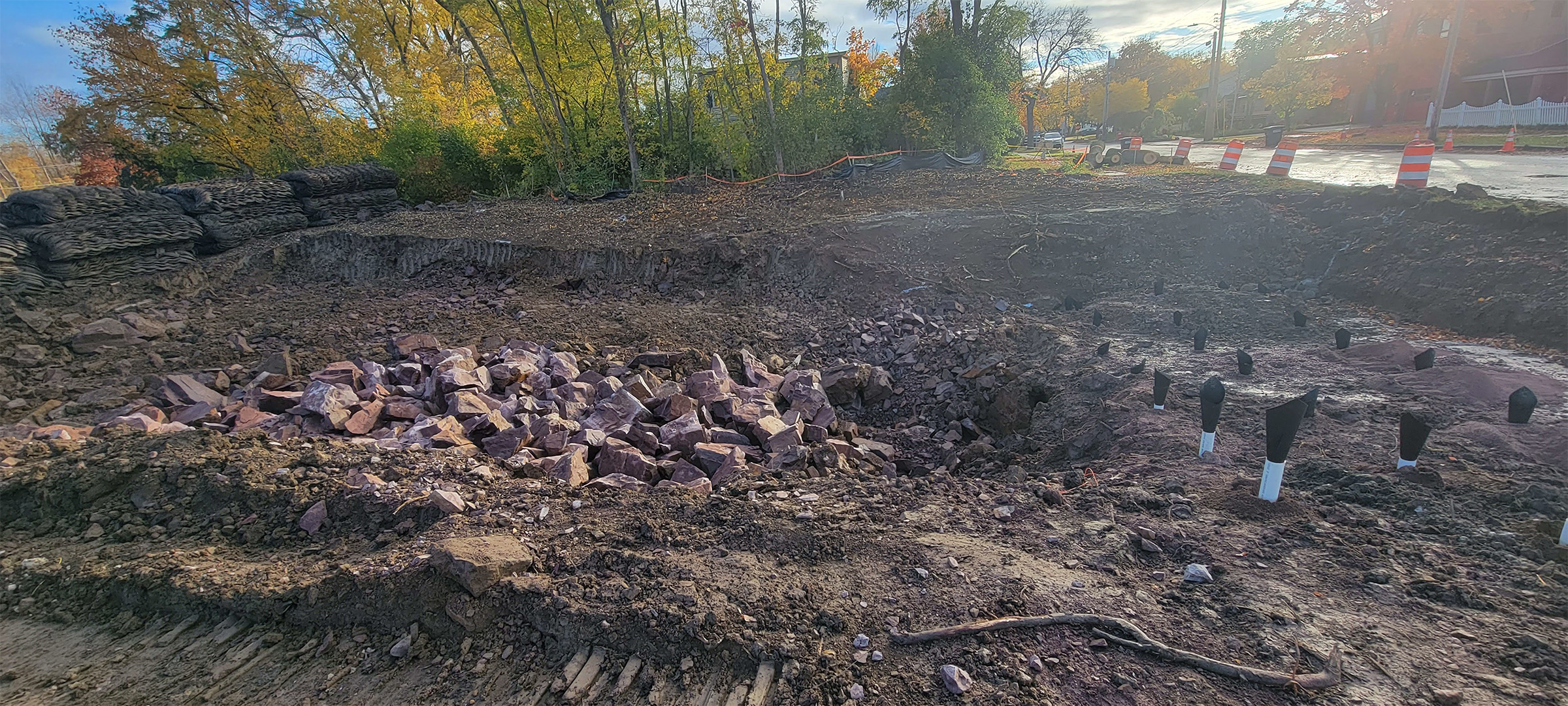

Site prepared for blasting to remove ledge along the east side of Briggs Street just south of Flynn Avenue.

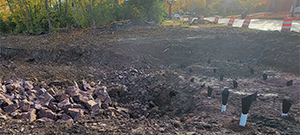

Blasted ledge for removal and preparation for additional blasting along the east side of Briggs Street just south of Flynn Avenue. Protective blasting mats pictured in the background.

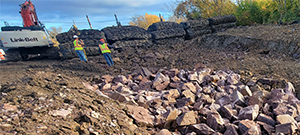

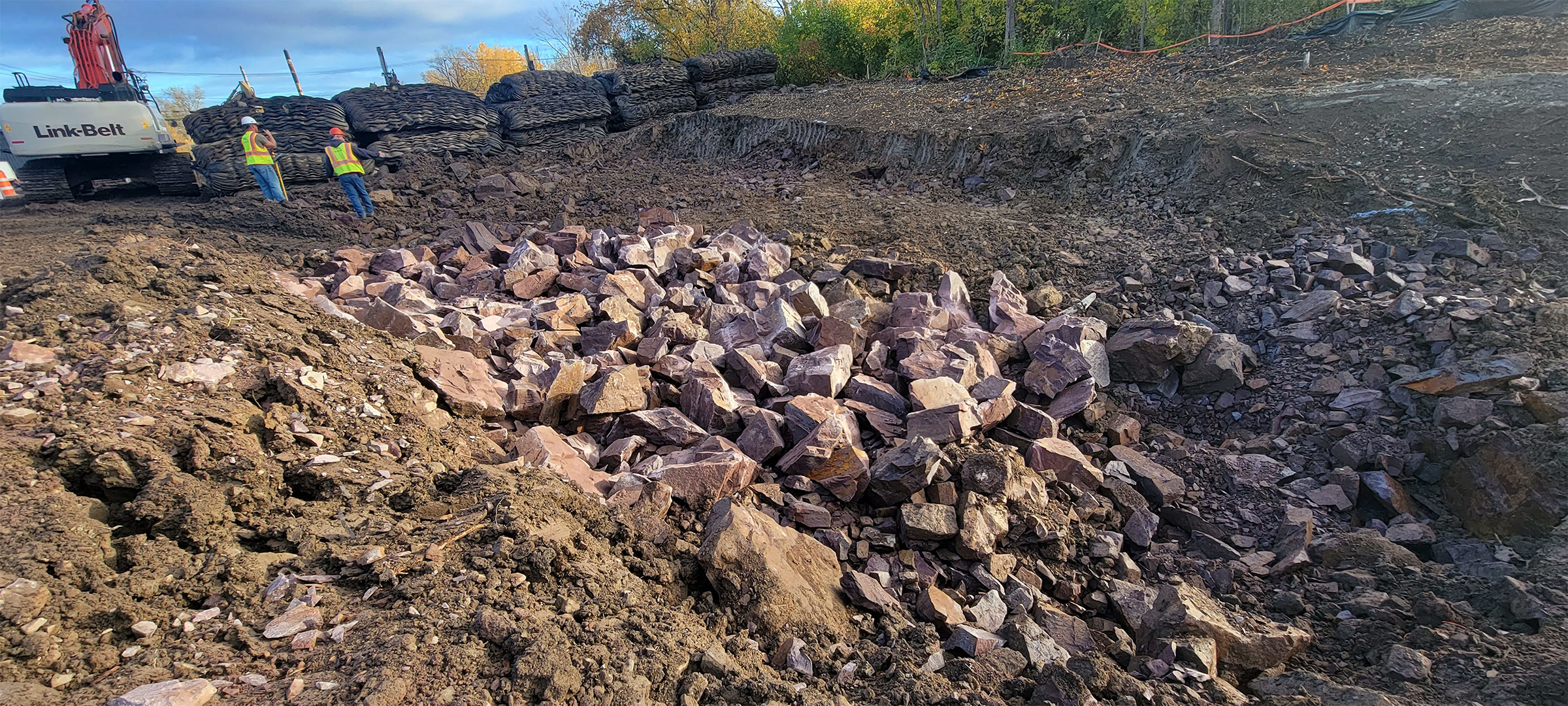

Blasted ledge for removal along the east side of Briggs Street just south of Flynn Avenue. Protective blasting mats pictured in the background.

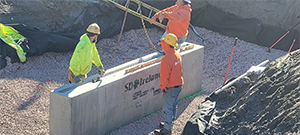

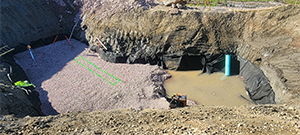

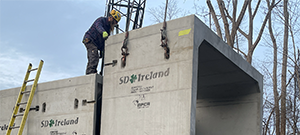

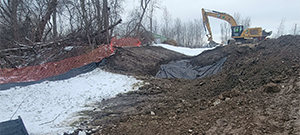

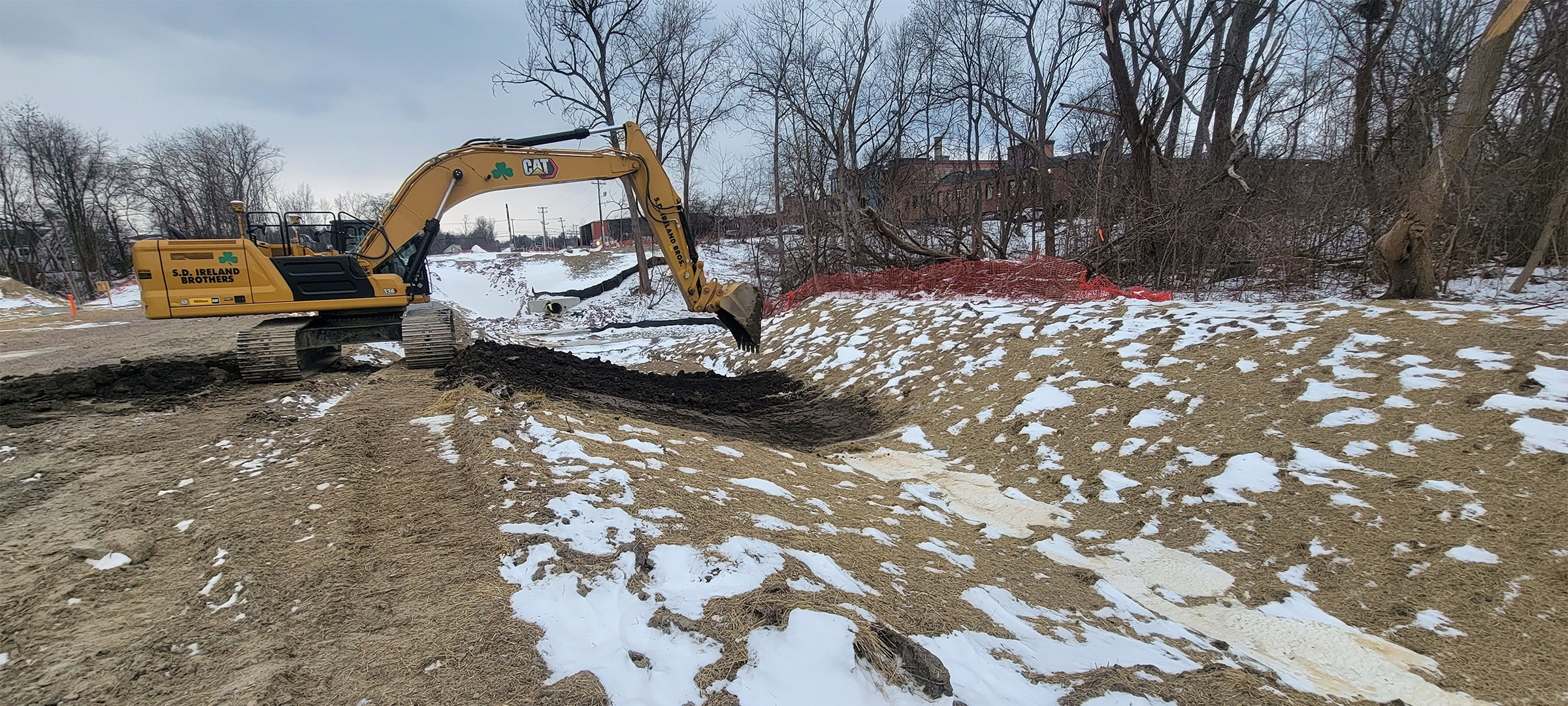

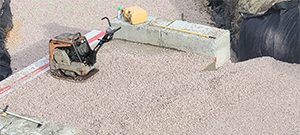

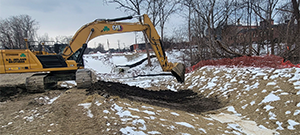

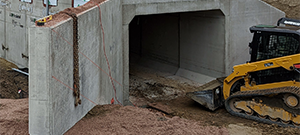

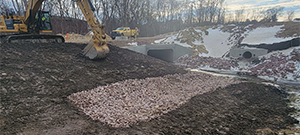

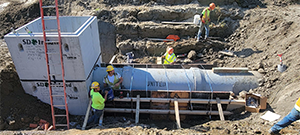

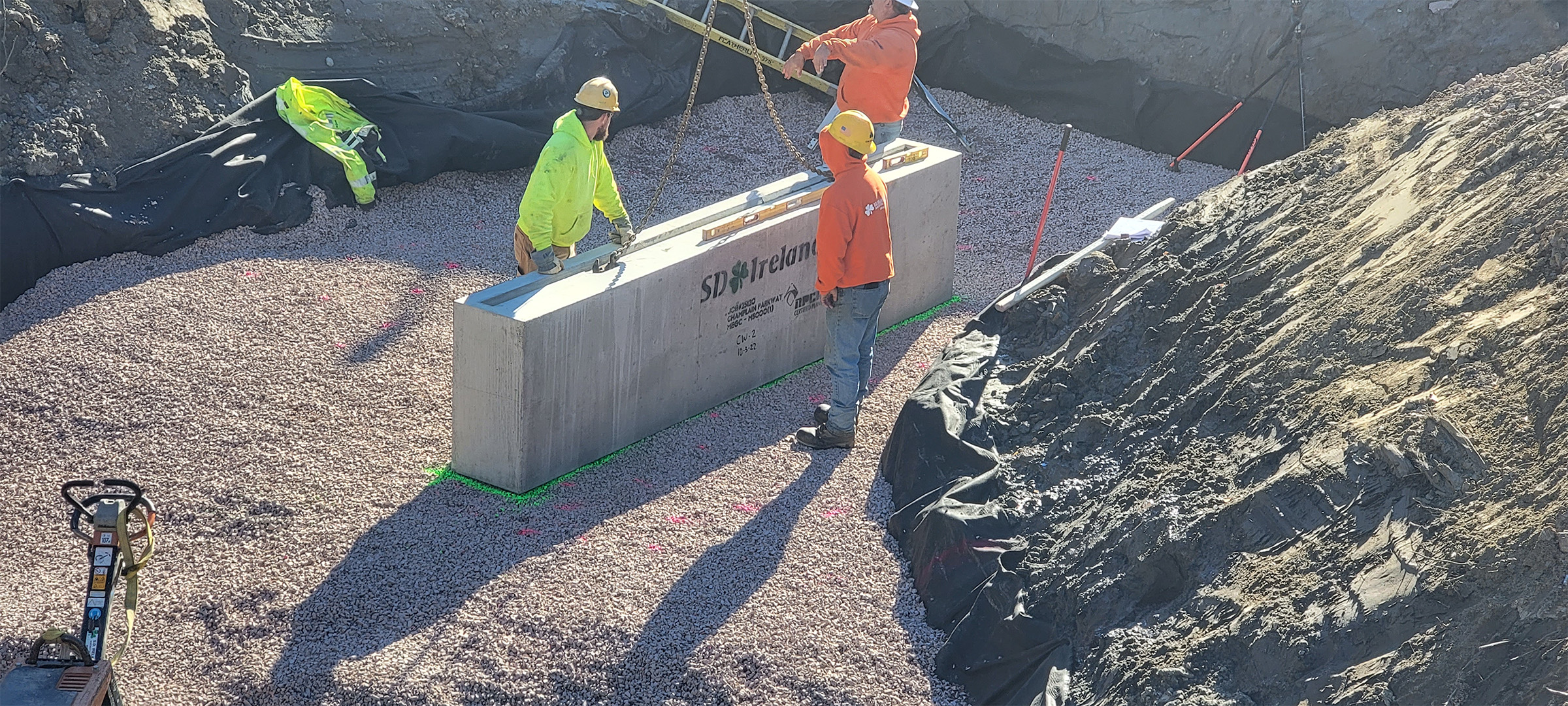

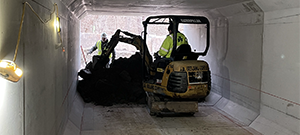

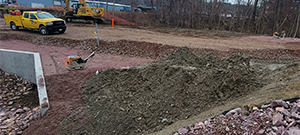

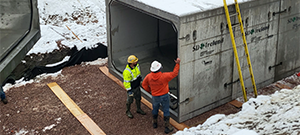

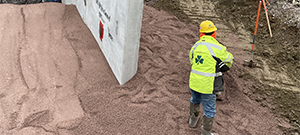

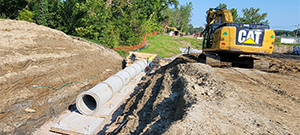

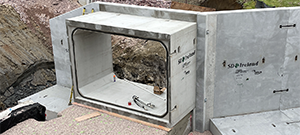

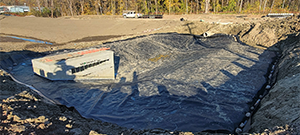

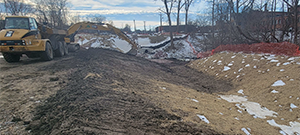

The Champlain Parkway Project includes several stormwater features including a box culvert for the Englesby Brook. Pictured downstream wingwall excavation.
The Champlain Parkway Project includes several stormwater features including a box culvert for the Englesby Brook.
The Champlain Parkway Project includes several stormwater features including a box culvert for the Englesby Brook.
The Champlain Parkway Project includes several stormwater features including a box culvert for the Englesby Brook. Pictured completed downstream end of box culvert.
The Champlain Parkway Project includes several stormwater features including a box culvert for the Englesby Brook. Pictured placement of the precast box culvert segments.
The Champlain Parkway Project includes several stormwater features including a box culvert for the Englesby Brook.
The Champlain Parkway Project includes several stormwater features including a box culvert for the Englesby Brook. Pictured placement of the precast box culvert segments.
The Champlain Parkway Project includes several stormwater features including a box culvert for the Englesby Brook. Pictured completed downstream end of the box culvert.
The Champlain Parkway Project includes several stormwater features including a box culvert for the Englesby Brook. Pictured completed downstream end of the box culvert.
The Champlain Parkway Project includes several stormwater features including a box culvert for the Englesby Brook. Pictured completed downstream end of the box culvert.
The Champlain Parkway Project includes several stormwater features including a box culvert for the Englesby Brook. Pictured completed upstream end of the box culvert with streambed material placed and water introduced.
The Champlain Parkway Project includes several stormwater features including a box culvert for the Englesby Brook. Pictured backfilling around completed box culvert.
The Champlain Parkway Project includes several stormwater features including a box culvert for the Englesby Brook. Pictured completed box culvert.

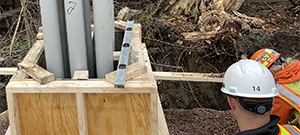

Aerial electrical and telecommunication utilities were relocated underground throughout portions of the south end. Crews installing underground electrical and telecommunication duct bank. This segment crosses the Champlain Parkway and Briggs Street.
Aerial electrical and telecommunication utilities were relocated underground throughout portions of the south end. Crews installing underground electrical and telecommunication duct bank. This segment crosses the Champlain Parkway and Briggs Street.
Aerial electrical and telecommunication utilities were relocated underground throughout portions of the south end. Crews installing underground electrical and telecommunication duct bank. This segment crosses the Champlain Parkway and Briggs Street.
Aerial electrical and telecommunication utilities were relocated underground throughout portions of the south end. Crews installing underground electrical and telecommunication duct bank. This segment crosses the Champlain Parkway and Briggs Street.
Aerial electrical and telecommunication utilities were relocated underground throughout portions of the south end. Crews installing underground electrical and telecommunication duct bank. This shows the concrete riser that houses the underground conduits at its terminus on Briggs Street.

The Champlain Parkway Project included several stormwater features including the grass swale constructed along the Champlain Parkway.
Aerial electrical and telecommunication utilities were relocated underground throughout portions of the south end. Crews installing underground electrical and telecommunication duct bank. This shows the construction of the concrete riser that houses the underground conduits at its terminus on Briggs Street.

The installation of underdrain, a stormwater feature, beneath the new Champlain Parkway between Lakeside Avenue and Home Avenue.
The installation of underdrain, a stormwater feature, beneath the new Champlain Parkway between Lakeside Avenue and Home Avenue.
The installation of underdrain, a stormwater feature, beneath the new Champlain Parkway between Lakeside Avenue and Home Avenue.
The installation of underdrain, a stormwater feature, beneath the new Champlain Parkway between Lakeside Avenue and Home Avenue. Pictured is a flushing basin.
The Champlain Parkway Project included several stormwater features including the grass swale constructed along the Champlain Parkway.
The Champlain Parkway Project included several stormwater features including the grass swale constructed along the Champlain Parkway.
The Champlain Parkway Project included several stormwater features including the grass swale constructed along the Champlain Parkway.
The Champlain Parkway Project included several stormwater features including the grass swale constructed along the Champlain Parkway.
The Champlain Parkway Project included several stormwater features including the grass swale constructed along the Champlain Parkway.
The Champlain Parkway Project included several stormwater features including the grass swale constructed along the Champlain Parkway.
The Champlain Parkway Project included several stormwater features including the grass swale constructed along the Champlain Parkway.
The Champlain Parkway Project included several stormwater features including the grass swale constructed along the Champlain Parkway.
The Champlain Parkway Project included several stormwater features including the grass swale constructed along the Champlain Parkway.

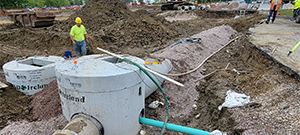

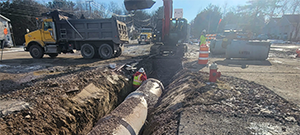

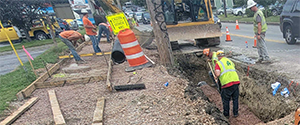

New stormwater infrastructure installed along the Champlain Parkway. Pictured adjacent to Briggs Street.
New stormwater infrastructure installed along the Champlain Parkway.
New stormwater infrastructure installed along the Champlain Parkway. Pictured near Morse Place.
New stormwater infrastructure installed along the Champlain Parkway.

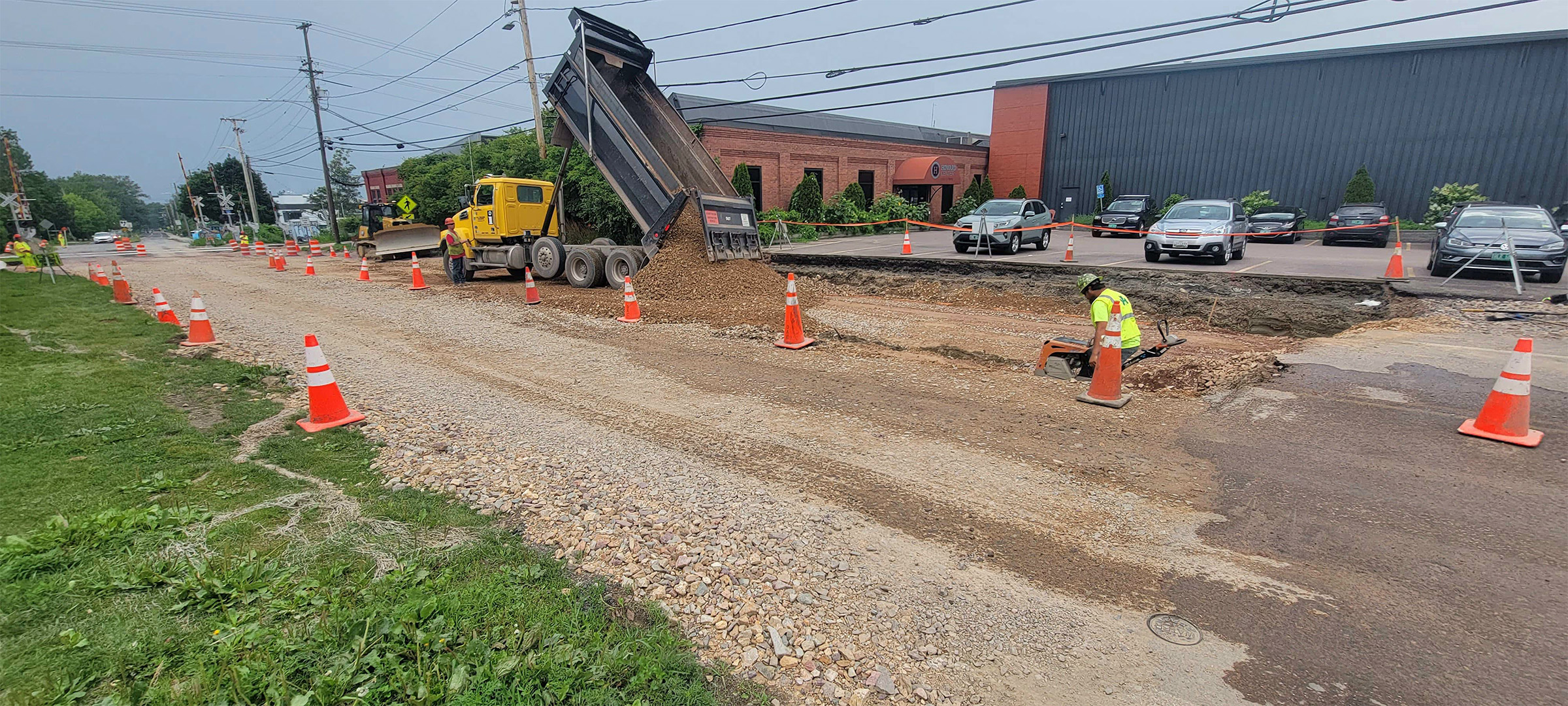

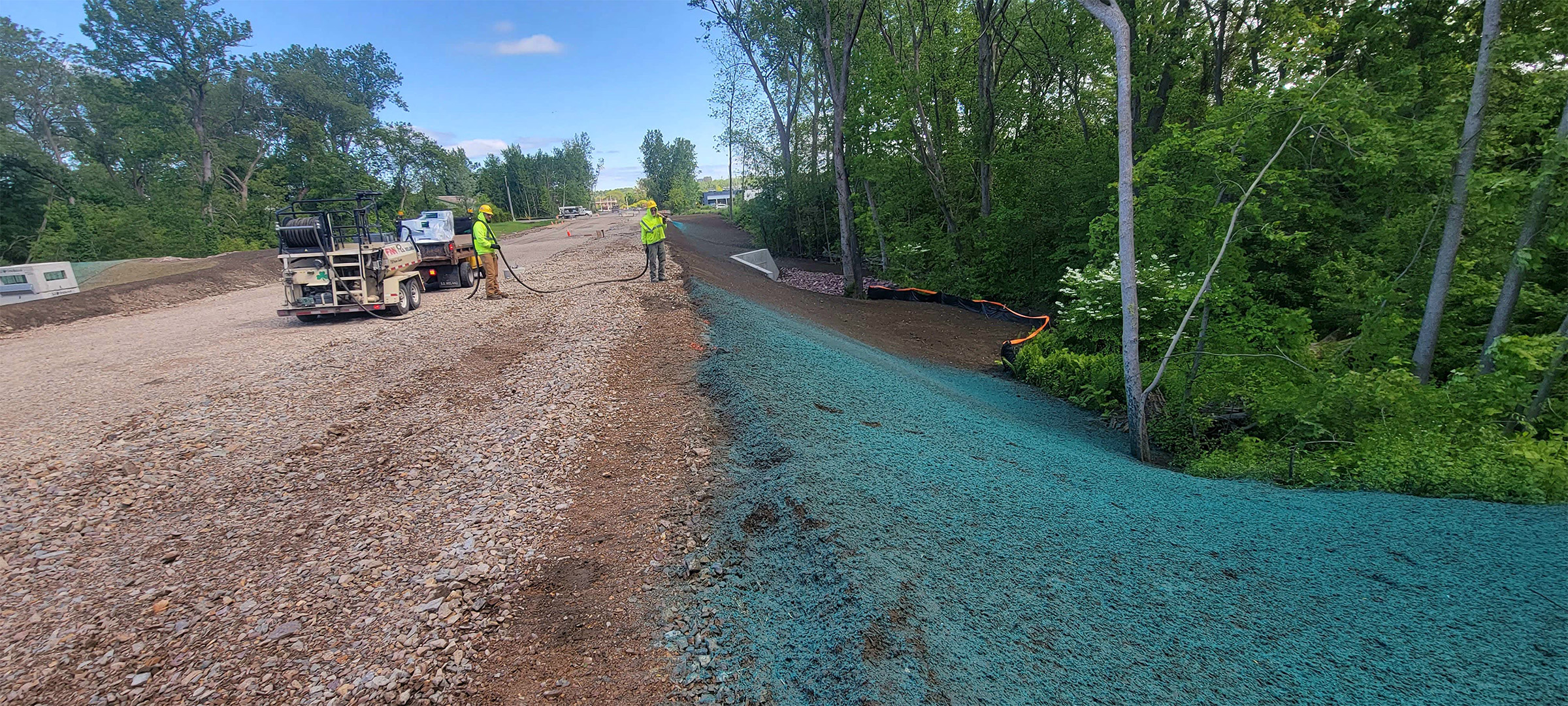

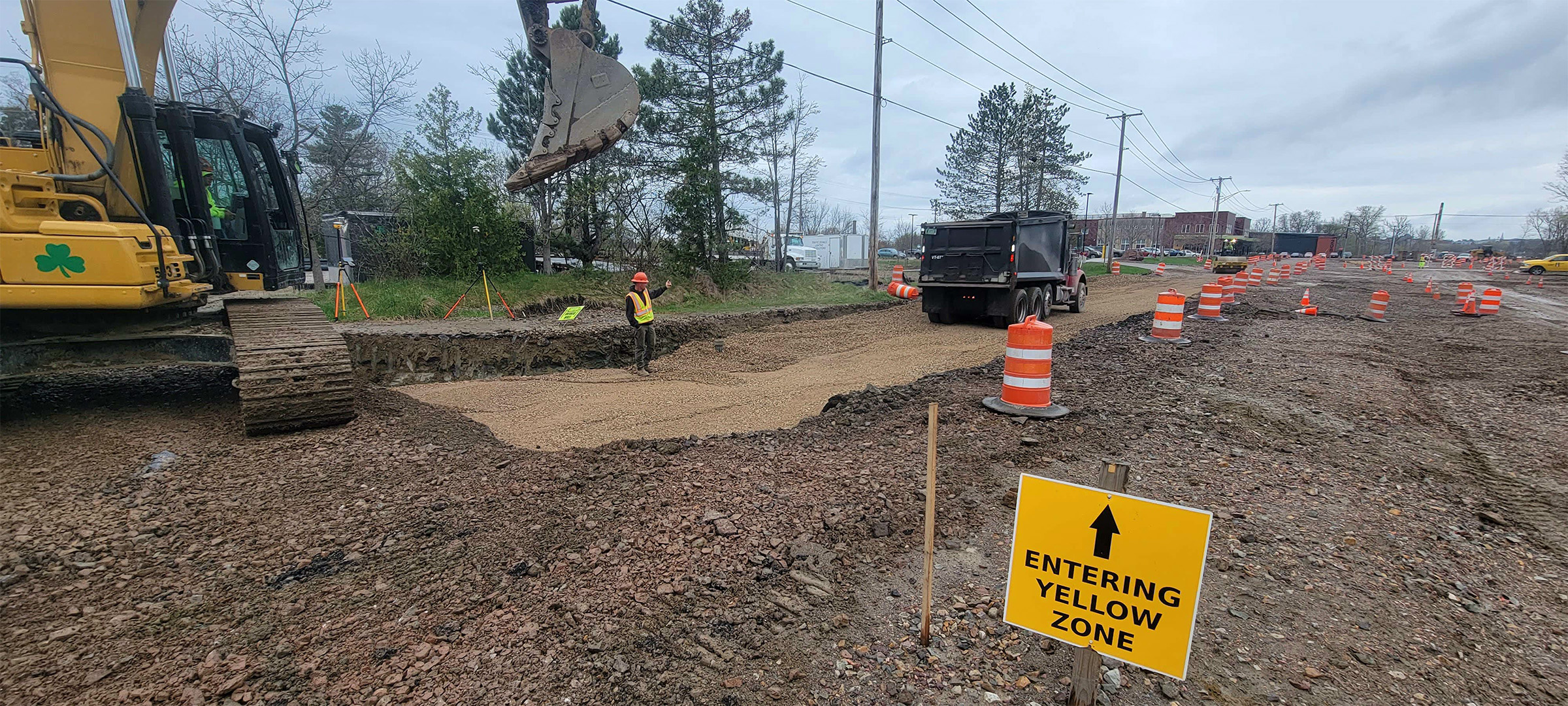

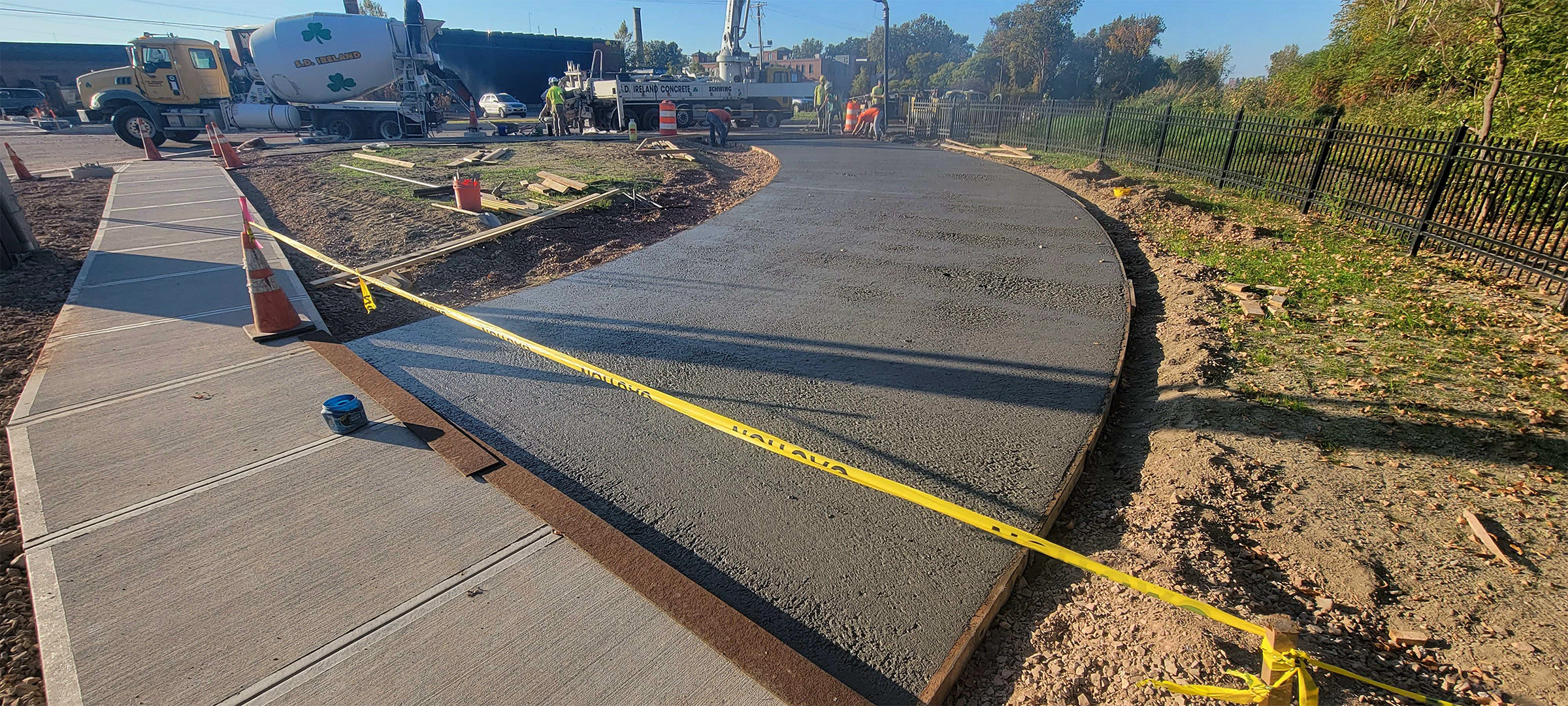

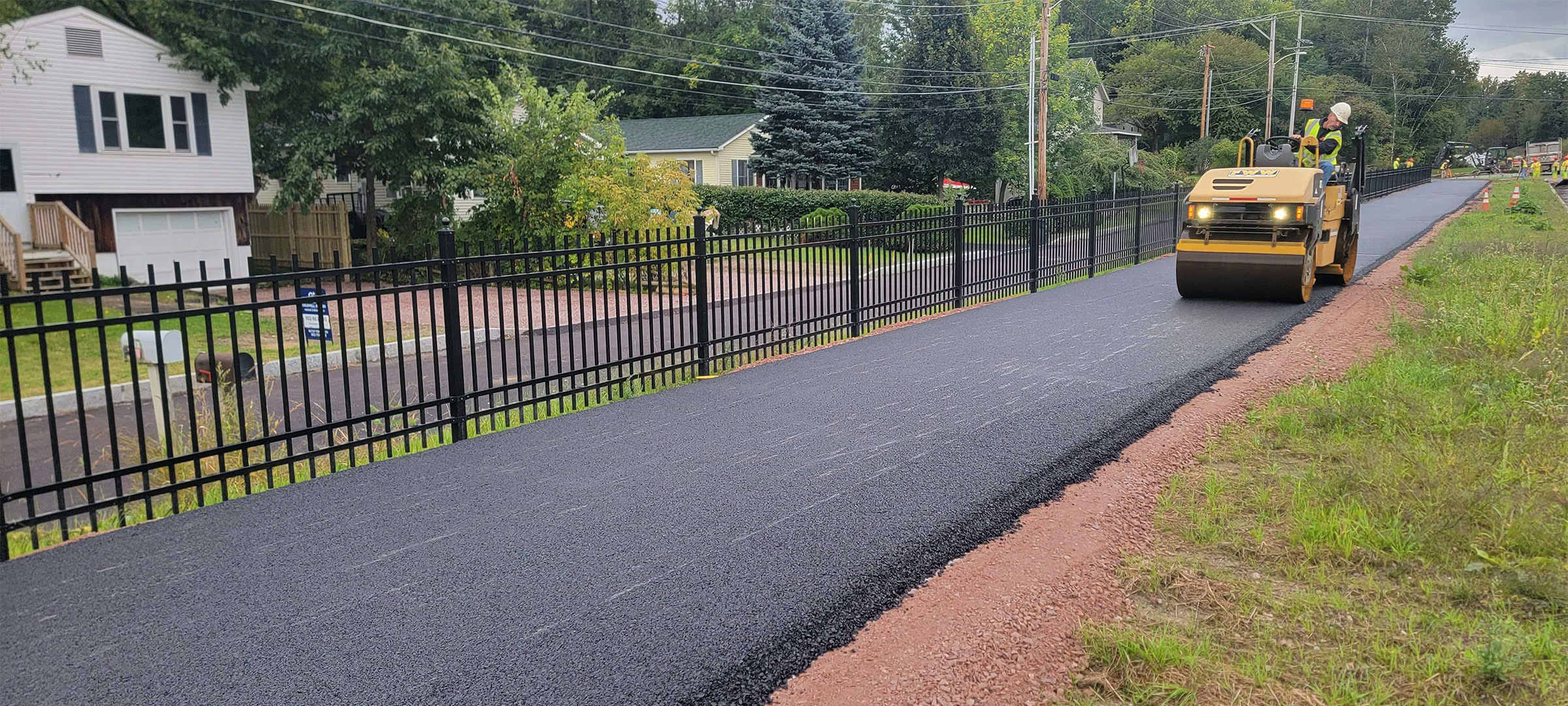

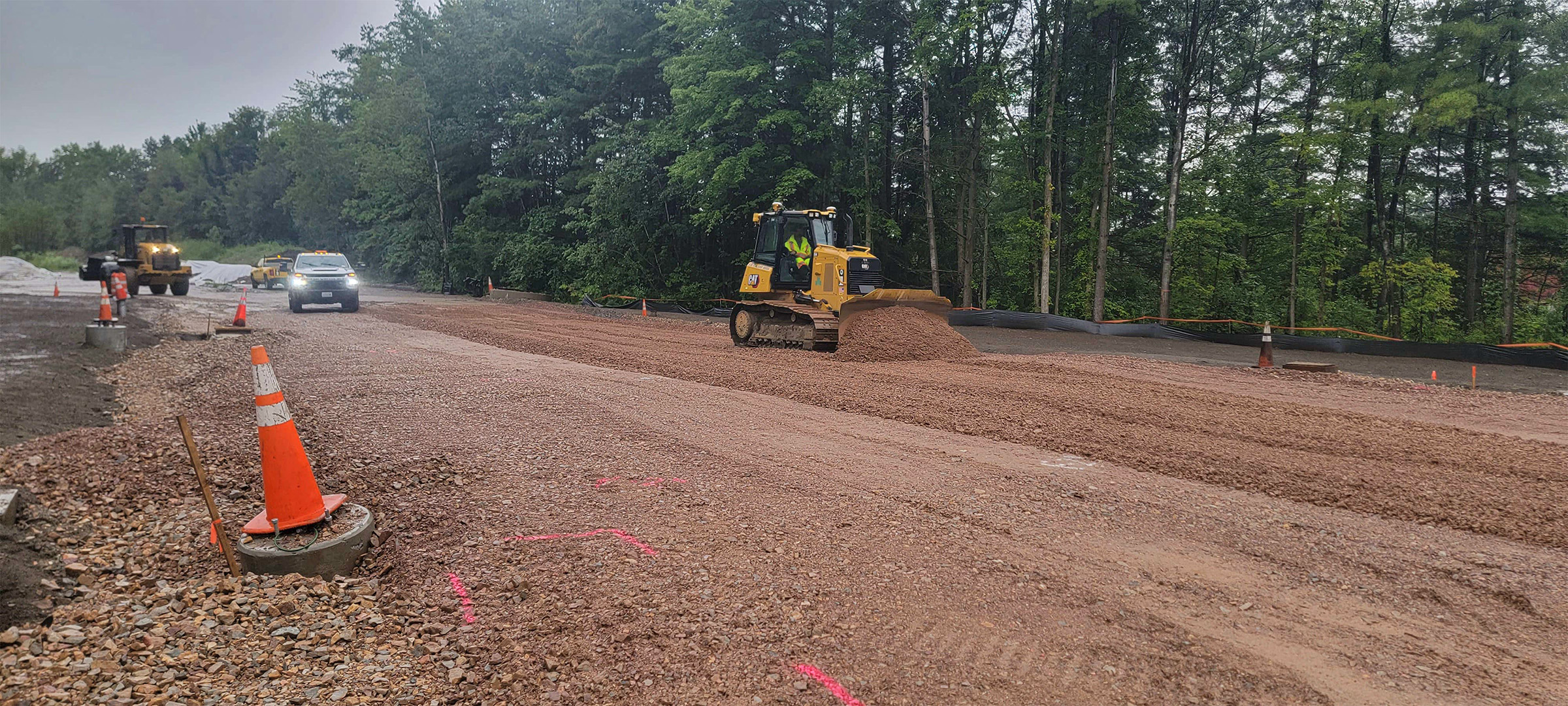

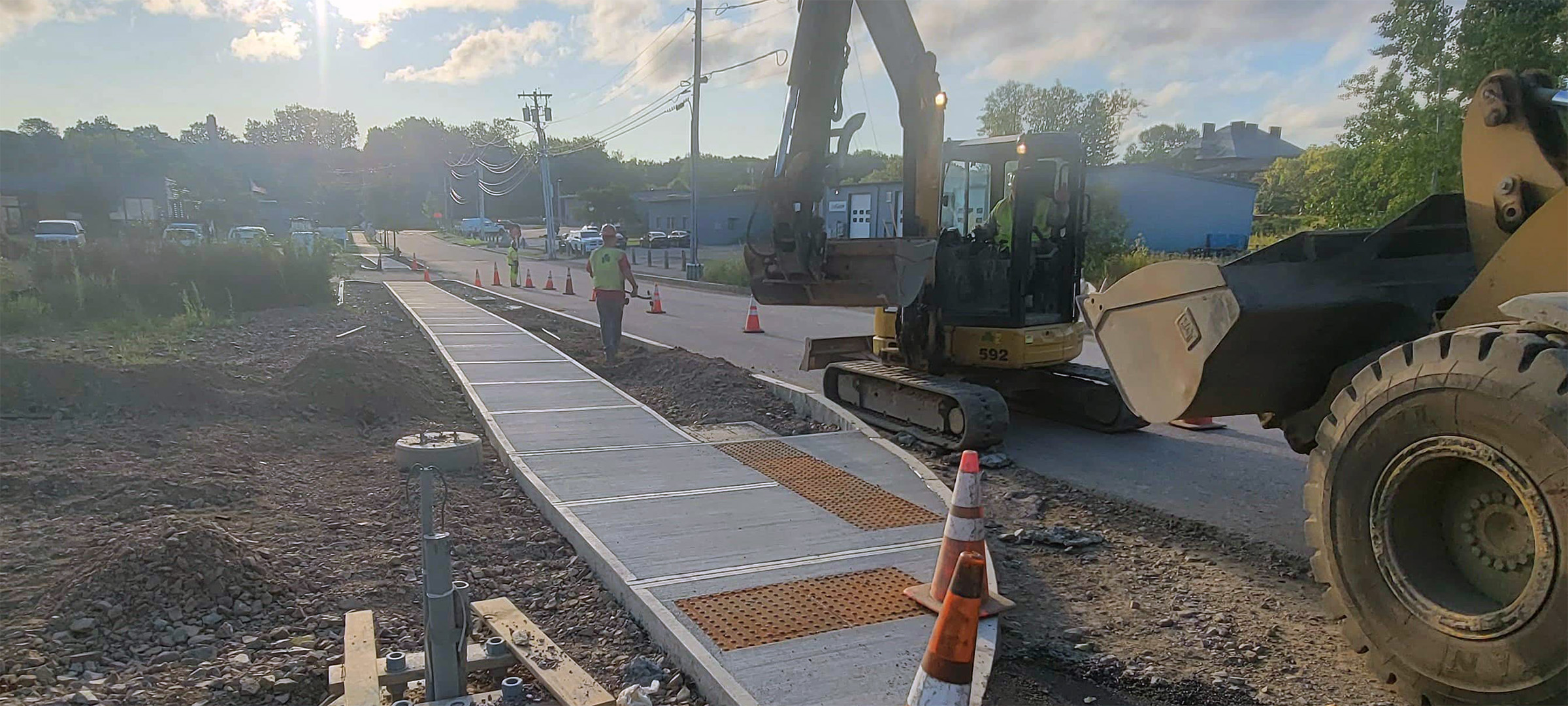

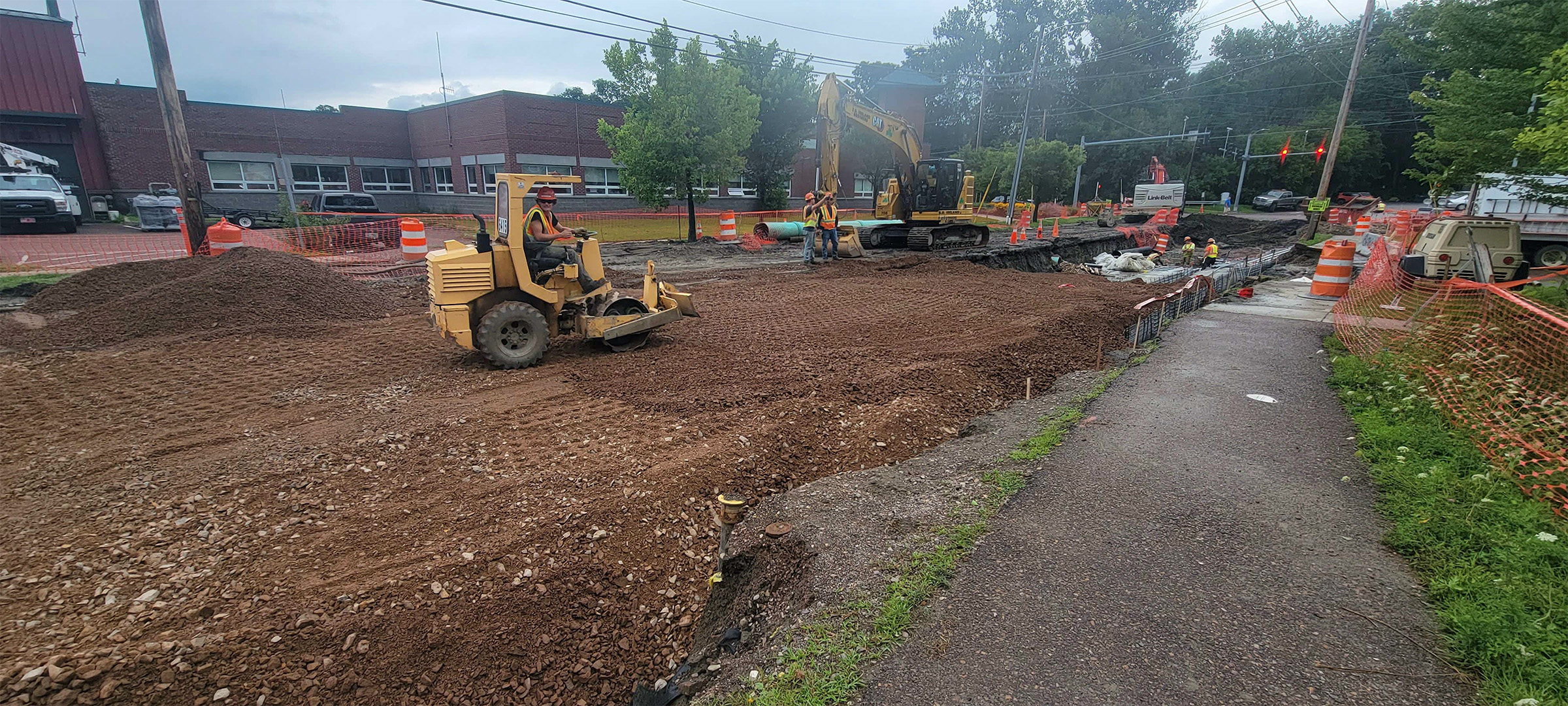

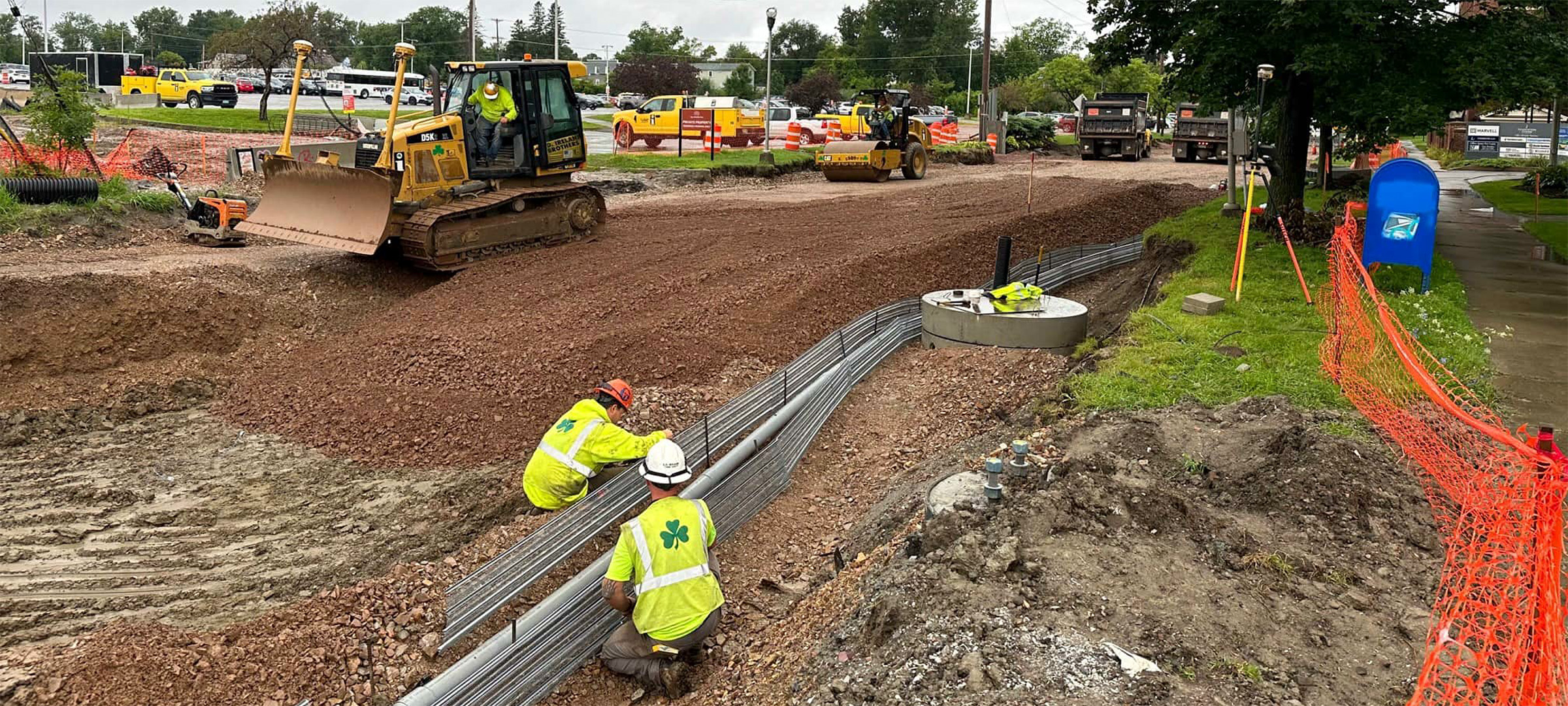

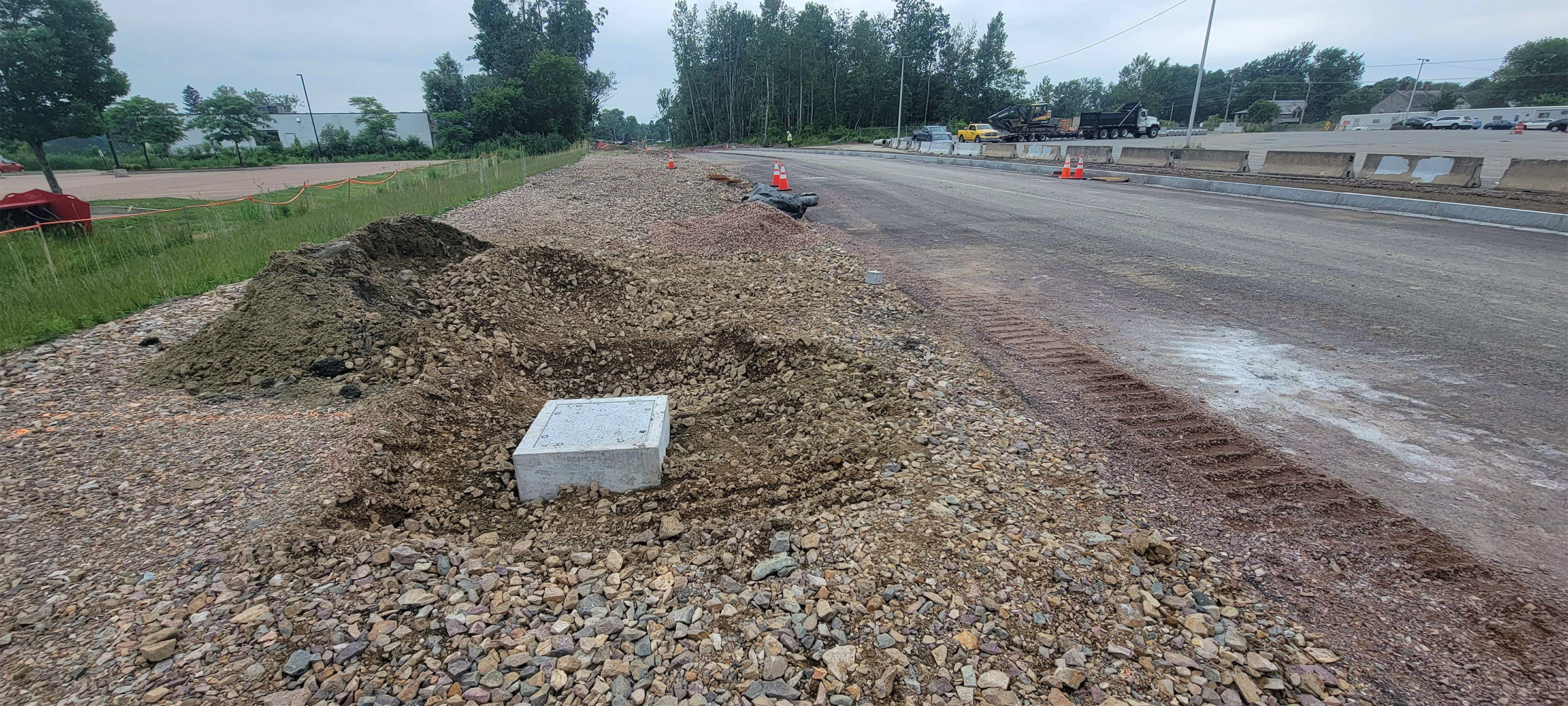

Initial Contract - Construction Season 2 (155)

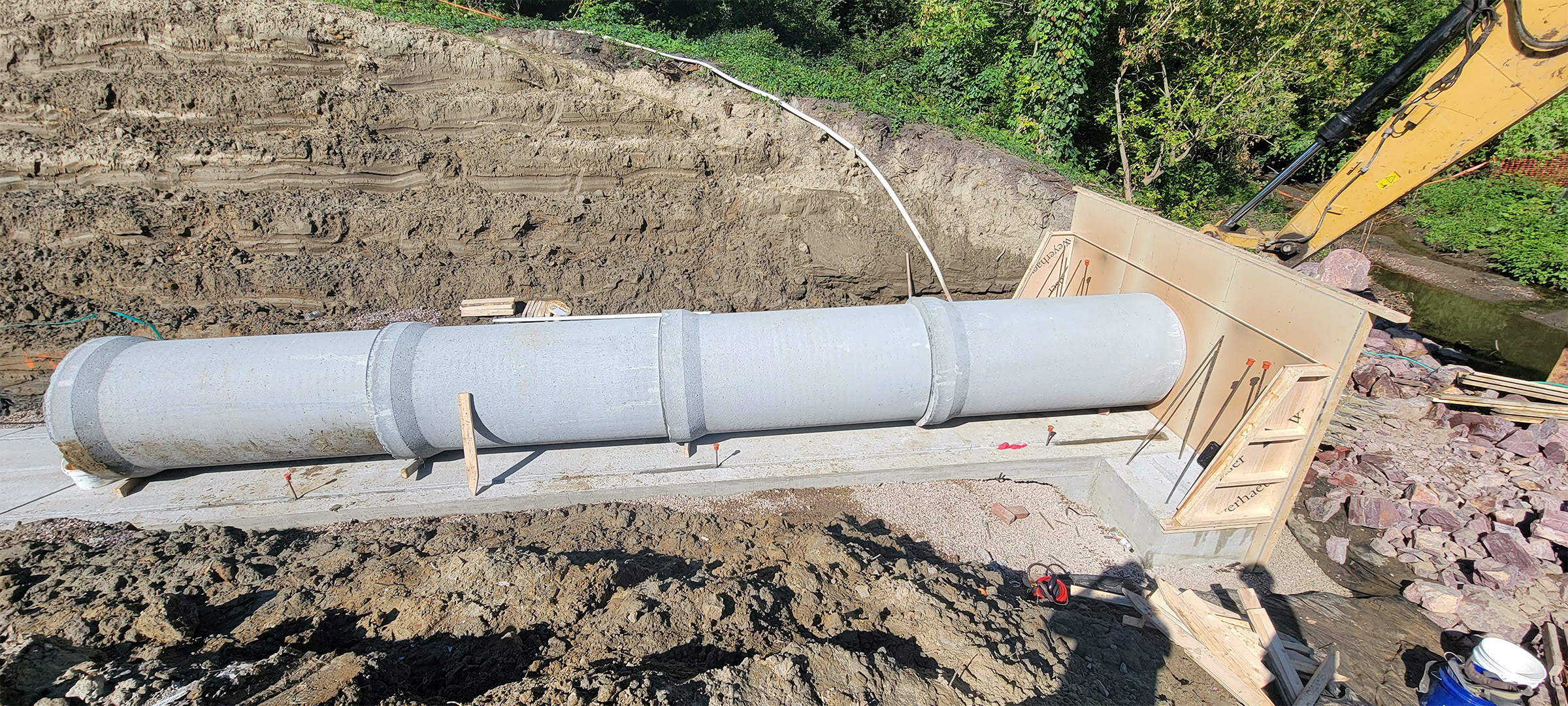

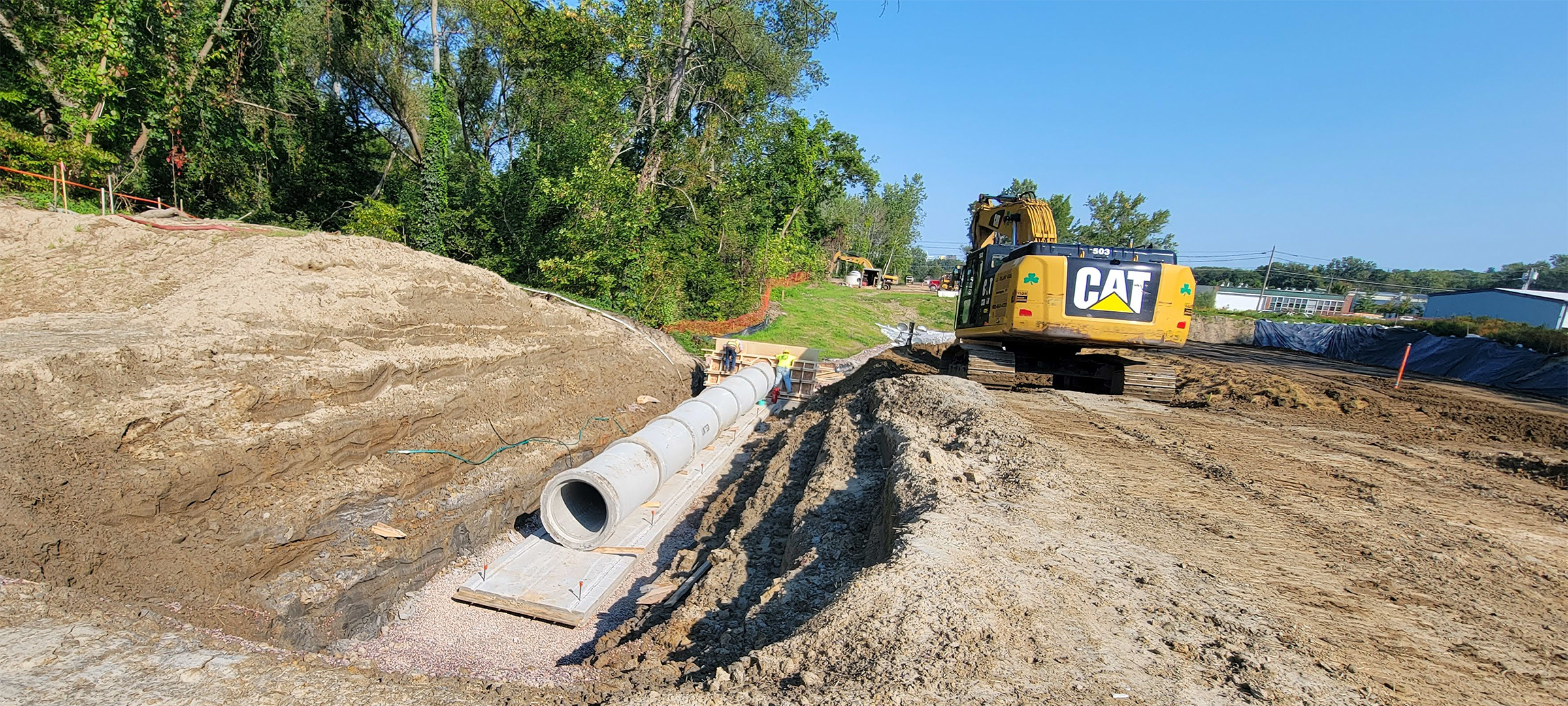

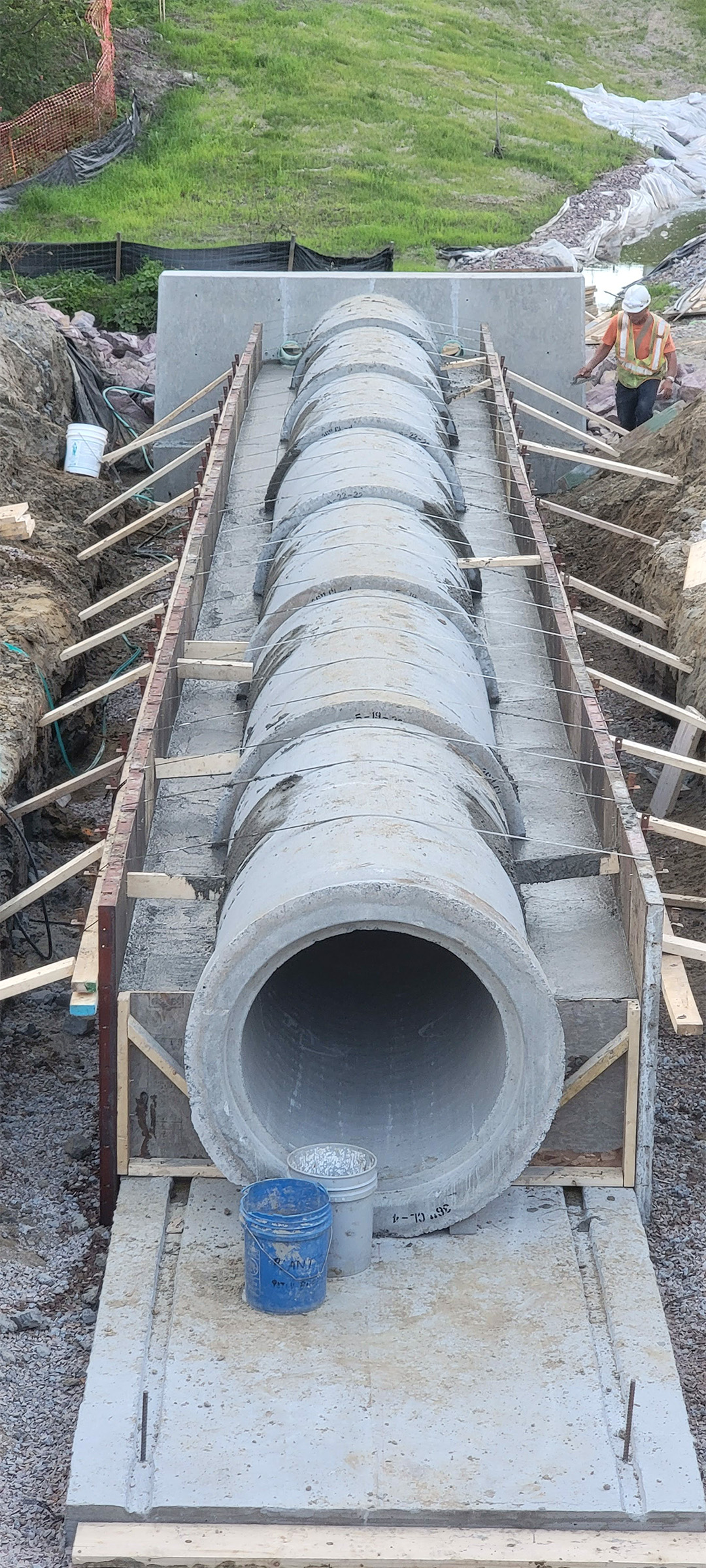

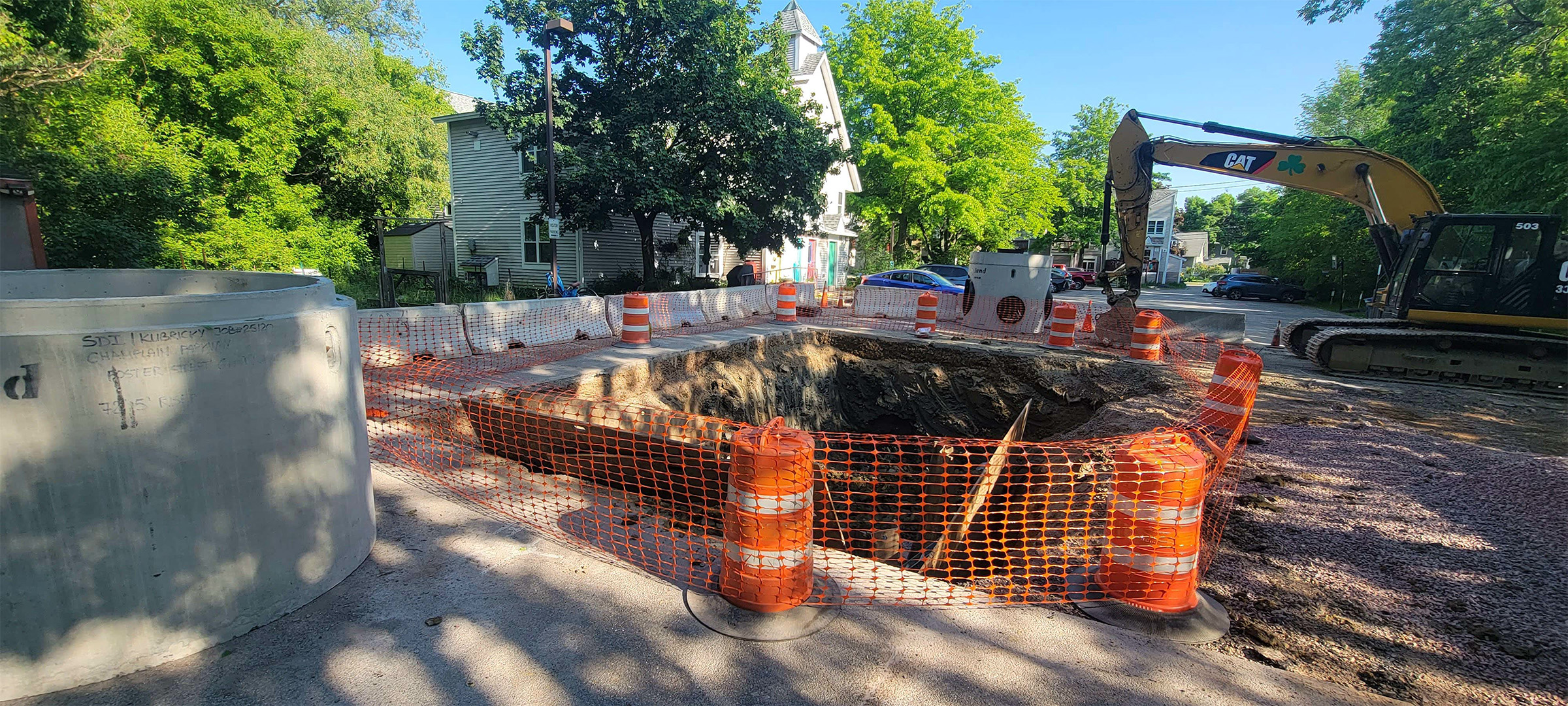

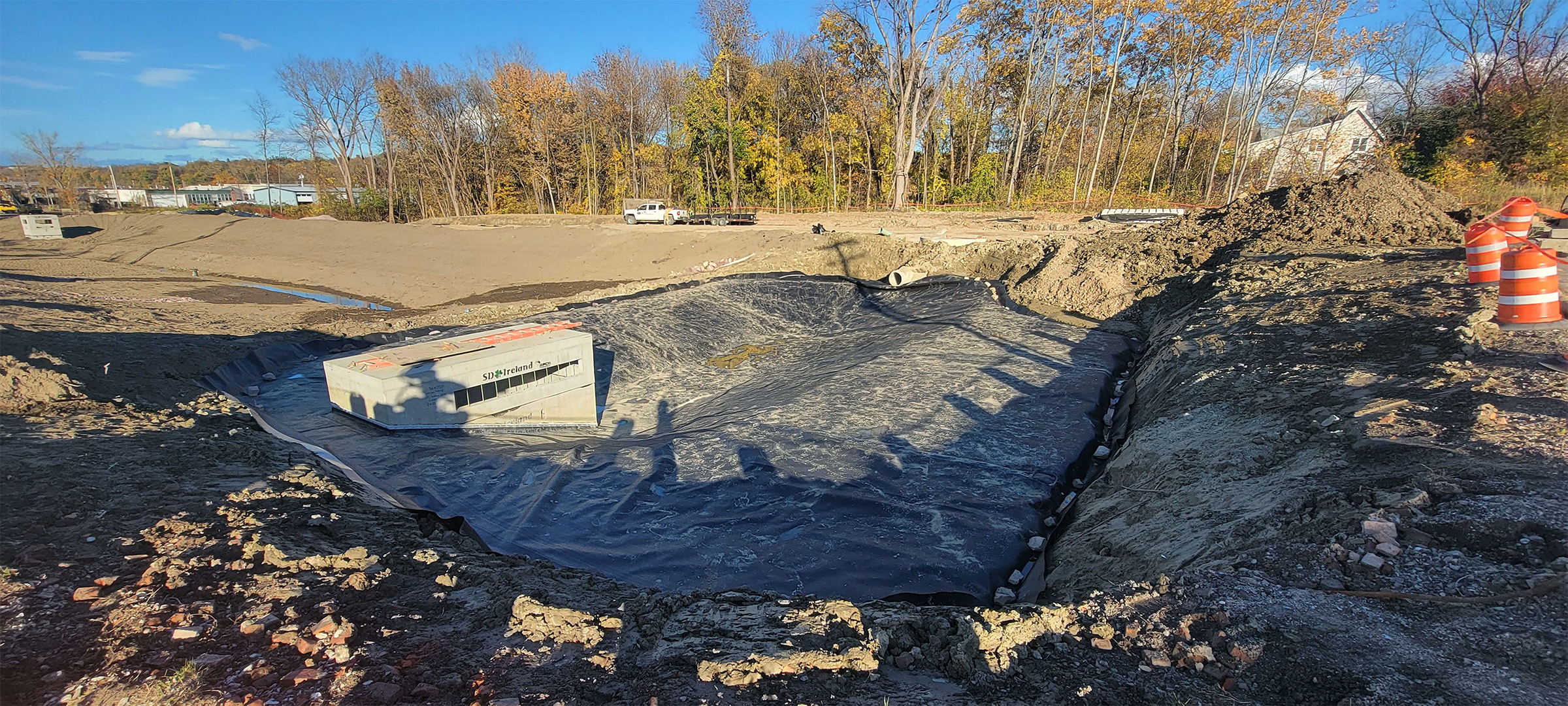

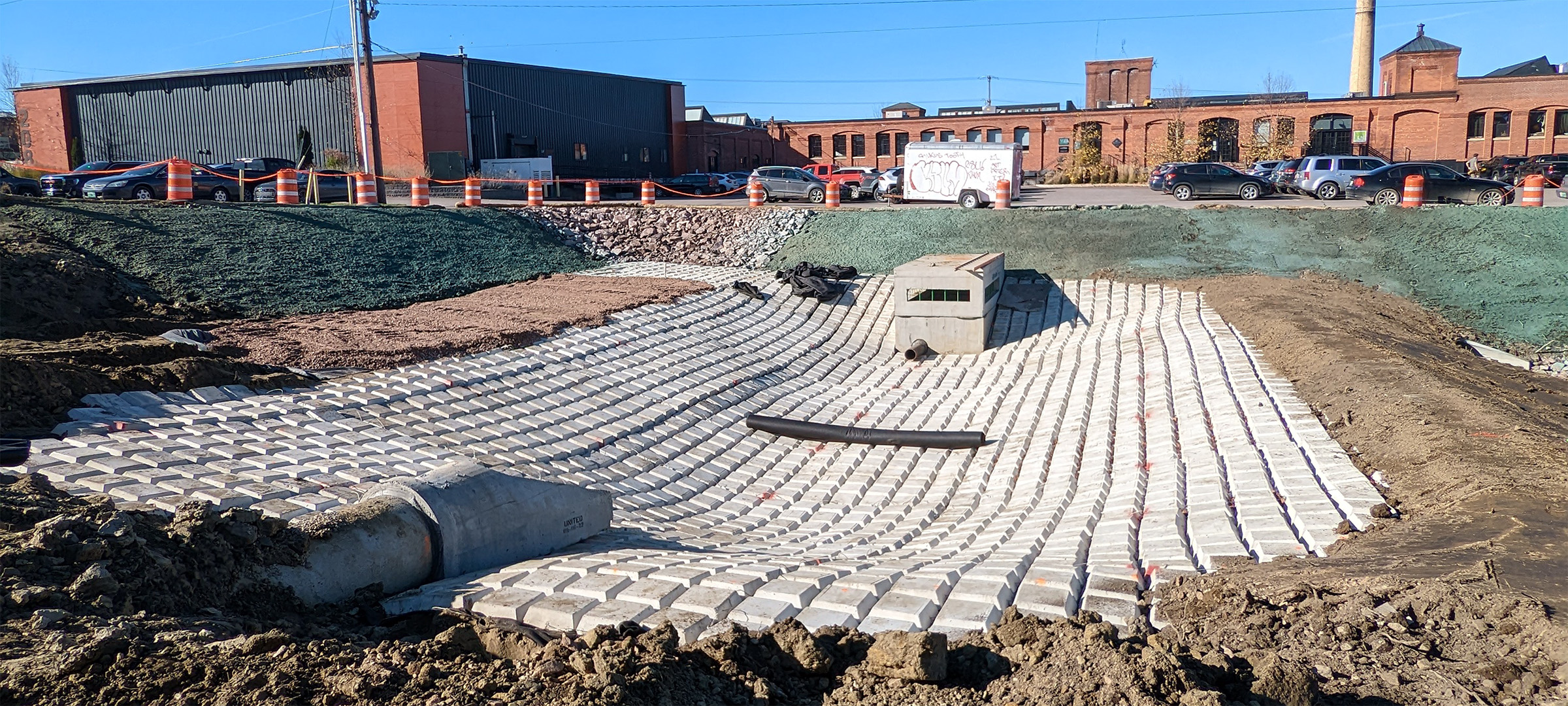

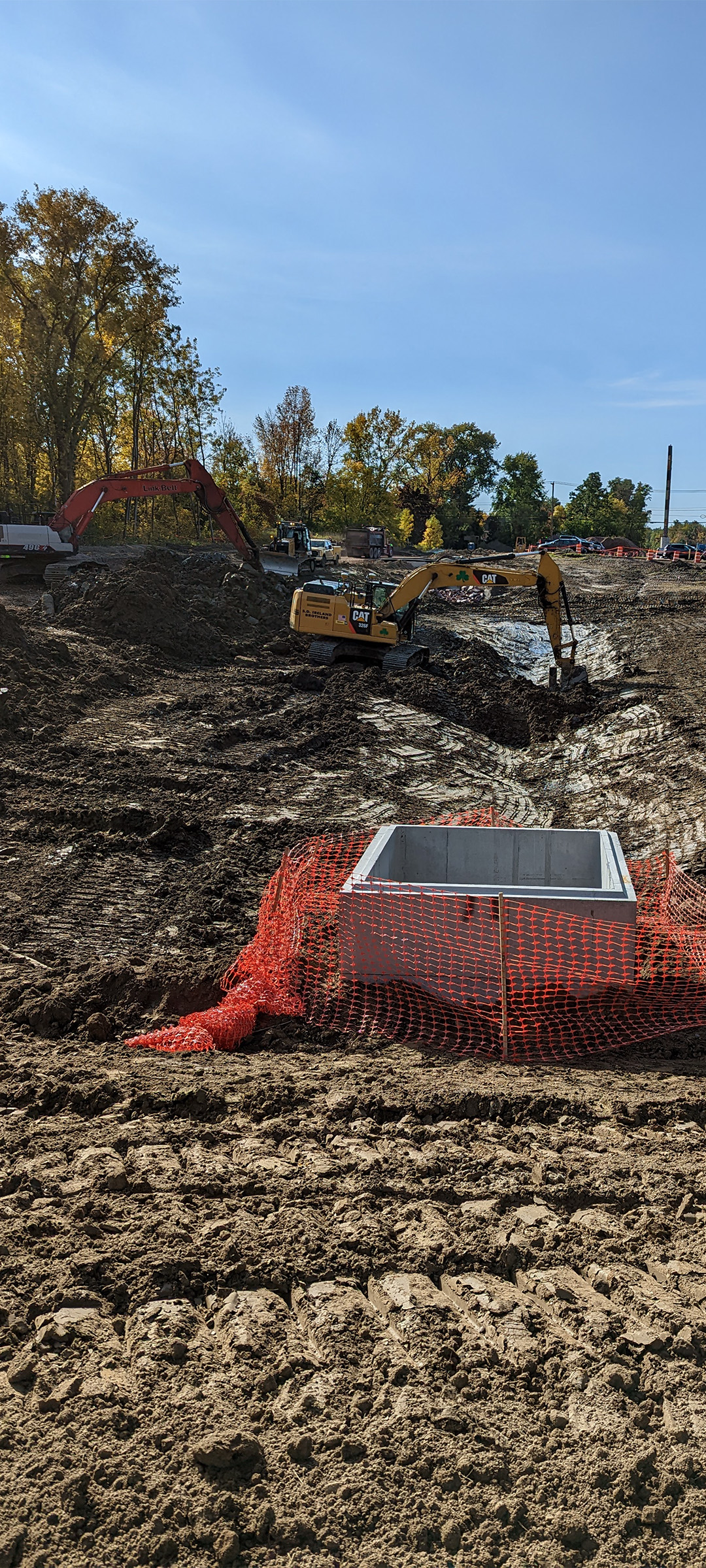

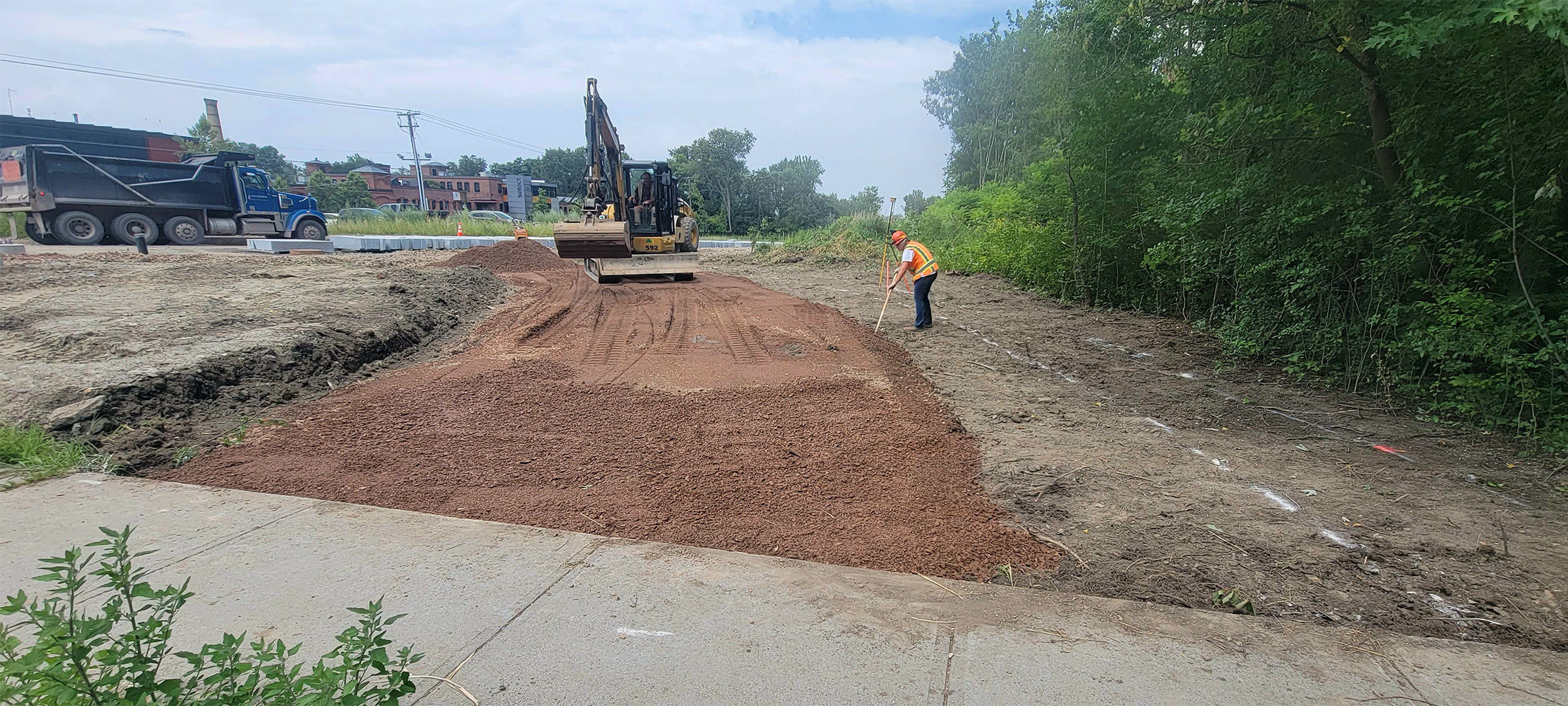

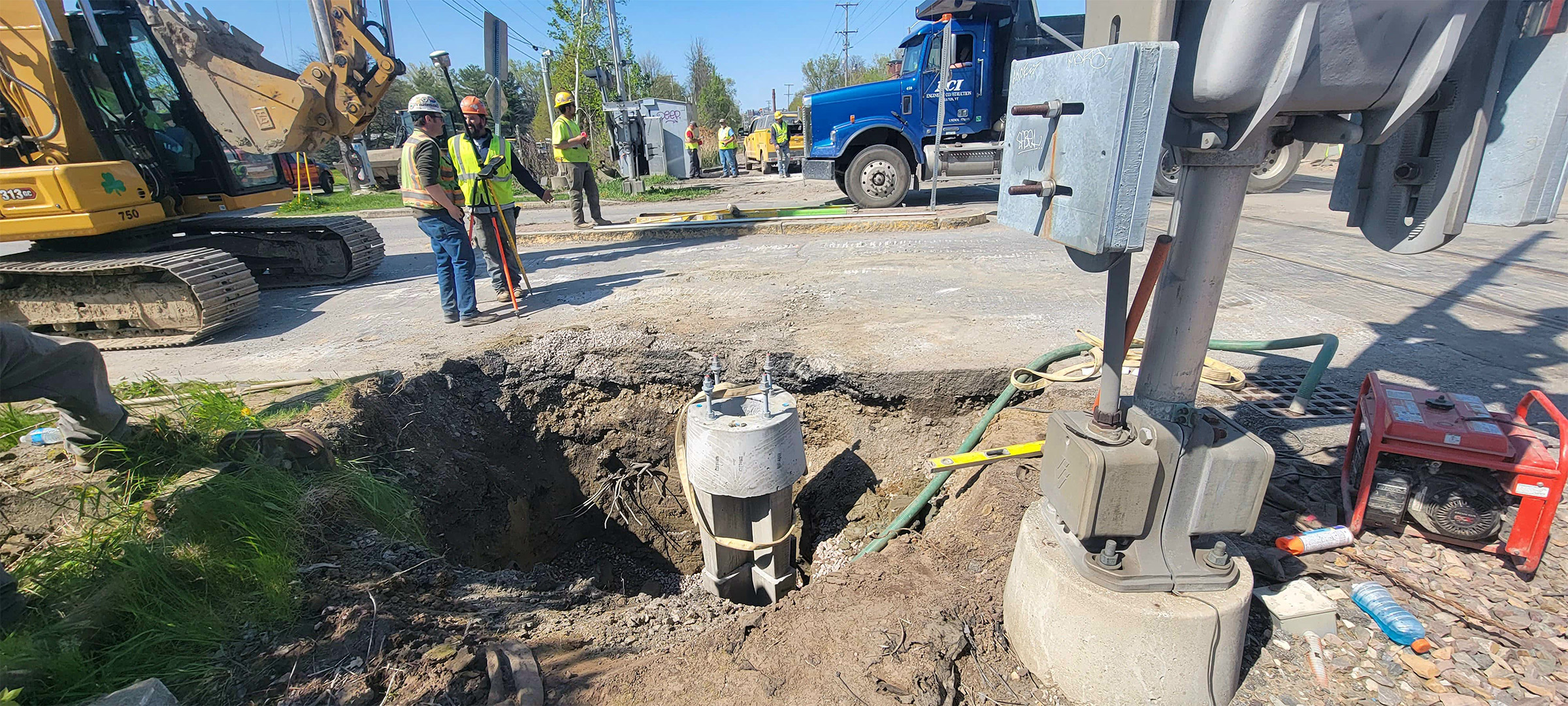

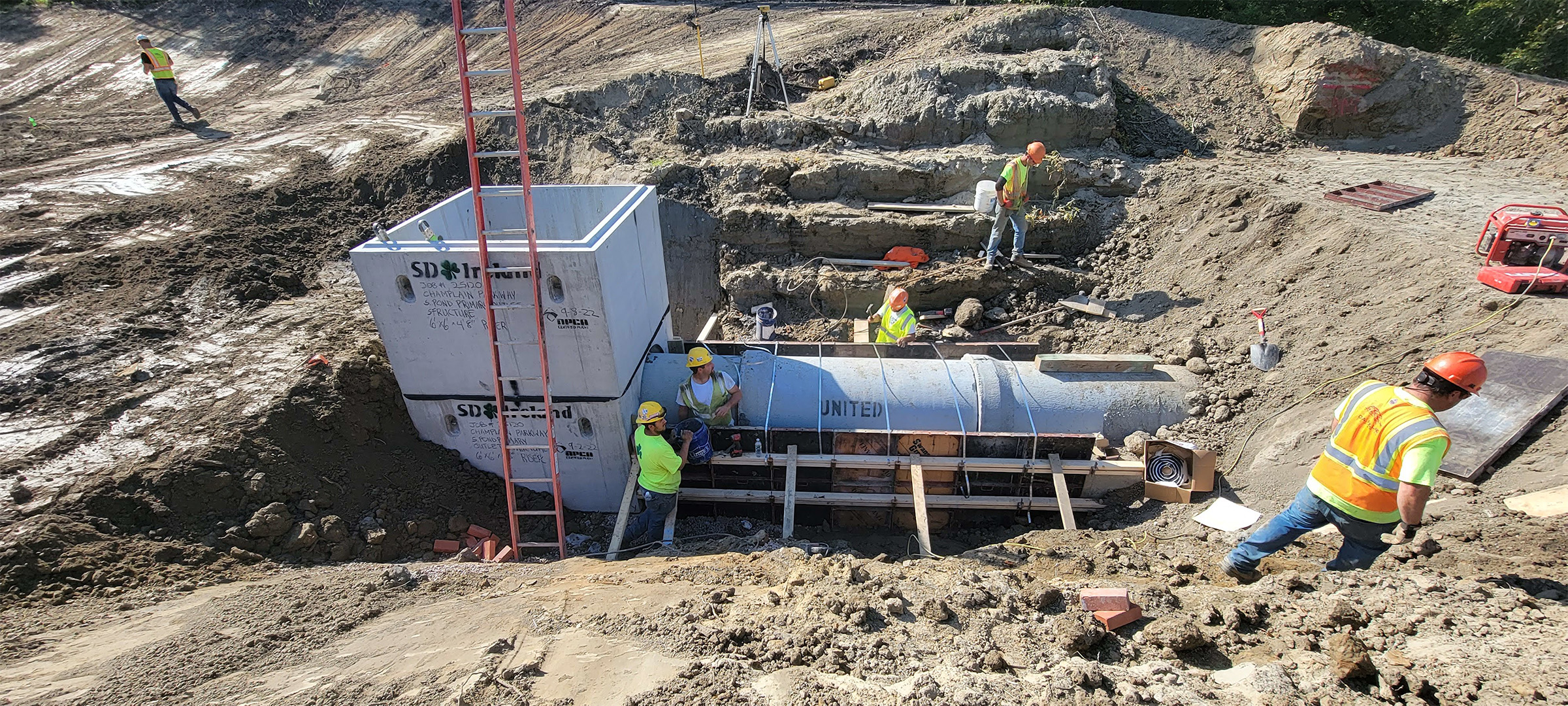

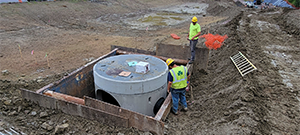

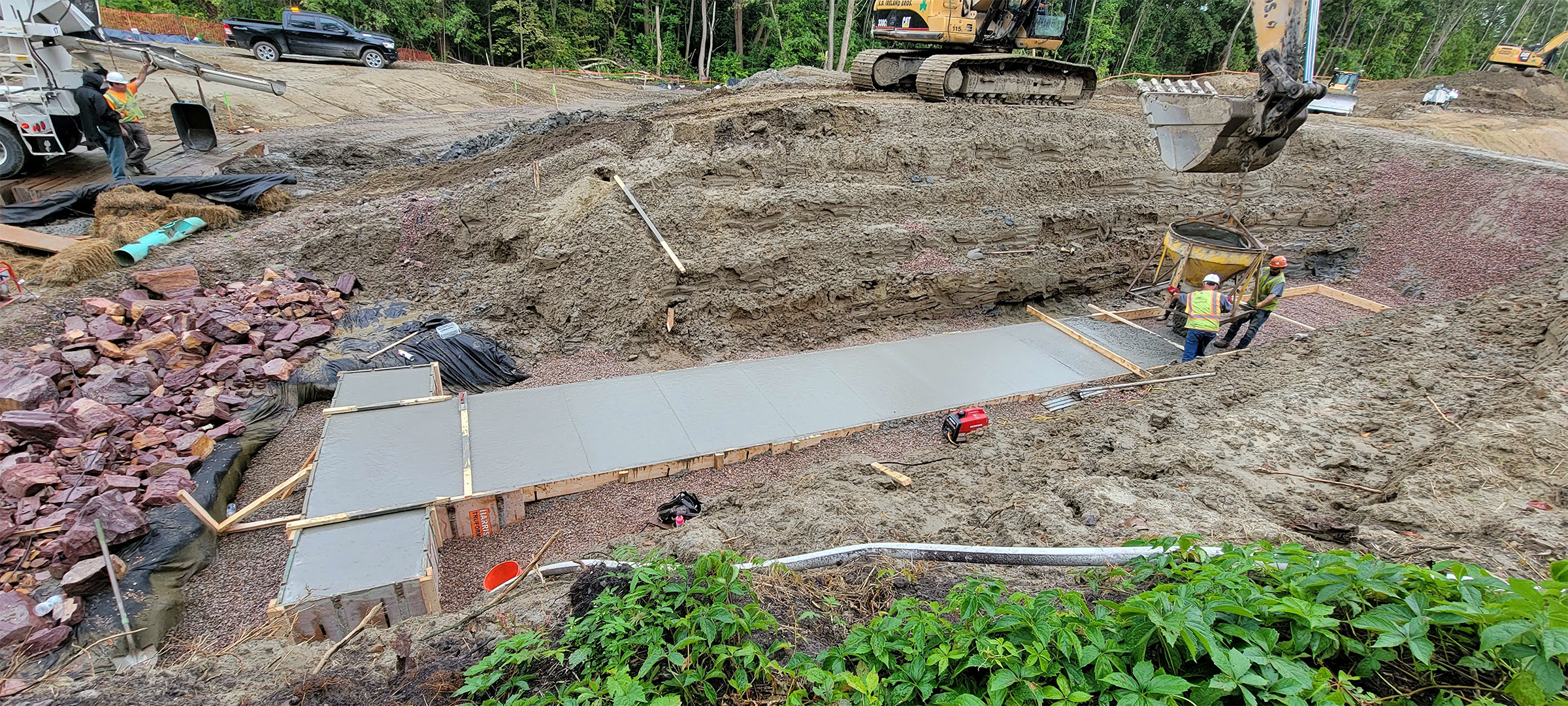

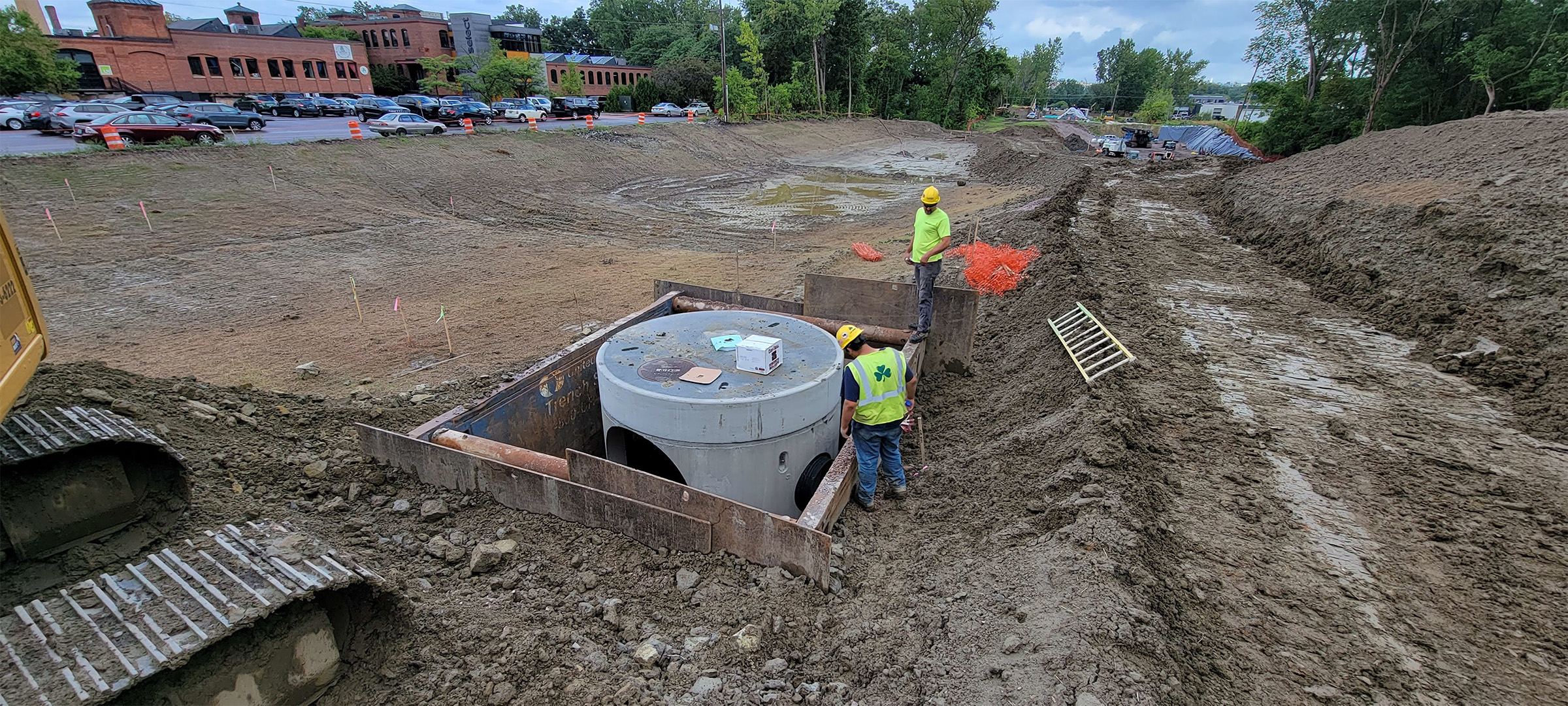

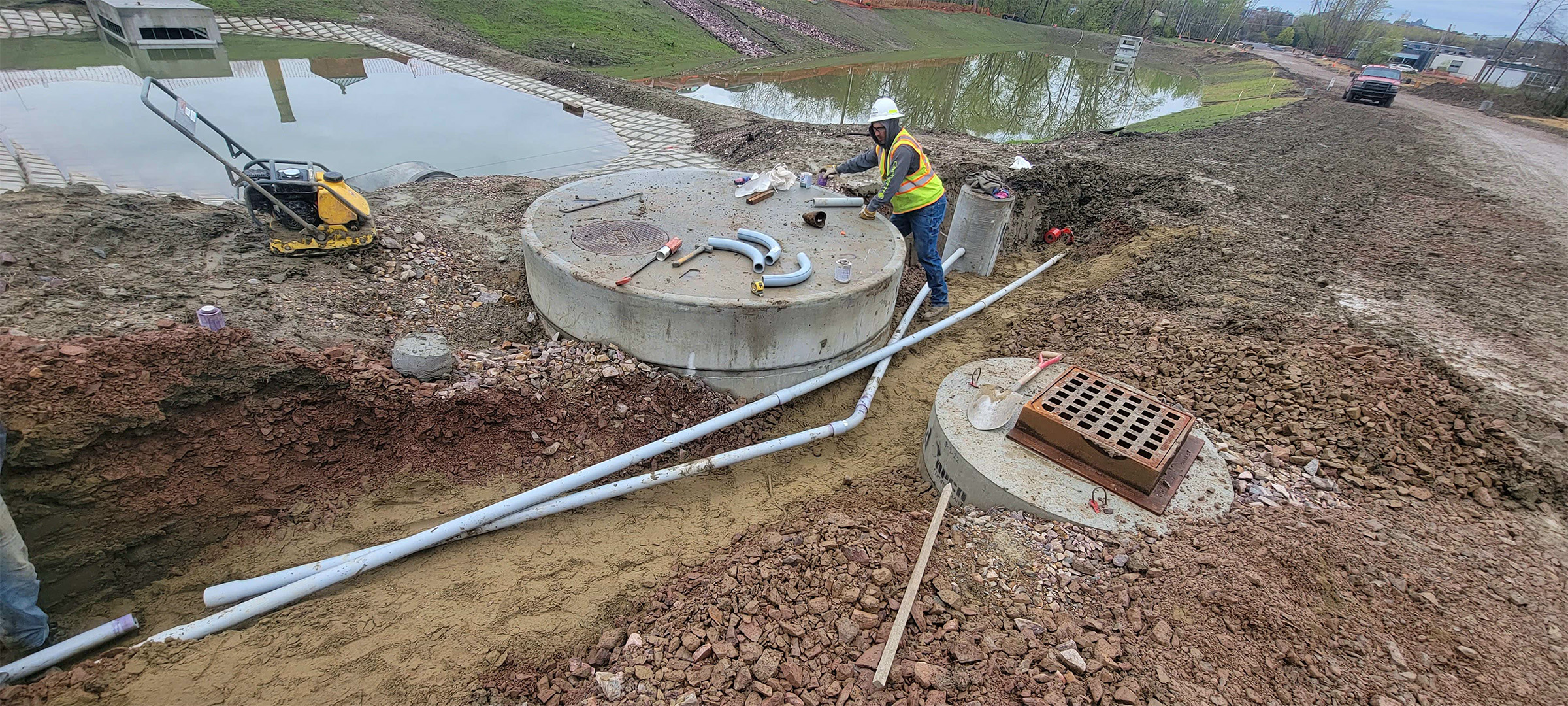

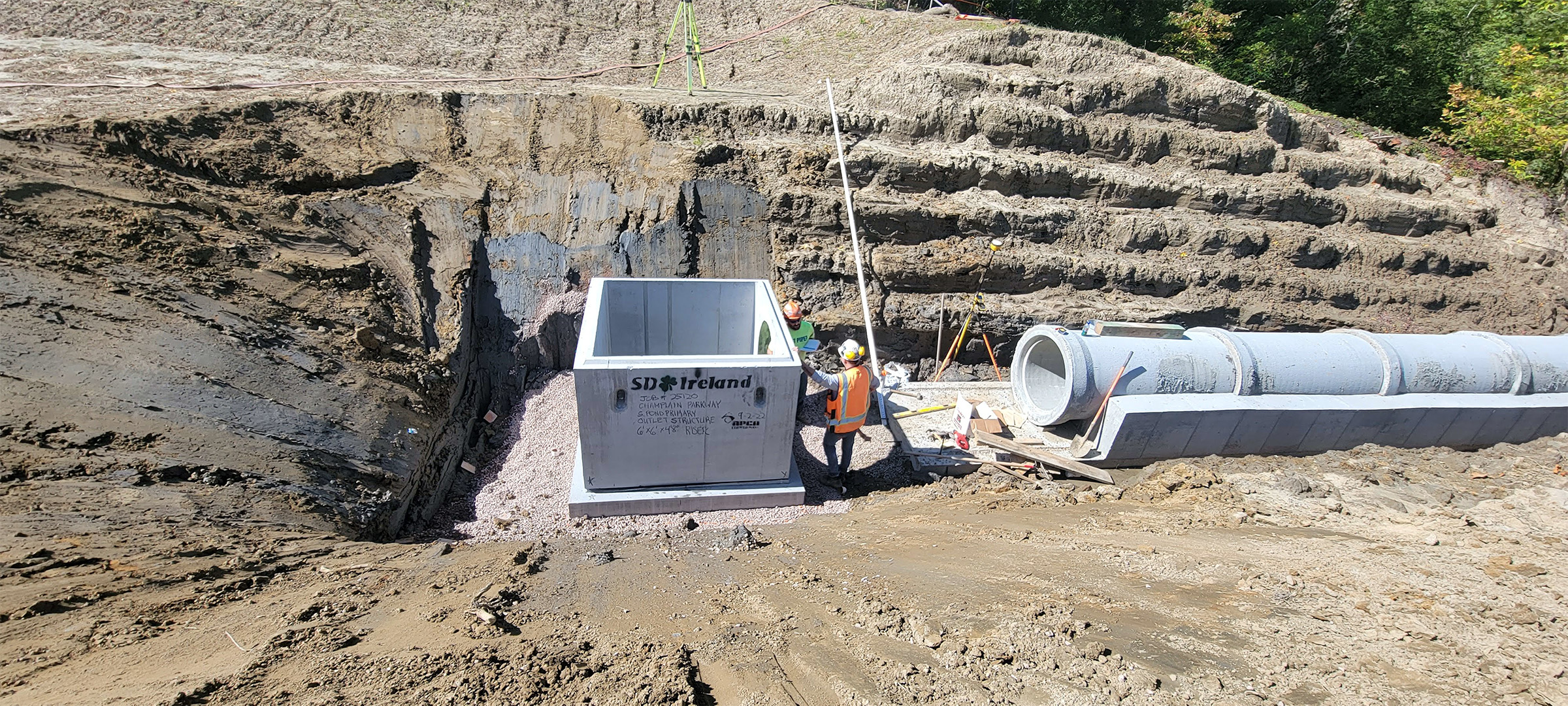

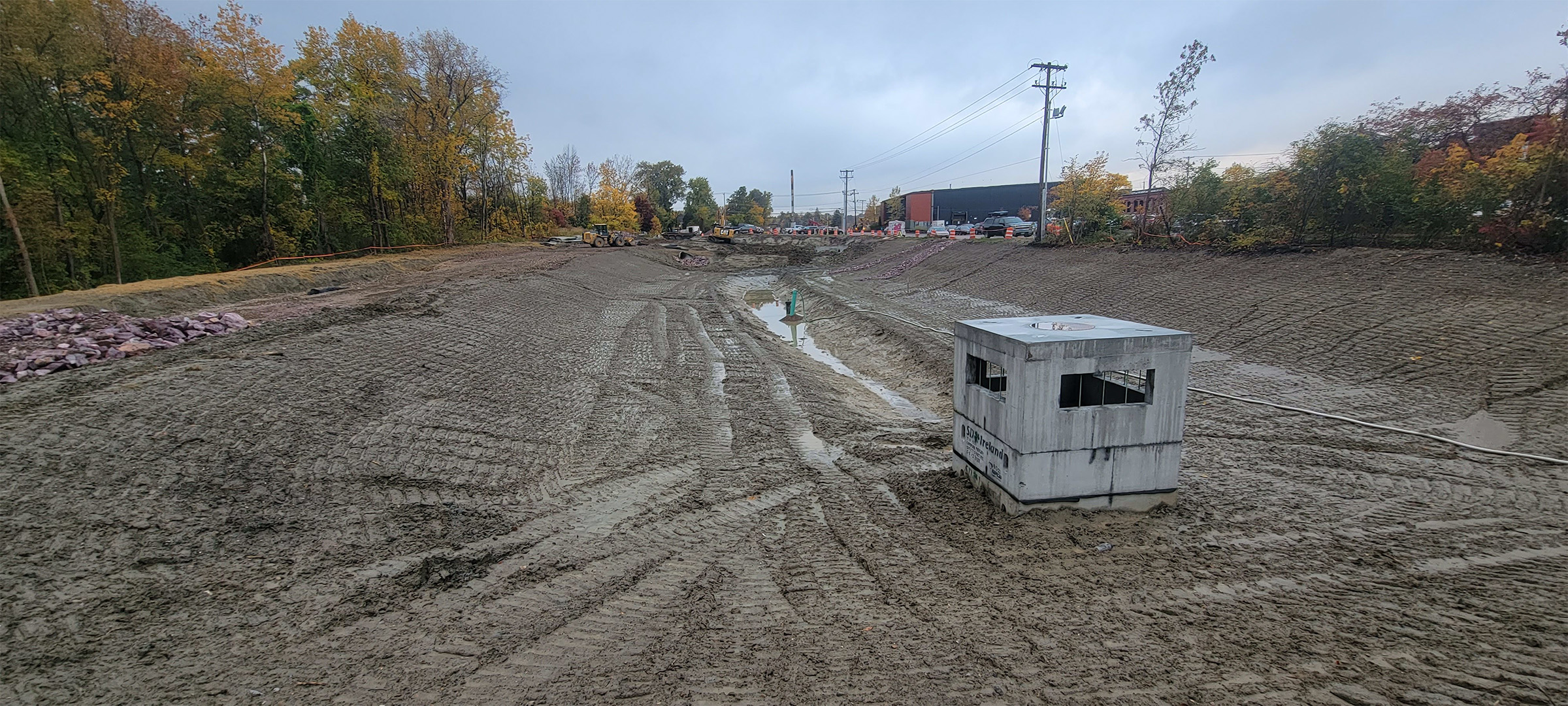

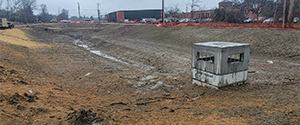

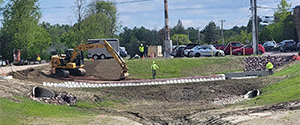

Crews install all the structures within the Englesby detention pond prior to grass and aquatic plant establishment.

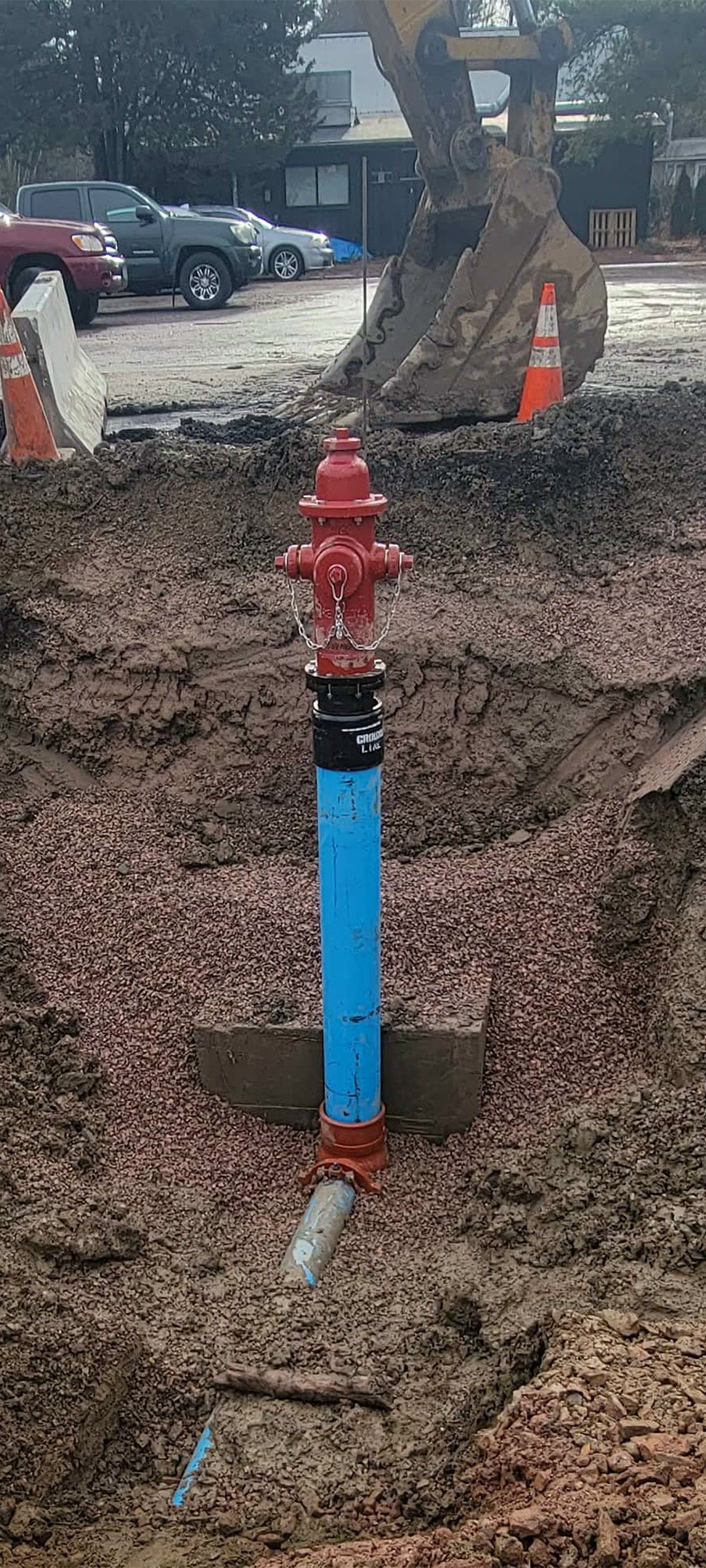

Installation of a new fire hydrant at the end of Briggs Street next to the cul-de-sac.

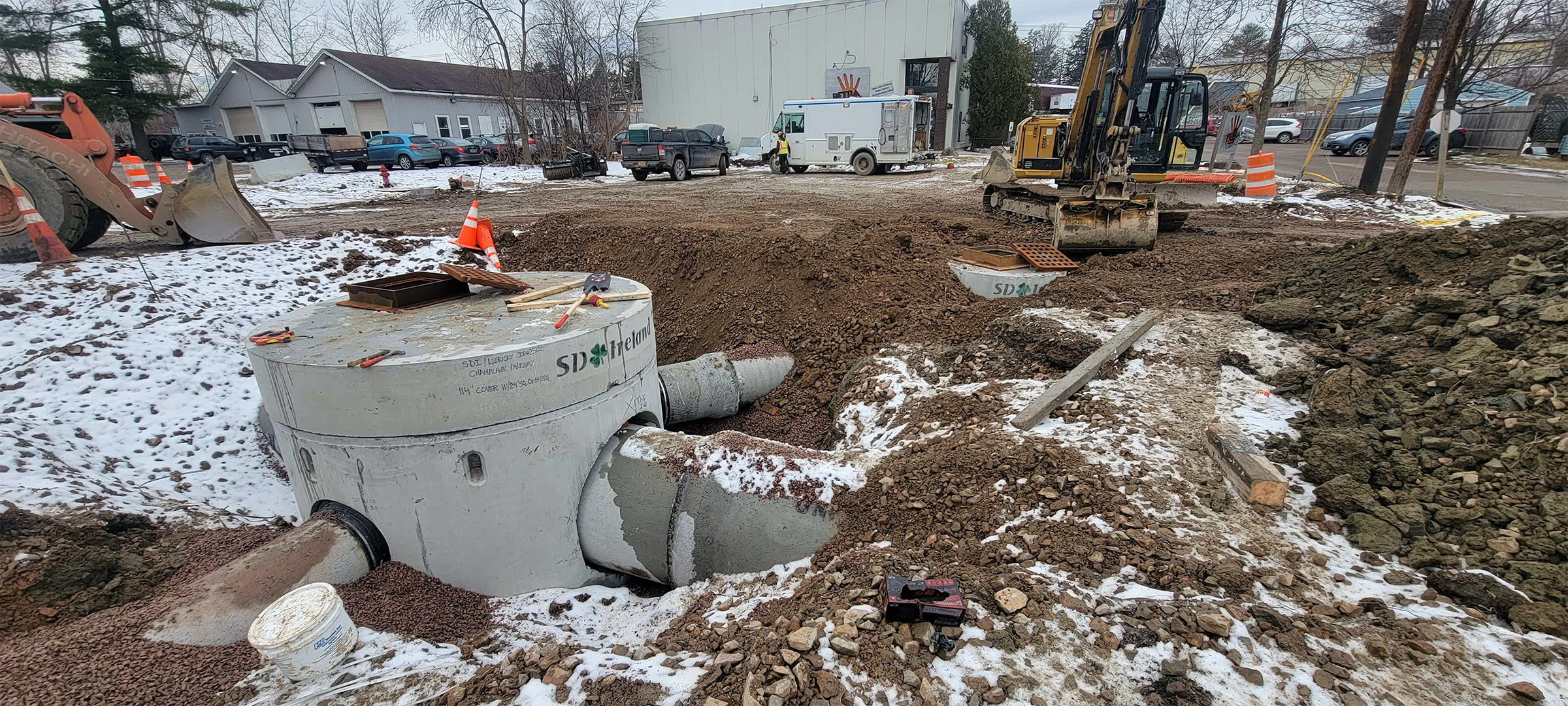

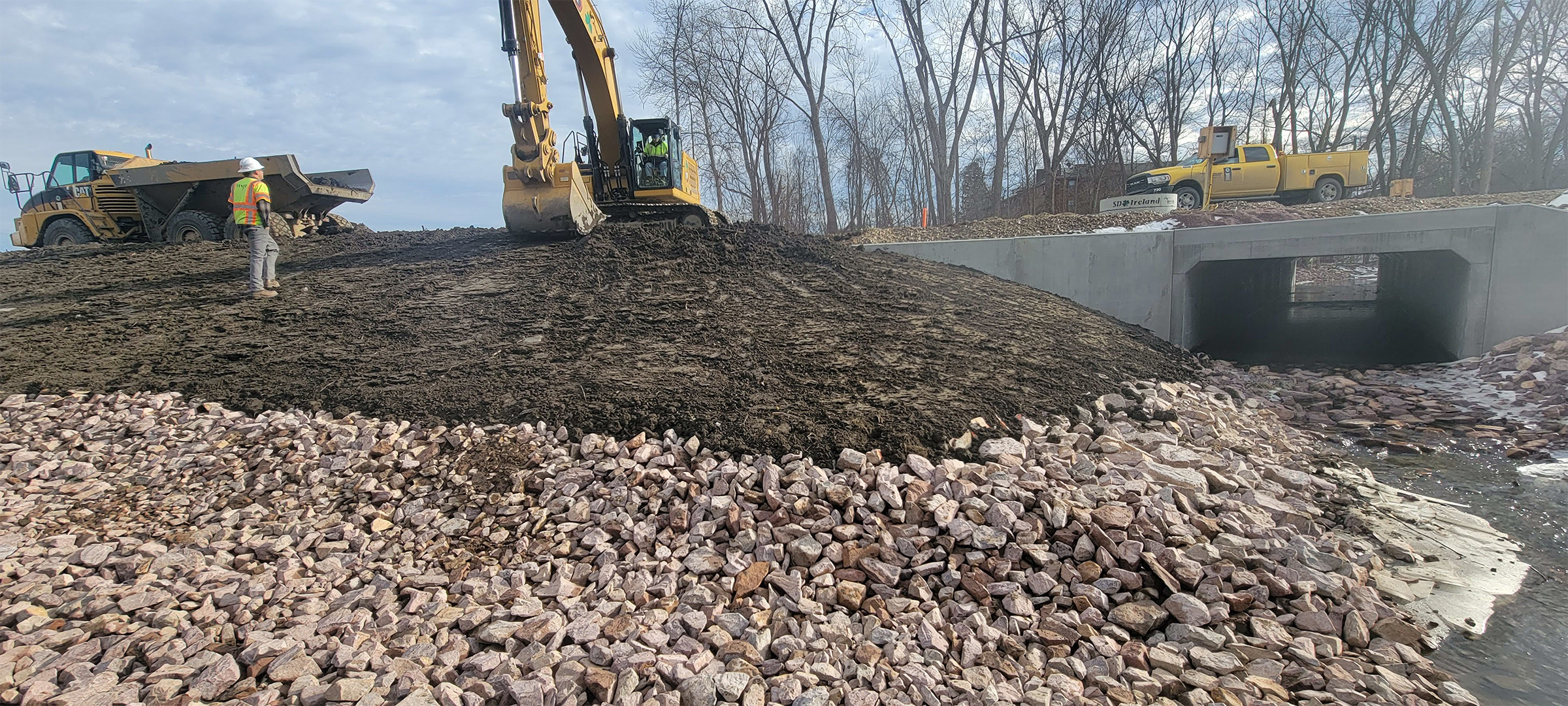

Installation of drainage structure for the Parkway and the grass swale near the Briggs Street cul-de-sac.

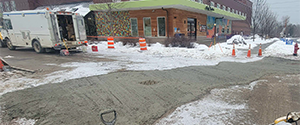

Temporarily patching the roadway surface on Briggs Street during winter drainage work.

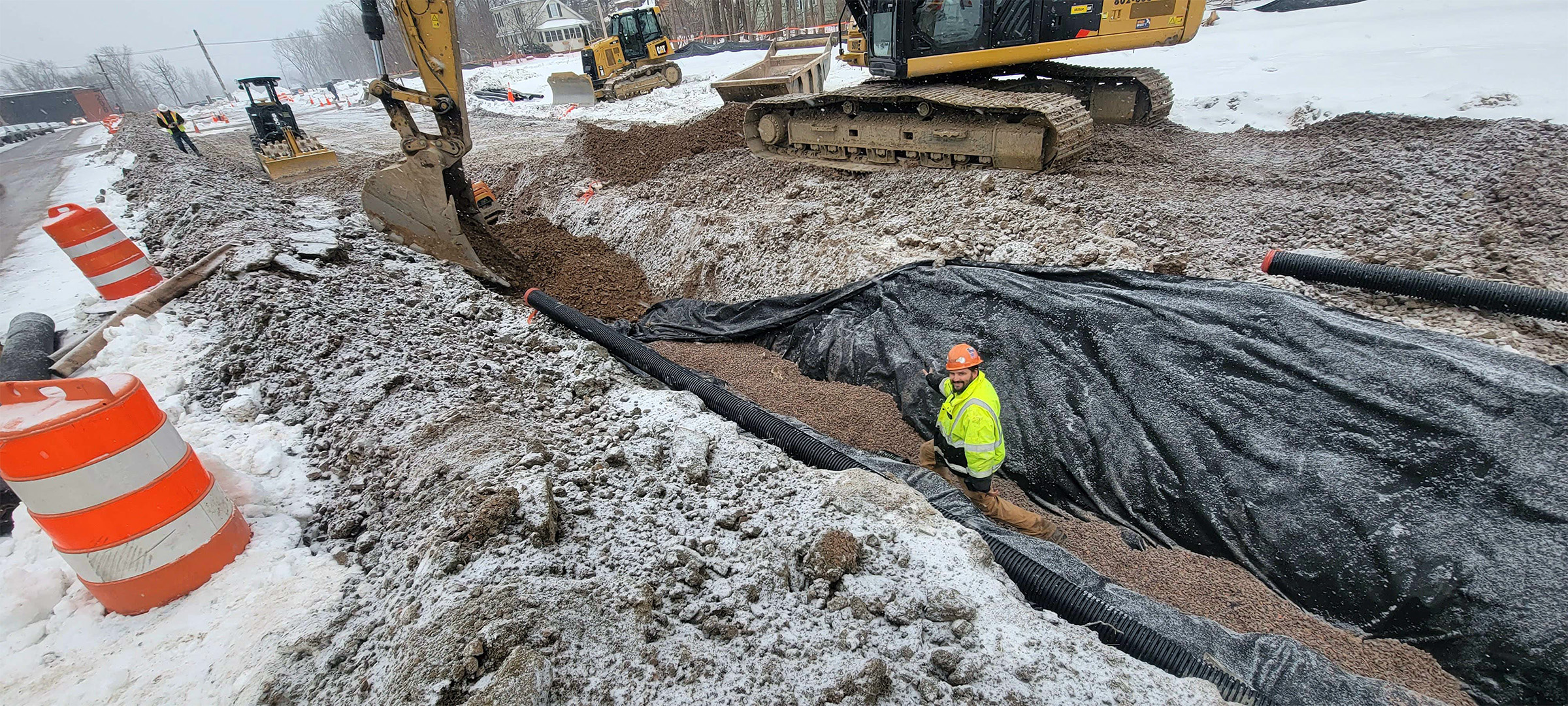

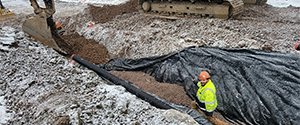

Installation of the six-inch underdrain along the Parkway between Ferguson Avenue and Lyman Avenue.

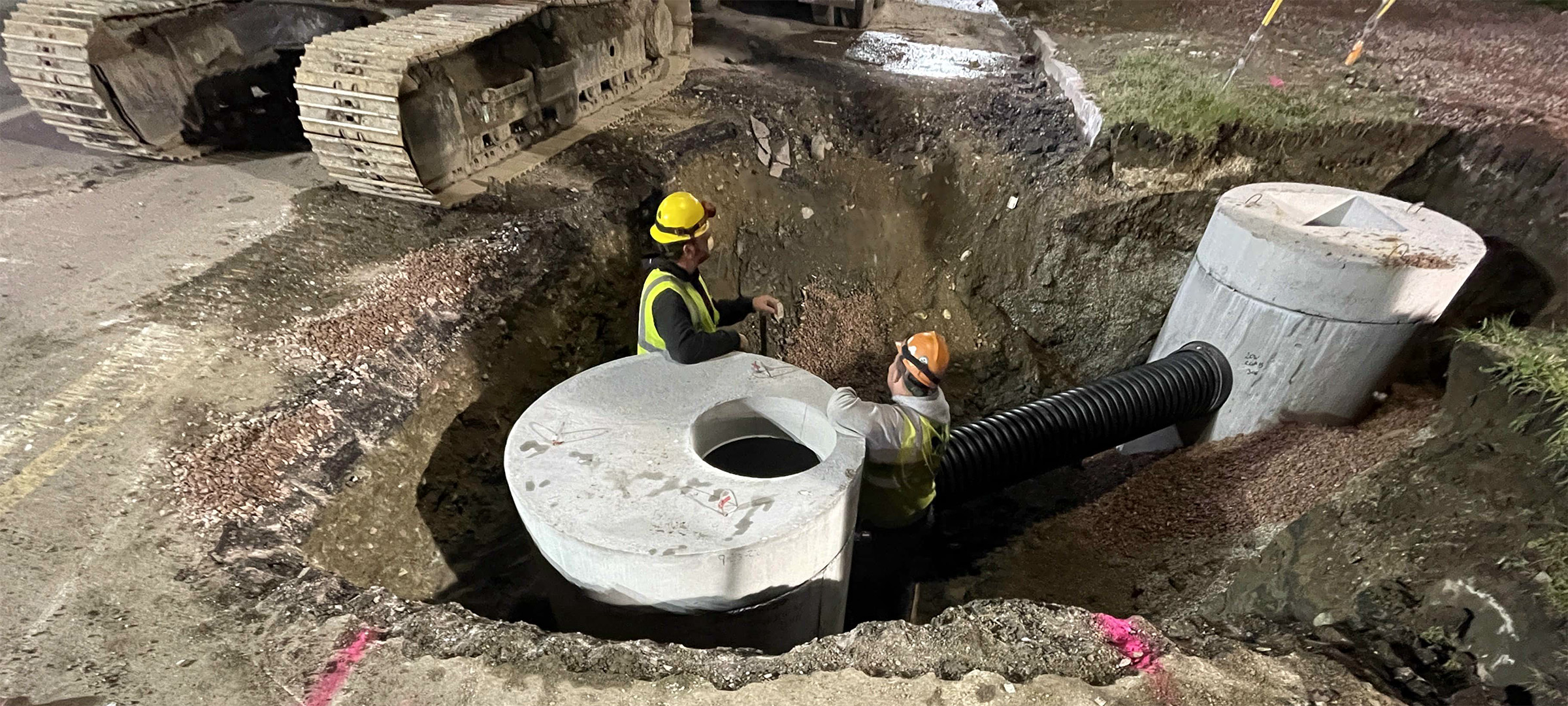

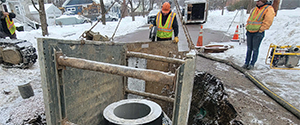

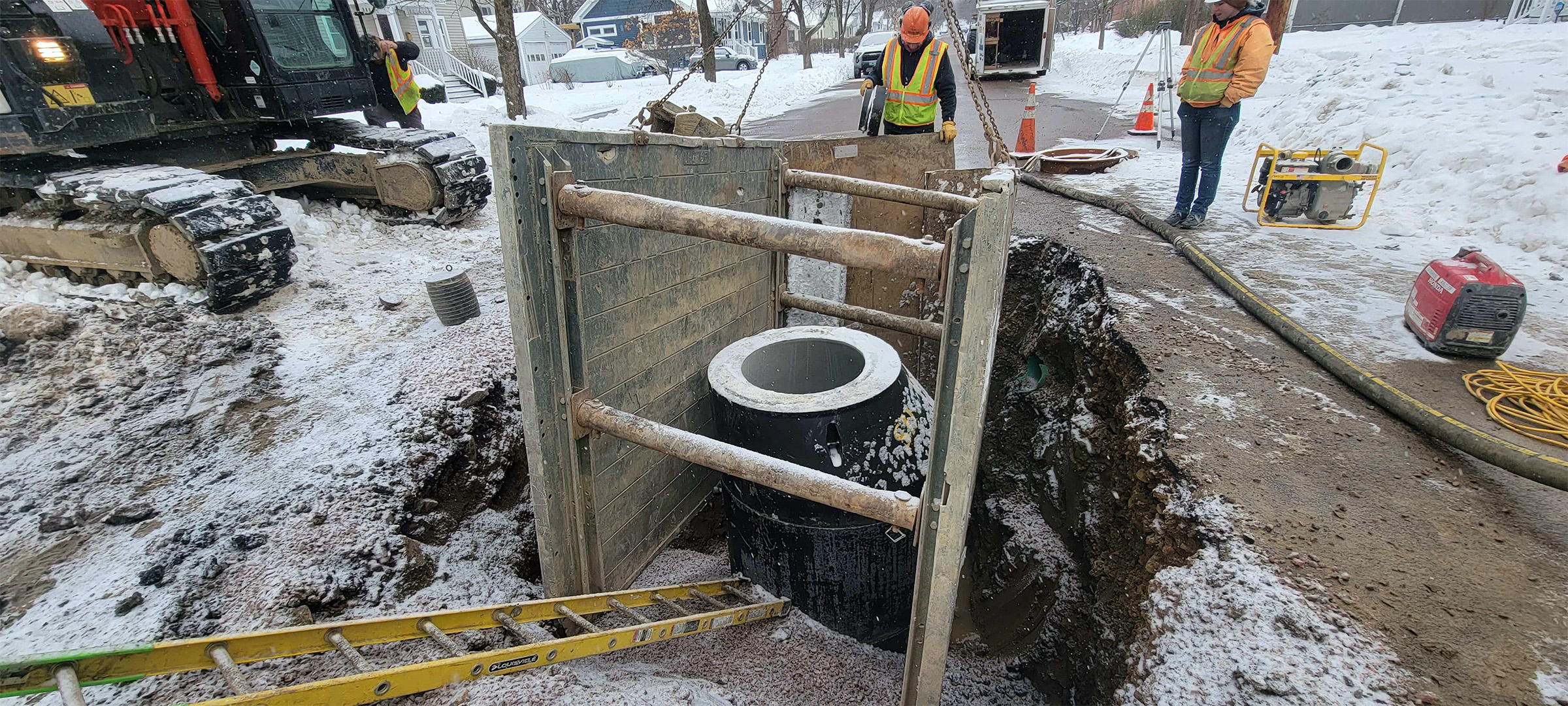

Sewer manhole installation along Lyman Avenue.

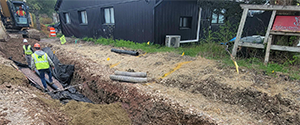

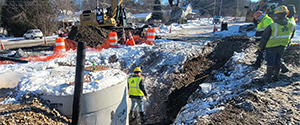

Installation of the six-inch underdrain along the Parkway between Morse Place and Home Avenue.

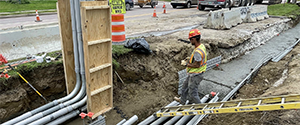

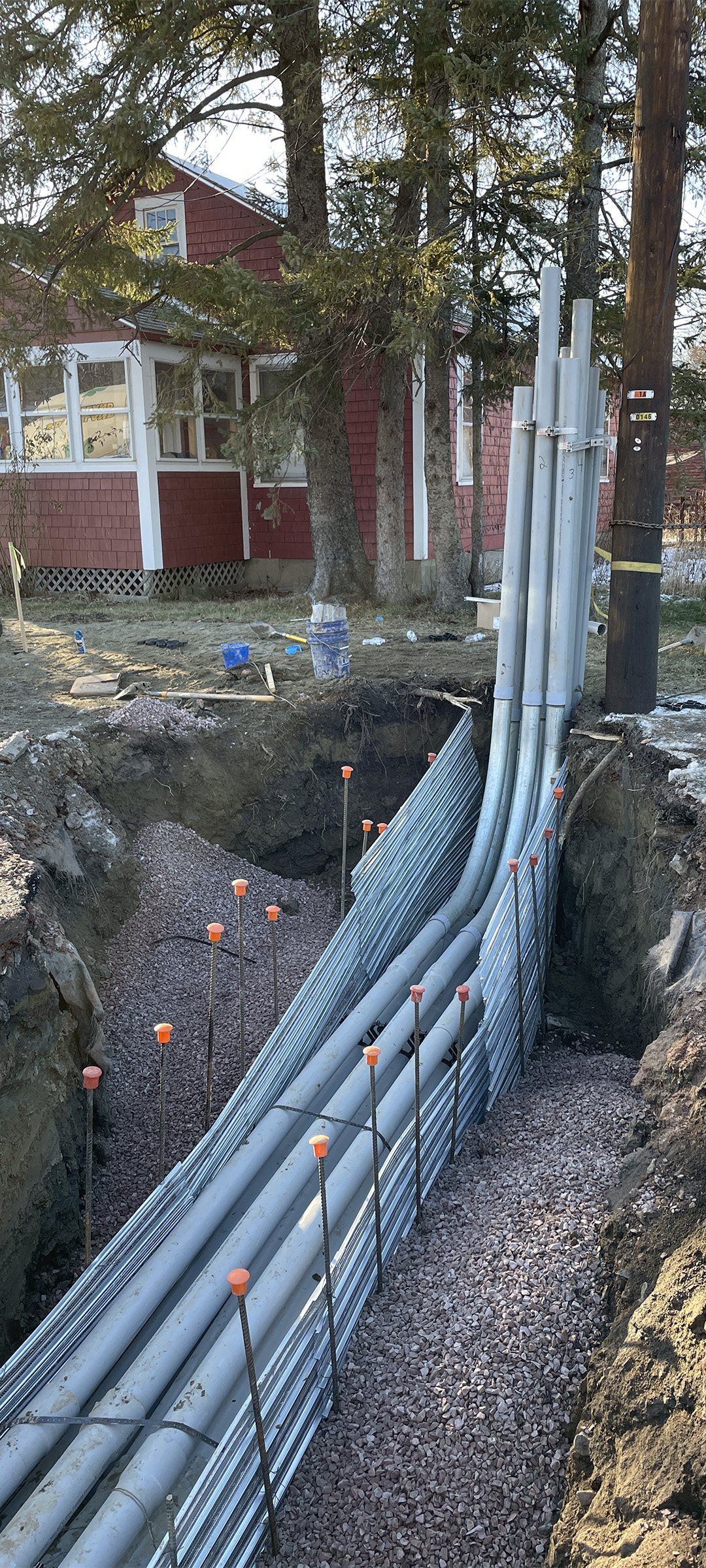

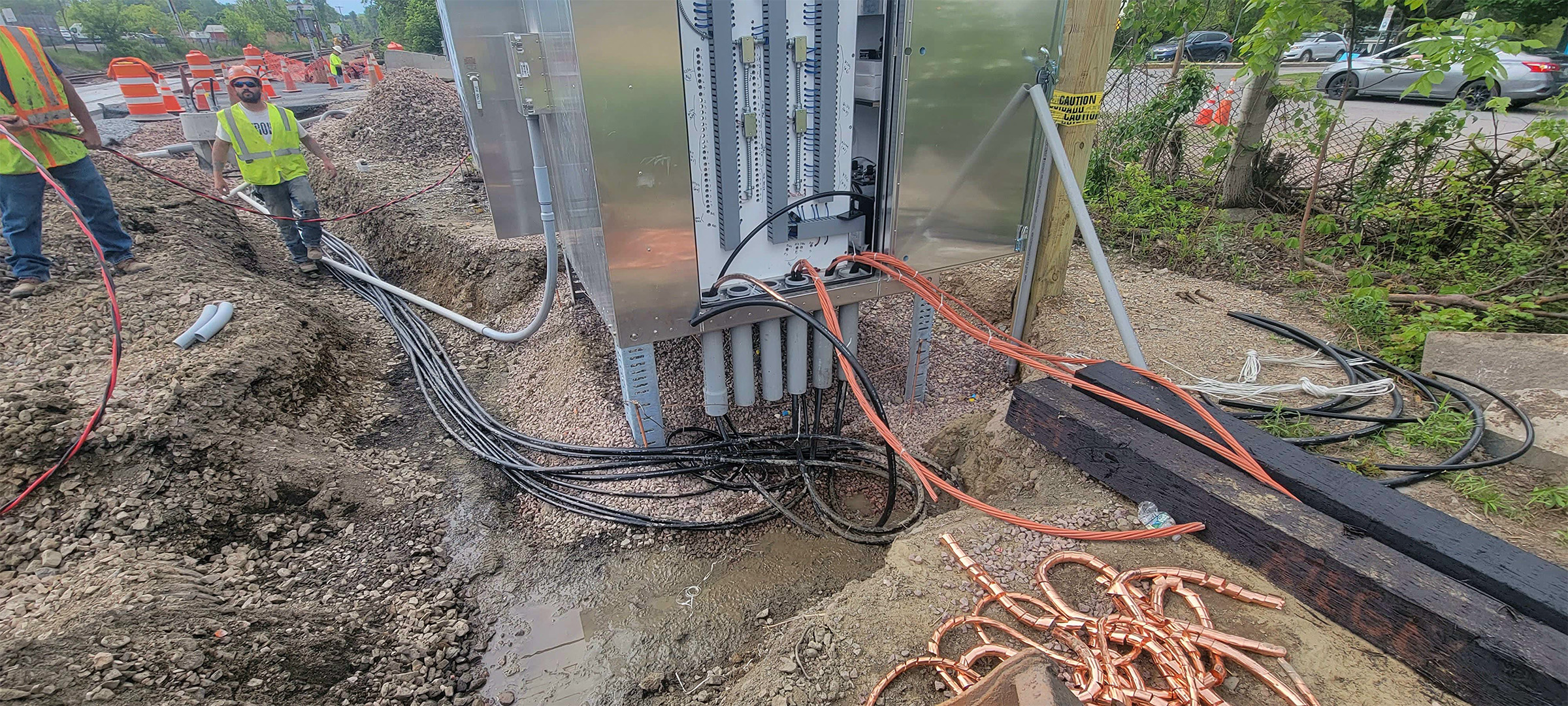

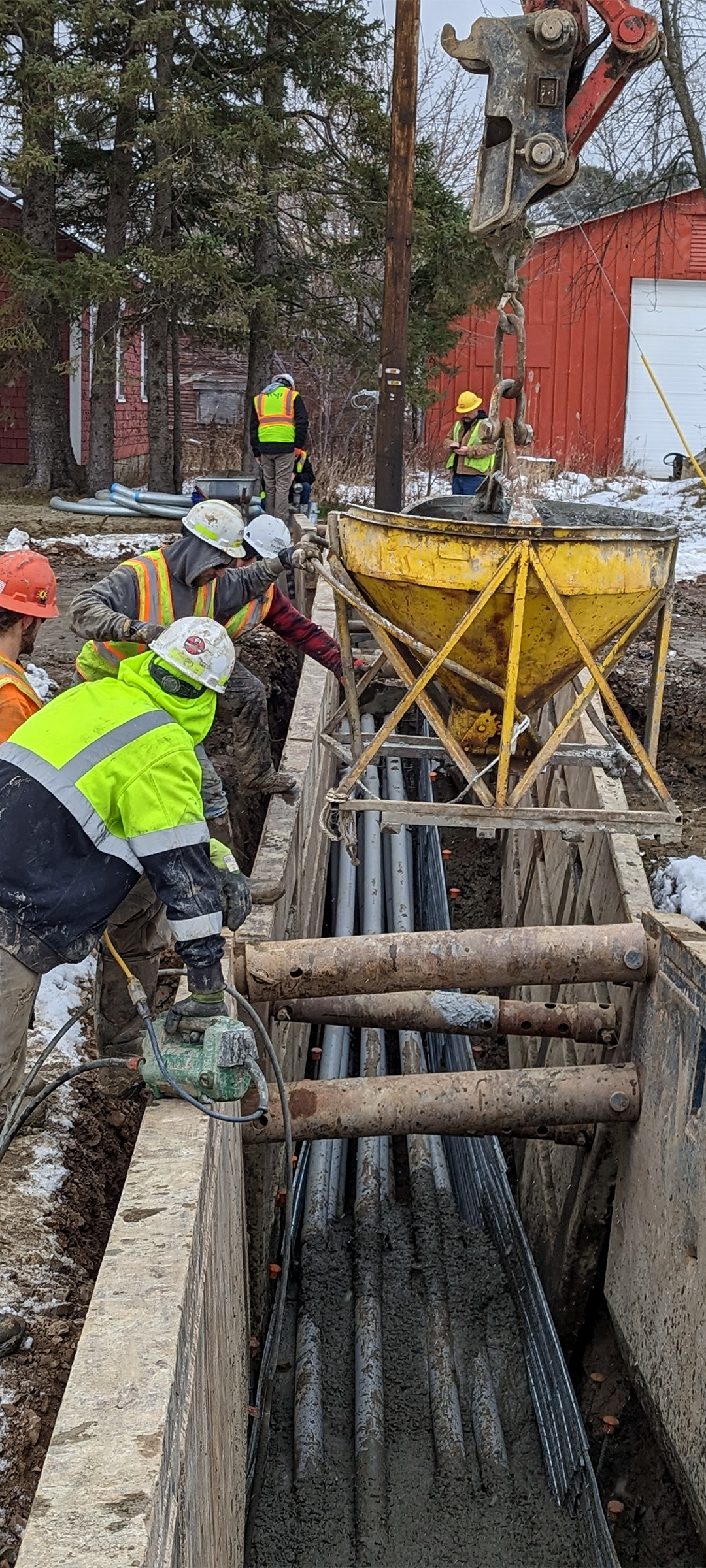

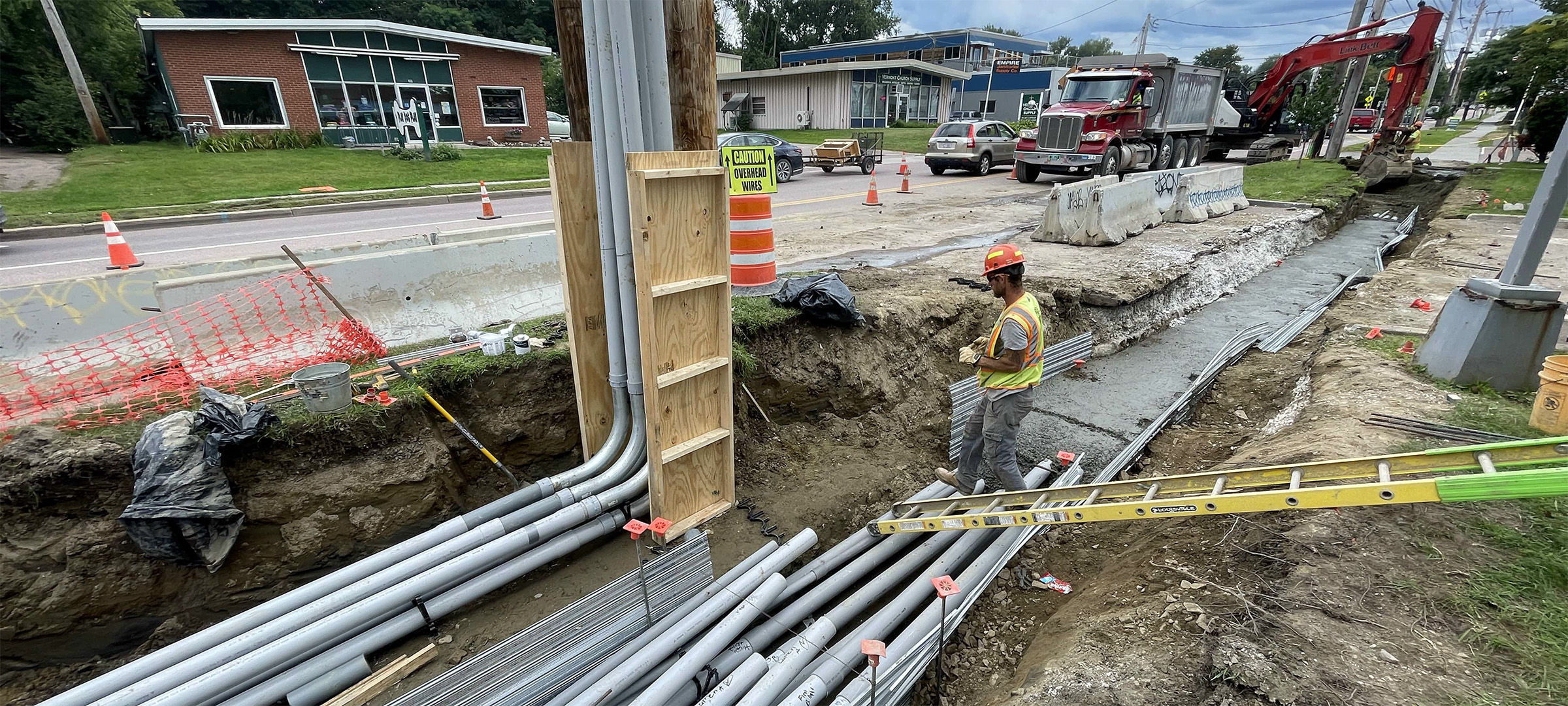

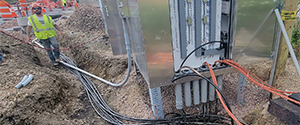

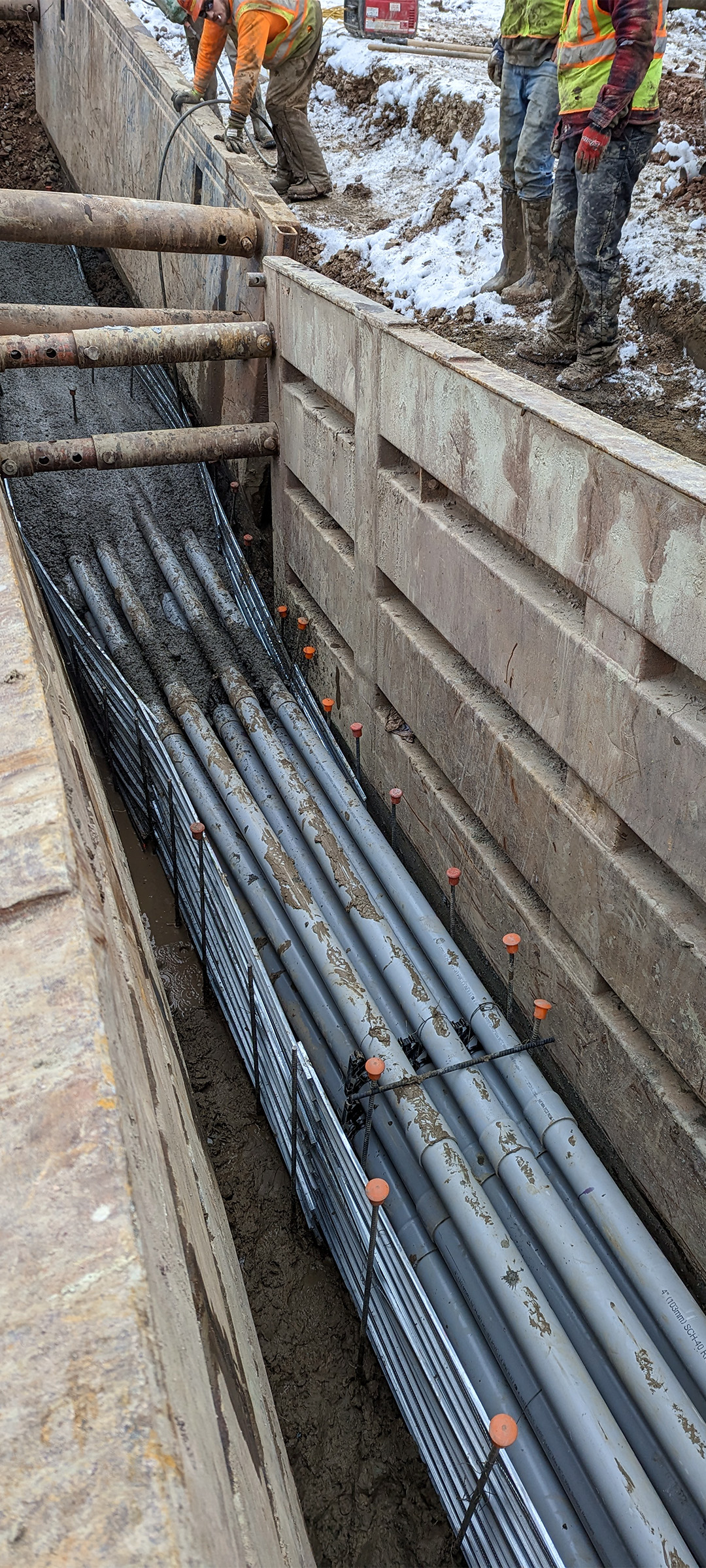

Burlington Electric feeding electrical cables through the underground utility duct banks crossing beneath the Parkway and Briggs Street.

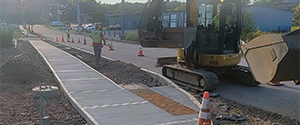

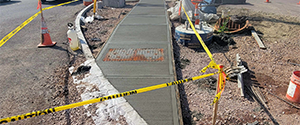

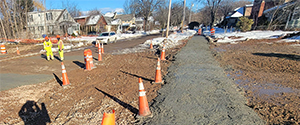

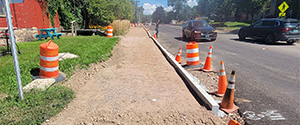

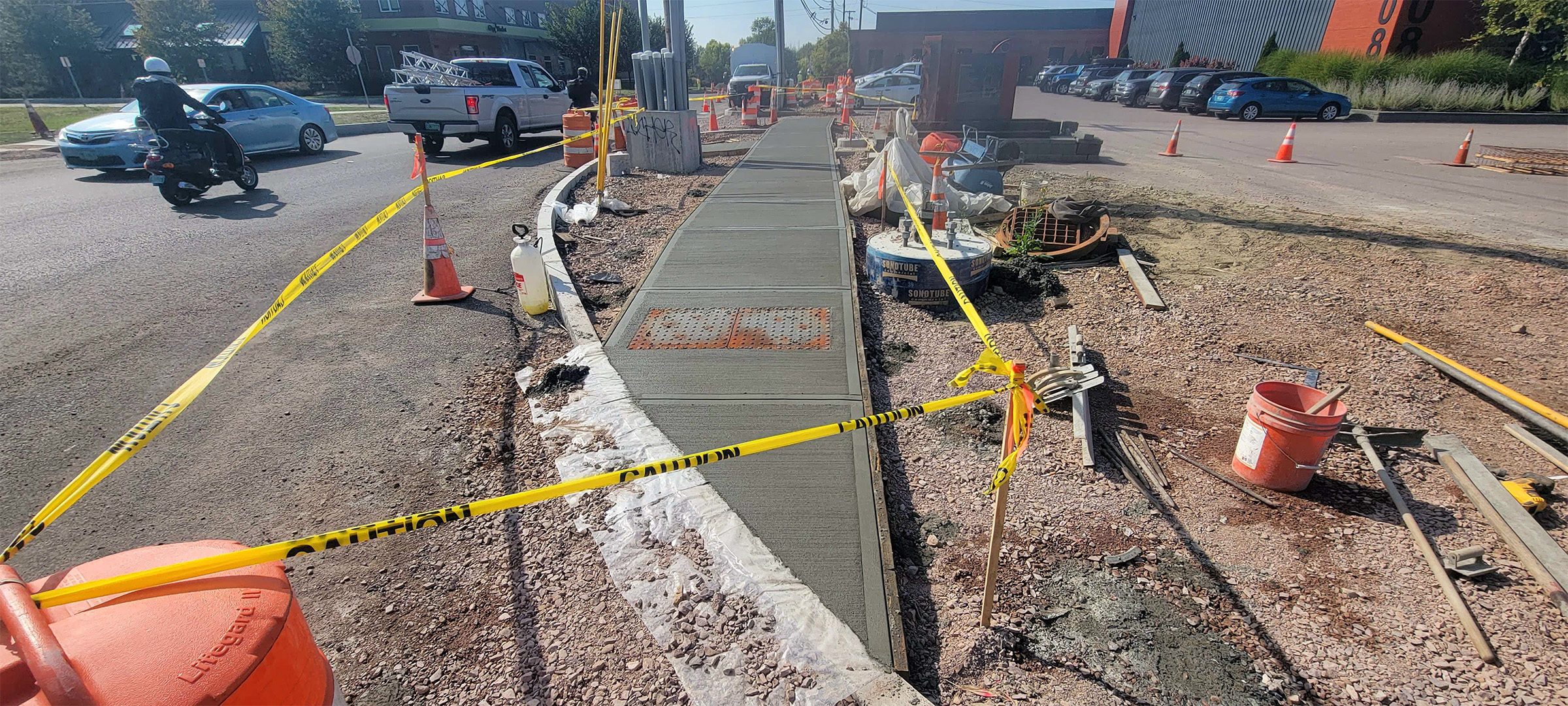

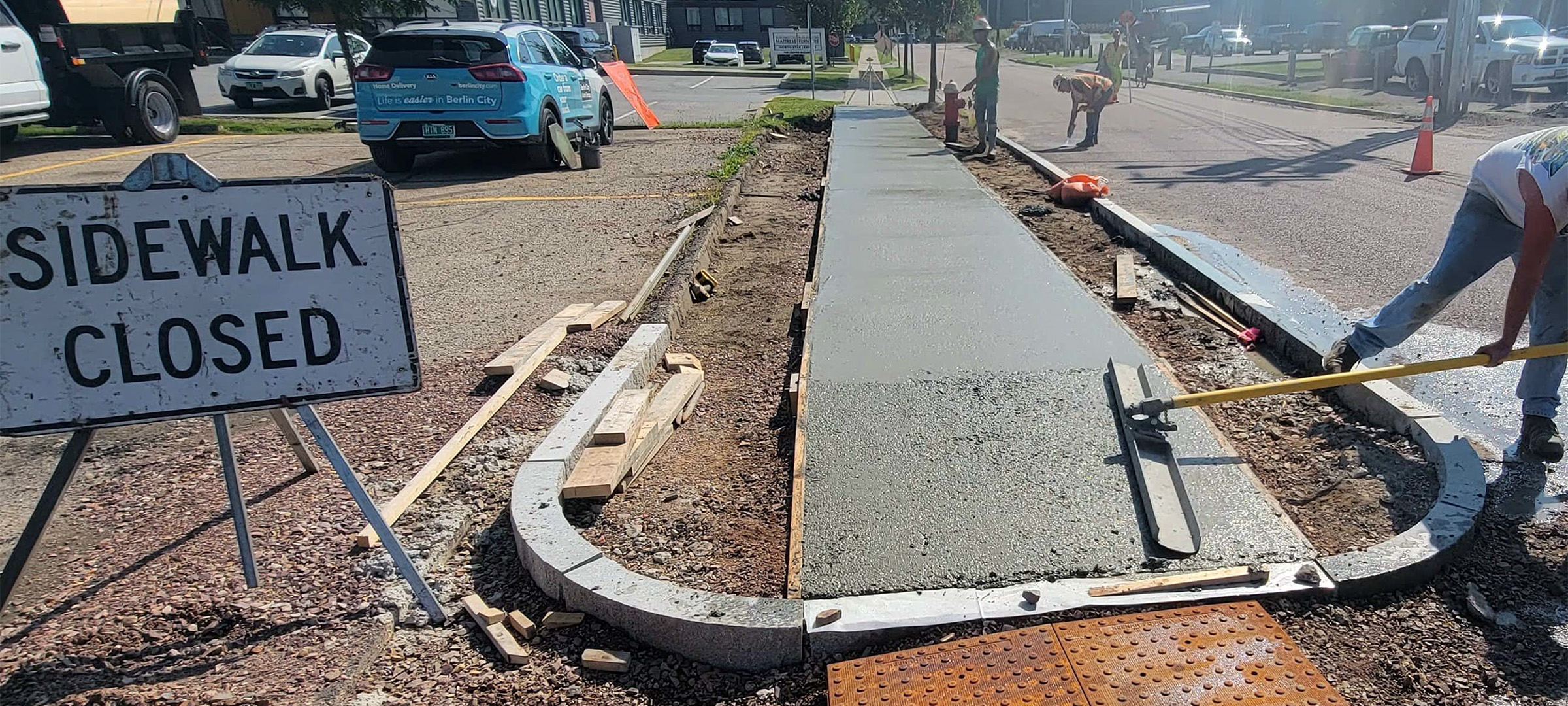

Temporary concrete sidewalk constructed across the Parkway between Ferguson Avenue and Briggs Street to maintain pedestrian access during the winter months.

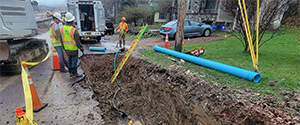

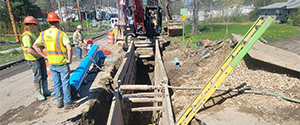

Completing the remaining waterline installation at the southern end of Batchelder Street, which ultimately ties into the waterline at Home Avenue.

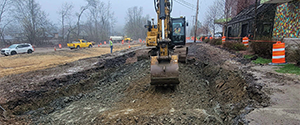

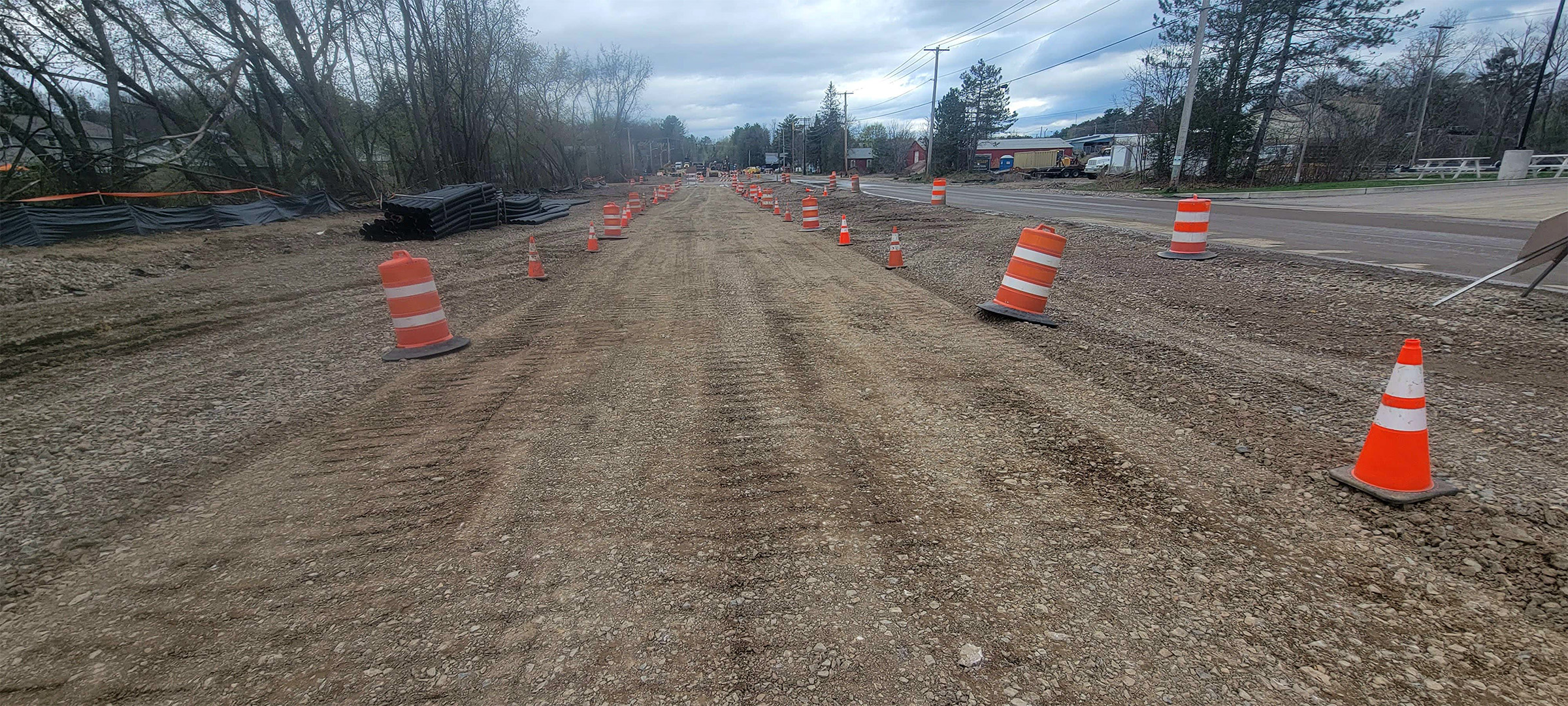

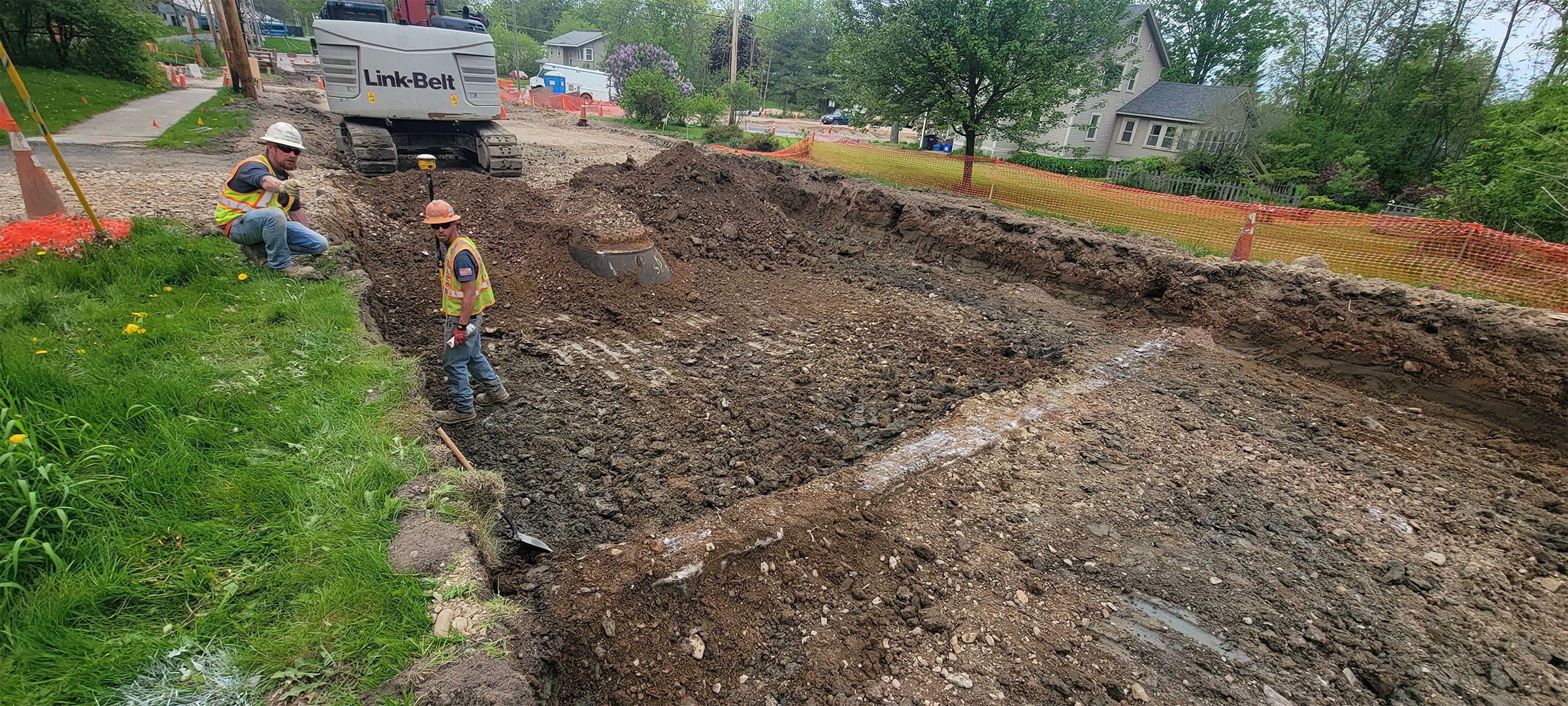

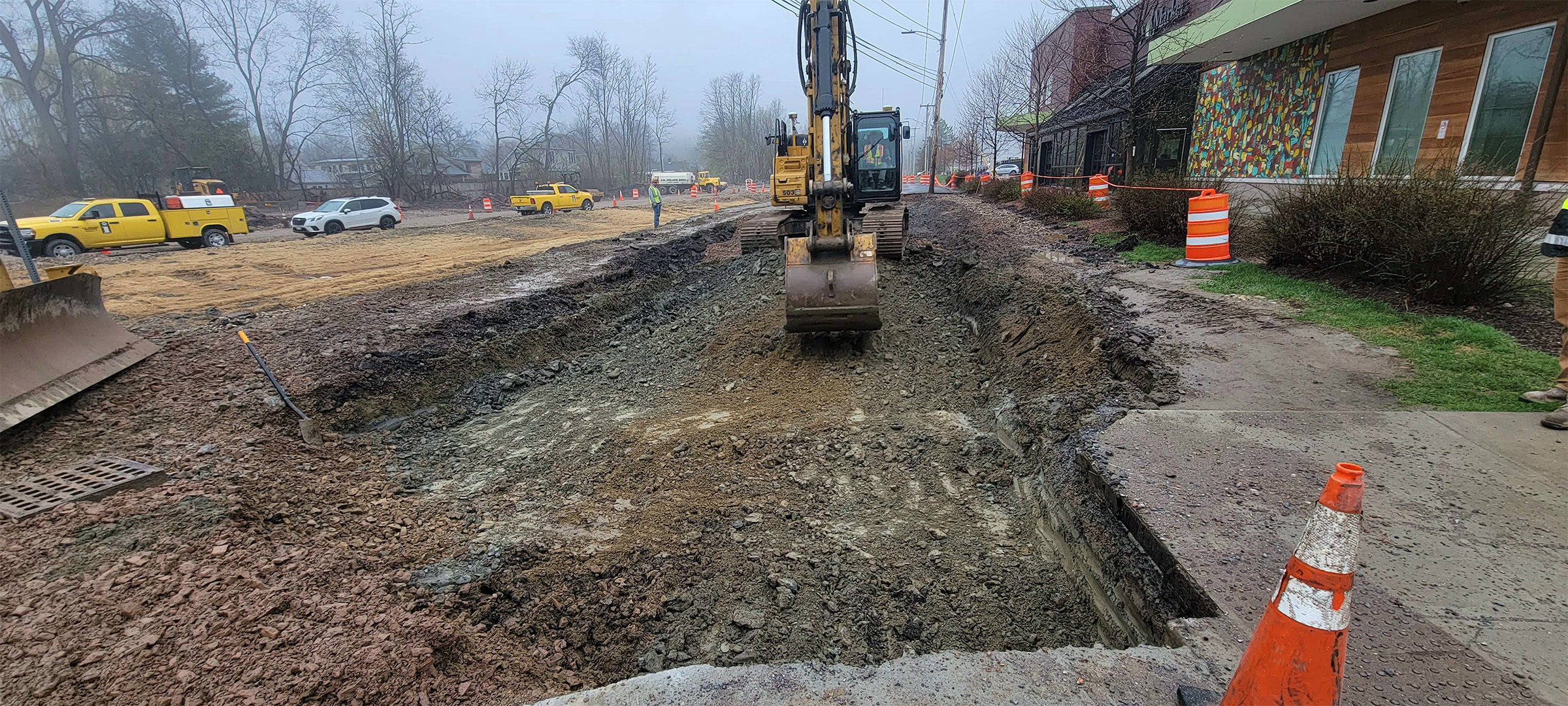

Crews begin full-depth excavation of Briggs Street near Flynn Avenue.

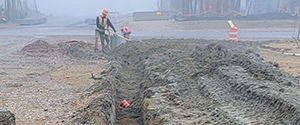

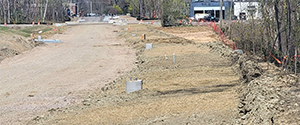

Installation of lighting conduit just south of Sears Lane in the green space adjacent to the shared use path.

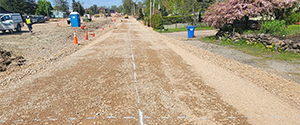

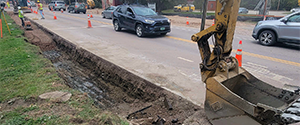

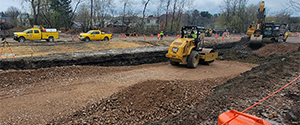

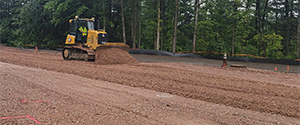

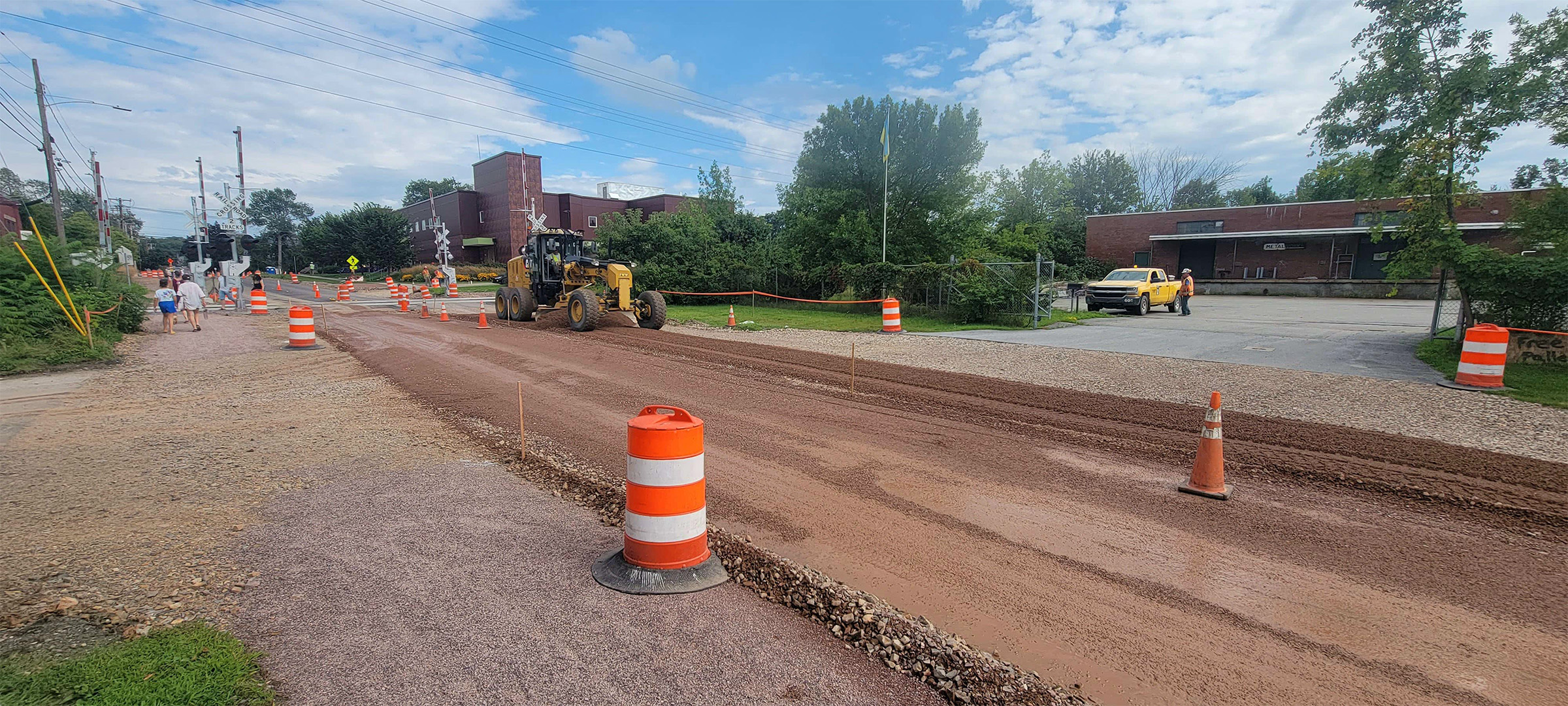

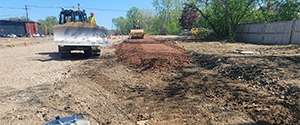

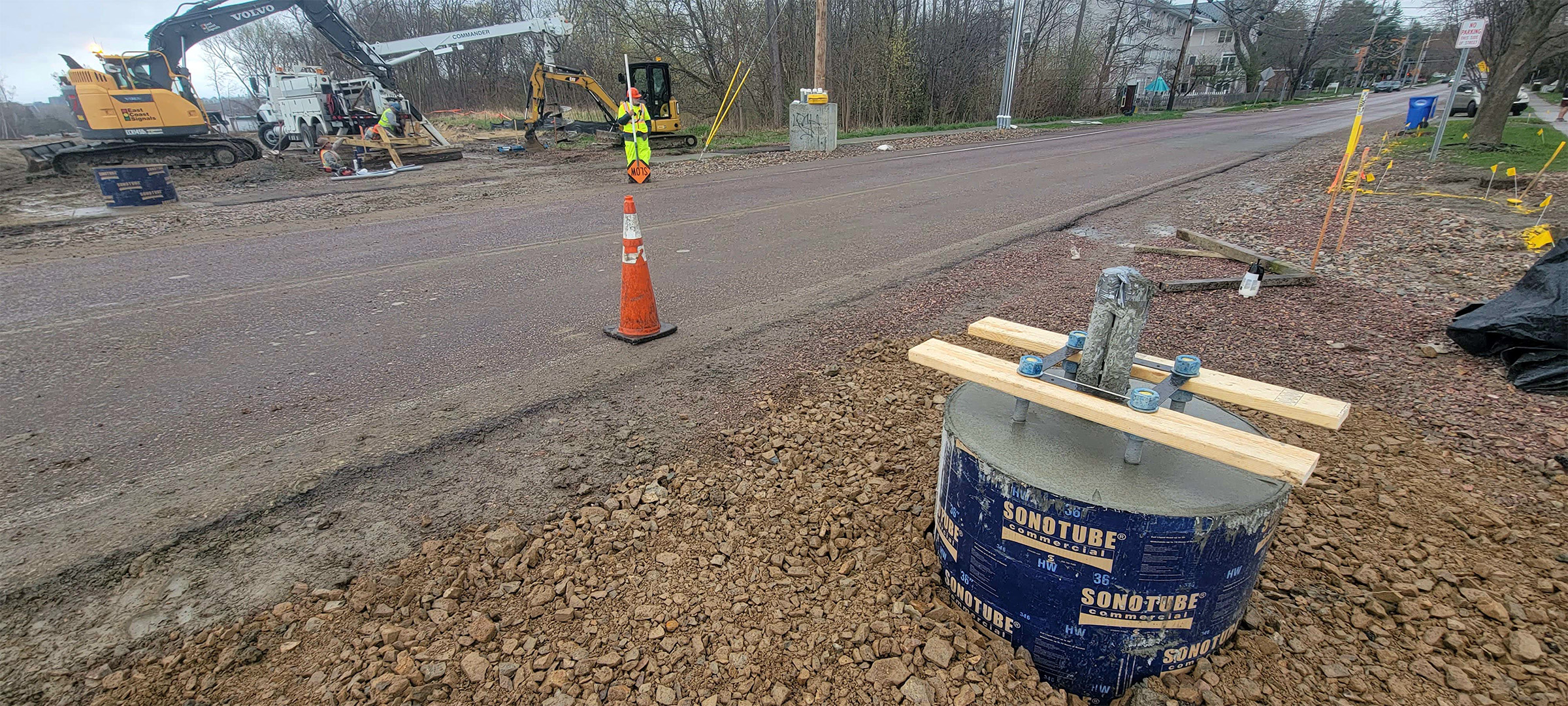

Installation of roadway subbase (dense grade) along Briggs Street.

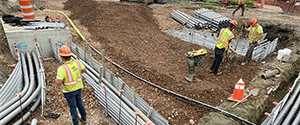

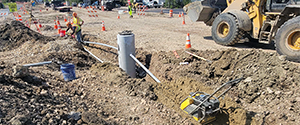

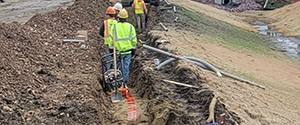

Installation of lighting conduit and light pole foundations near the Englesby grass swale.

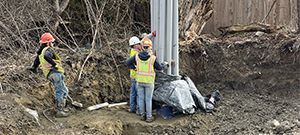

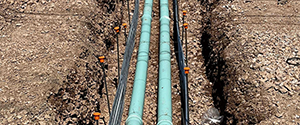

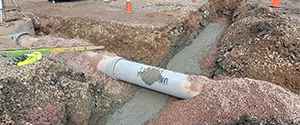

Installation of concrete-encased electrical sleeves and drainage on Batchelder Street.

The sand filter and stormwater detention pond on Lakeside Avenue.

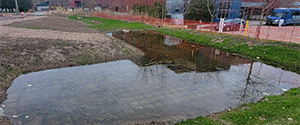

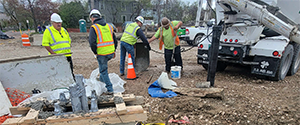

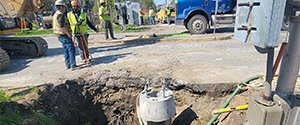

Placing concrete mast arm foundations at Flynn Avenue and the Parkway for future traffic signal equipment.

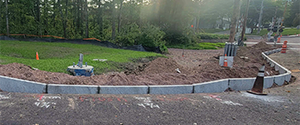

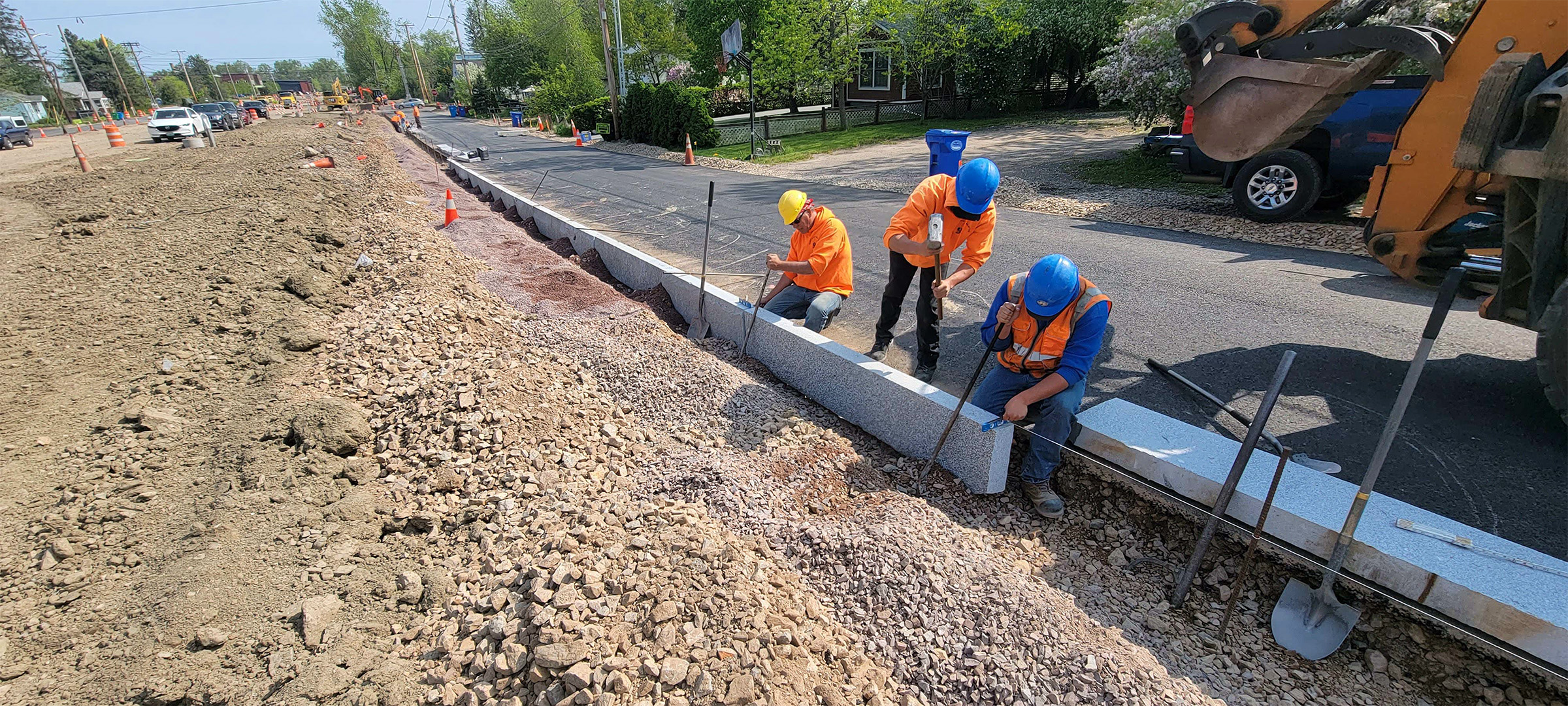

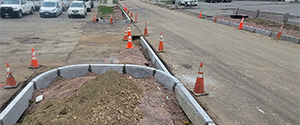

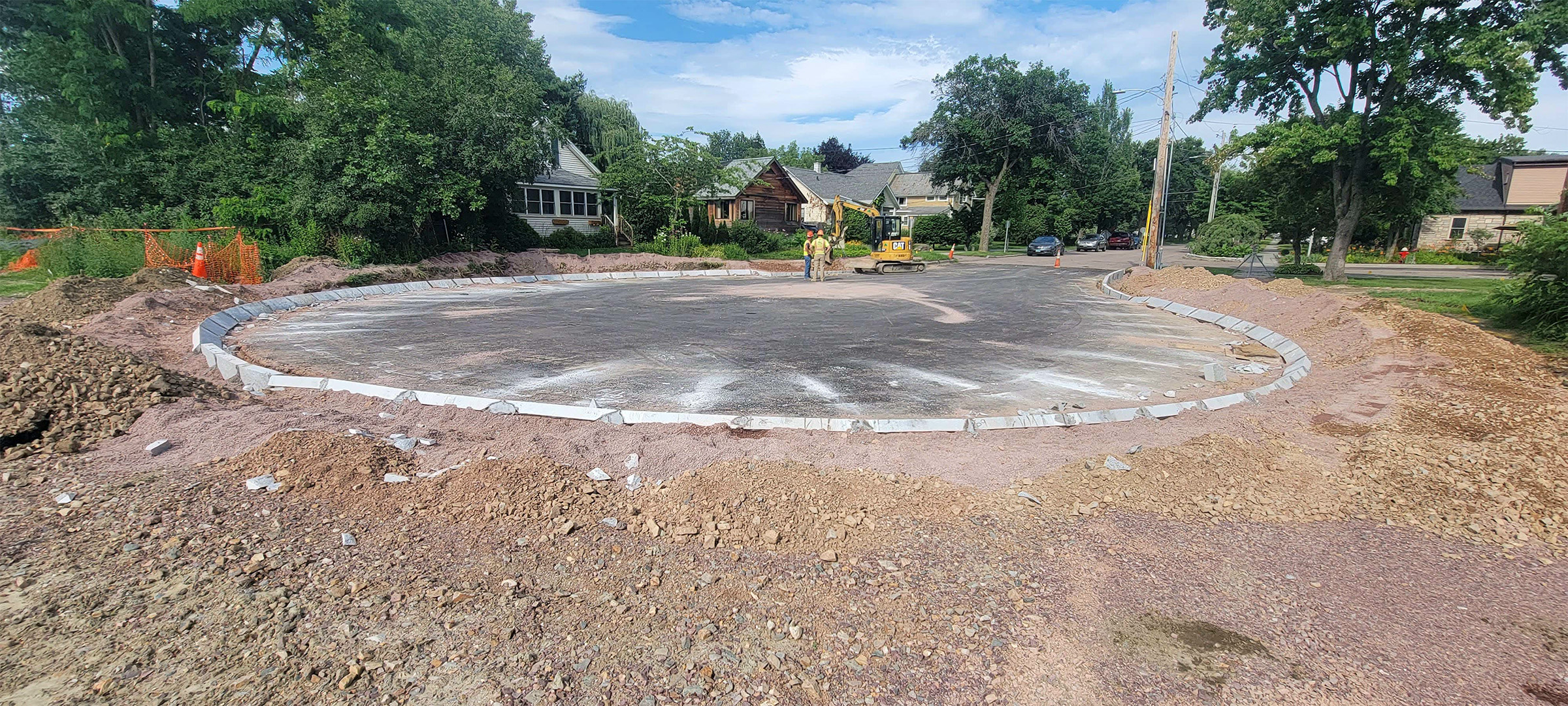

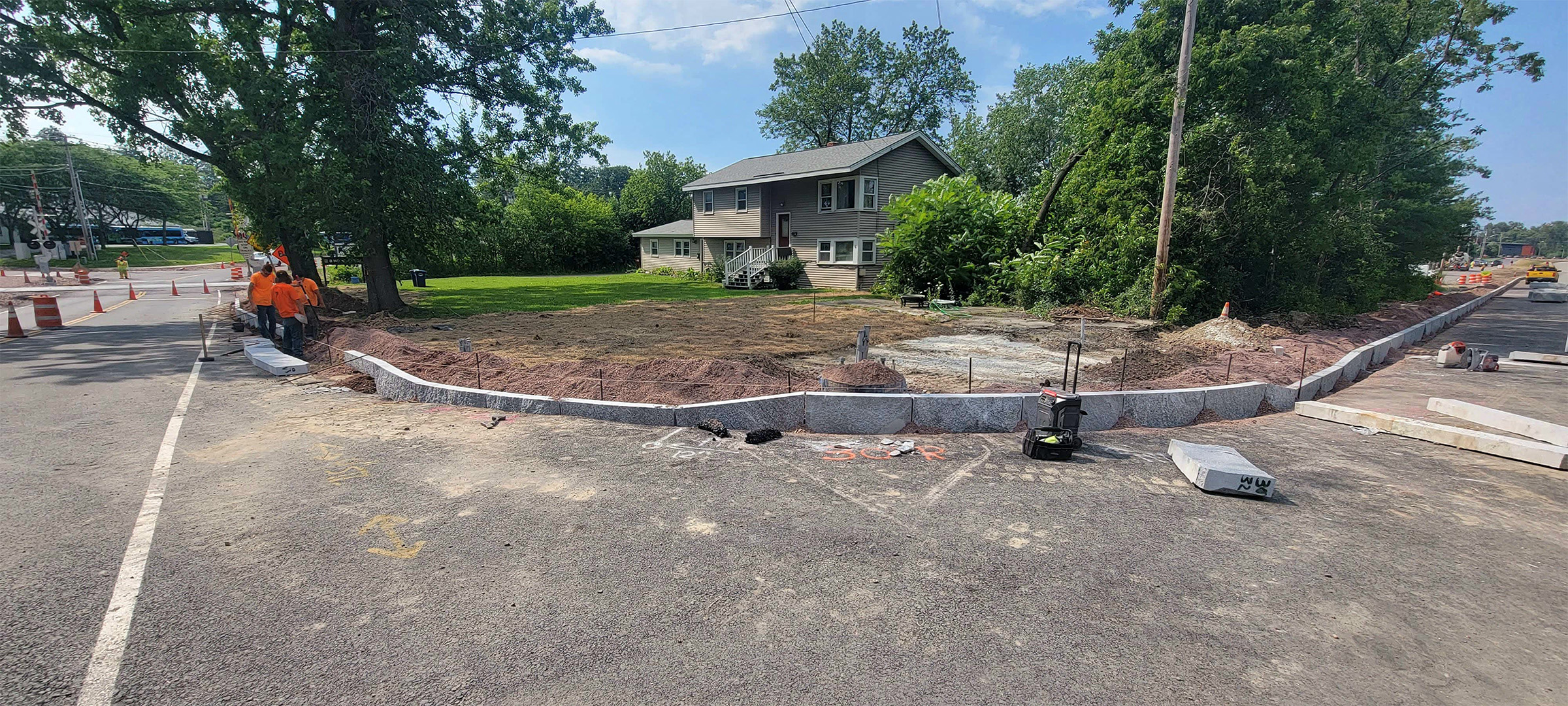

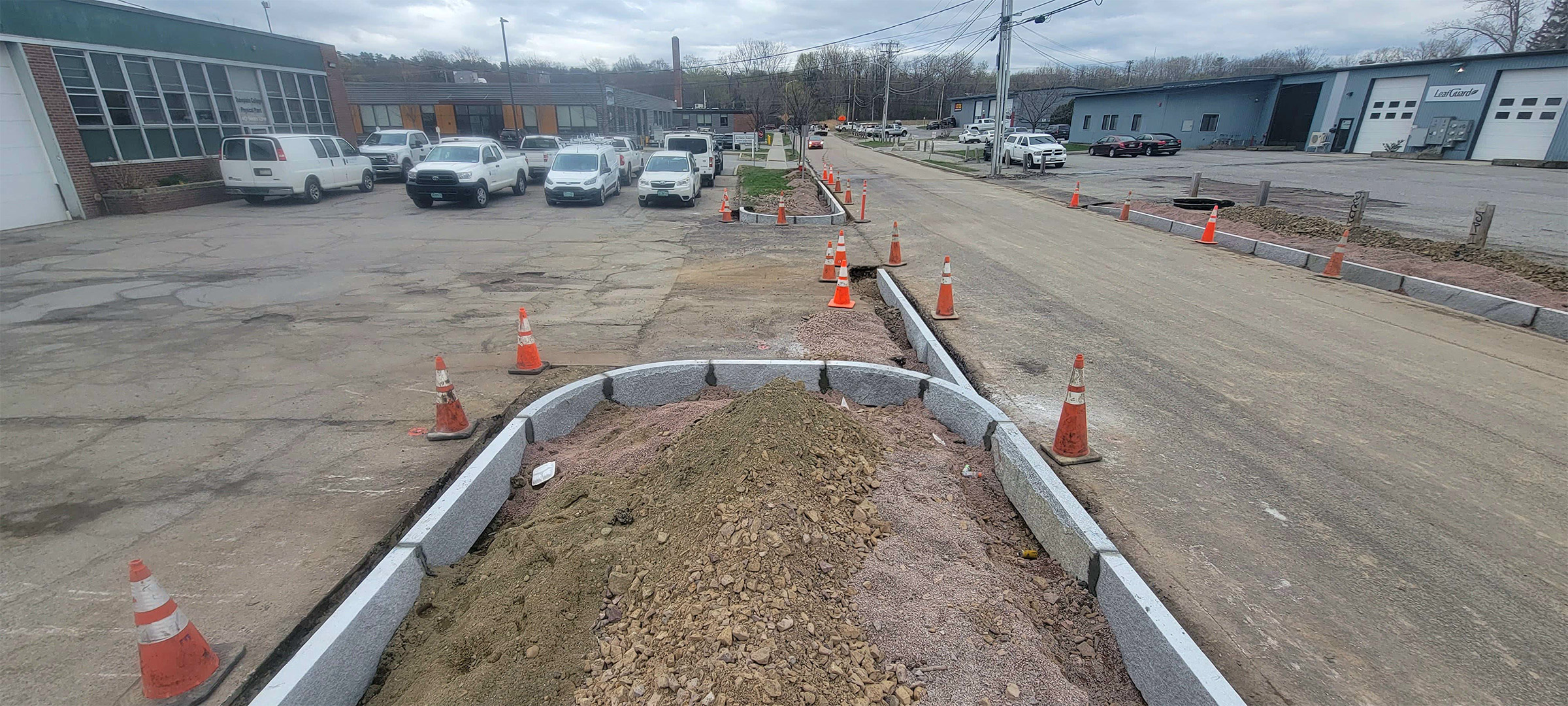

Granite curb installation along Sears Lane.

A segment of the unfinished Parkway being used as a temporary detour for Briggs Street during the reconstruction of that roadway.

Relocation of a utility gas line on Batchelder Street to allow the installation of drainage infrastructure.

Installation of the rebar cage as part of the foundation for the signal mast arm at the intersection of Sears Lane at the Parkway.

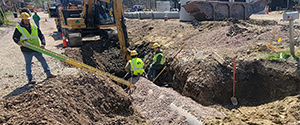

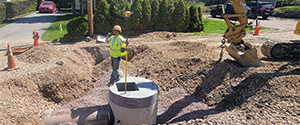

Installation of drainage infrastructure on Batchelder Street.

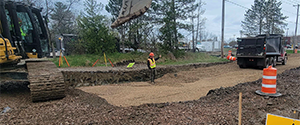

Full-depth excavation and the installation of roadway subbase (dense grade) along Brigs Street.

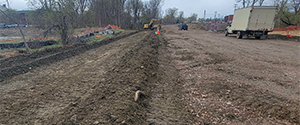

Crews grade the common fill before placing dense grade material on the shared use path along the Parkway between Sears Lane and Flynn Avenue.

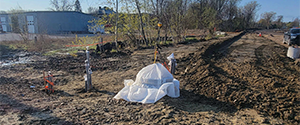

Crews continue to work installing conduit for future traffic signal wiring and power while the concrete mast arm foundations cure.

Erosion matting installed for slope stabilization near the Englesby box culvert.

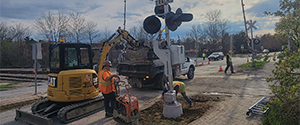

Installation of the new signal and gate at the railroad crossing at Flynn Avenue.

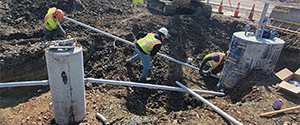

Installation of street lighting foundations and conduits near Flynn Avenue.

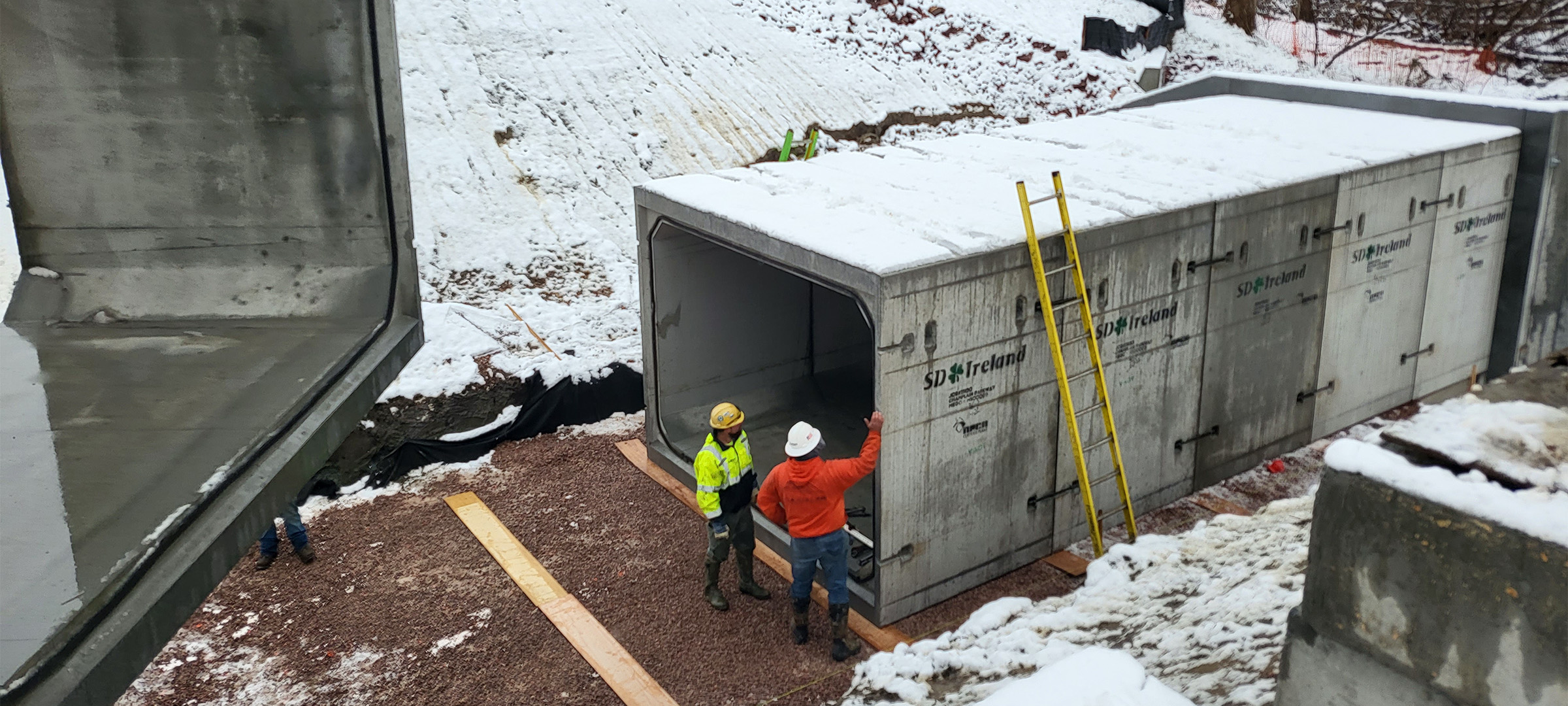

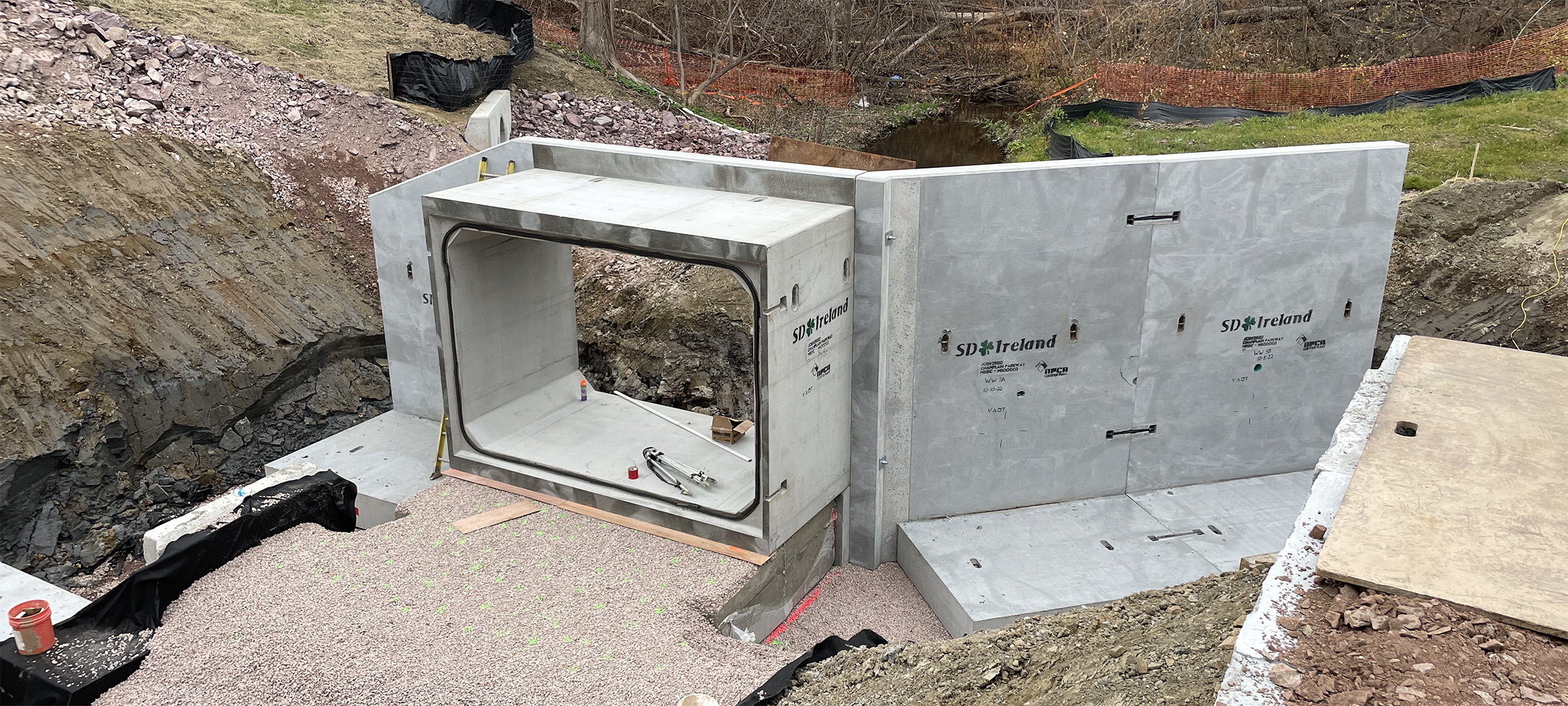

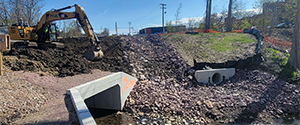

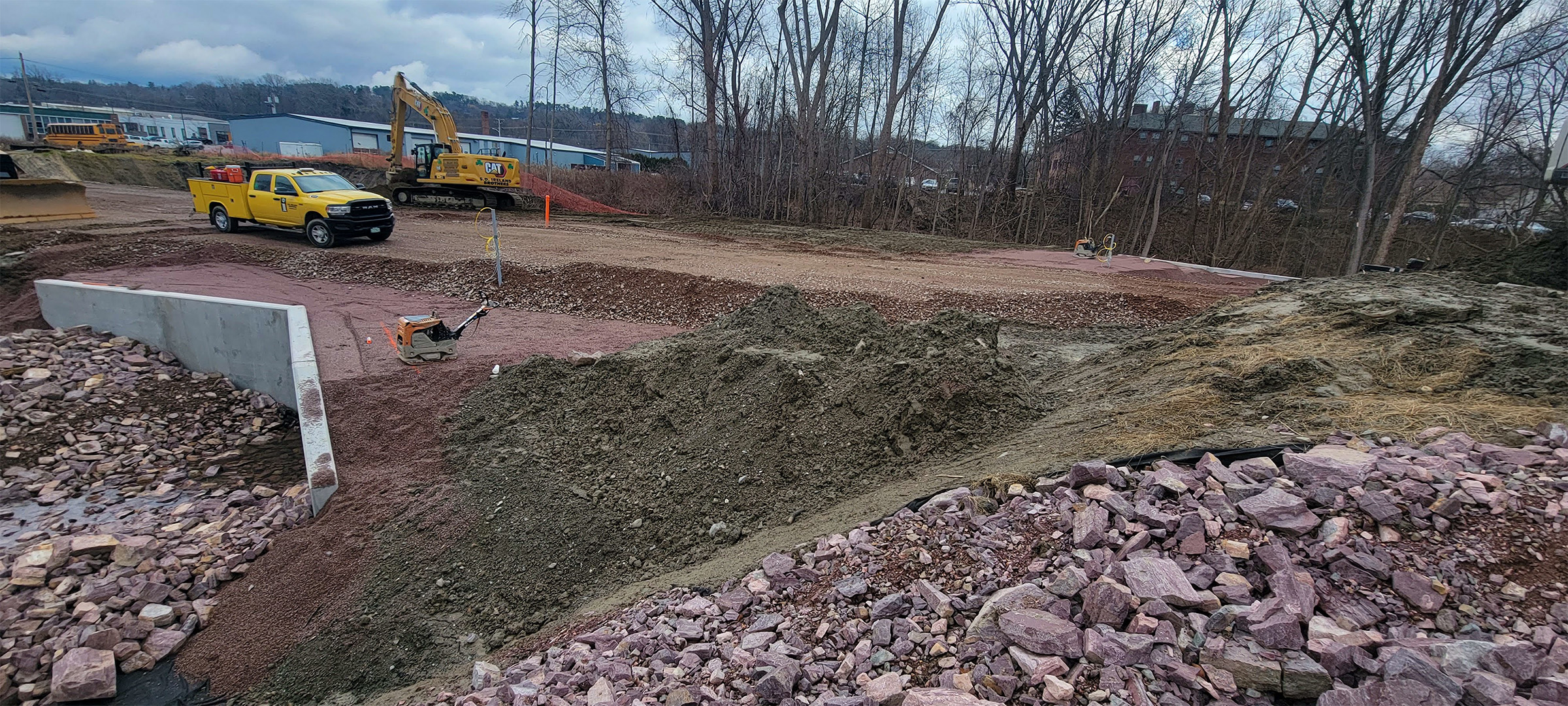

Installation of topsoil around the headwall and wingwalls along the box culvert channeling Englesby Brook and the emergency spillway for the detention pond.

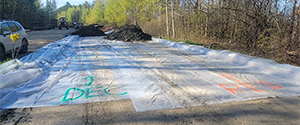

Soil stockpile area on the unused section of the previously constructed southern connector near Home Avenue.
Installation of drainage infrastructure on Batchelder Street.

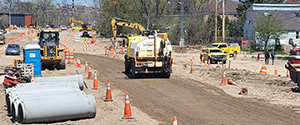

Implementation of dust control measures along the unfinished segment of the Parkway between Flynn Avenue and Home Avenue as it is prepped to be used as a detour route for Batchelder Street during its reconstruction.
Street lighting foundations and conduit installed along the Parkway and the shared use path just south of Sears Lane.

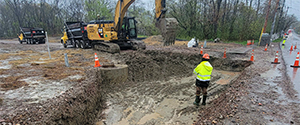

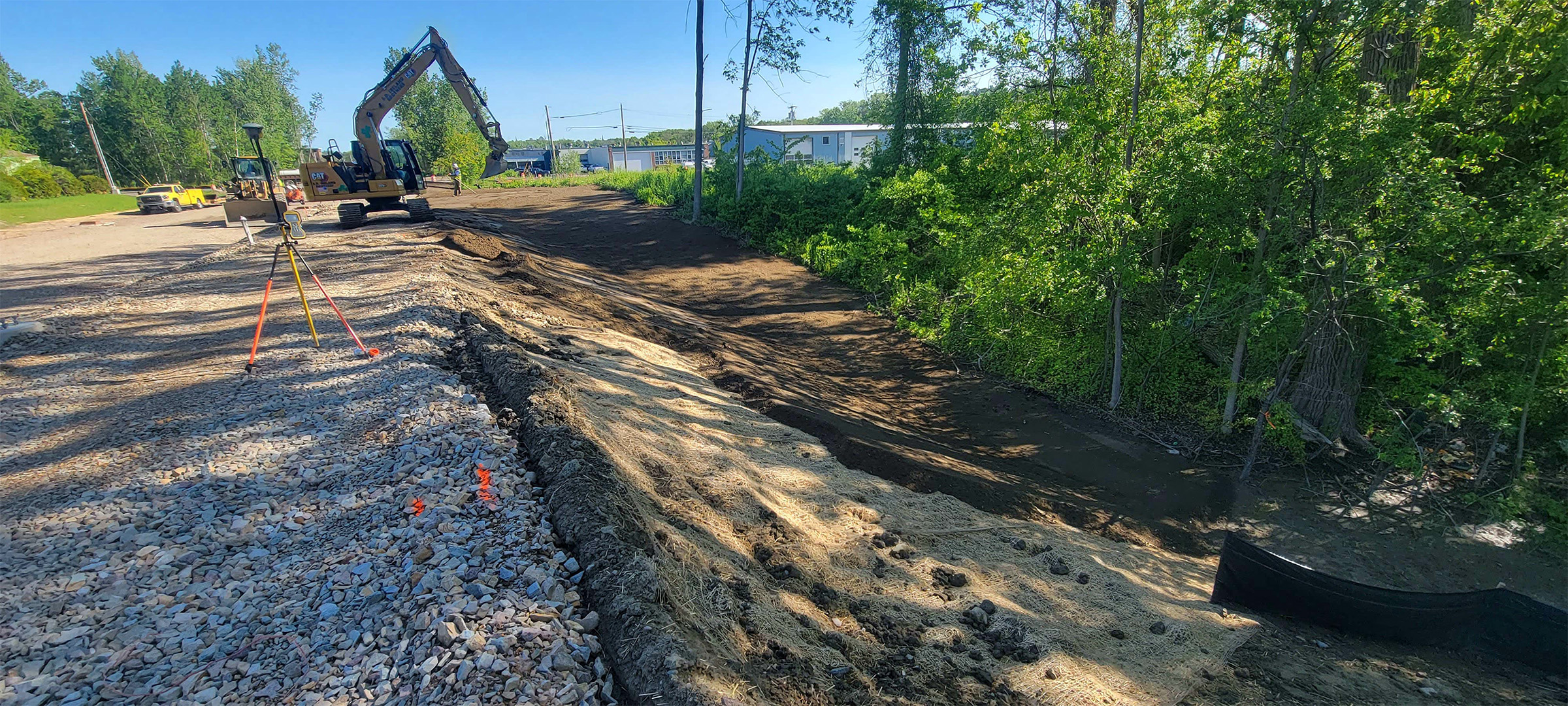

Crews excavating the section of the Parkway just north of the Flynn Avenue intersection.

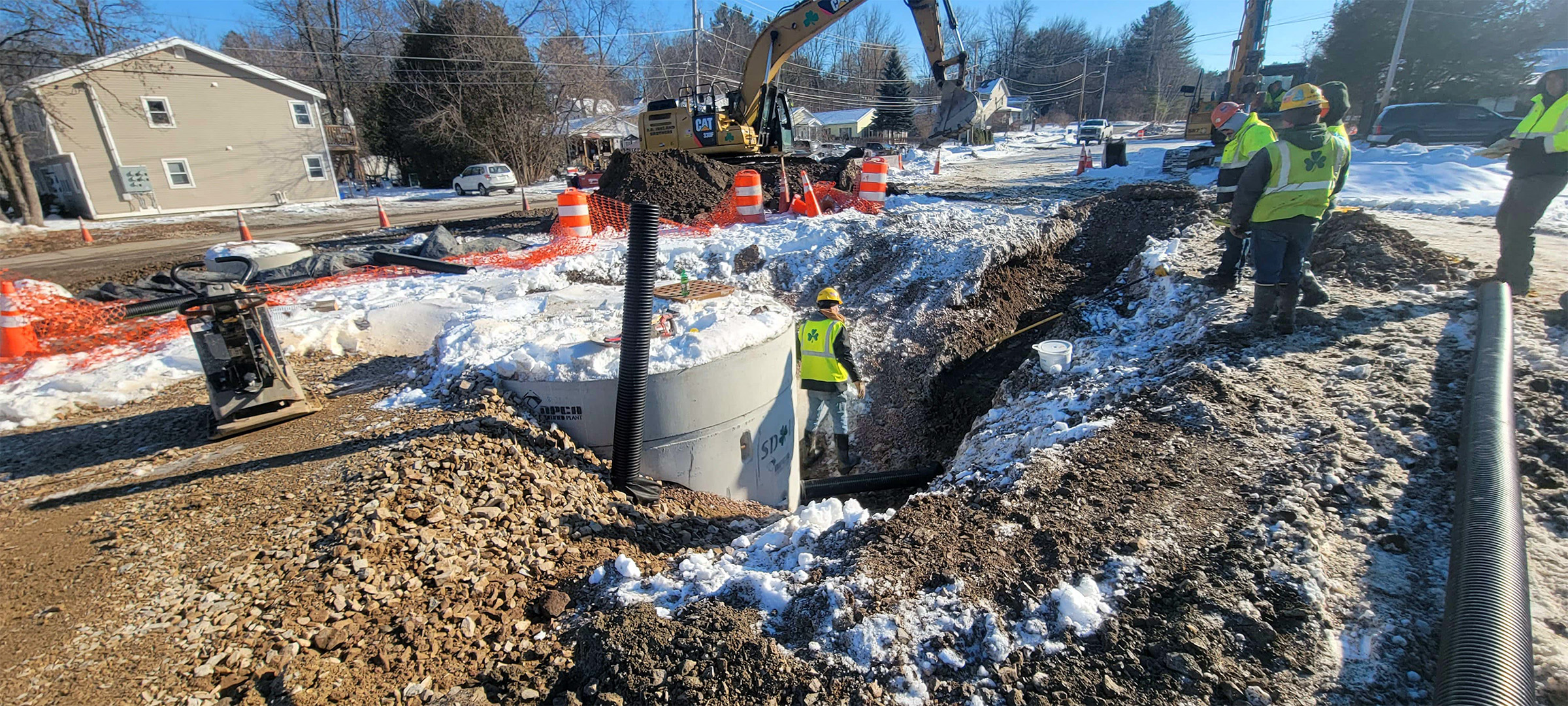

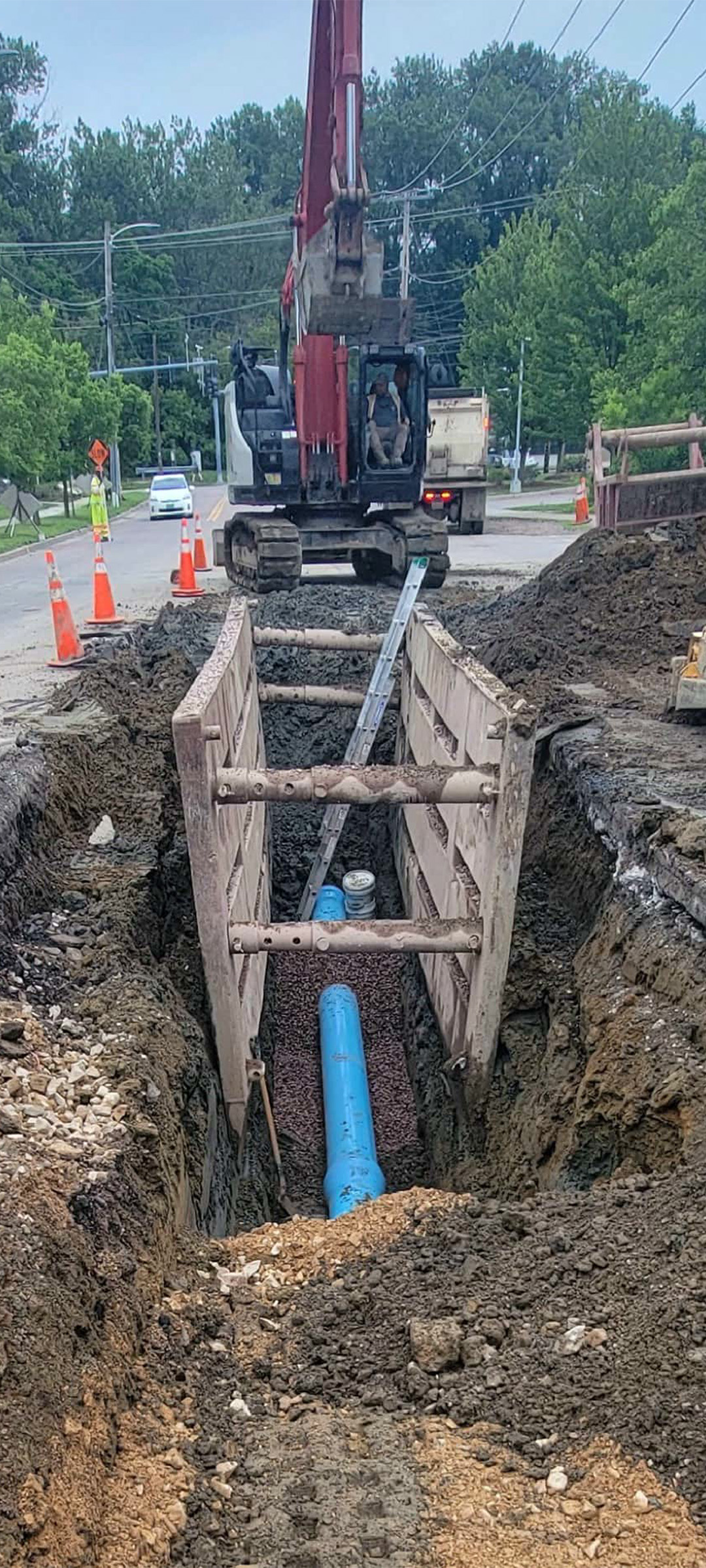

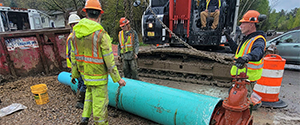

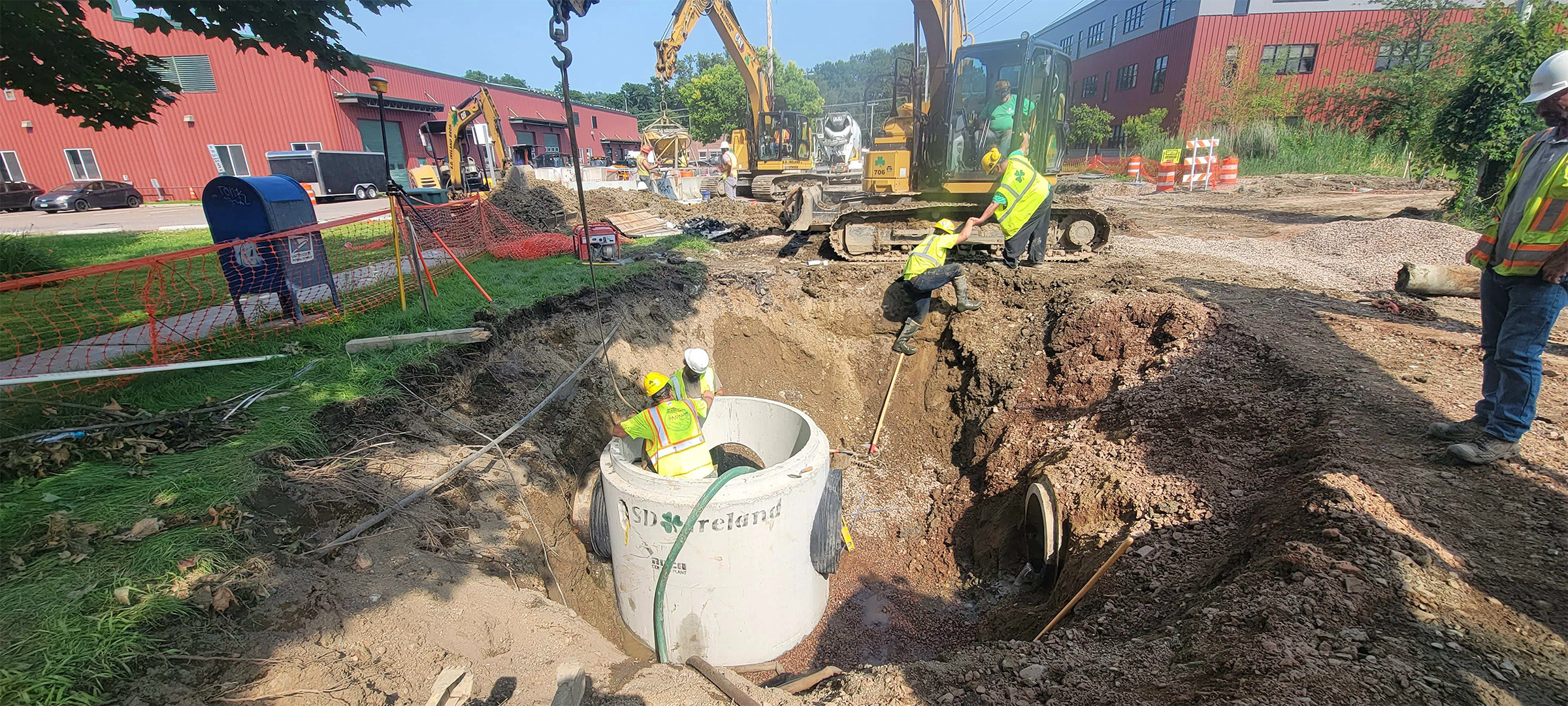

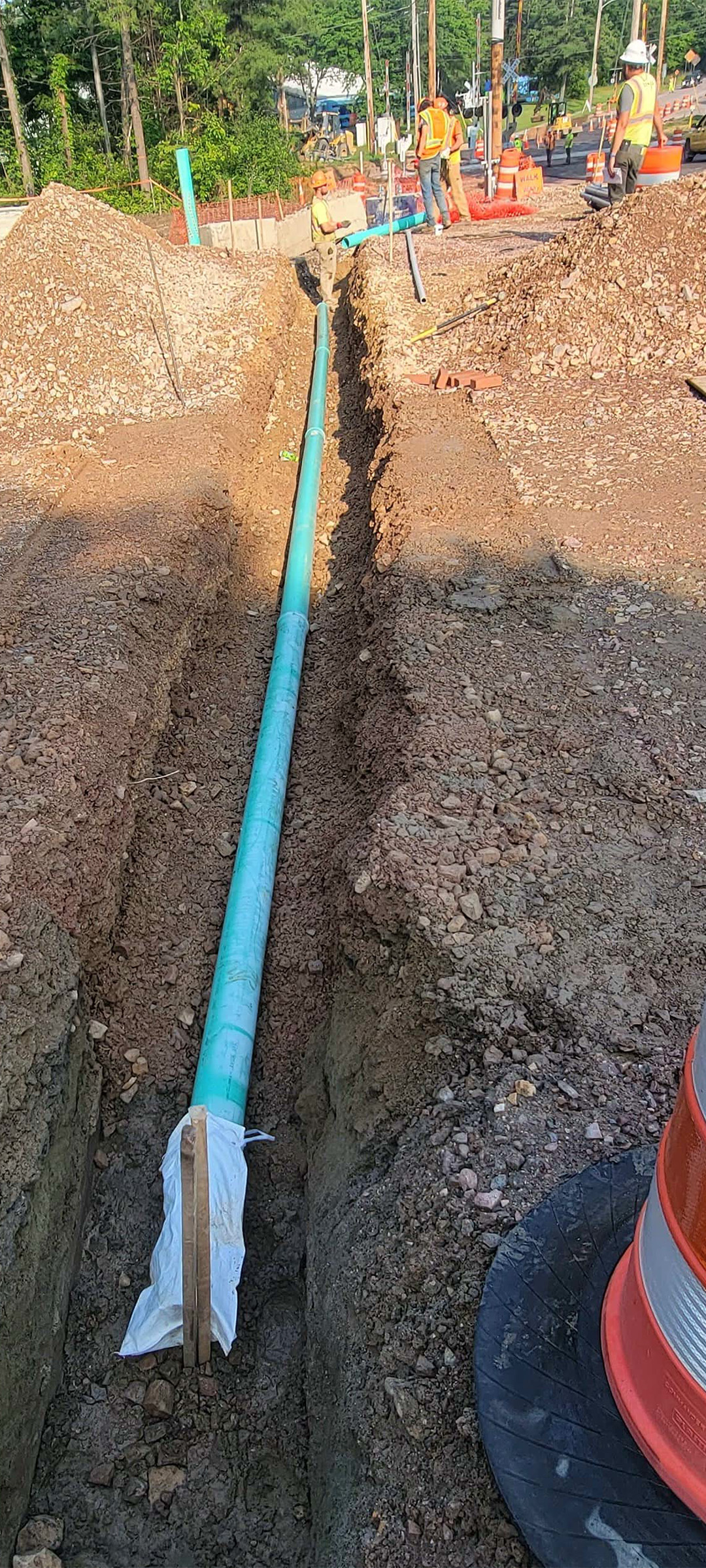

Installation of waterline, gate valve, and sleeve on Home Avenue at the tie in point for the Batchelder Street waterline tie in.

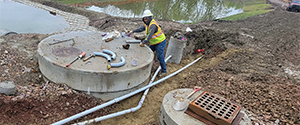

Street lighting foundation and conduit installation next to the Englesby Brook detention pond.

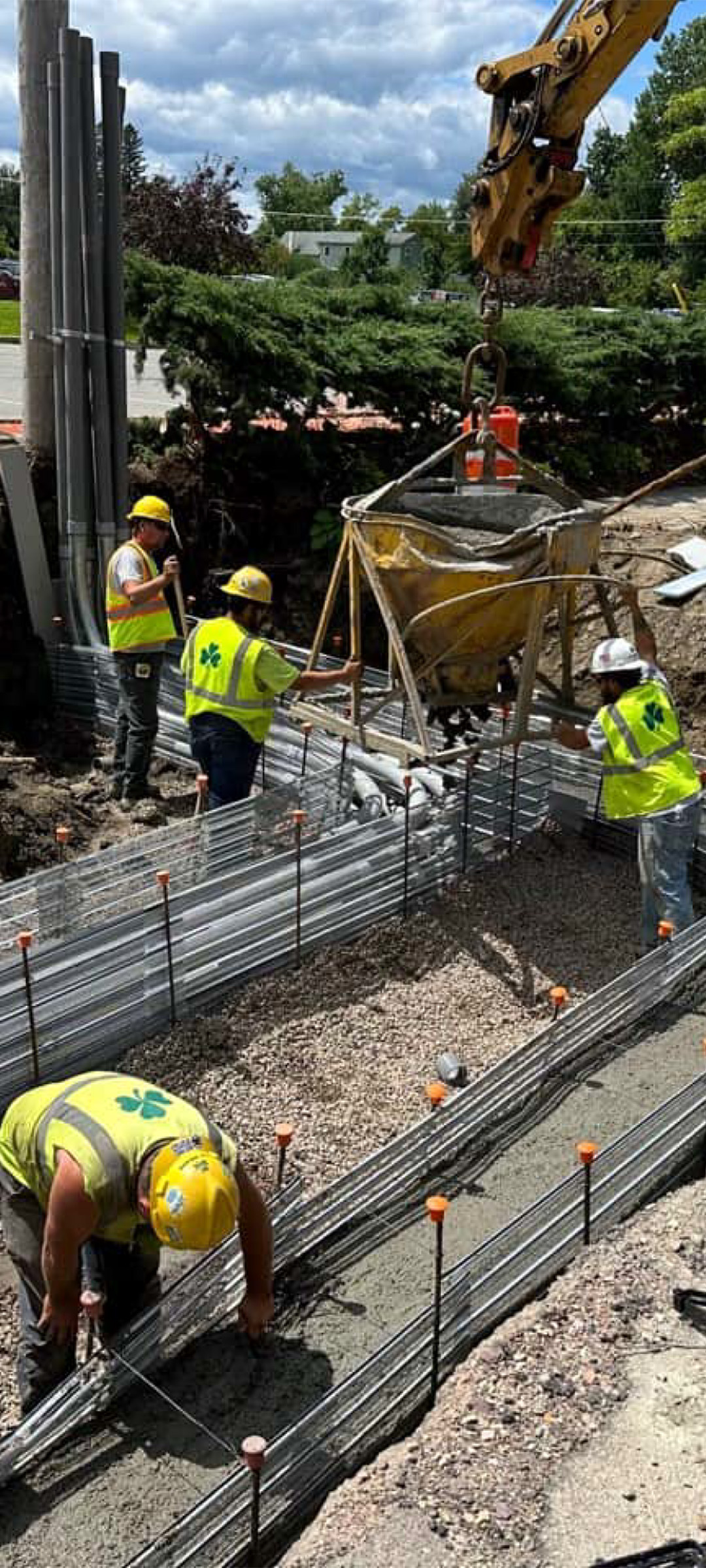

Concrete placement for the mast arm foundation for the traffic signal at Flynn Avenue and the Parkway.
Installation of underdrain along the Parkway between Morse Place and Home Avenue.

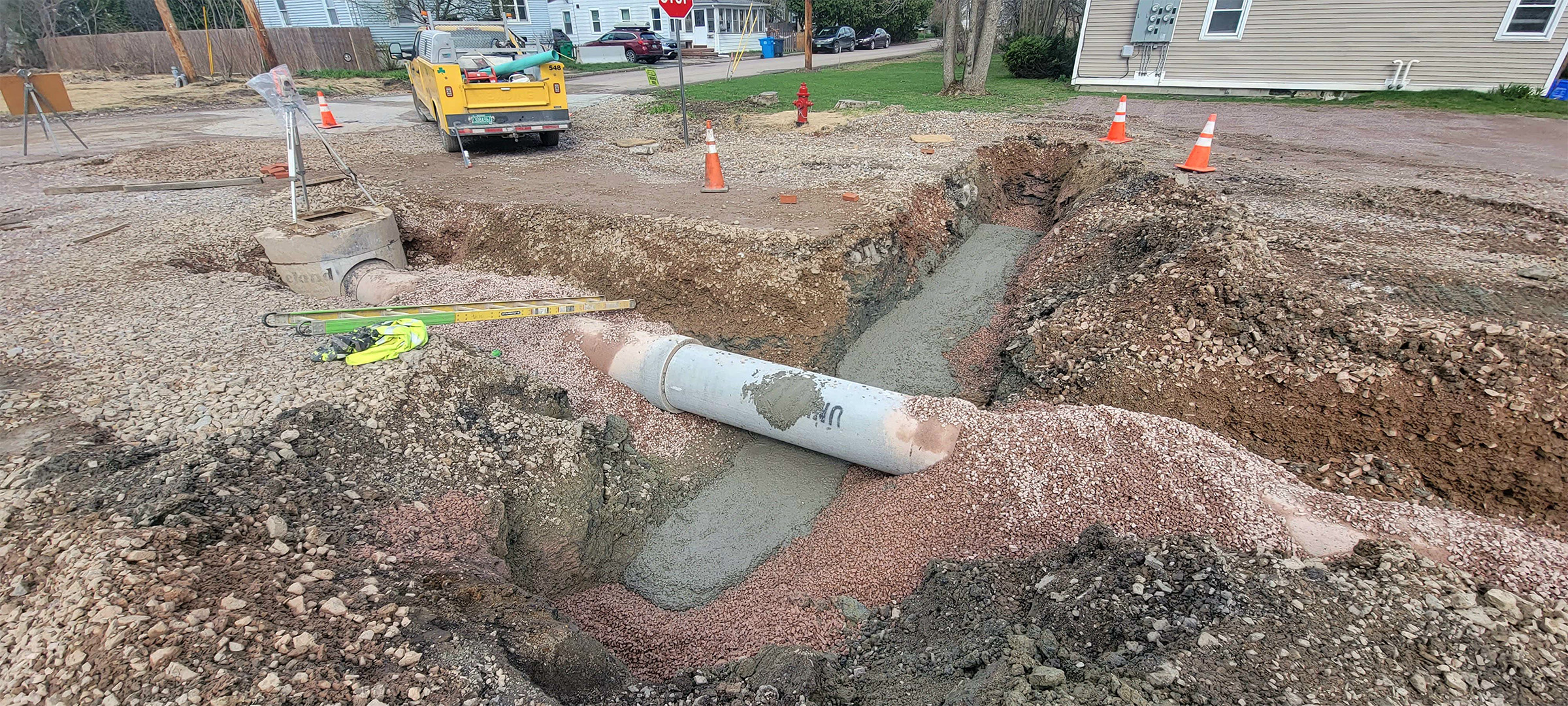

Installation of waterline along Home Avenue.
Installation of the signal house for the Flynn Avenue railroad crossing.

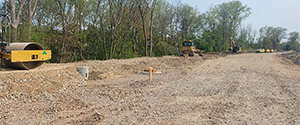

Installation of dense grade material along the shared use path between Sears Lane and Flynn Avenue.

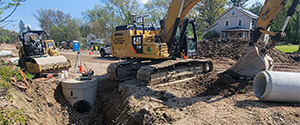

Installation of drainage near the intersection of Home Avenue and the Parkway.

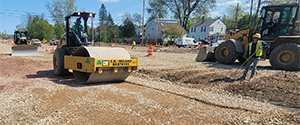

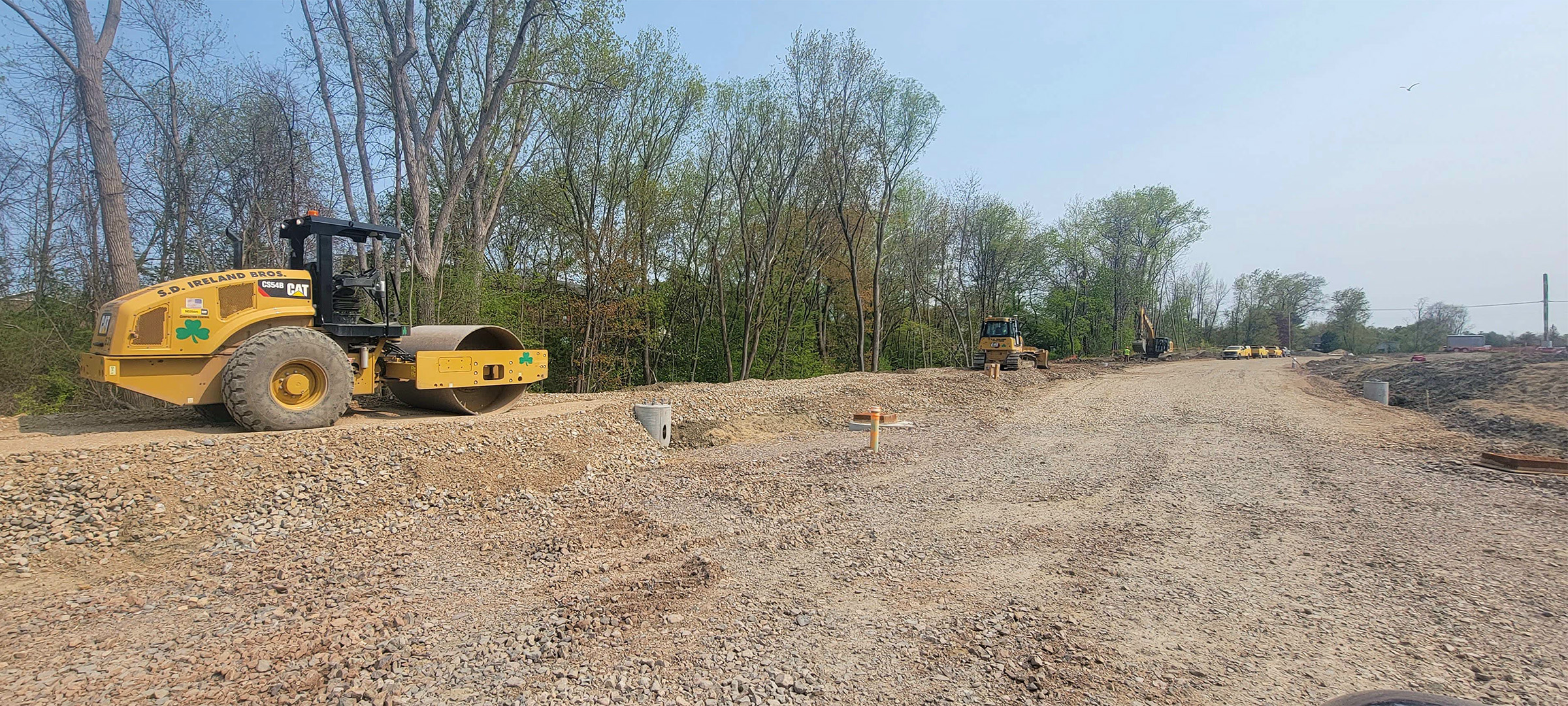

Grading of Briggs Street and the new cul-de-sac at the westerly end of Briggs Street in preparation for base course paving.

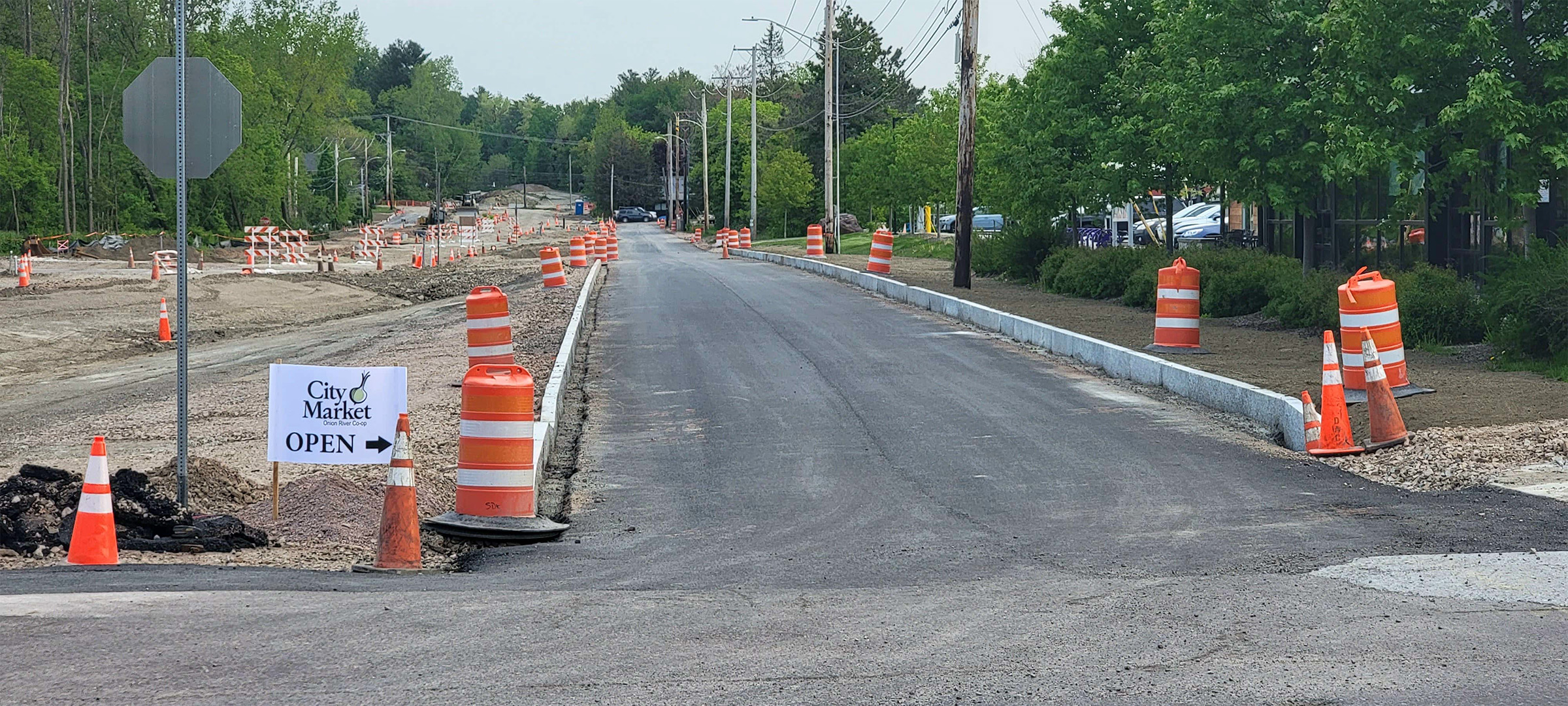

Batchelder Street fine-graded in preparation of base course paving.

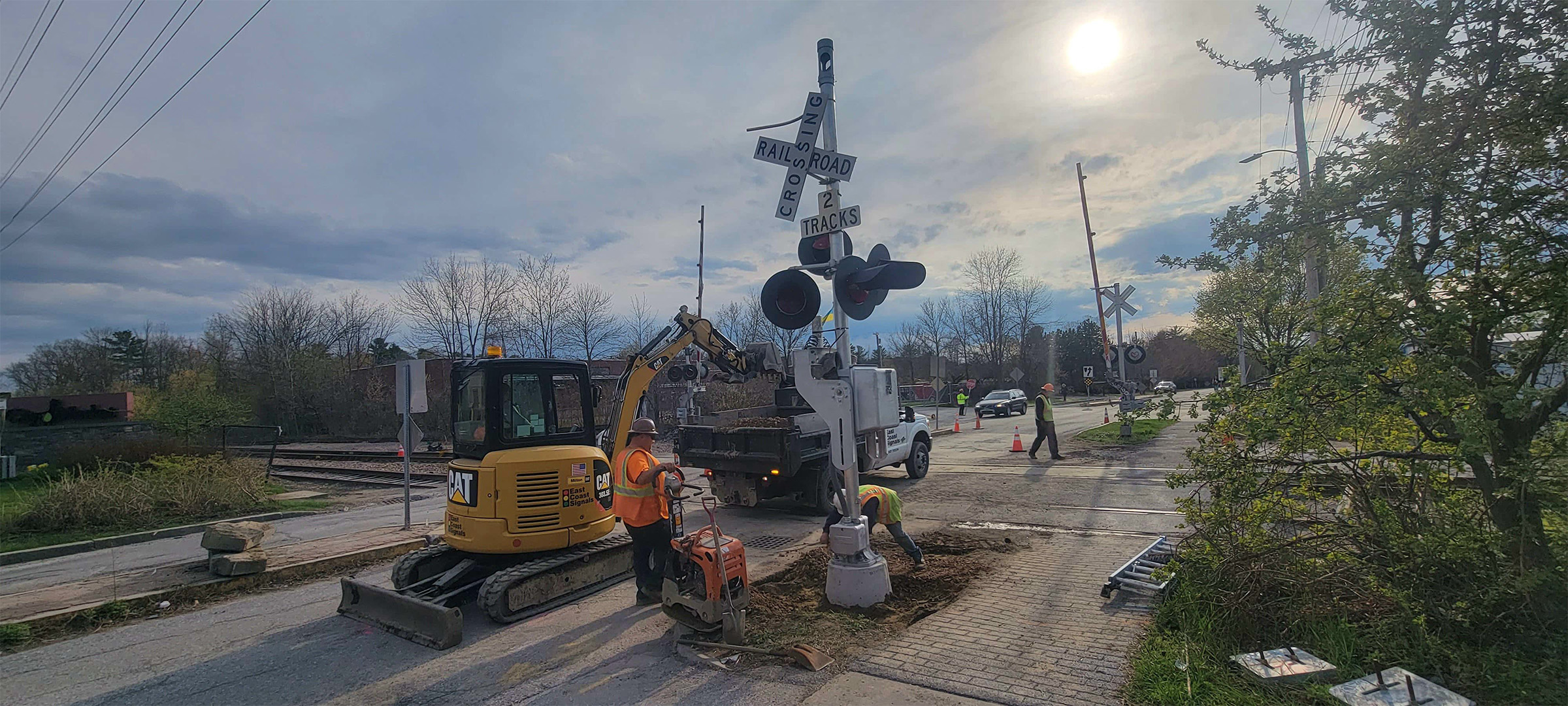

Installation of the foundation for the new railroad signal at the railroad crossing at Flynn Avenue.
Crews base paving Batchelder Street.
Crews base paving the new cul-de-sac at the westerly end of Briggs Street.
Installation of street lighting foundations and conduit between the Parkway and Batchelder Street.
Installation of dense grade along the shared use path between Flynn Avenue and Ferguson Avenue.

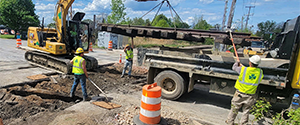

The removal of the railroad siding at the Flynn Avenue railroad crossing.

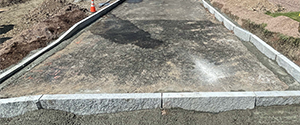

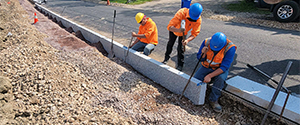

The installation of granite curb along Batchelder Street.

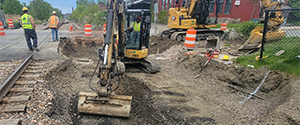

Removal of the old ballast material at the railroad crossing on Flynn Avenue.

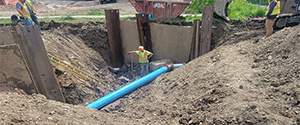

New waterline being tied into the existing waterline on the western end of Home Avenue.

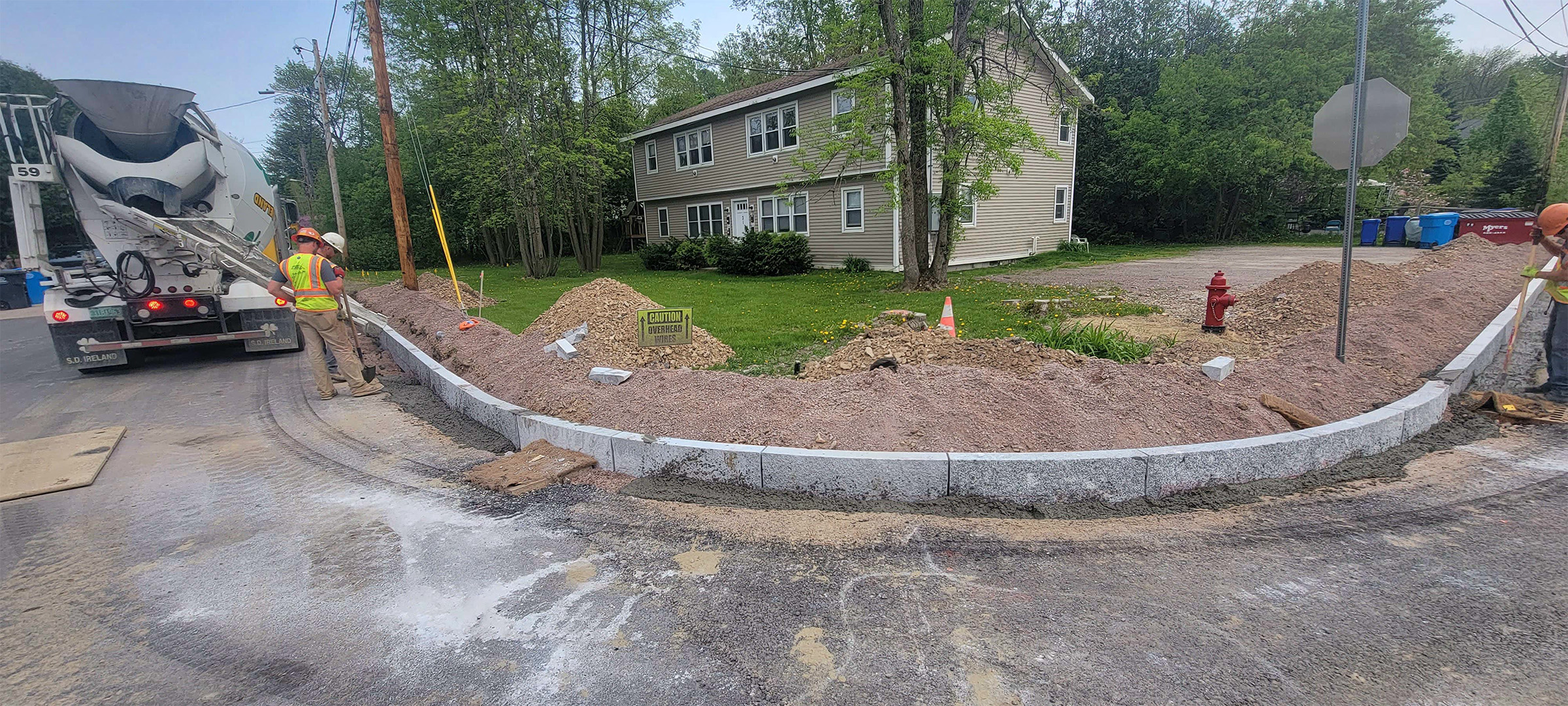

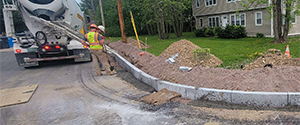

Placing concrete support to the granite curb along the corner of Batchelder Street and Morse Place. Placing concrete support to the granite curb along the corner of Batchelder Street and Morse Place.

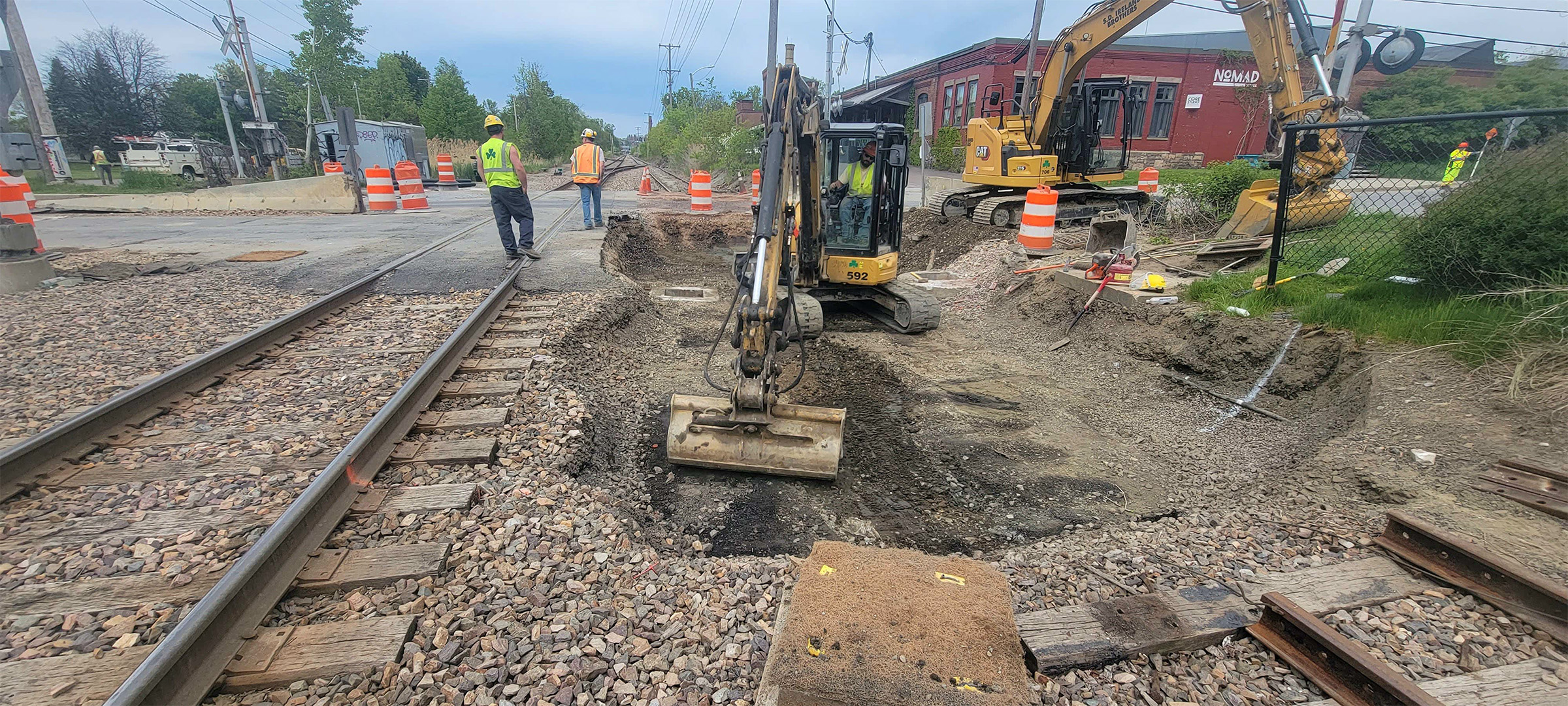

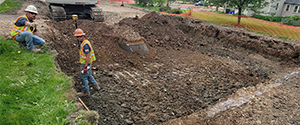

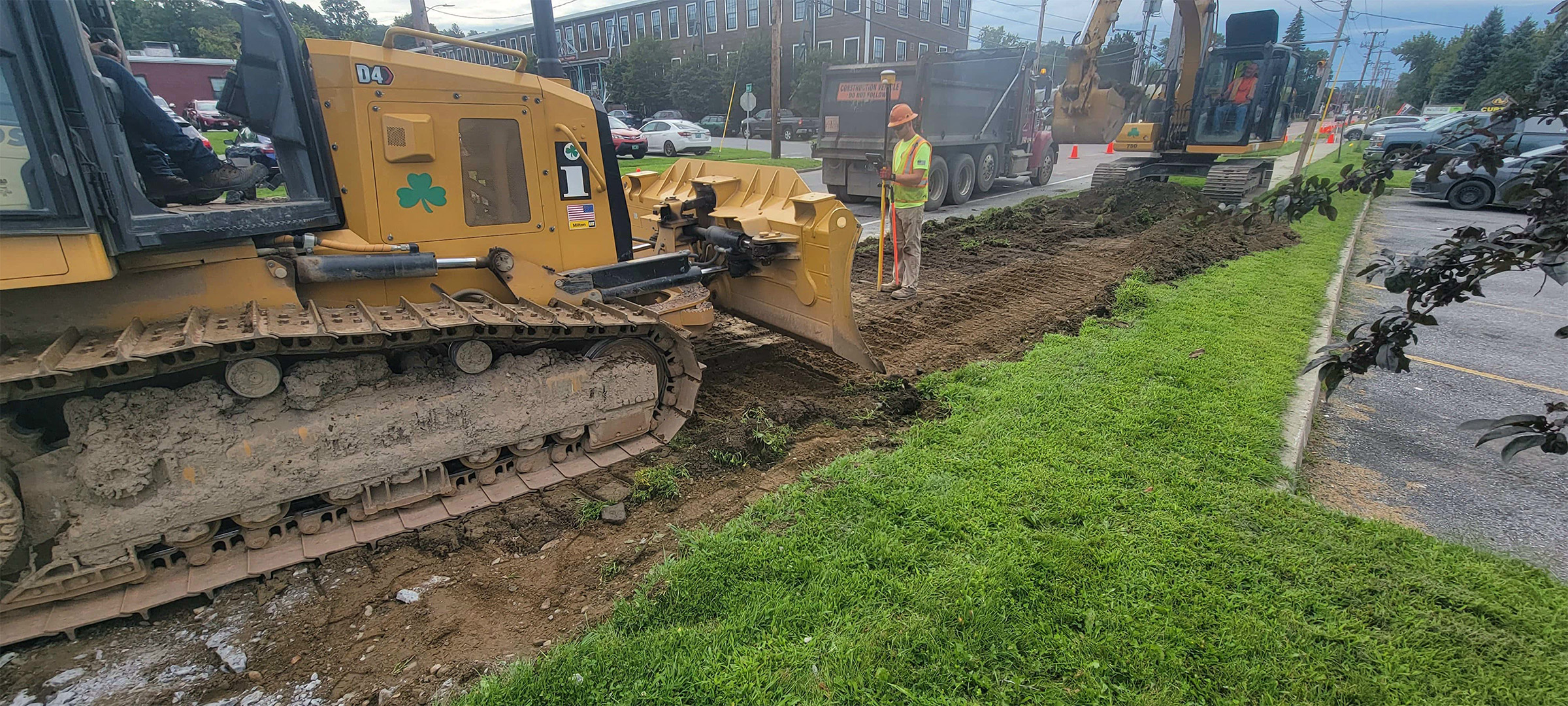

Crews begin full-depth excavation on the eastern end of Home Avenue.

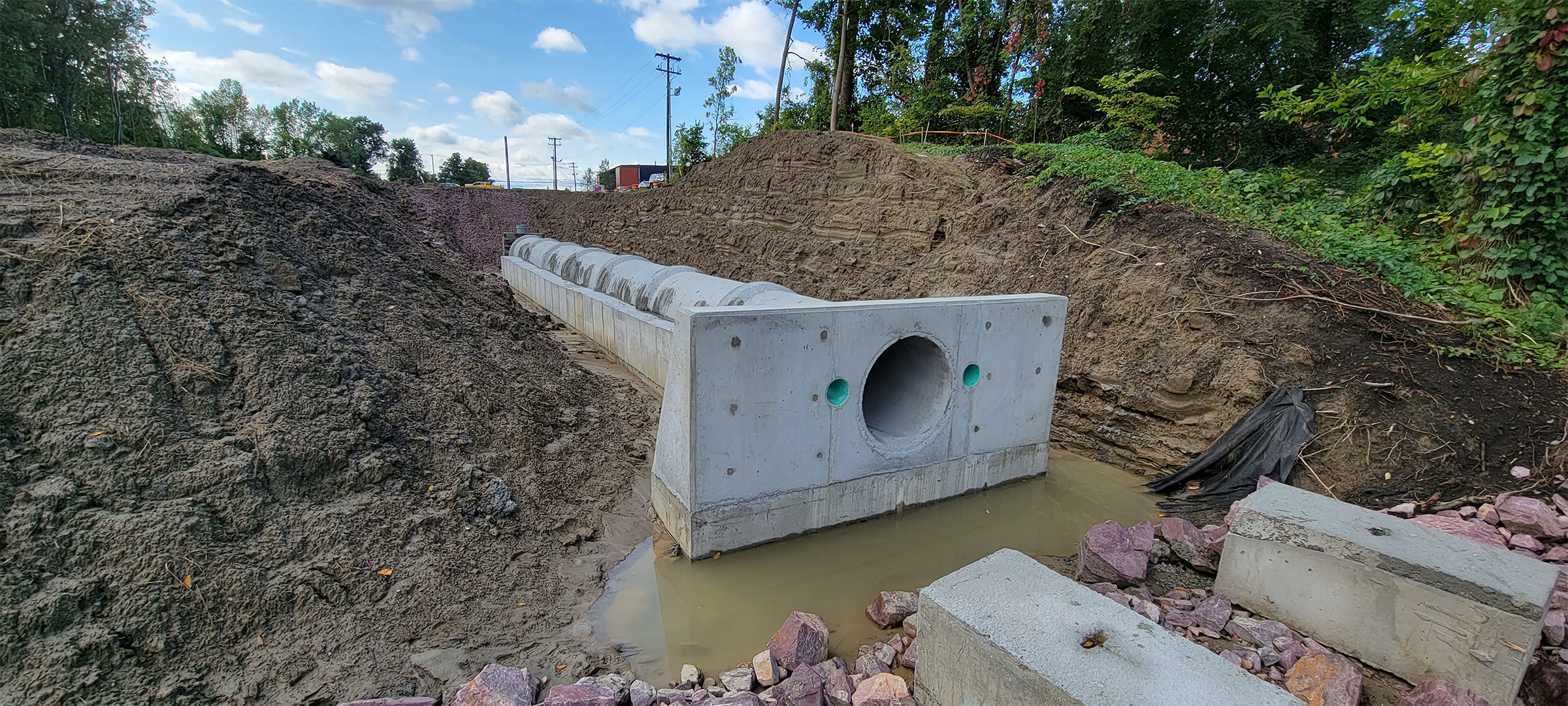

Installation of the access road to the Englesby Detention Pond.

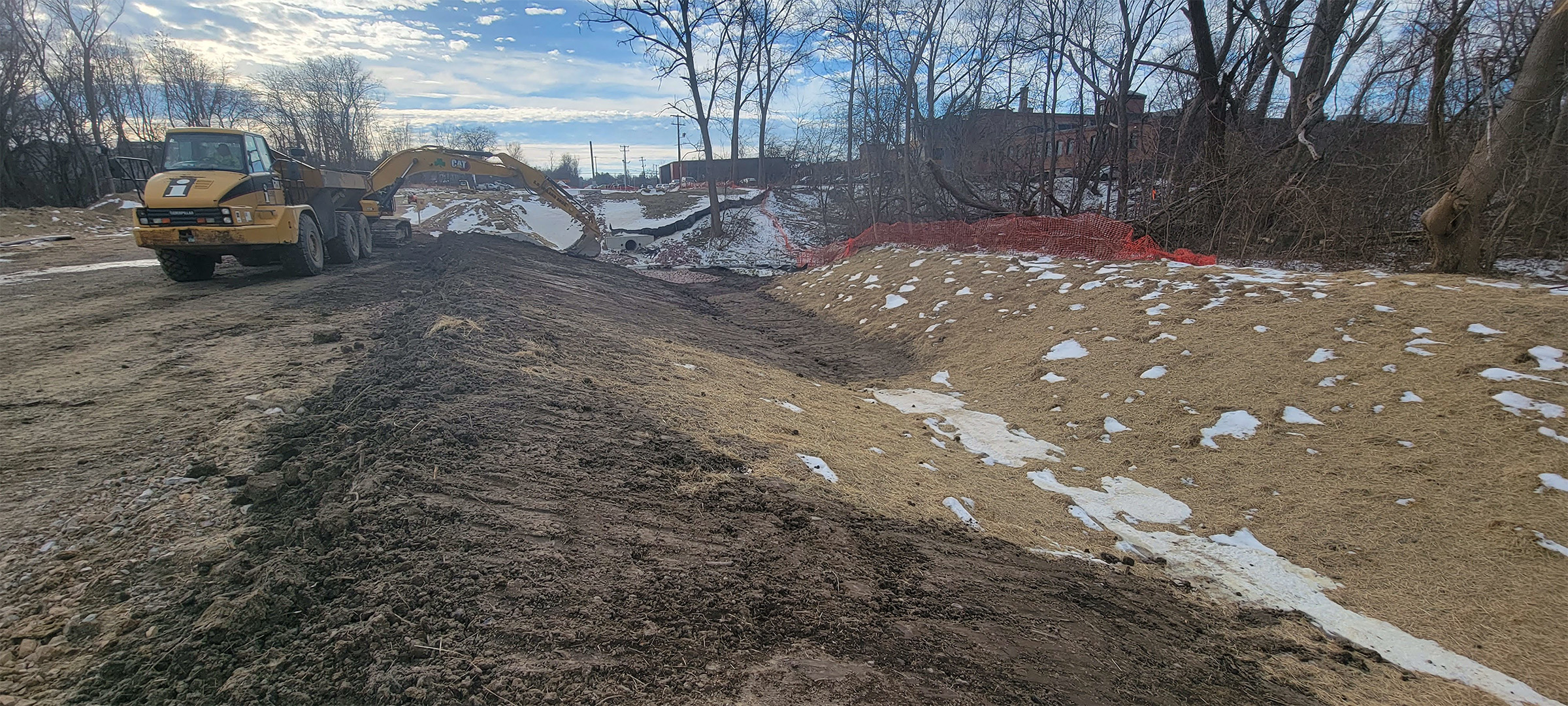

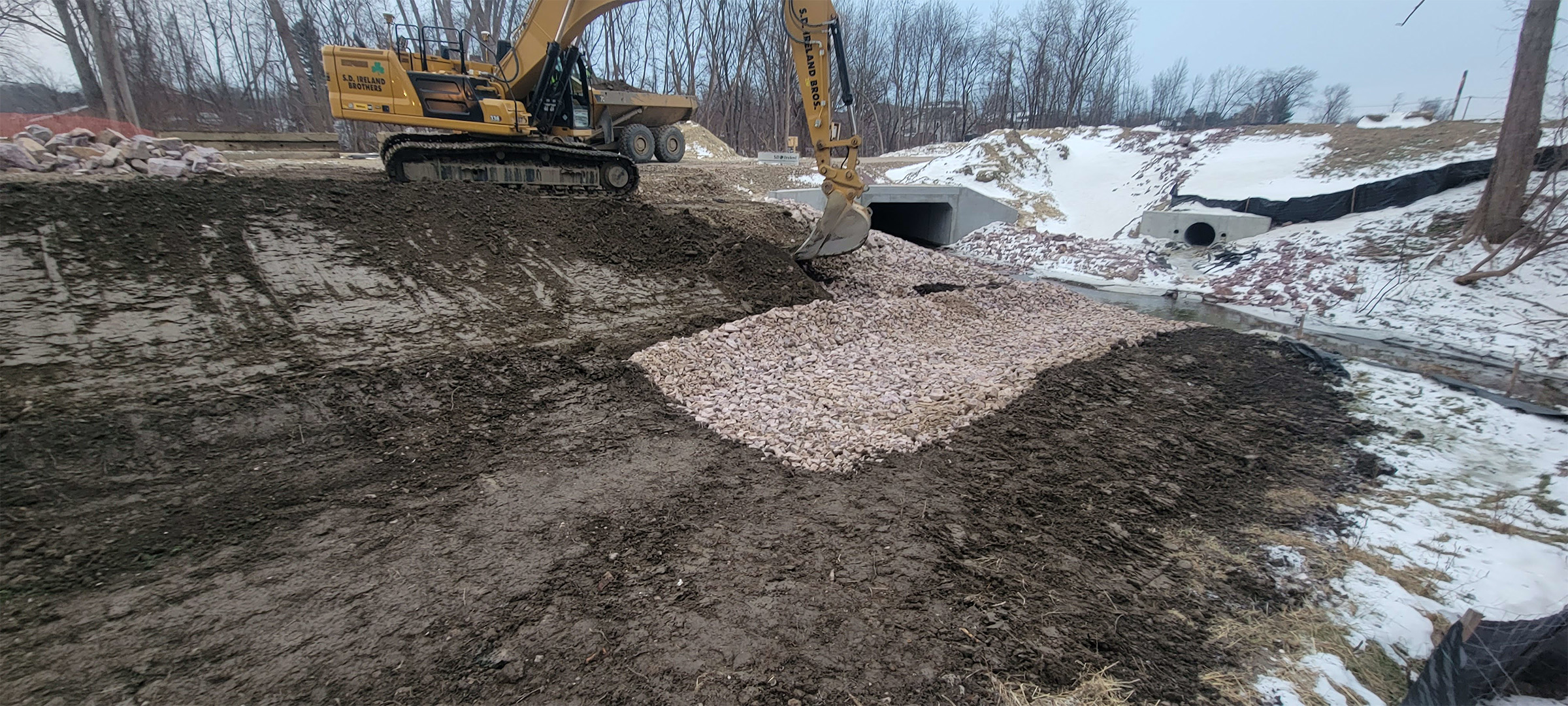

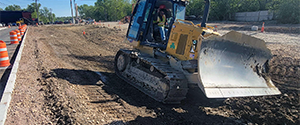

Grading of the grass swale between Briggs Street and the Parkway.

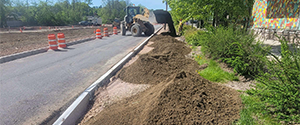

Installation of topsoil behind the newly installed granite curb on Briggs Street.

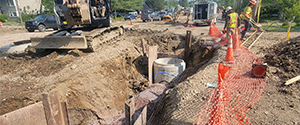

Drainage infrastructure installation on Home Avenue.
Granite curb and base course pavement along Briggs Street.
Installation of topsoil around the Englesby detention pond.
Installation of topsoil near the Englesby box culvert.

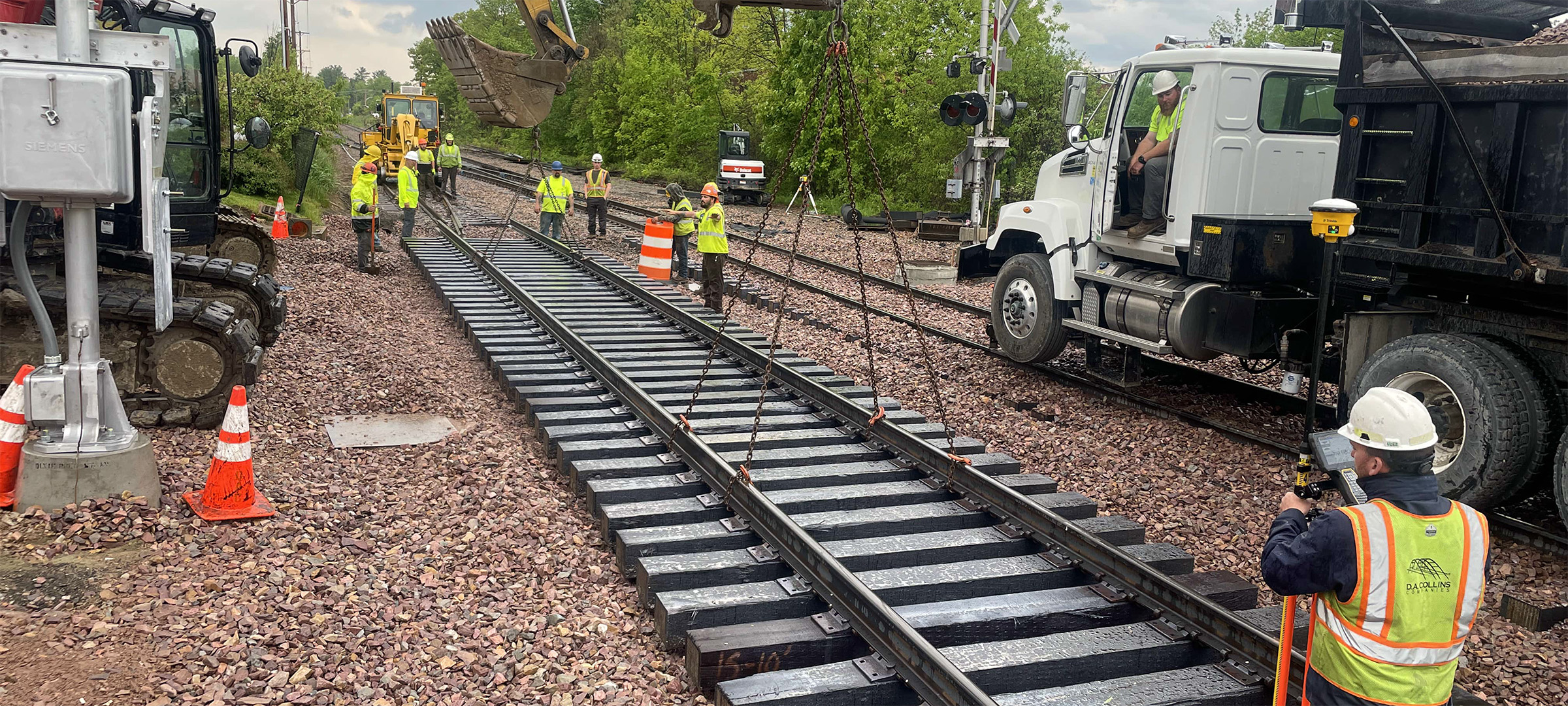

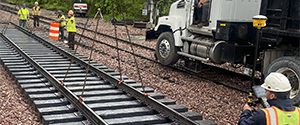

Installation of pre-assembled continuous welded rail and ties for the Flynn Avenue siding.

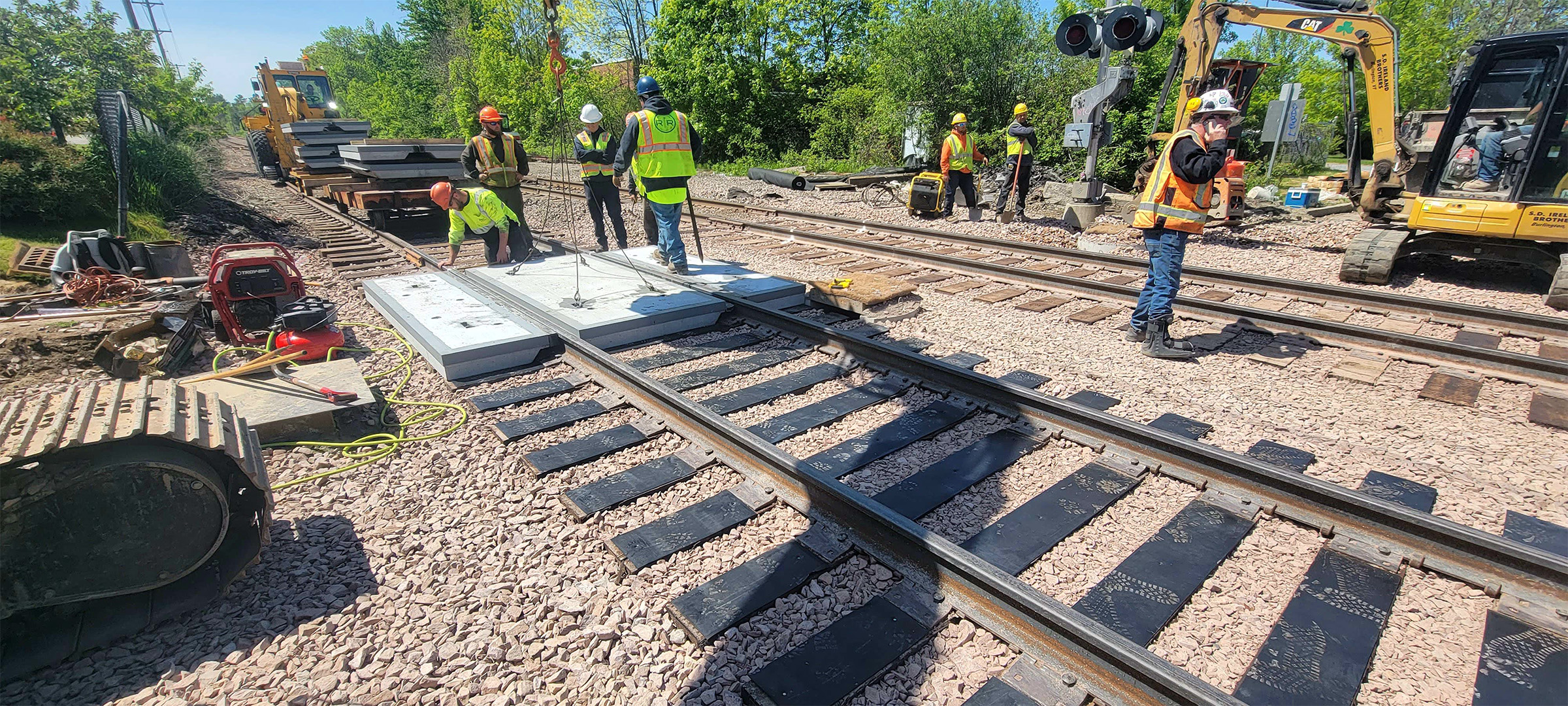

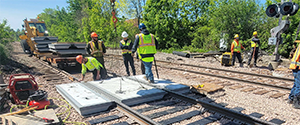

The installation of precast concrete panels for the railroad crossing at Flynn Avenue.
Crews running the cables for the railroad crossing signal at Flynn Avenue to the signal house.

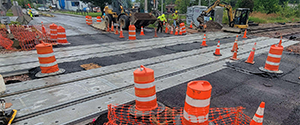

The newly installed asphalt and precast concrete panels at the railroad crossing at Flynn Avenue.

Installation of fiber optic communication conduit to duct bank along Home Avenue.

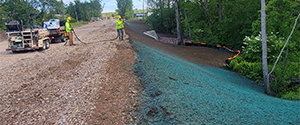

Crews placing hydroseed over the newly installed topsoil around the Englesby Brook box culvert.

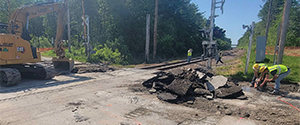

The removal of the asphalt at the Home Avenue railroad crossing in preparation for the installation of precast concrete panels and small box culverts.

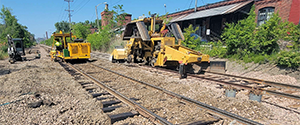

Adjusting the surface tracks just north of the Flynn Avenue railroad crossing.
Installation of the signal house for the new railroad crossing signal at the Home Avenue railroad crossing.

Installation of the decorative fencing around the Englesby detention pond.

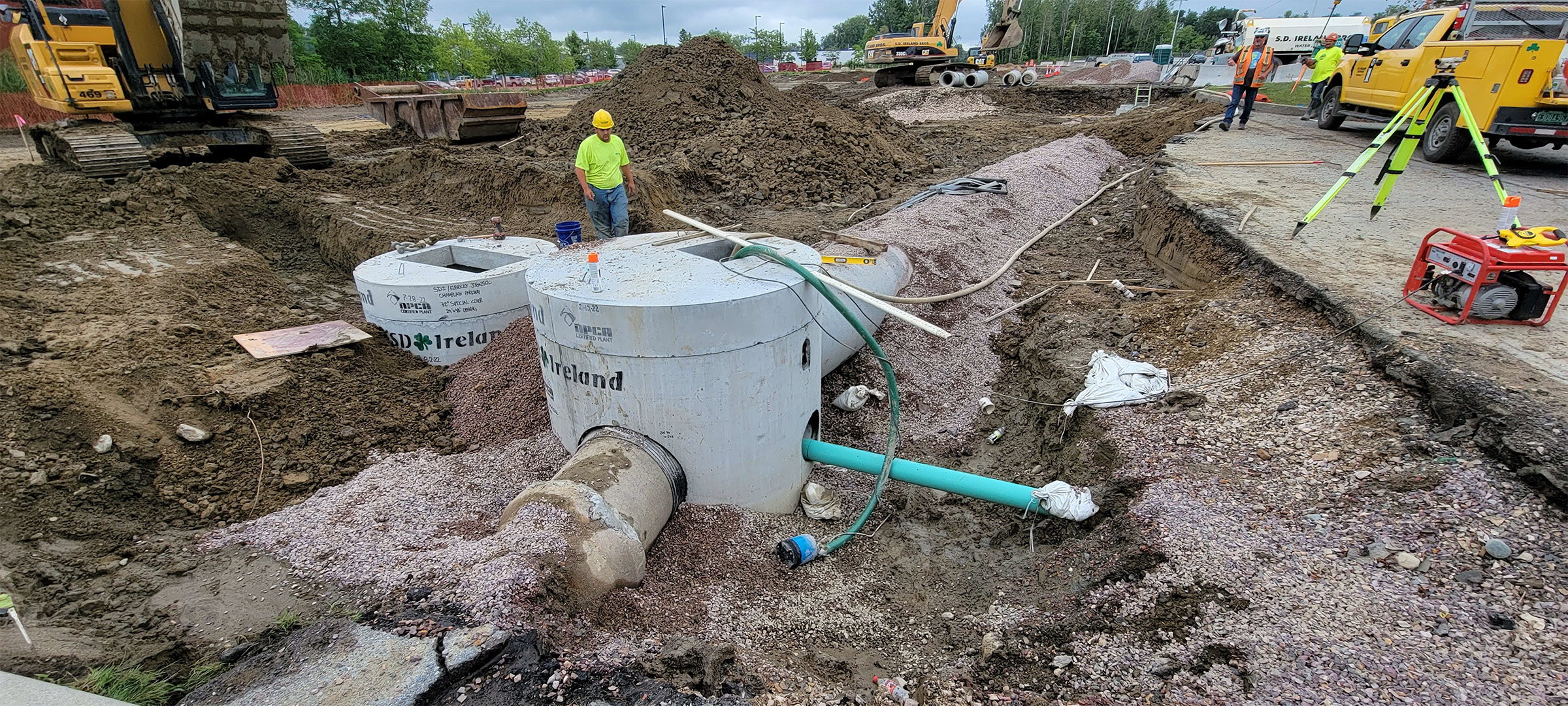

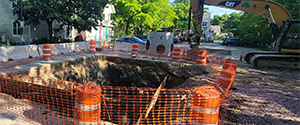

Excavation for the installation of the swirl chamber (new stormwater infrastructure) and the diversion structures in the parking area at the Flynn Avenue Co-op.

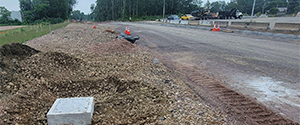

The installation of traffic signal fiber optic pull boxes along the Parkway between Lakeside Avenue and Sears Lane.

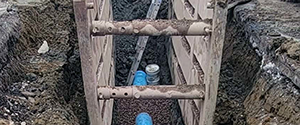

Installation of new waterline on Lakeside Avenue.
Base course paving at the intersection of Queen City Park Road and Austin Drive.

Removal of the existing abandoned railroad tracks along the west side of Pine Street in preparation for the installation of the new shared use path between Lakeside Avenue and Kilburn Street.

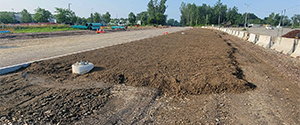

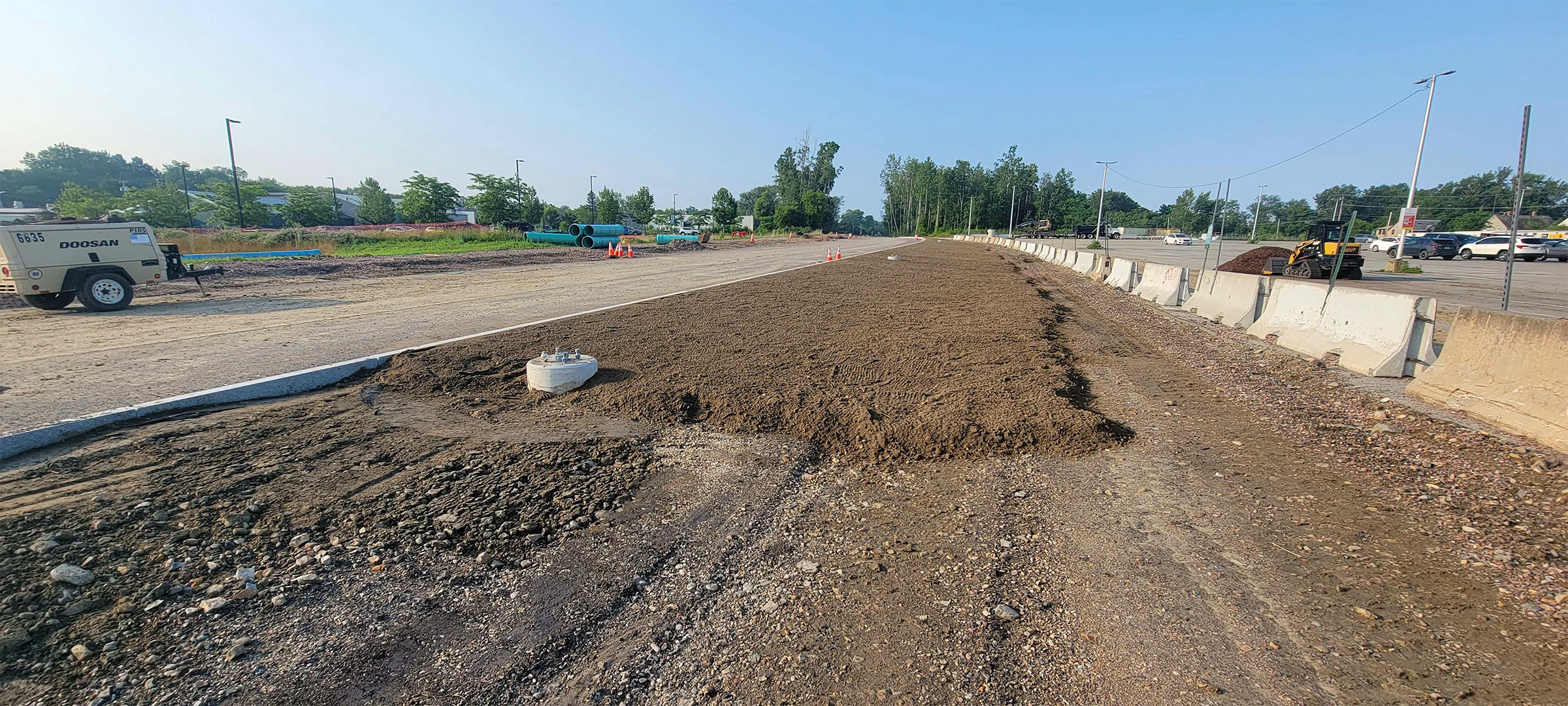

Placement of topsoil along the west side of the Parkway between Lakeside Avenue and Sears Lane.

Installation of six-inch conduit sleeve underneath the Parkway just south of Home Avenue. This conduit sleeve will later be encased in concrete.

Base paving and temporary line striping along Home Avenue.

Hydroseeding along the west side of the Parkway between Lakeside Avenue and Sears Lane.

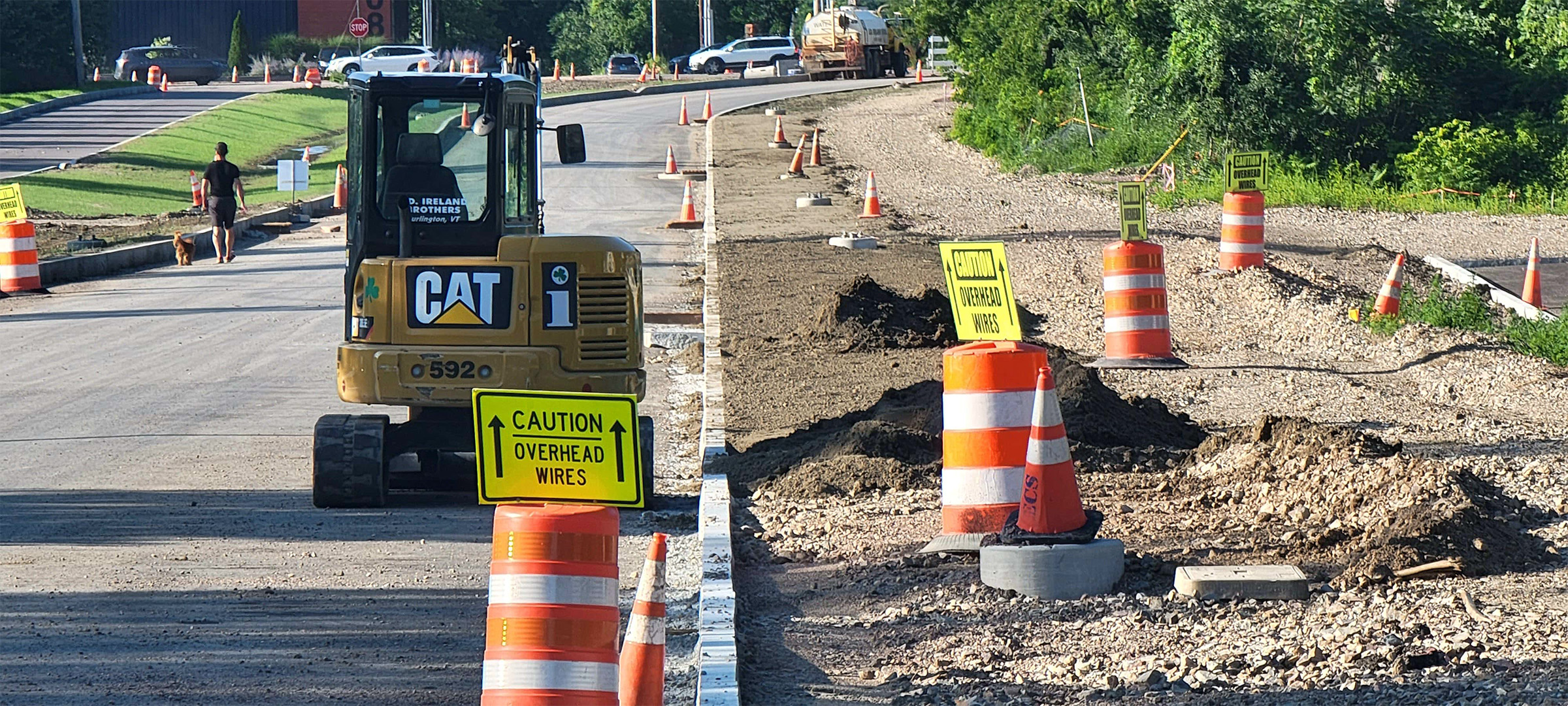

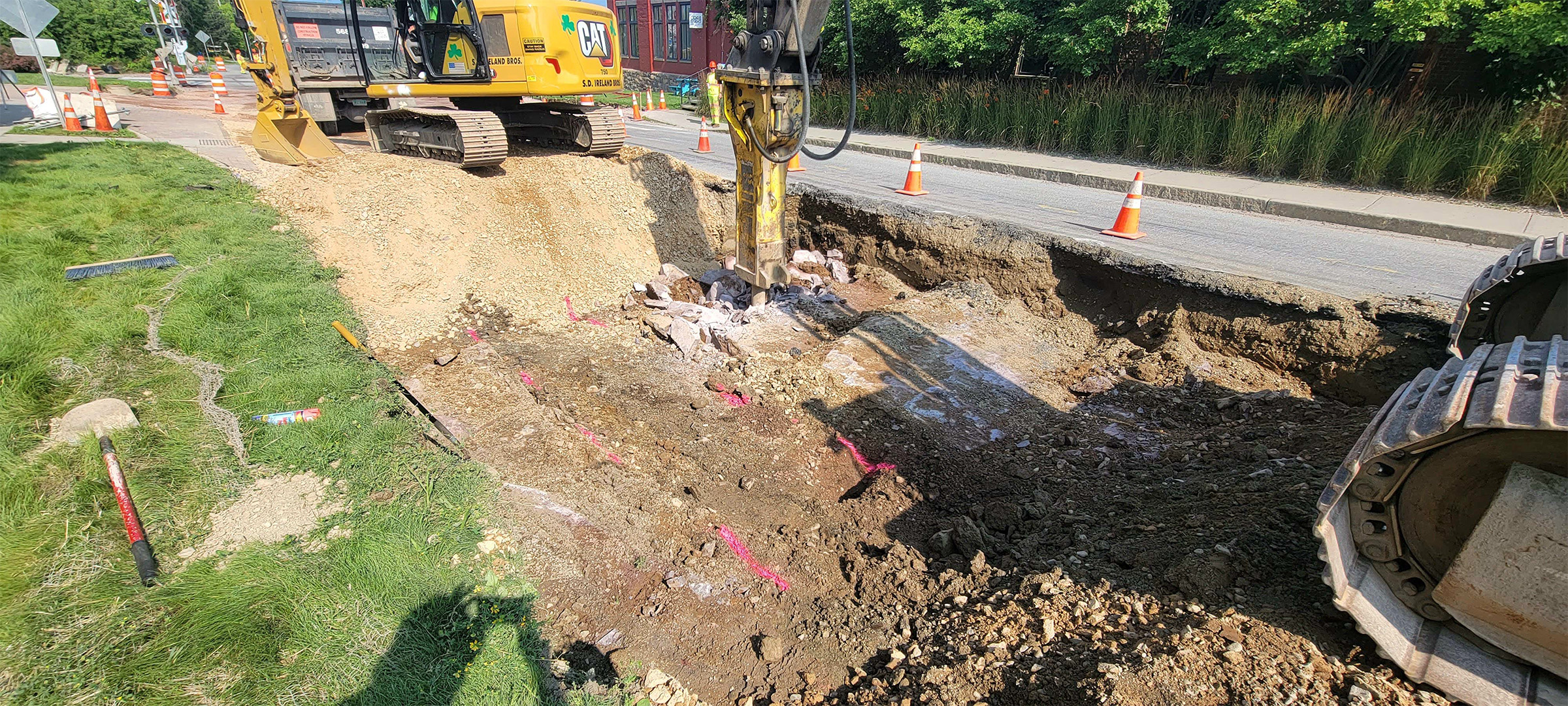

Removal of ledge on Flynn Avenue using a hammer as part of the full-depth roadway reconstruction.

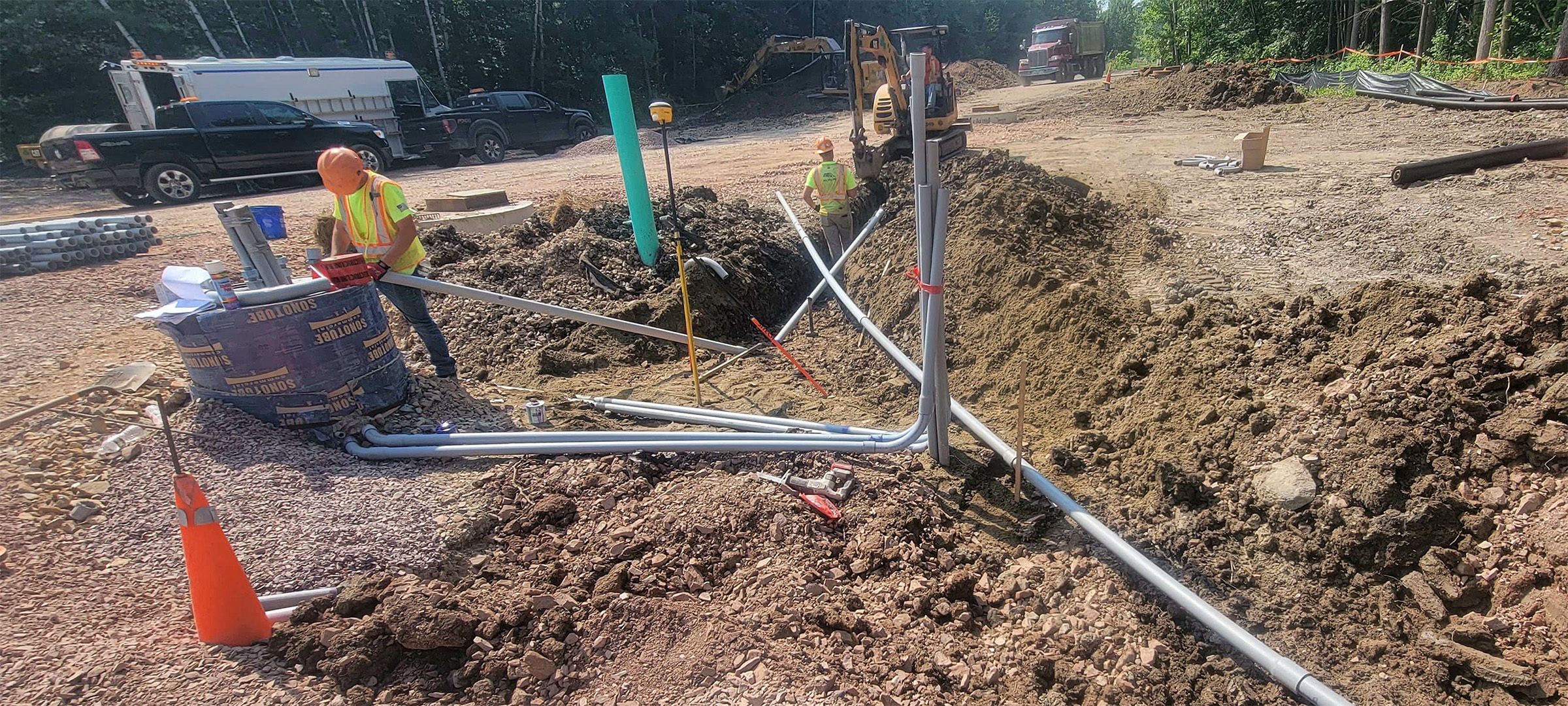

Installation of traffic signal and street lighting conduit on the Parkway just south of Home Avenue.

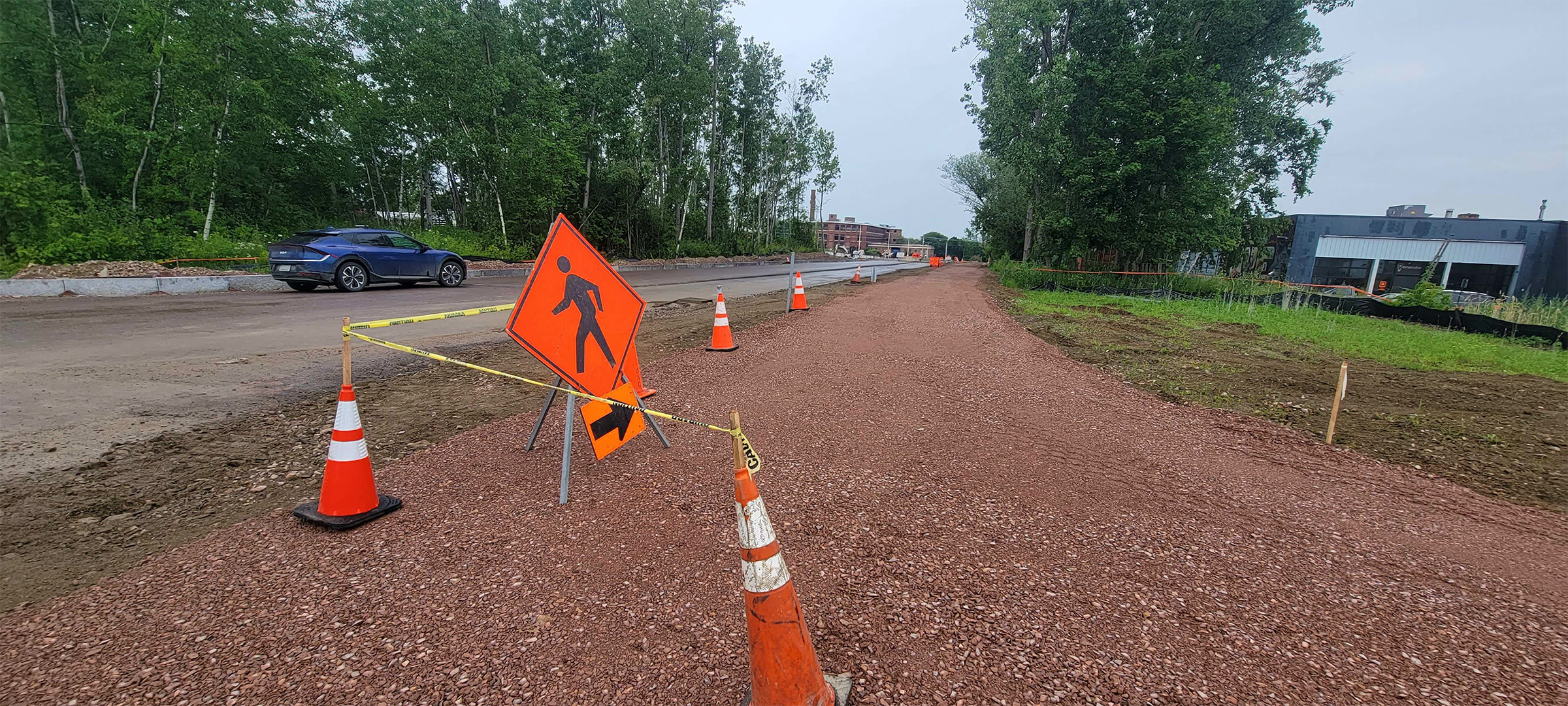

Fine-grading the shared use path and temporary pedestrian detour for the Lakeside Avenue closure.

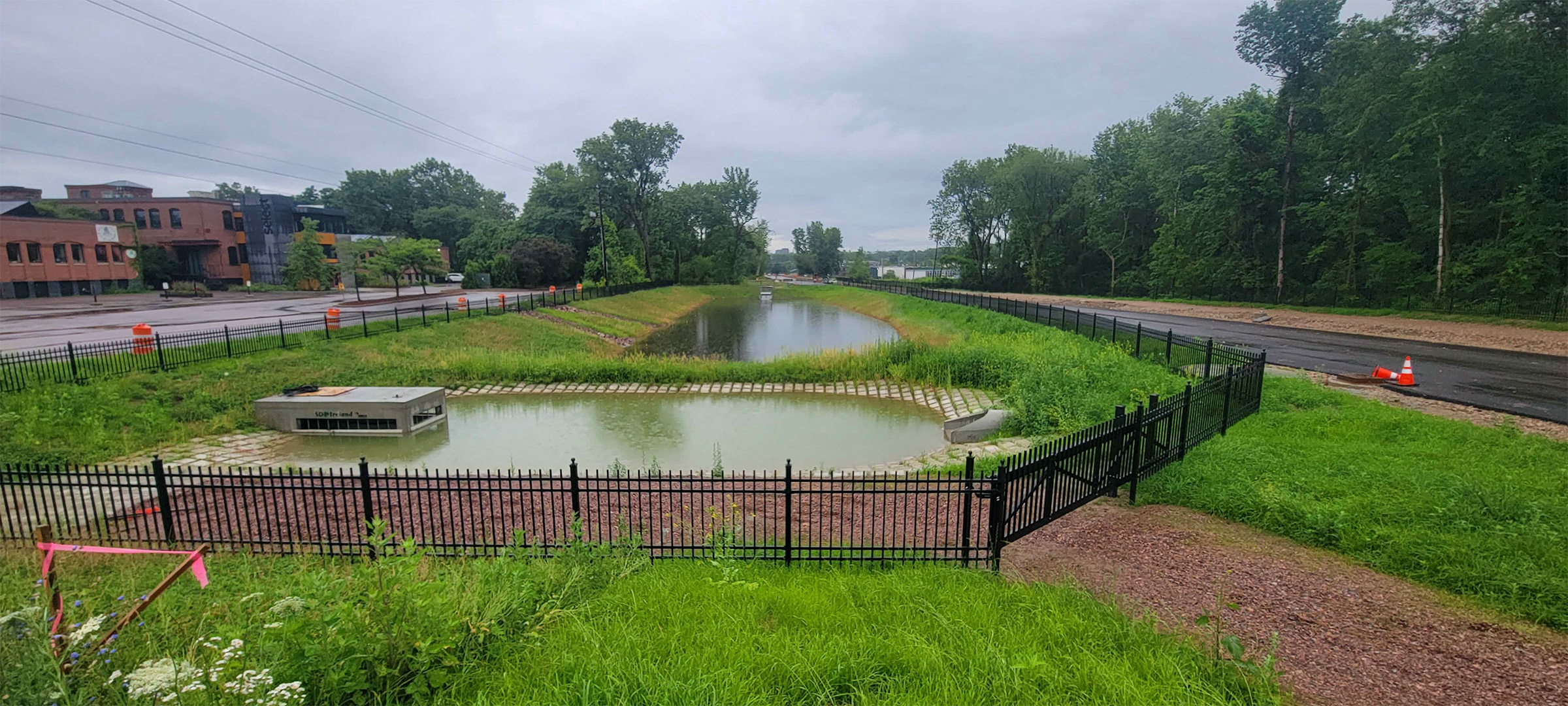

Englesby detention pond after a rain event.
Installation of sloped granite curbing along the new cul-de-sac at the westerly end of Ferguson Avenue.

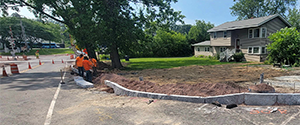

Installation of granite curb at the intersection of Home Avenue at the Parkway (northwest corner).

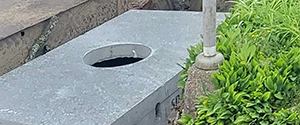

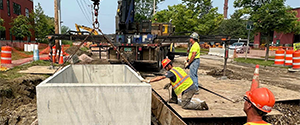

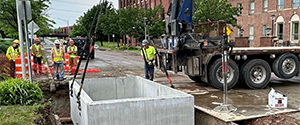

Installation of the electrical vault on Lakeside Avenue.

Installation of granite curb along the Parkway between Home Avenue and Flynn Avenue.
The installation of electrical vault on Lakeside Avenue.

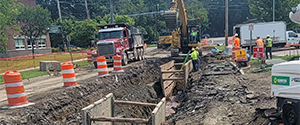

The installation of waterline along Lakeside Avenue.

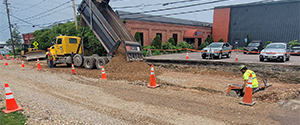

The installation of dense grade subbase material on Flynn Avenue.
Topsoil placement in the green space between the shared use path and the Parkway between Flynn Avenue and Home Avenue.

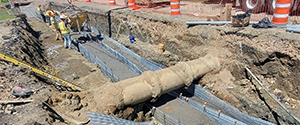

Placement of concrete to encase the electrical and communication duct banks installed along Lakeside Avenue.
Installation of the electrical vault on Lakeside Avenue.

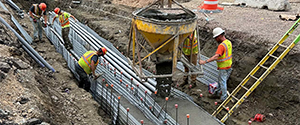

Placement of concrete to encase the electrical and communication duct banks installed at the intersection Lakeside Avenue and the Parkway.

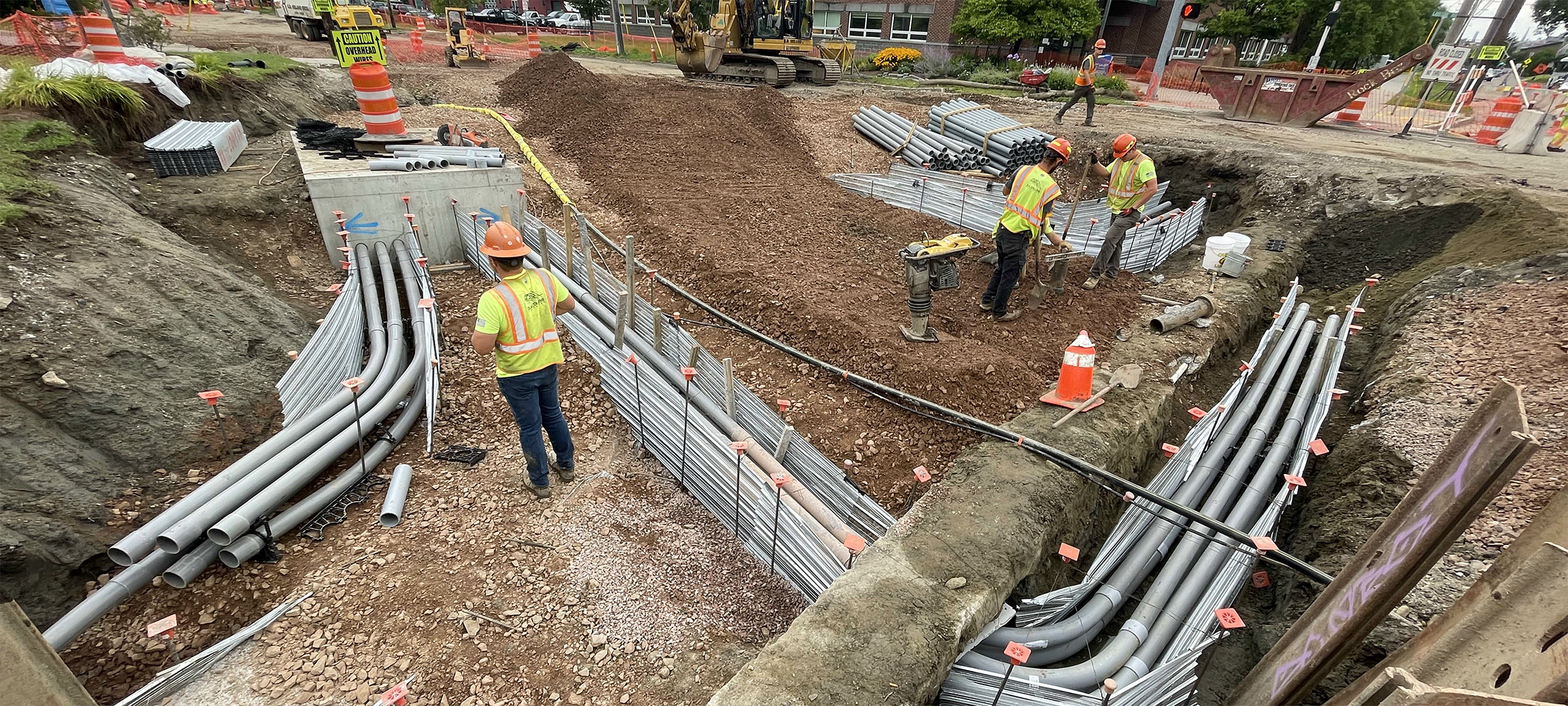

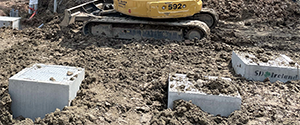

The installation of traffic signal pull boxes and conduit at the intersection of Home Avenue and the Parkway.

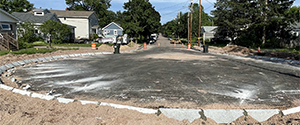

Installation of sloped granite curbing along the new cul-de-sac at the westerly end of Lyman Avenue.
Installation of granite curb along Batchelder Street.

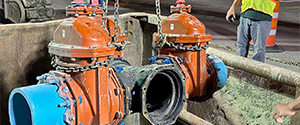

The installation of the four-way water valve assembly at the intersection of Pine Street at Lakeside Avenue at night to reduce impacts to the public.
Placement of concrete to encase the electrical and communication duct banks installed on Lakeside Avenue.
Installation of a new fire hydrant on Lakeside Avenue.

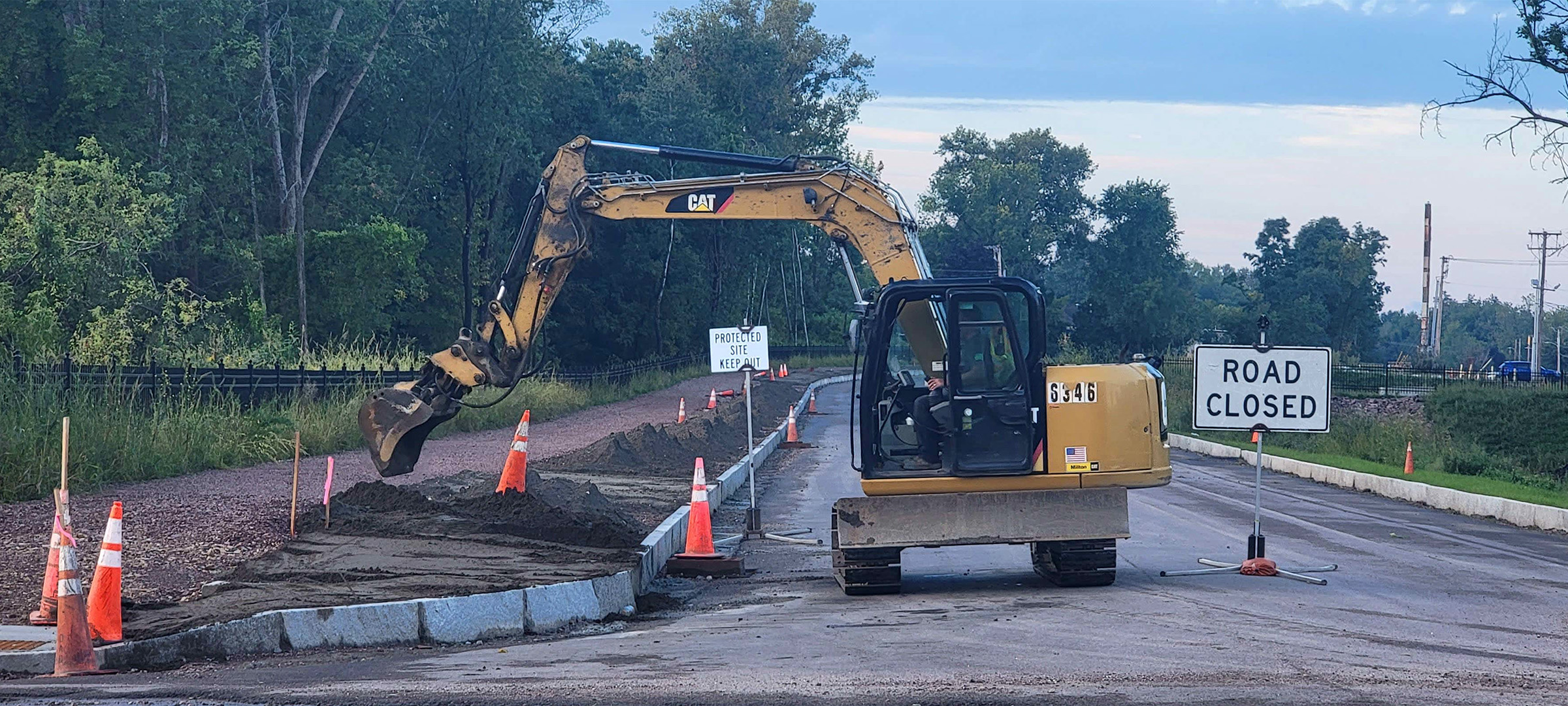

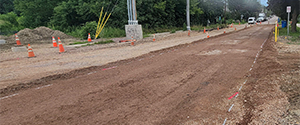

Fine-grading in preparation for base course paving along Flynn Avenue.

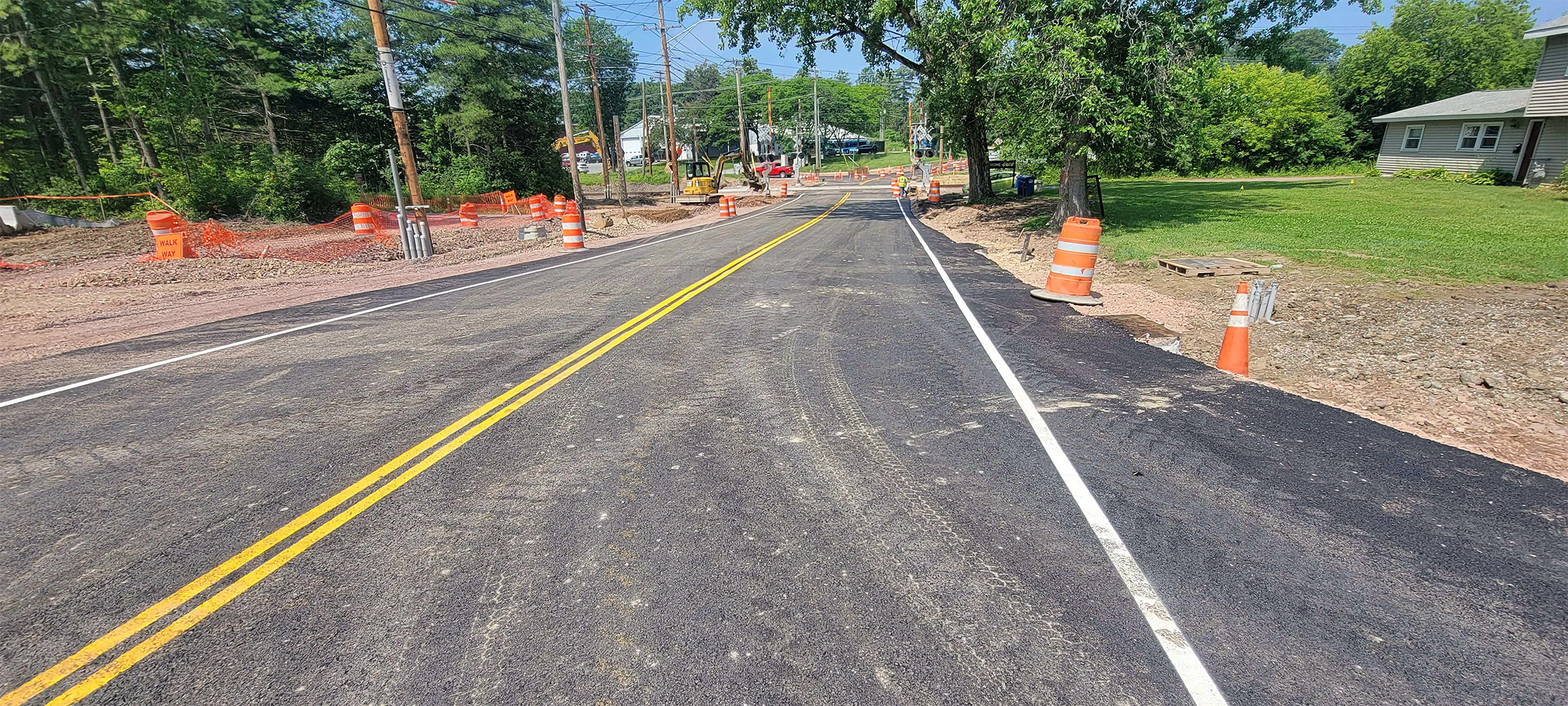

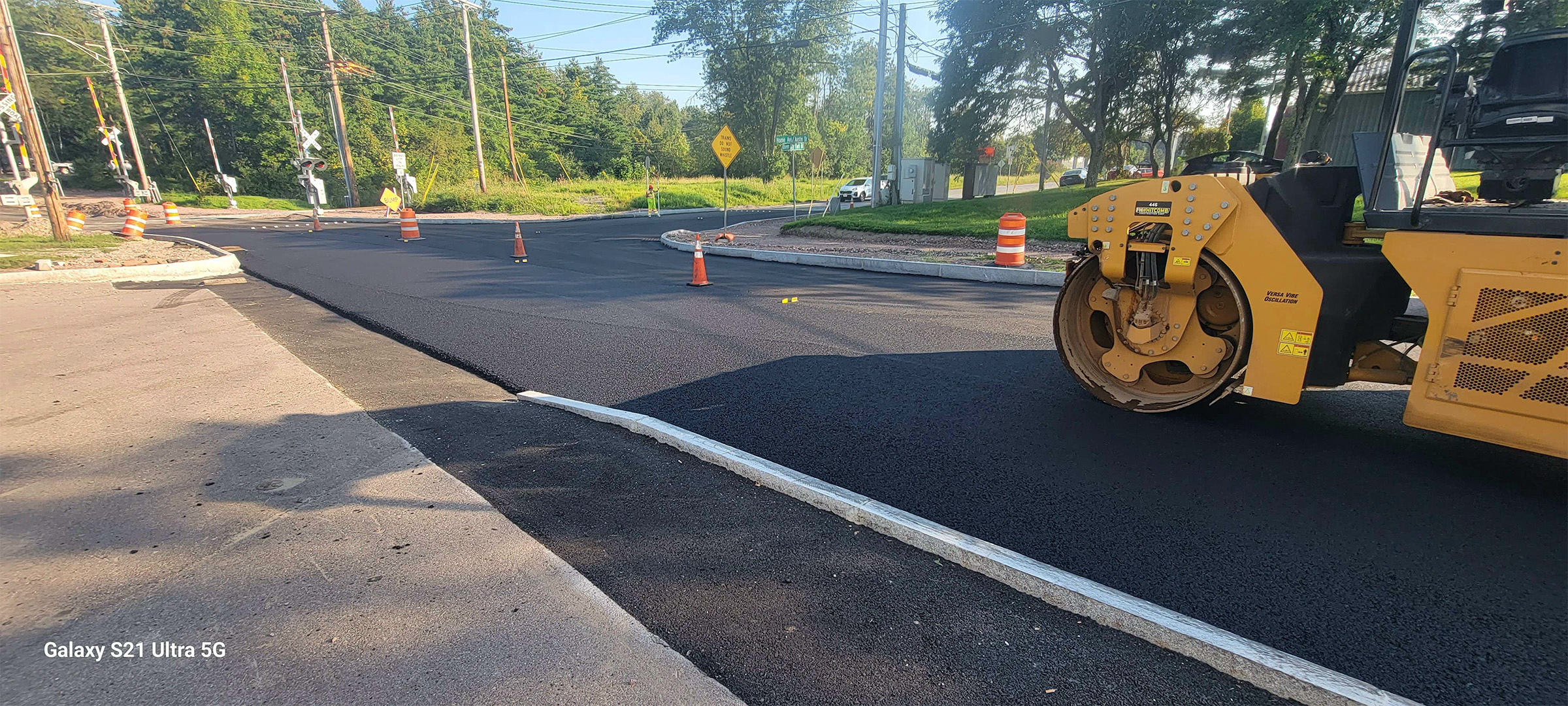

Base course paving along Flynn Avenue.

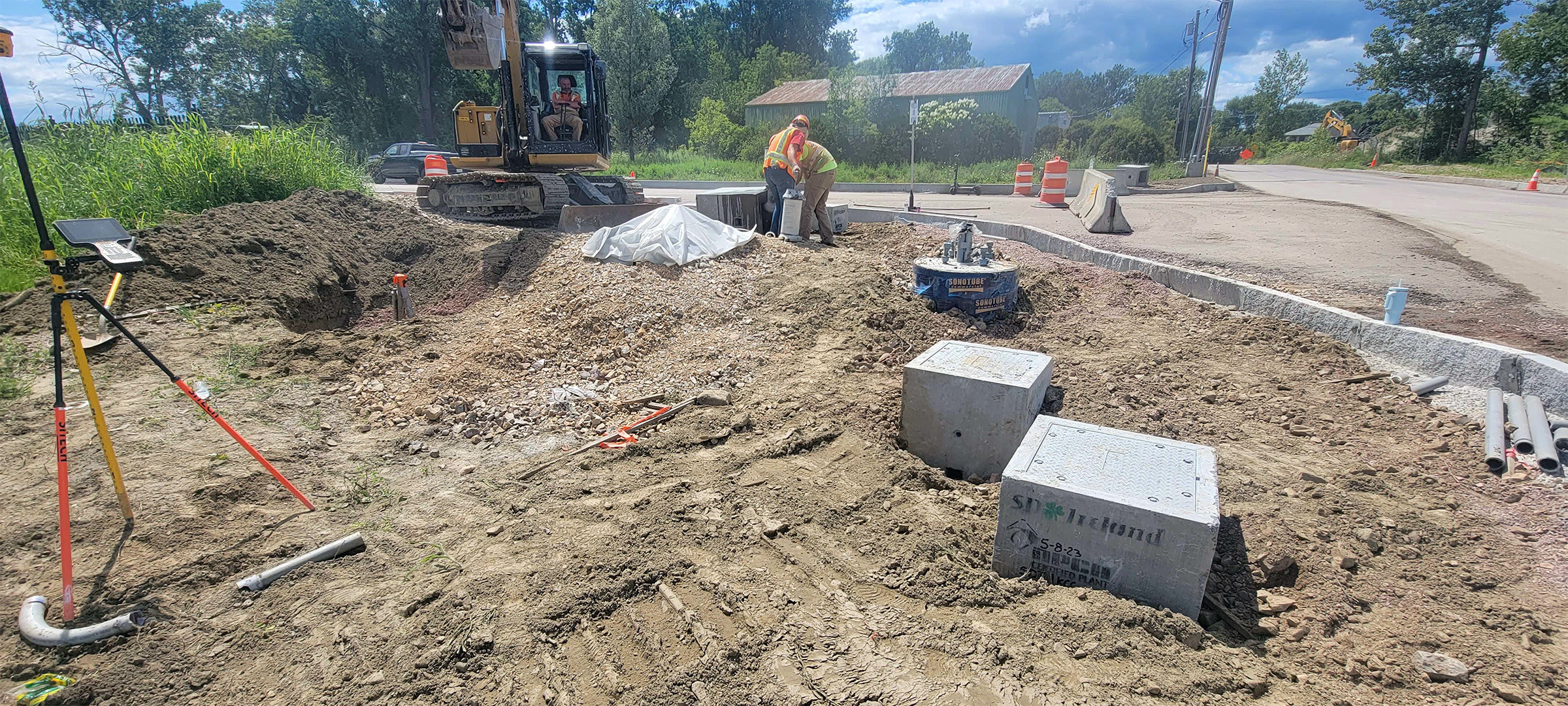

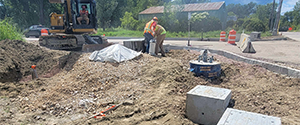

The installation of traffic signal pull boxes at the intersection of Sears Lane and the Parkway.

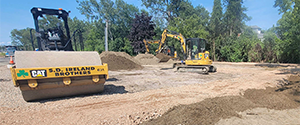

Placement of topsoil at the pocket park on the southeast corner of the intersection of Flynn Avenue and the Parkway.
Hay mulch spread over the topsoil to prevent erosion while the grass is established within the green areas along the Parkway. Photo taken near the intersection of Home Avenue and the Parkway.

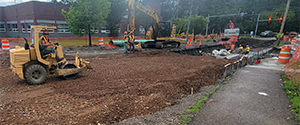

Installation of dense grade subbase material after waterline and duct bank installation was completed along Lakeside Avenue.

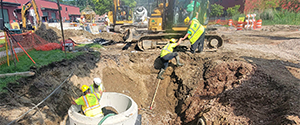

Installation of a catch basin on Lakeside Avenue.

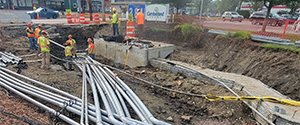

Installation of the communications duct bank on Lakeside Avenue near its intersection with Pine Street.

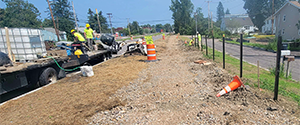

Installation of fence posts for the decorative fencing between the shared use path and Batchelder Street along the Parkway.

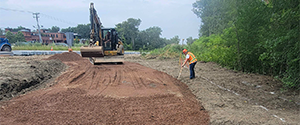

Installation of crushed stone subbase in preparation for the concrete slab support for the brick pavers at the Flynn Avenue pocket park.
The addition of communication service lines within the conduit on Lakeside Avenue. The installation of dense grade roadway subbase material.

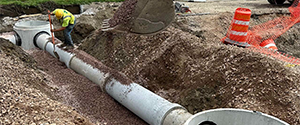

Installation of drainage infrastructure on Lakeside Avenue.

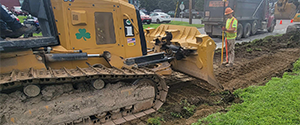

The removal of the existing sidewalk along Pine Street just north of the Kilburn Street in preparation for new concrete sidewalk installation.

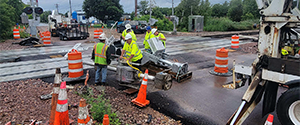

Installation of the new railroad crossing signal and gates at the Flynn Avenue railroad crossing.

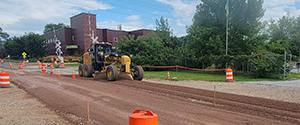

Fine-grading the roadway in preparation for base course paving on Flynn Avenue west of the Flynn Avenue railroad crossing.
Installation of dense grade roadway subbase along the Parkway just south of the Home Avenue intersection.

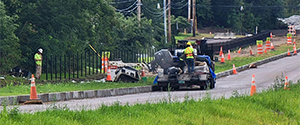

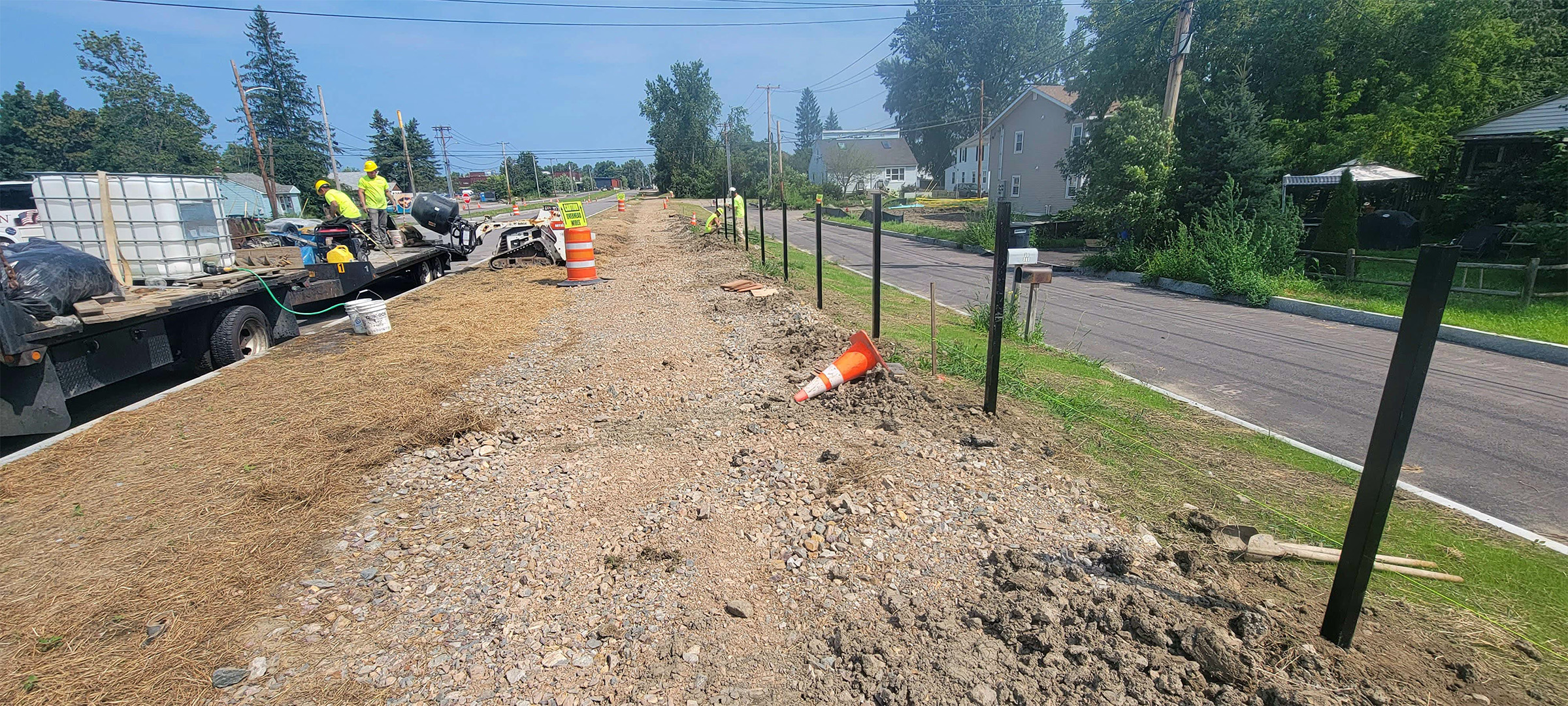

Installation of the decorative fencing along the shared use path and the Parkway between Flynn Avenue and Home Avenue.

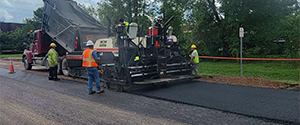

Base course paving along Flynn Avenue west of the Flynn Avenue railroad crossing.

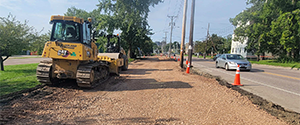

Installation of dense grade subbase material for the shared use path along the west side of Pine Street.
Grading the shared use path along Pine Street in preparation for the installation dense grade subbase material.

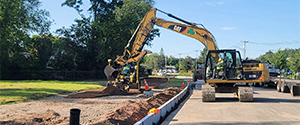

Fine-grading the shared use path along the Parkway between Flynn Avenue and Home Avenue in preparation for base paving.
Installation of electrical duct bank on Lakeside Avenue near its intersection with Pine Street.
Fine grading the shared use path along the Parkway between Flynn Avenue and Home Avenue in preparation for base paving.

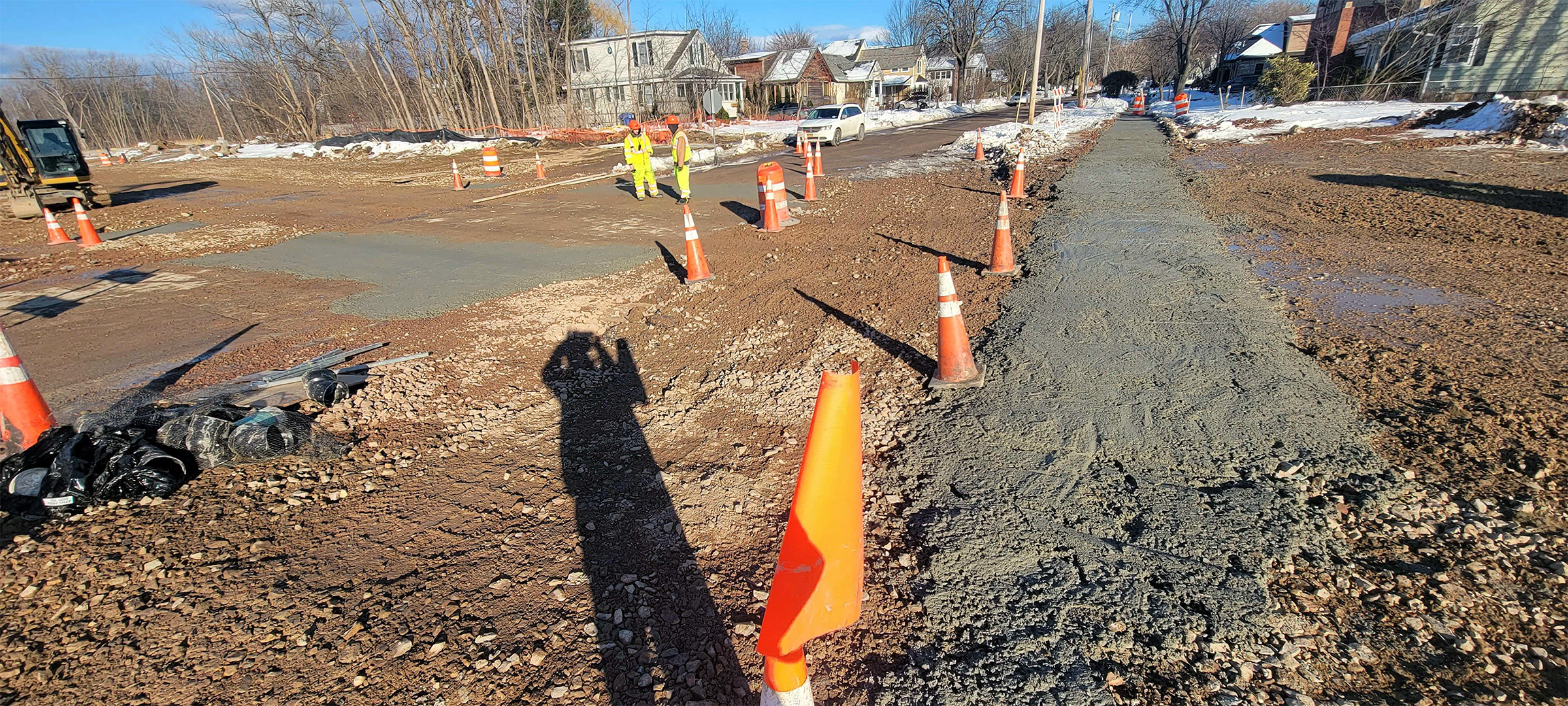

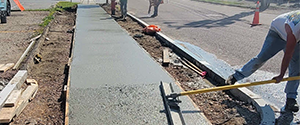

Construction of new concrete sidewalks along Sears Lane.
Fine grading along Flynn Avenue in preparation for forming and pouring the new concrete sidewalk along Flynn Avenue.

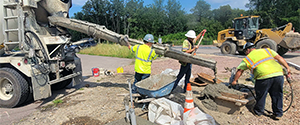

Placing concrete foundations for the traffic signal controller cabinet and the electrical meter pedestal in the northwest corner of the intersection of Flynn Avenue at the Parkway.

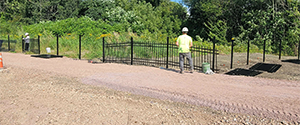

Installation of decorative fencing along the shared use path and the pocket park along the northeast corner of the intersection of Flynn Avenue and the Parkway.
Base paving the pedestrian connection along Sears Lane from the Parkway to the Hula parking area.

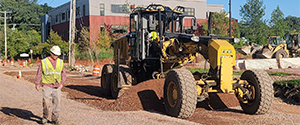

Grading the green space between the curb and the newly placed concrete sidewalk on Sears Lane.
Grading the green space between the curb and the newly placed concrete sidewalk on Sears Lane.
Installation of a new fire hydrant on Lakeside Avenue.

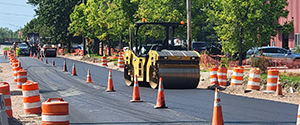

Base course paving along Lakeside Avenue.

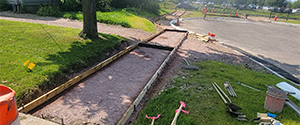

Forming the new concrete sidewalks along the Ferguson Avenue cul-de-sac in preparation for concrete pours.

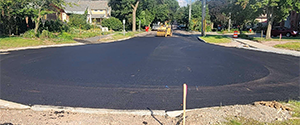

Wearing course paving of the new cul-de-sac on the westerly side of Ferguson Avenue.

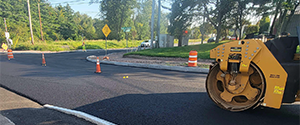

Paving the binder course at the intersection of Queen City Park Road and Austin Drive.

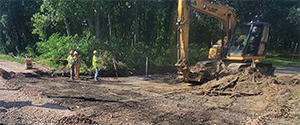

Excavation for the new alignment of the Maltex driveway on Pine Street.

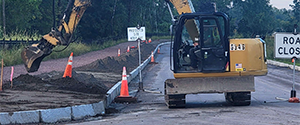

Placing topsoil along the green area between the shared use path and the Parkway between Sears Lane and Flynn Avenue.
Installation of the electrical and communication duct bank along Pine Street just north of Lakeside Avenue.
Installation of a six-inch concrete encased conduit on Lakeside Avenue.
Process of relocating the power lines from overhead and running them through the underground duct banks at the intersection of Pine Street at Lakeside Avenue.
Installation of the new concrete sidewalk and drainage infrastructure on Pine Street just north of Kilburn Street.
Installation of granite curb at the intersection of Home Avenue at the Parkway.

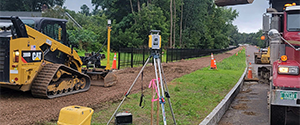

Fine grading the shared use path along the Parkway between Home Avenue and Flynn Avenue in preparation for base paving.

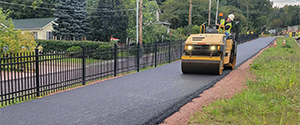

Base paving the shared use path between the Parkway and Batchelder Street.

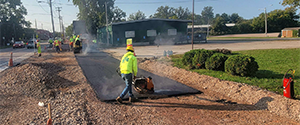

Base paving the shared use path along Pine Street.
Freshly poured concrete sidewalk at the northwest corner of Flynn Avenue at the Parkway.

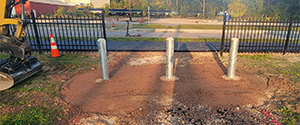

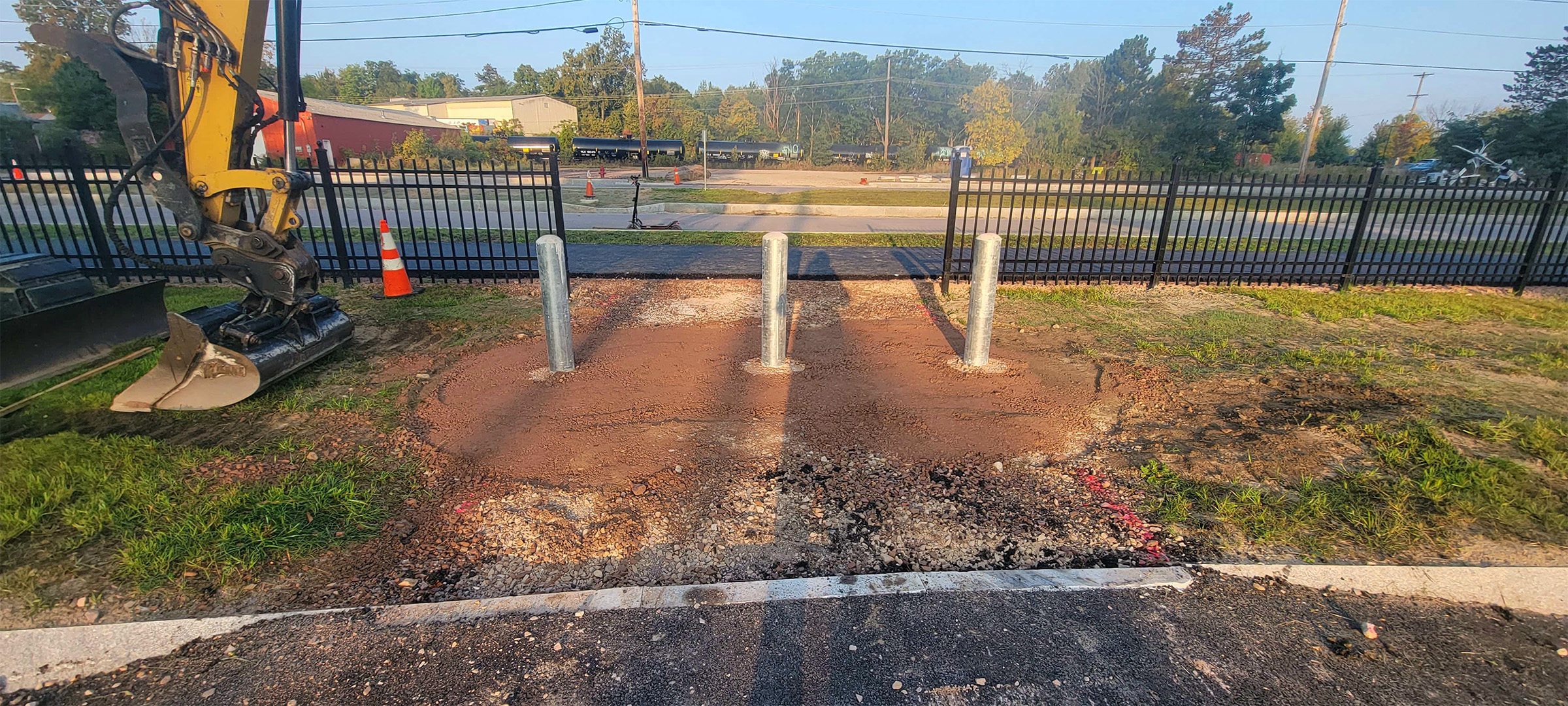

Installation of bollards at the entrance of the shared use path to the Lyman Avenue cul-de-sac.
Placing the concrete support for the brick pavers at the pocket park on the northeast corner of the intersection of Flynn Avenue at the Parkway.
Fine grading the shared use path near the Home Avenue railroad crossing in preparation for base paving.
Removing the existing curb and placing subbase materials along the east side of Pine Street in preparation for the installation of new granite curb.
Installation of drainage structures on Pine Street just south of Lakeside Avenue.

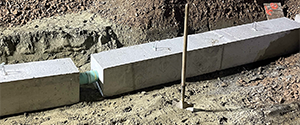

Installation of six-inch concrete encased sleeves for traffic signal conduit at the intersection of Pine Street at Lakeside Avenue.

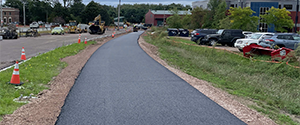

Newly installed pavement along the shared use path along the Parkway between Lakeside Avenue and Sears Lanes.
